prepared for Globe Kingston Limited
April 2024
summarised progress report
summarised progress report
Surrey House Island Site – Project Honey (10372)
contents
1.0 executive summary
2.0 programme
3.0 planning update
4.0 legals
5.0 design and project update
6.0 procurement update
7.0 construction works update

8.0 health and safety matters
9.0 tenant variations and approvals update
10.0 sustainability / Net Zero Carbon
11.0 environmental status update
12.0 key risks
13.0 areas of concern
14.0 key activities in the reporting period
15.0 lookahead – key activities in the next reporting period
appendices
appendix a – LoR & warranties tracker
appendix b – planning / S106 conditions
appendix c – EAI tracker
appendix d – outline programme
appendix e – G&T update report
https://francishunter.sharepoint.com/sites/FH/Shared
Documents/Projects/03 current/10372 - Project Honey/10 Reports & Surveys/PM dashboard/2404 April 2024/Cube Appendix/contents page Cube 240508.docx
appendix f – MCLH update report
appendix g – BREEAM tracker
appendix h – Aecom CMT report
appendix i – MNP CMT report
appendix j – ORSA monthly CDM report
appendix k – DAA CMT report
appendix l – package review schedule
appendix m – McLH procurement schedule
appendix n – McLH programme
appendix o – Lautus progress report
appendix p – Clarke’s manufacturing update
https://francishunter.sharepoint.com/sites/FH/Shared
Documents/Projects/03 current/10372 - Project Honey/10 Reports & Surveys/PM dashboard/2404 April 2024/Cube Appendix/contents page Cube 240508.docx
FH090-151015 appendix a LoR
warranties tracker
&
warranty and PI schedule
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty primary warranties 1.00 main consultants 1.01 Employers Agent FHPM £10m expires 08/08/24 Signed 25//5/22 Completed Gwlng May Tracker Signed 8/6/22 Issued by Gwlngs for Docusign 7/7/23…signed TA email 19/7/23 Warranty required per building CLOSED 1.02 Monitoring Architect DAA £5m expires 27/08/24 Signed 25//5/22 N/A for monitor Signed 8/6/22 Issued by Gwlngs for Docusign 7/7/23…signed TA email 19/7/23 Only one monitoring architect's appointment. TA email 5/7/23 CLOSED
Monitoring Civil and Structural Engineer (main and monitoring) MNP £5m expires 18/04/25 Signed 19/10/22 Completed…Gwlng May Tracker. Tenan Warranty not required for Monitoring. Signed 19/10/22 Issued by Gwlngs for Docusign 7/7/23….13/9/23 Lender to sign all warranties in one go. 29/11/23 Lender warranty (Main) signed by Lender. CLOSED 1.04 MEP Engineer Aecom £10m expires 01/04/24 …new certificate requested Signed 19/10/22 Completed- Gwlng May Tracker. Signed 19/10/22 29/11/23 Lender signed. CLOSED 1.05 Cost Consultant G & T £10m expires 01/05/24 Signed 25//5/22 N/A Signed 8/6/22 .signed TA email 19/7/23 CLOSED 1.06 Main Contractor MCLH £20m expires 31/12/24 Contract dated 16/11/22 With Tenant Fund warranties completed Contractor lender warranty sent out for Docusign by Gwlngs 7/7/23. Lender to sign all warranties in one go. GOWLINGS/MAYER BROWN 1.07 Demolition Contractor Shorts £1m expires 01/06/24 (£5m) Contract dated 3/2/23 Fund warranties completed 25/7/23 Shorts have signed. GOWLINGS
Warranties/LoR within 12 months of unconditional or no more drawdowns for relevant trades 2.01 Architect Novated x 3 appointments DAA £10m expires 27/08/24 signed 25/5/23 Completed- Gwlngs May Tracker Fund warranty completed Email of 30/1/24 COMPLETED CLOSED 2.02 Contractors Engineer RBG £10m expires 31/12/24 COMPLETED COMPLETED- Gwlng May Tracker 30/1/24 Fund Warranty "COMPLETED" 30/1/24 Lender Warranty COMPLETED CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
1.03
2.00
project: Surrey House
warranty
PI
and
schedule
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.03 Cladding consultant x 3 appointments Eckersley O'Callaghan (EOC) £10m expires 23/03/25 Signed by Consultant…and by Employer COMPLETED- Gwlng May Tracker Funder warranty issued and completed by Gwlngs Docusign 11/7/23 Issued by Gwlngs for Docusign 7/7/23. 29/11/23 COMPLETED CLOSED 2.04 Right of light consultant Point2 £10m expires 19/12/24 Appointment COMPLETED COMPLETED- Gwlng May Tracker FUNDER WARRANTY COMPLETED LENDER WARRANTY COMPLETED CLOSED 2.05 Measurement Surveyor consultant Plowman & Craven £5m expires 01/06/24 Gwlng May TrackerAppt with Client for signature Reliance letters to be issued once reports are prepared. Gwlng May Tracker- with Client for signature Gwlng May Tracker- with Client for signature GOWLINGS 2.06 Validation Engineer Inhabit £2m expires 31/12/24 (£10m) Gwlng awaiting details Gwlng awaiting details Gwlng awaiting details Gwlng awaiting details Services not carried out until completion. 2.07 Environmental consultant GEA £5m expires 31/03/25 Gowlngs awaiting details. Report dated February 2022 COMPLETED COMPLETED COMPLETED 2.08A Landscape Architect Gillespies £5m expires 25/09/24 signed 13/02/22 Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED 2.08B Landscape ArchitectContractor Appointment McIIlwaine £2m expires 08/11/24 30/1/24 TA says that draft has been received. Not required Draft Fund Warranty forwarded
approval.
been reviewed
approval. 30/1/24..TA
be issued.
GOWLINGS 2.09 Principal Designer x 3 appointments ORSA £10m expires 24/02/25 Signed 19/10/22….check if completed Completed Gwlng May Tracker Signed 19/10/22…check if completed COMPLETED CLOSED 2.10A Fire Strategy Consultant SWECO Not required No longer engaged…replaced by Marshall Fire.
Marshall £5m aggregate expires 25/07/24 COMPLETED Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED 2.10C Fire Strategy ConsultantContractor Appointment Marshall £5m aggregate expires 25/07/24 Draft received ….30/4/24 email...Client Warranty sent out to Consultant for signature. Not required 1/3/24 Marshall have confirmed they can accept the draft warranty. Gwlng May Tracker-issued to Consultant for signature. 29/11/24 TA to be issued. ….Gwlng May Trackerissued to Consultant for signature FHPM to check
to MCLH to obtain
Gwlng May Tracker- Comments have
and sent to Consultant for
..to
…but on tracker 6/3/24 shown as N/A….check
2.10B Fire Strategy Consultant x 2 (one direct/retained and one with contractor) ….see below for contractor appointment
subcontractor Van Elle £5m aggregate expires 29/04/24 (updated cert requested) Redacted order signed and dated 2/11/22 received and filed on Centrodoc. Completed Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
2.11 Piling Bored.Sheet
project: Surrey House
11/10/24
2.14 MEPH subcontractor Halsion £10m AOC expires 11/12/24
Redacted order dated 21/11/22 received and saved on Centrodoc. Certified copy required.
2.15 Façade, cladding and curtain walling Clarkes £10m aggregate expires 28/02/25
2.16 Acoustic consultantContractor Appointment Hann Tucker £1m expires 24/7/24
2.17 Lift subcontractor Otis £5m aggregate expires 30/11/24
Fully executed order dated 30/5/23 received and filed on Centrodoc. redacted . 6/3/24 Certified copy required.
29/1/24...no change. Issued to subcontractor. 12/4/24 Issued by Docusign again by GWLNGS
Gwlng May TrackerDraft received. 30/4/24 email…Client Warranty sent to Consultant by Docusign
Redacted subcontract order dated 4/5/23 received and filed on Centrodoc.. 6/3/24 Certified copy required.
29/1/24 Signed by subcontractor, to be signed by the contractor.
29/1/24...no change. Issued to sub-contractor. 12/4/24 Issued by Docusign again by GWLNGS
29/1/24...no change. Issued to sub-contractor. 12/4/24 Issued by Docusign again by GWLNGS
Not required Gwlng May Trackerissued to Consultant for signature.
29/1/24...no change. Issued to sub-contractor.
12/4/24 Issued by Docusign again by GWLNGS
Gwlng May Tracker- with Consultant for signature
2.18 Car Park Contractor (if separate)
FP McCann £10m aggregate expires 31/01/25 Fully executed subcontract order dated 26/7/23 received and saved on Centrodoc.. 6/3/24 Certified copy required.
29/1/24 Issued to subcontractor . 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
Completed- Gwlng May Tracker
.6/3/24 Signed by the subcontractor. Sent to the Tenant. 12/4/24 Issued to Otis again by GWLNGS
6/3/24 Still with subcontractor. Issued to Otis by Docusign by GWLNGS ….12/4/24
Completed- Gwlng May Tracker
29/1/24 Issued to subcontractor. 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
29/1/24 Issued to subcontractor. 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
warranty
PI
and
schedule
ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.12 Concrete frame subcontractor Mitchellson
Redacted
on
COMPLETED Completed Gwlng May Tracker COMPLETED COMPLETED. CLOSED 2.13 Roofing subcontractor AYM
expires
Received, certified
Issued to sub-contactor for signature Issued to sub-contactor for signature ….2 warranties, Building A and Building B Issued to sub-contactor for signature Issued to sub-contactor for signature GOWLINGS
date: 08/05/24
£10m aggregate expires 18/11/24
subcontract order dated 5/1/23 received …saved
Centrodoc.
£10m aggregate
copy required.
Completed Gwlng May Tracker Completed Gwlng May Tracker Completed Gwlng May Tracker Completed Gwlng May Tracker CLOSED
GOWLINGS
GOWLINGS
GOWLINGS
GOWLINGS https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
warranty
PI schedule
and
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.19 Architectural metalwork/secondary steelwork CMF Limited £10m in the aggregate certificate provided expires 03/07/24 Fully executed subcontract order dated 4/9/23 received and saved on Centrodoc. 6/3/24 Certified copy required. Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker CLOSED 2.20 Plant screens and Louvres (if separate) TBA 2.21 Soffit cladding (if appropriate) Clarkes See Clarkes above 2.22 Steelwork connections (if appropriate) TBA Included in Mitchellsons 2.23 Fire curtains TBA
Feature staircase TBA 29/11/23 requested from LN 2.25 Mansafe system PTSG £10 m in the aggregate Expires 31/3/25 Signed sub-contract order dated 5/9/23 received and filed and Centrodoc. 6/3/24 Certified copy required. Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker GOWLINGS 2.26 Internal glazed screen subcontractor TBA £2m 2.27 Greenwall ANS Global 2.28 Flood protection equipment TBA 2.29 Car park cladding (if separate) Maple 2.30 Other subcons with material design responsibility. TBA 3 Secondary consultants supporting Planning Application only 3.01 Acoustic consultant Hann Tucker £1m expires 24/07/24 (£10m) Appointment completed Funder warranty completed CLOSED 3.02 Air Quality consultant AQ Consultants £2m expires 06/03/25 Appointment completed Funder warranty completed CLOSED 3.03 Arboriculture consultants Landmark Trees £2m continuous Appointment completed Funder warranty completed CLOSED 3.04 Archeological consultants RPS Consultancy £1m expires 30/9/24 (£10m) Appointment completed Funder warranty completed CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
2.24
project: Surrey House
warranty
PI schedule
and
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 3.05 Asbestos consultant Search Environmental £1m expires 21/8/24 Appointment completed Funder warranty completed CLOSED 3.06 Ecological consultant Ecology Practice £2m expires 17/12/24 Appointment completed Funder warranty completed CLOSED 3.07 Planning consultant Chart Plan £2m expires 30/7/24 Appointment completed Funder warranty completed CLOSED 3.08 Security consultant Kabsec £5m expires 03/01/25 L of R agreed. 6/3/24 Reliance letter signed by Consultant…to be sent to Funder. CLOSED 3.09 Blast consultant Aibara £1m expires Appointment completed …but Gwlng May Tracker "Awaiting details". Funder warranty completed CLOSED 3.10 Cladding Access consultant PTSG (Through MCLH) £5m expires 31/03/25 Awaiting details to prepare Appt. TA 6/3/24 To be issued with Appt. Missing from TA schedule on 6/3/24 but CMS have been informed that it is PTSG through MCLH. 3.11 Transport consultant Milestone £5m expires 5/12/24 Appointment completed Funder warranty completed CLOSED 3.12 Environmental Impact Statement consultant Stantec £1m expires 1/10/24 COMPLETED N/A COMPLETED COMPLETED CLOSED 3.13 Approved Inspector Sweco £1m expires 29/4/24 Not required…statutory service. 4.00 Other 4.01 Wind and microclimte consultant BRE With Consultant …Letter of Reliance. 4.02 Heritage and Townscape Consultant Peter Stewart Consultancy Completed CLOSED 4.03 Viability study Housing Expectations Completed CLOSED 4.04 Building Control MLM (Sweco) Completed CLOSED 5.00 Product and Component Guarantees ( Tenant Guarantees) 5..01 To be added if required in this document 6.00 Sub-sub- contractor warranties https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
wall (Mitchelson sub-sub contractor)
confirmed that she has sent a draft form of warranty to BCLP for all 5 of these sub-subbies…....and will arrange for these to be issued once approved. 6.02 Design of PT slabs (Mitchelson sub-sub contractor)
6.03 Design, manufacture, installation (Mitchelson sub-sub contractor)
6.05 Design and manufacture(Mitchelson sub-sub contractor)
6.06
(Halsion)
warranty and PI schedule
ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty
twin
Kilsaran
TA 6/3/24 ..To be issued
with
approval) To be issued To be issued To be issued 23/2/24 TA
CCL Received, certified
TA 6/3/24
be issued
To be issued To be issued To be issued See
date: 08/05/24
6.01 Design and supply of
Awaited
(currently
the Funder for
copy required.
..To
(currently with the Funder for approval)
Kilsaran above
Received, certified
required. TA 6/3/24 ..To be issued
with the
approval) To be issued To be issued To be issued See Kilsaran above
Creagh Received, certified
TA
be issued
To be issued To be issued To be issued See Kilsaran above
Intersteel
copy
(currently
Funder for
6.04 Design and manufacture (Mitchelson sub-sub contractor)
copy required.
6/3/24 ..To
(currently with the Funder for approval)
FP McCann
TA 6/3/24 ..To be issued
approval) To be issued To be issued To be issued See Kilsaran above
Awaited
(currently with the Funder for
Carbon3 Received, certified copy required To be issued (currently with Funder
approval) To be issued To be issued To be issued https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
Sub-sub-contractor
for
planning/S106 conditions
FH090-151015 appendix
b
Detail Planning Application No: 22/02905/FUL – Consented 11/01/2023
Updated 09/05/2024
Surrey House, 34 Eden Street NCP Car Park, St James Road Former Hippodrome, Eden Street And Bo Concept, The Roundhouse 20 Eden Street
PROPOSAL: Application under S73 of the Town & Country Planning Act 1990 to carry out development without compliance with condition 1 (Approved plans) of planning permission ref: 21/04022/FUL (Application under Section 73 of the Town and Country Planning Act 1990 to carry out development without compliance with Condition 1 (Approved Plans) of Planning Permission ref: 20/02495/FUL (Full Planning application for the demolition of Surrey House, Multi Storey Car Park, Hippodrome and Bo Concept and the erection of 2 (two) Office buildings [Use Class - E(g)(i)] Building A and Building B: Building A 9 storeys (22,144 (GEA) sqms) Building B 11 storeys (11,587 (GEA) sqms). The erection of a replacement multi storey car park of 354 spaces plus cycle parking (for use as a public car park at weekends) landscaping, public realm upgrades, servicing, pedestrian and vehicular access) dated 02/12/2021. Variations to include alterations to bridge link, elevations, floorplates, ground floor level access, rooftop plant and screen, service yard, reduction to height of Buildings A and B, alterations to landscaping/public realm, removal of basements and stairs on sides of Building A. This application is accompanied by an Environmental Statement.)
Variation to consist of revisions to the Car Park (Building C). This application is accompanied by an Environmental Statement.
Taking into account the Environmental Information contained within the Environmental Statement and addenda thereto, which was submitted under the Town and Country Planning (Environmental Impact Assessment) Regulations 2017 and subject to a ‘Legal Agreement’, PERMIT subject to the following conditions:
This application is accompanied by an Environmental Statement. BRIEF OUTLINE OF CONDITIONS
(See Notice of Decision of Planning Application 22/02905/FUL for Full Specification)
1 The approved development shall be carried out in accordance with the following drawings/details: (See consent for full list of drawings)
App deposited re cladding deposited and validated 27/04/23
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
TIME LINE SENSITIVITY DETAIL/A CTION TO BE ACTIONE D BY APPLICATION SUBMISSION PROGRESS APPROVAL DATE
Informative
Consented
NMA
25/05/23
2 The development hereby permitted shall begin before the expiration of three years from 2nd December 2021 (2nd December 2024)
3 . The development shall be completed in accordance with samples for all facing materials including fenestration and boundary treatments (gates, fences / walls, other) including details of manufacturing specification which shall be submitted to and approved in writing by the Local Planning Authority before above ground works on site are commenced. The development shall then be built in accordance with these approved samples and completed prior to occupation.
4 1 Notwithstanding the details shown on the approved plans additional architectural detailing plans at scale 1:10/ 1:5 showing all openings and key elements of the building / landscape (windows, doors, facade glazing, fins and parapets, spandrel panels, entrance and associated publicly visible features, signage, lighting in publicly accessible areas, vents / intakes / exhausts, grilles / louvres, rooftop plant, other elevational features shall be submitted to and approved in writing by the Local Planning Authority before the relevant element is commenced on site. The development shall be constructed in accordance with the approved details.
5 Prior to any occupation an updated full and detailed landscape and planting plan, including details of additional tree planting on Brook Street shall have been submitted to and approved in writing by the local planning authority. The Strategy shall include the details of the 6 trees to be planted in Brook Street along with the proposed locations and details of the tree pits and tree grilles. The Trees planted on Brook Street shall comprise of 3no. Fastigiate Hornbeam (Carpinus betulus ‘Fastigiata’) planted at a minimum of 550cm tall with a minimum single clear stem of 200cm and a girth of 30-35cm, and 3no. Fastigiate Hornbeam (Pyrus calleryana ‘Chanticleer’)
Pre above ground works condition
Ref: 23/01117/NMA
MCLH 11th November 2022
Validation details 22/03576/CLC
Consented 30/01/23
22/03576/CLC
Pre development condition, relevant to each section
Pre above ground development
Pre-occupation condition
MCLH Application deposited 15/08/23
Ref: 23/02245/CLC
Validated 22/08/23
Consented 10/10/23
Park Road,
RH2 0DD –
Suite 21, High Cedars, 20 Wray
Reigate
Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Informative
MCLH
planted at a minimum of 450cm tall with a minimum single clear stem of 200cm and a girth of 25-30cm. The Strategy shall be implemented within the first planting season following completion of the development and the landscape and planting shall thereafter be maintained for five years to the satisfaction of the Local Planning Authority. Any trees or planting that die during this period shall be replaced during the following planting season, and the areas shown to be landscaped shall be permanently retained for that purpose.
6 No above ground development shall take place until details of all external lighting have been submitted to and approved in writing by the Local Planning Authority. The external lighting shall be installed in accordance with the approved details and thereby retained as such unless a variation is subsequently submitted to and approved in writing by the Local Planning Authority.
7 Notwithstanding the provisions of the Town and Country Planning (General Permitted Development) (England) Order 2015 (or any Order revoking or re-enacting this Order) No fans, louvres, ducts, external lighting or other external plant other than those shown on the drawings hereby approved shall be installed without the prior written approval of the Local Planning Authority.
8 All works on site shall take place in accordance with the details approved pursuant to 22/00273/CLC (Details of Demolition and Construction Environmental Management Plan)
9 The development shall be carried out in accordance with details approved by 22/00759/CLC (Levels).
10 The development shall be carried out in accordance with details approved under 22/00371/CLC pursuant to Condition 10 (Site Waste Management Plan).
11 Within 6 months of above ground works a Public Realm Management Plan, including measures to minimise any adverse
of
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Pre
MCLH
22/03480/CLC
above groundworks condition
Application deposited 31/10/22 Validated Ref: 22/03480/CLC Consented 23/01/23
Informative
Informative
Informative
Informative
Within 6 months
MCLH Submitted 09.05.24
microclimatic impacts of the development have been submitted to and approved in writing by the Local Planning Authority. Prior to the beneficial occupation of the development hereby approved the hard and soft landscaping shall be fully implemented and made available for all residents and thereafter maintained for the lifetime of the development. commencement of above ground works
12 The development hereby permitted shall be carried out in accordance with the approved Transport Statement. Informative
13 Prior to the commencement of any development above ground level, details of secure cycle parking facilities to serve the development to which this permission relates shall be submitted to and approved in writing by the local planning authority. The cycle parking facilities as shown in the approved details shall be provided prior to beneficial occupation of the development to which this permission relates and shall be permanently retained for that purpose and kept free from obstruction thereafter. Pre development condition (above ground)
14 The hard surfaces hereby approved shall be made of porous materials and retained thereafter or provision shall be made and retained thereafter to direct run-off water from the hard surface to a permeable or porous area or surface within the /curtilage of the property.
Informative
15 The revised energy strategy as approved by 22/00683/CLC on 3rd January 2023 shall be implemented throughout the development of the site. Informative
16
17
Informative
Any flat roofed area that is not identified as communal or private amenity space or roof terrace shall not be converted or used as a balcony or sitting out area, and no access shall be gained except for maintenance purposes.
A public art and way-finding strategy should be submitted to the local planning authority for approval prior to commencement of above ground works. The public art and wayfinding strategy shall identify proposed public art and way-finding works to be installed
Pre above groundworks condition
Consented 21/03/23 Ref: 22/03873/CLC
Park
RH2 0DD –
054
barry@chartplan.co.uk
Suite 21, High Cedars, 20 Wray
Road, Reigate
Registered in England: 5204488 T: 01883 730 877 M: 07843 661
E:
MCLH Consented
Ref: 22/03841/CLC
30/01/23
MCLH
as part of the detailed landscaping strategy. The Strategy shall detail the mechanism for selecting the public art and way-finding works and the maintenance and management of the art works. The works of art shall be installed prior to the beneficial use of the car park or in accordance with the timeframe set out in the public art and wayfinding strategy and thereafter retained in accordance with the agreed maintenance and management plan.
18 Prior to the occupation of the development hereby approved, details of the works relating to highway works required in connection with the proposed bus stop and bus stand, including any relocation of services and pedestrian crossings, shall be submitted to and approved by the Local Planning Authority or by the Council as Highway Authority pursuant to Section 278 of the Highways Act 1980, and carried out in accordance with the approved details. Such details shall include the agreement of levels and construction details. All works are to be to the Council's adoptable highway standards and shall include any associated drainage works, lighting improvements, landscaping, street furniture, road markings, signage, traffic orders, and any necessary alterations to statutory undertakers equipment. Any widening to the public footways shall be retained permanently available for pedestrian circulation and the widened areas dedicated as highway pursuant to the Highways Act 1980.
19 The development shall be carried out in accordance with the details approved on 25.02.2022 Reference 22/02595/CLC (Written Scheme of Investigation WSI - Archaeology). No development shall take place other than in accordance with the agreed WSI, and the programme and methodology of site evaluation and the nomination of a competent person(s) or organisation to undertake the agreed works. If heritage assets of archaeological interest are identified by stage 1 then for those parts of the site which have archaeological interest a stage 2 WSI shall be submitted to and approved by the local planning authority in writing. For land that is included within the stage 2 WSI, no demolition/ development shall take place other than in accordance with the agreed stage 2 WSI which shall include: A. The statement of significance and research objectives, the programme and methodology of site
Pre demolition condition
FHPM/Ch art Plan
DOC app deposited
31.12.21
App validated 05/01/22
Ref: 21/04117/CLC
Additional Archaeology report submitted to LPA, validated 10/08/22
Ref: 22/02595/CLC
Consented 25/02/22
Consented 23/09/22
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
MCLH
Pre occupation condition
investigation and recording and the nomination of a competent person(s) or organisation to undertake the agreed works; B. The programme for post-investigation assessment and subsequent analysis, publication & dissemination and deposition of resulting material. This part of the condition shall not be discharged until these elements have been fulfilled in accordance with the programme set out in the stage 2 WSI.
20 The servicing of commercial unit(s) hereby permitted shall only take place between 0700 and 2000 on any day, including Sundays and Bank Holidays.
21 Prior to occupation a Pedestrian Environment Review Study (PERS), considering the ten Healthy Streets indicators, as set out in the Mayor’s Transport Strategy, 2018 shall be submitted to and agreed in writing by the Local Planning Authority, the findings of which shall be implemented in accordance with timeframes agreed with the Local Planning Authority and thereafter permanently retained.
22 Prior to the occupation of the office, details as to how the approved development has been designed to connect to a future District Heating Network in the surrounding area and provision for the development’s connection shall be submitted to and agreed in writing by the Local Planning Authority and thereafter permanently retained.
Pre occupation condition Milestone
Pre occupation condition MCLH Application deposited and validated 23/11/23 Ref: 23/03103/CLC Decision due by 16.01.24
23 The development shall be carried out in accordance with details approved pursuant to 22/00463/CLC in relation to Condition 23 (Ecological Management Plan) Informative
24 Prior to the occupation of development a Delivery and Servicing Management Plan shall be submitted to and approved in writing by the Local Planning Authority.
25 The rating level of the noise determined by the cumulative sound emissions of the plant hereby permitted shall be at least 5dBA lower than the existing background noise level at any
Pre occupation condition Chart Plan/Unilv er/MIlest one
Informative
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Informative
given time of operation. The noise levels shall be measured or predicted 1m externally to any window at the nearest residential facade. Measurements and assessment shall be made according to British Standard 4142:2014.
26 The site and building works required to implement the development shall be only carried out between the hours of 08.00 and 18.00 Mondays to Fridays and between 08.00 and 13.00 on Saturdays and not at all on Bank Holidays and Sundays.
27 The demolition secured through demolition PD Consent 20/02696/PRA and construction works shall be implemented in accordance with details approved pursuant to Condition 27 (Section 61 of Control of Pollution Act 1974).
28 The Development shall be carried out in accordance with the details approved on 08.03.2022 Reference 22/00411/CLC (Air Quality Technical Note Technical Note J13011 F1)
29 All Non-Road Mobile Machinery (NRMM) of net power of 37kW and up to and including 560kW used during the course of the demolition, site preparation and construction phases shall comply with the emission standards set out in chapter 7 of the GLA’s supplementary planning guidance “Control of Dust and Emissions During Construction and Demolition” dated July 2014 (SPG), or subsequent guidance. Unless it complies with the standards set out in the SPG, no NRMM shall be on site, at any time, whether in use or not, without the prior written consent of the local planning authority. The developer shall keep an up to date list of all NRMM used during the demolition, site preparation and construction phases of the development on the online register.
30 Prior to commencement of above ground works on the development hereby permitted, a Damage Cost Assessment in line with the requirements of the GLA Sustainable Design and Construction Practice must be submitted to and approved in writing by the local authority.
31 The development shall be implemented in accordance with the Fire Statement approved under 22/00557/CLC and retained as such for the lifetime of the development.
Informative
Informative
Informative
Informative
Pre above ground works condition AQ Consultan ts / Chart Plan App deposited 25/10/22 PP-11645457
Validated Ref: . 22/03432/CLC
Informative
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Consented 23/01/23
22/03432/CLC
32 The development shall be carried out in accordance with details approved by 22/03872/CLC on 5th January 2023 regarding the exhaust point to ensure the health and safety of residents nearby.
33 The Development shall be carried out in accordance with the details approved 11.03.2022 Reference 22/00359/CLC (Contamination Ground Investigation Report).
34 Should remedial works be required in relation to contaminated land, the remedial strategy shall be submitted to and agreed in writing by the Local Planning Authority, prior to the commencement of the development works and remedial works. On completion of the agreed remedial works, a closure report and certificate of compliance endorsed by the interested party/parties, shall be submitted to and agreed in writing by the Local Planning Authority, prior to the occupation of the site by end users.
35 If during implementation of this development, contamination is encountered which has not previously been identified, the additional contamination shall be fully assessed and a specific contaminated land assessment and associated remedial strategy shall be submitted to and agreed in writing by the Local Planning Authority before the additional remediation works are carried out. The agreed strategy shall be implemented in full prior to completion of the development hereby approved.
Informative
InformativeRemedial works condition
InformativeContamination condition
36 Prior to commencement of groundworks (excluding site investigations and demolition), a final detailed drainage design, including drawings, supporting calculations, SuDS Statement and Drainage Assessment Form shall be submitted to and approved in writing by the local planning authority. A detailed management plan confirming routine maintenance tasks for all drainage components must also be submitted to demonstrate how the drainage system is to be maintained for the lifetime of the development. The system shall be implemented and thereafter managed and maintained in accordance with the approved details Pre above groundworks condition MCLH Application deposited and validated 22/09/22 Ref: 22/03000/CLC
Consented 09/05/23
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Informative
37 No building hereby permitted shall be occupied until evidence (photographs and installation contracts) is submitted to demonstrate that the sustainable drainage scheme for the site has been completed in accordance with the submitted details. The sustainable drainage scheme shall be managed and maintained thereafter in accordance with the agreed management and maintenance plan for all of the proposed drainage components
38 Within 6 months of the commencement of any development above ground level, details of waste and recycling facilities to serve the development to which this permission relates shall be submitted to and approved in writing by the local planning authority.
Within 6 months of commencement of above groundworks condition
39 The development (including any works of demolition) shall be carried out in accordance with details approved under 22/00306/CLC (Arboricultural Report and Drawings). Informative
40 The approved protection scheme (Condition 39) shall be implemented prior to commencement of any work on site including demolition, and be maintained to the reasonable satisfaction of the Local Planning Authority until the completion of the development or until such stage as detailed within the approved AMS.
Informative
41 The development shall be carried out in accordance with the submitted Flood Risk Assessment (FRA) by Cole Easdon Consultants Limited (dated November 2022; issue no. 2; job no. 8922) and the Design Note by Robert Bird Group titled ‘Flood Volume Attenuation Strategy Clarifications – Updated MSCP’ (dated 02/09/2022; project no. 4881; document no. 4881-RBGZZ-XX-DN-CV-87002, issue 02) and the following mitigation measures it details:
Finished floor levels shall be set no lower than 8.8mAOD for more vulnerable residential uses
Informative
MCLH Application deposited with LPA 07/08/23
Ref: 23/02158/CLC
Validated 09/08/23
Consented 11/10/23
Park Road,
RH2 0DD –
661 054 E: barry@chartplan.co.uk
Suite 21, High Cedars, 20 Wray
Reigate
Registered in England: 5204488 T: 01883 730 877 M: 07843
Pre occupation condition MCLH
• Finished floor levels shall be set no lower than 8.4mAOD for less vulnerable commercial uses
• Finished floor levels shall be set no lower than 7.9mAOD for the commercial reception area
• Flood storage mitigation shall be provided
• Flood voids shall be installed
These mitigation measures shall be fully implemented prior to occupation and subsequently in accordance with the scheme’s timing/phasing arrangements. The measures detailed above shall be retained and maintained thereafter throughout the lifetime of the development.
42 The development shall be carried out in accordance with the submitted Interim Flood Storage Scheme detailed within the letter from MNP to the Environment Agency (SV/ib/220051-04; dated 15 February 2021), with the location of the temporary storage amended in the Design Note by Robert Bird Group titled ‘Flood Volume Attenuation Strategy Clarifications – Updated MSCP’ (dated 02/09/2022; project no. 4881; document no. 4881-RBG-ZZ-XX-DN-CV-87002, issue 02). The car park ramp tank will be implemented at the trigger points specified and remain in perpetuity until the demolition of Lever House is complete.
43 Prior to occupation, a maintenance plan to manage the flood voids and grilles over the lifetime of the development will be submitted to, and approved in writing by, the local planning authority in consultation with the Environment Agency. The Plan should cover general maintenance and inspection as well as maintenance after a flood event. The approved management plan will then be implemented in full throughout the lifetime of the development.
44 Prior to occupation, a scheme detailing the flood resistance measures must be submitted to, and approved in writing by, the local planning authority with guidance from the Environment
Suite
High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
21,
Informative
Pre occupation
MCLH
condition
Pre
condition MCLH
occupation
Agency. The scheme should include details on the passive flood barriers up to 8.31 metres above Ordnance Datum (mAOD) to protect: The shared reception of the Hive and Honey Buildings The car park basement access ramp, stairwell and lift lobbies The scheme shall be fully implemented and subsequently maintained, in accordance with the scheme’s timing/phasing arrangements, or within any other period as may subsequently be agreed, in writing, by the local planning authority.
45 Surface water draining from areas of car park hardstanding shall be passed through an oil separator or series of oil separators, prior to being discharged into any watercourse, soakaway or surface water sewer. The separator(s) shall be designed and constructed to have a capacity compatible with the area being drained, shall be installed prior to the occupation of the development and shall thereafter be retained and maintained throughout the lifetime of the development. Clean roof water or vehicle washdowns and detergents shall not pass through the separator(s) and should be drained instead to foul sewer or sealed system. Informative
46 A Car Park Management Plan demonstrating how the use of the car park will be controlled, including any restrictions and detailing the signage necessary within the site to direct pedestrians and vehicles shall be submitted to and approved in writing by the local planning authority before the first occupation of the development. The development shall be carried out in accordance with the approved details. Pre occupation condition
47 By the time the development hereby permitted is substantially complete, pedestrian/vehicular intervisibility splays of 2.8 m x 3.3 m shall have been provided in each direction where the access meets the back edge of footway, and shall be permanently retained free from any obstruction to visibility higher than 1.0m above ground level.
Informative
MCLH / Occupier
48 Within 6 months of MCLH Application deposited 03/04/23 Consented 31/05/23
Park Road,
RH2 0DD –
054
Suite 21, High Cedars, 20 Wray
Reigate
Registered in England: 5204488 T: 01883 730 877 M: 07843 661
E: barry@chartplan.co.uk
'Within six months of the commencement of the above ground development' details regarding the relocated bus driver welfare facilities on Brook Street, have been submitted to and agreed in writing by the Local Planning Authority. The relocated bus driver welfare facilities shall be delivered in accordance with time frames agreed with the Local Planning Authority prior to development, other than demolition and thereafter permanently retained.
Bus driver welfare facilities will be retained throughout development.
49 A. The development hereby permitted shall incorporate security measures to minimise the risk of crime and disorder and meet the specific security needs of this development in accordance with Secured by Design Commercial 2015 or its equivalent required security standards. Details of these measures shall be submitted to and approved in writing by the local planning authority prior to commencement of the development and shall be implemented in accordance with the approved details prior to occupation.
B. As the proposed development is in close proximity to Kingston Town Centre, a crowded place, I would seek that that a blast assessment be completed by a member of the Register of Security Engineers & Specialists (RSES); this is order to determine the appropriate glazing specification for the building(s).
C. Prior to occupation of the offices a Secured by Design accreditation certificate or its equivalent from the Metropolitan Police Design Out Crime Office shall be submitted to and approved by the Local Planning Authority.
commencement of above groundworks condition
Ref: 23/00892/CLC
D) Prior to the functioning of the multi-story carpark Park Mark Certification is achieved. Pre development condition MCLH / FHPM / Kabsec App deposited 21/02/22
49 REVISED
. A. The development hereby permitted shall incorporate security measures to minimise the risk of crime and disorder and meet the specific security needs of this development in accordance with Secured by Design details approved under
Within 3 months post commencement of ground works.
Validated 22/02/22
Ref: 22/00558/CLC
(Originally submitted under Planning Consent 20/02499 /FUL – App form sent to LPA to request transfer to this app 19/04/2022)
(TRANSIT APPLICATION )*
Consented 28/04/22
TO BE REVISED AS BELOW
Park Road,
RH2 0DD – Registered
730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Suite 21, High Cedars, 20 Wray
Reigate
in England: 5204488 T: 01883
22/00558/CLC (other than the car park/ cycle parking proposed in Building C which is superseded by this permission.) Details of the car park/ cycle parking measures shall be submitted to and approved in writing by the local planning authority within 3 months of commencement of above ground works of the car park. The development shall be implemented in accordance with the approved details prior to occupation. B. As the proposed development is in close proximity to Kingston Town Centre, a crowded place, I would seek that a blast assessment be completed by a member of the Register of Security Engineers & Specialists (RSES); this is in order to determine the appropriate glazing specification for the building(s). C. Prior to occupation of the offices a Secured by Design accreditation certificate or its equivalent from the Metropolitan Police Design Out Crime Office shall be submitted to and approved by the Local Planning Authority. D. Prior to the functioning of the multi-storey car park, Park Mark Certification is achieved. The development shall be implemented in accordance with the approved details.
50 A retail management plan to include opening hours and the link to the wider occupation of the site shall be submitted to the local planning authority for approval prior to commencement of the use of the Eden St retail units. The retail units shall operate in accordance with the approved management plan.
51 Prior to occupation of the new office building, the woodland walk shall be made available to members of the public in accordance with hours of access and a management plan to be submitted to the local planning authority for approval. The woodland walk shall operate in accordance with the approved details.
52 The car park shall be implemented in accordance with the details approved under 22/03504/CLC dated 29th December 2022.
53 The development shall be implemented in accordance with the details approved on 07.03.2022 under reference 22/00292/CLC (Water re-use/harvesting).
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Pre use condition Occupier
Pre
Occupier
occupation condition
Informative
Informative
54 Details shall be submitted to the local planning authority prior to commencement of development to demonstrate how the comprehensive landscaping strategy would achieve the proposed Urban Greening Factor of at least 0.3 within the site. The development shall be carried out in accordance with the approved details prior to occupation of the development.
55 The minimum water consumption targets as per The London Plan 2021, i.e. 105 l/person/day for residential units and a BREEAM rating of ‘Excellent’ for the Wat 01 credits for non-residential uses. It should be stressed that these are the minimum requirements and need to be improved upon where possible
56 . Air Quality Neutral Assessment: A Damage Cost Assessment using the most up to date damage cost toolkit from Defra and the most recent version of the EFT must be submitted to and approved in writing by the local planning authority within 3 months of commencement of development.
57 The development must be carried out in accordance with the Dust Management Plan Reference 22/00618/CLC approved on 07.03.2022. The applicant must install PM10 monitoring equipment at the site boundary, with exact locations to be determined through discussion with the local authority Environmental Health department.
58 No construction shall take place within 5m of the water main. Information detailing how the developer intends to divert the asset / align the development, so as to prevent the potential for damage to subsurface potable water infrastructure, must be submitted to and approved in writing by the local planning authority in consultation with Thames Water. Any construction must be undertaken in accordance with the terms of the approved information. Unrestricted access must be available at all times for the maintenance and repair of the asset during and after the construction works.
condition
Within 3 months of commencement of development condition
Report to be submitted – No time constraint specified.
Application deposited 03/04/23 Ref: 23/00893/CLC Consented 22/05/23
Consultan ts App deposited 25/10/22 PP-11645457
Consented 23/01/23
22/03432/CLC
Suite
High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
21,
MCLH
Pre development
Informative
AQ
Informative
MCLH
59 Any piling must be undertaken in accordance with the terms of the approved piling method statement approved under 22/00390/CLC.
60 In order to demonstrate compliance with the ‘be seen’ postconstruction monitoring requirement of Policy SI 2 of the London Plan, the legal Owner shall at all times and all in all respects comply with the energy monitoring requirements set out in points a, b and c below. In the case of non-compliance the legal Owner shall upon written notice from the Local Planning Authority immediately take all steps reasonably required to remedy noncompliance. a. Within eight weeks of planning permission being issued by the Local Planning Authority, the Owner is required to submit to the GLA accurate and verified estimates of the ‘be seen’ energy performance indicators, as outlined in Chapter 3 ‘Planning stage’ of the GLA ‘Be seen’ energy monitoring guidance document, for the consented development. This should be submitted to the GLA's monitoring portal in accordance with the ‘Be seen’ energy monitoring guidance. b. Once the as-built design has been completed (upon commencement of RIBA Stage 6) and prior to the building(s) being occupied (or handed over to a new legal owner, if applicable), the legal Owner is required to provide updated accurate and verified estimates of the ‘be seen’ energy performance indicators for each reportable unit of the development, as per the methodology outlined in Chapter 4 ‘Asbuilt stage’ of the GLA ‘Be seen’ energy monitoring guidance. All data and supporting evidence should be uploaded to the GLA’s monitoring portal. The owner should also confirm that suitable monitoring devices have been installed and maintained for the monitoring of the in-use energy performance indicators, as outlined in Chapter 5 ‘In-use stage’ of the GLA ‘Be seen’ energy monitoring guidance document. c. Upon completion of the first year of occupation following the end of the defects liability period (DLP) and for the following four years, the legal Owner is required to provide accurate and verified annual in-use energy performance data for all relevant indicators under each reportable unit of the development as per the methodology outlined in Chapter 5 ‘In-use stage’ of the GLA ‘Be seen’ energy
Various submissions
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Informative
monitoring guidance document. All data and supporting evidence should be uploaded to the GLA’s monitoring portal. This condition will be satisfied after the legal Owner has reported on all relevant indicators included in Chapter 5 ‘In-use stage’ of the GLA ‘Be Seen’ energy monitoring guidance document for at least five years. .
61 The development shall be carried out in accordance with the approved details ref. 22/00622/CLC and maintained as such in perpetuity.
62 The development shall be carried out in accordance with the plans and details approved under 22/03626/CLC (Drinking Water Infrastructure) approved 30/12/22, and drinking water made available to the public for free in accordance with the plans and details prior to occupation of the development, and in perpetuity.
63 The measures set out in the Air Quality Positive Statement AQPS approved on 08.03.2022 under reference 22/00412/CLC shall be implemented in accordance with the details so approved, and thereafter retained, unless otherwise agreed in writing by the local planning authority.
64 Prior to the occupation of each building the post-construction tab of the GLA’s whole life carbon assessment template should be completed accurately and in its entirety in line with the GLA’s Whole Life Carbon Assessment Guidance. The post-construction assessment should provide an update of the information submitted at planning submission stage, including the whole life carbon emission figures for all life-cycle modules based on the actual materials, products and systems used. This should be submitted to the GLA at: ZeroCarbonPlanning@london.gov.uk. along with any supporting evidence as per the guidance. Confirmation of submission to the GLA shall be submitted to, and approved in writing by, the local planning authority, prior to occupation of the relevant
65 The development shall be carried out in accordance with the Ducting Space for Full Fibre Connectivity Infrastructure Plans approved on 07.03.2022 under reference 22/00681/CLC these
Informative
Informative
Informative
Pre occupation condition MCLH
Informative
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
building
plans shall be implemented prior to occupation and maintained as such in perpetuity.
66 Prior to the occupation any building, a Post Completion Report setting out the predicted and actual performance against all numerical targets in the relevant Circular Economy Statement shall be submitted to the GLA at: circulareconomystatements@london.gov.uk along with any supporting evidence as per the GLA’s Circular Economy Statement Guidance. The Post Completion Report shall provide updated versions of Tables 1 and 2 of the Circular Economy Statement, the Recycling and Waste Reporting form and Bill of Materials. Confirmation of submission to the GLA shall be submitted to, and approved in writing by, the local planning authority, prior to occupation. Pre occupation condition
67 Notwithstanding the submitted details, prior to commencement of any above ground development (excluding demolition), details of a plant screen on top of Block A and Block B shall have been submitted to and approved in writing by the local planning authority. The approved plant screen shall be installed in accordance with the approved details prior to the occupation of the development hereby approved.
NMA APPLICATIONS
NMA Application deposited re amendments to Building A and B Spandrel Panels
Prior to commencement of above ground works MCLH/ DAA App deposited 25/10/22 PP-11631141
NMA Condition 3 (Facing Materials)
Foot Bridge Link
Consented 26/01/23
22/03431/CLC
Application submission Progress Consent
Deposited with LPA 09/08/23
Ref: 23/02182/NMA
Validated 09/08/23
Deposited 25/09/23
Validated 27/09/23 23/02623/NMA
Deposited and validated 03/10/23
Ref: 23/02702/NMA
Consented 07/09/23
Park
RH2 0DD
054
Suite 21, High Cedars, 20 Wray
Road, Reigate
– Registered in England: 5204488 T: 01883 730 877 M: 07843 661
E: barry@chartplan.co.uk
MCLH
NMA Condition 1 – Louvre NMA Application validated 02/04/24 Ref: 24/00017/NMA
Section 106 Obligations
1 Affordable Workspace contribution
2 Kingston Employment Support Services Contribution
The Owner covenants to pay the Affordable Workspace Contribution to the Council prior to Occupation of the Development.
Kingston Employment Support Services Contribution" means the sum of £232,000 Index Linked to be paid by the Owner to the Council towards the Council's work match brokerage initiative;
£250,000 Prior to Occupation of the development
£232,000, Prior to Commencement of the development. Paid - 6th February 2023
3 Skills Employment and Apprenticeship Plan Contribution.
Skills Employment and Apprenticeship Plan Contribution" means the sum of £50,000 Index Linked to be paid by the Owner to the Council towards implementation of the Skills Employment and Apprenticeship Plan.
4 The Owner covenants to submit to the Council for approval a Skills Employment and Apprenticeship Plan –• 70 employment opportunities for residents of the South London
£50,000 Prior to Commencement of the development Paid - 6th February 2023
Pre-Construction SEP & Stakeholder
Allocation sent to LPA 03.07.23
Within 3 month of commencement of the development
Submitted to the Council for approval
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
No. Item Description Value / percentage Timescale Latest Status
Construction Phase within 3 months of Commencement of the Development to include the following provisions:
Partnership Boroughs or students and graduates of the Mayor's Construction Academy.
• 20 apprenticeships for Local Residents.
• Two Local Businesses to be invited to quote for contracts less than £150,000 in value; and
• Not less than 15% of the total value of goods and services procured throughout the construction phase to be procured from Local Businesses or businesses based in Neighbouring Boroughs The Owner covenants to use its best endeavours to comply with the Skills Employment and Apprenticeship Plan –Construction Phase during the construction of the Development PROVIDED THAT the Owner and the Council may agree amendments to the Skills Employment and Apprenticeship Plan – Construction Phase in writing from time to time.
5 Skills Employment and Apprenticeship Plan –Operational phase
Skills Employment and Apprenticeship Plan – Operational Phase" means a plan setting out targets for local employment, skills and training and detailing mechanisms for delivering such opportunities during the operational phase of the Development
6 Carbon Dioxide Emissions Target Carbon Dioxide Emissions Target” means a 35% carbon reduction against Part L2a of the Building Regulations 2013. 35% carbon reduction against part L2a of the Building Regulations 2013
Within 18 months of commencement of the development.
Following practical completion
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Action for Unilever.
7 Carbon Dioxide Offsetting Contribution
Carbon Dioxide Offsetting Contribution" means a sum of money (Index Linked) calculated on the basis of £60 per tonne for 30 years to be agreed between the Council and Owner (both parties acting reasonably) and paid by the Owner to the Council in the event that the Development cannot achieve the Carbon Dioxide Emissions Target and the shortfall in emissions reduction has not been offset through an accredited scheme or alternative off site off setting has not been agreed with the Council, to be used if payable towards the Council's Carbon Offset Fund which seeks the delivery of carbon dioxide emissions reductions projects within the Royal Borough of Kingston Upon Thames inter alia through retrofit of social housing, schools and civic buildings, investment in renewable energy projects and low-carbon lighting projects;
£60 per tonne for 30 years to be agreed
Following practical completion
8 Energy Monitoring Portal “Energy Monitoring Portal” means the ‘Be seen’ webpage of the GLA’s website and the email address ZeroCarbonPlanning@london.gov.uk, or any other such method of submission that may replace this N/A
9 Construction Environmental Management Plan Construction Environmental Management Plan” means the plan to be submitted by the Owner to the Council for approval in accordance with paragraph 15 of Schedule 1; N/A
10 Construction Phase Flood Management Plan
Construction Phase Flood Management Strategy" means the measures set out in the flood risk assessment prepared by Cole Easdon Consultants Limited dated November 2020 (issue 5) submitted with the Planning Application and the N/A
Cedars,
To be submitted within 8 weeks of the grant of the Planning Permission Completed
Prior to Commencement of the Development the Owner shall submit the Construction Environmental Management Plan
Submitted and approved
The Development shall be constructed and completed in accordance with the approved Construction Ongoing
Suite 21, High
20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
supplementary letter issued by Mason Navarro Pledge Limited dated February 2021 attached to this deed at Appendix 2 as the same relate to the Land;
11 Rooftop Garden Management Plan Rooftop Garden Management Plan" means the plan for the provision of managed public access to the Rooftop Garden as may be varied from time to time in writing; N/A
12 Car Park Management Plan "Car Park Management Plan" means a management plan detailing measures for the management of the use of the car park within the Development including restrictions on use of the car park by users other than the occupier(s) of the offices within the Development. N/A
13 Delivery and Service Management Plan
Delivery and Servicing Management Plan” means the plan to be submitted by the Owner to the Council for approval in accordance with paragraph 16 of Schedule 1; N/A
Phase Flood Management Strategy.
Prior to Occupation of the Development Action for Unilever.
Prior to Occupation of the Development
Prior to Occupation of the Development Action for Unilever
14 District Heating Network “District Heating Network" means a third party district heating network to be developed within the Council's area and which is capable of providing electricity to the Development; N/A DHN rooms provided within Building A and B.
15 Highway and Public Realm Enhancement Works
“Highway and Public Realm Enhancement Works" means the highway and public realm enhancements identified for indicative purposes only on the Highway and Public Realm Enhancements Plan N/A
16 TFL Works TfL Works" means the relocation of Transport for London's welfare facility from Brook Street near the corner of Eden Street as shown for indicative purposes only on the Highway and Public Realm Enhancements Plan; N/A
17 Travel Plan
Travel Plan” means a full travel plan to be submitted to the Council for approval in consultation with Transport for London N/A
Following an agreement pursuant to section 278 of the Highways Act 1980 Discussions ongoing
Within 12 months following first Occupation of the Development Will form part of S278 works
Prior to Occupation of the Development Action for Unilever
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
pursuant to paragraph 14 of the First Schedule;
18 Woodland Walk Management Plan Woodland Walk Management Plan” means a management plan to be submitted to and agreed by the Council in accordance with paragraph 8 of the First Schedule which shall contain arrangements for management of the Woodland Walk including the management of public access to the Woodland Walk;
Prior to Occupation of the Development
Suite
Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
21, High
N/A
Action
for Unilever
FH090-151015 appendix c EAI
Tracker
project: Project Honey - Surrey House Island Site client: Globe Kingston Limited date: 07-May-24 EAI no. EAI date description CRF / other ref. cost agreed 1 25-May-22 BIM CO-034 382,720.00 £ 2 25-May-22 Town Hall CO-024(S1) 54,080.00 £ 3 26-May-22 Gym Loadings Study CO-039 8,268.00 £ 4 26-May-22 Kerb Drop - Lever House CO-093 2,508.42 £ 5 31-May-22 S106 - Latest Version N/A - £ 6 24-Jun-22 Town Hall and Gym Piling/ Substructure CO-041 27,473.05 £ 7 13-Jul-22 Additional Basebuild Energy Modelling, for ASHRAE 90.1 / for LEED CO-042 57,686.57 £ 8 28-Sep-22 Below ground drainage design changes CO-046 15,552.26 £ 9 29-Sep-22 Omission of CAT A across a number of floor on Building A and B CO-053 3,391,861.52 -£ 10 29-Sep-22 Bridge Link Widening to 7.5m CO-035 33,422.00 £ 11 05-Oct-22 Town Hall and Gym full instruction CO-024(S4) 1,658,599.00 £ 12 10-Oct-22 MER/ SER Building A and B changes CO-043 8,840.00 £ 13 13-Oct-22 S73 Façade and Plant Screen Amendments 47,098.21 £ 14 13-Oct-22 MER SER Building B 6th Floor Change CO-043 8,941.00 £ 15 28-Oct-22 Instruction to proceed with the column changes in Building B - £ 16 28-Oct-22 Instruction to proceed 130 additional penetrations and connections into drainage stacks in Building A and B CO-046A 40,052.16 £ 17 28-Oct-22 Instruction to proceed with design of rainwater harvesting under Building C CO-049 9,260.00 £ 18 28-Nov-22 Instruction to proceed with additional pile matt TBC 19 28-Nov-22 All items currently referenced as RAL9010 to be updated to RAL 9016. CO-057 - £ 20 28-Nov-22 Gym full instruction including increase in size of columns CO-059 49,568.31 £ 21 01-Dec-22 Building C Design Fees - Expenditure of Prov Sum N/A 360,000.00 £ 22 14-Dec-22 Building A Ground Floor Amendment CO-060 48,047.41 £ 23 14-Dec-22 Signage Design Costs CO-050 11,400.00 £ 24 27-Jan-23 Rainwater Harvesting tank procurement CO-064 26,406.96 £ 25 27-Jan-23 CHW/ LTHW Uplift Design CO-065 16,473.60 £ 26 27-Jan-23 Ventilation Uplift Design CO-066 11,980.80 £ 27 27-Jan-23 Town Hall Splice Details CO-067 Included in EAI 11 28 27-Jan-23 White and Green Brick confirmation CO-068 82,836.00 £ 29 27-Jan-23 GRC Alternative CO-069 350,000.00 -£ 30 03-Feb-23 Building C FP McCann Procurement - Expenditure of Prov Sum CO-120 Prov Sum Expenditure 31 10-Feb-23 Green Wall Design CO-115 15,858.13 £ 32 14-Feb-23 Town Hall Amendments CO-024 6,507.30 £ 33 15-Feb-23 Building C Below Ground Obstruction CO-109 3,668.78 £ 34 06-Mar-23 LV Panel Design CO-071 11,980.80 £ 35 06-Mar-23 Domestic Water CO-072 10,483.20 £ 36 06-Mar-23 Structural Penetrations CO-073 15,498.08 £ FH020- 151015 https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/08 Instructions/EAI Tracker and Instructions/230605 EA instructions inc register Project Honey 103721 R20 LIVE CHANGE
employer's agent instruction register
employer's agent instruction register
EAI no. EAI date description CRF / other ref. cost agreed 37 09-Mar-23 Wicona CO-114 - £ 38 10-Mar-23 Rainwater Harvesting Tank below ground works CO-098 161,811.10 £ 39 20-Mar-23 New Sewer Connection and Manhole Connection CO-097 Prov Sum Expenditure 40 22-Mar-23 Internal Ramps CO-088 - £ 41 22-Mar-23 Town Hall Design Amendments CO-095 28,570.47 £ 42 24-Mar-23 Building B Spandrels CO-110 - £ 43 28-Mar-23 Terrace Doors CO-082 21,820.70 £ 44 31-Mar-23 Smart Buildings Design CO-078 29,996.37 £ 45 05-Apr-23 Building A penetrations in slab for tenant drainage CO-083 TBC 46 06-Apr-23 Building B penetrations in slab for tenant drainage CO-083 TBC 47 14-Apr-23 MSCP Cast In Channels CO-121 107,121.68 £ 48 17-Apr-23 WC Corridor RCPs CO-085 - £ 49 19-Apr-23 Secondary CAT A Omission CO-061 1,948,328.40 -£ 50 01-May-23 CCTV and access control omission CO-089 206,282.00 -£ 51 16-May-23 Terrace Finishes CO-087 - £ 52 16-May-23 Building A and B Spandrel Panels CO-111 - £ 53 18-May-23 Building C Ducts CO-103 5,517.57 £ 54 31-May-23 Building A Column Size Increase CO-112 - £ 55 31-May-23 Building A Metal Soffit Options CO-113 - £ 56 16-Jun-23 Building C Lift Order N/A - £ 57 16-Jun-23 Circle Sliding Doors CO-079 89,386.00 £ 58 16-Jun-23 Generator Uplift CO-091 21,378.42 £ 59 16-Jun-23 Domestic Water CO-072 18,060.41 £ 60 20-Jun-23 Gym Floor Design Fees CO-099 13,917.93 £ 61 20-Jun-23 Building B Feature Stair 02 Glazed Screen Omission CO-101 175,606.68 -£ 62 23-Jun-23 Utilities Provisional Sum N/A 250,861.60 -£ 63 26-Jun-23 Omission of Undefined Provisional Sums N/A 15,774.00 -£ 64 06-Jul-23 Service Yard Door Clear Opening CO-86 22,176.00 £ 65 11-Jul-23 Mullion Cover Strips Expended in prov sum 66 17-Jul-23 Ventilation Uplift CO-066 356,442.34 £ 67 17-Jul-23 LV Panel Enhancement CO-071 68,345.42 £ 68 17-Jul-23 Modified CAT A CO-074 353,735.16 -£ 69 21-Jul-23 Building C Prov Sum Maple Halsion - £ 70 25-Jul-23 Gym Floor Dead Load Increase CO-131 TBC 71 27-Jul-23 Omission of Soap Dispenser CO-118 31,284.00 -£ 72 15-Aug-23 MSCP Additional Fire Alarm Protection CO- 125 7,810.73 £ 73 15-Aug-23 CHW and LTHW Uplift CO-65 386,303.69 £ 74 15-Aug-23 RAL 9010 Reversion CO-106 5,821.83 £ 75 21-Aug-23 BOH Corridor Ceiling CO-116 95,947.93 £ 76 23-Aug-23 Building A & B Shell and Core Cleaners Sockets CO-123 69,128.09 £ 77 25-Aug-23 Rainwater Harvesting Tank Above Ground CO-100 57,018.51 £ 78 25-Aug-23 WC Hand Dryers (Provision) CO-127 5,938.91 £ 79 25-Aug-23 Building B Door Opening CO-128 - £ 80 09-Oct-23 Corian Alternative CO-135 20,282.52 £ 81 11-Oct-23 Building C Prov Sum Expenditure N/A Prov Sum Expenditure 82 11-Oct-23 Bridge Link Design CO-117 23,135.20 £ 83 25-Oct-23 Feature Stair Nosing CO-137 8,327.36 £ 84 25-Oct-23 Toilet Roll Holders CO-138 10,945.53 -£ 85 25-Oct-23 Temporary Measures CO-139 160,022.22 £ 86 31-Oct-23 Façade Lighting CO-75 129,624.46 £ 87 03-Nov-23 Internal & External Doors CO-133 8,412.80 £ 88 03-Nov-23 Building B Changing Places CO-124 14,196.60 £ 89 03-Nov-23 External Louvres CO-130 26,290.00 £ 90 10-Nov-23 Door Vision Panel Beads CO-141 3,259.96 £ 91 10-Nov-23 Building A & B GF Screed & RAF Omission CO-136 TBC 92 10-Nov-23 Building C Planning Approval CO-142 175,936.00 £ 93 10-Nov-23 BREEAM Man02 CO-143 - £ 94 21-Nov-23 Building C Fitout & Metalwork Packages CO-148 TBC 95 29-Nov-23 Town Hall Steel Intumescent Paint CO-149 21,991.00 £ 96 29-Nov-23 Public Art CO-150 3,680.60 £ 97 01-Dec-23 Fire Curtains CO-152 517,266.00 £ 98 12-Dec-23 MSCP park mark requirements CO-153 5,300.00 £ 99 20-Dec-23 Blind Box Design CO-144 3,680.60 £ 100 20-Dec-23 Woodland walk path widening design CO-155 10,663.23 £ 101 11-Jan-24 WC Frameless Grilles CO-157 24,886.53 £ 102 11-Jan-24 Omission of Tea Point Ductwork and Fan Provision CO-156 29,891.91 -£ 103 12-Jan-24 Wiring Accessories CO-158 - £ 104 12-Jan-24 Blind Box Construction CO-144 TBC FH020- 151015 https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/08 Instructions/EAI Tracker and Instructions/230605 EA instructions inc register Project Honey 103721 R20 LIVE CHANGE
employer's agent instruction register
EAI no. EAI date description CRF / other ref. cost agreed 105 17-Jan-24 Disabled Refuge Emergency Phone Recess CO-159 13,998.16 £ 106 23-Jan-24 Public Art Schematic & Connection Design CO-160 15,248.20 £ 107 26-Jan-24 RAF Omission CO-161 138,611.42 -£ 108 26-Jan-24 Facade Galvanised Steel Brackets CO-162 - £ 109 12-Feb-24 Building A Baby Changing CO-164 5,681.37 £ 110 12-Feb-24 Building C Roof Landscape and Floor Finishes TBC 111 13-Feb-24 Building A Lv9 AHU Clash & BWIC CO-165 2,629.00 £ 112 15-Feb-24 Service Yard Door Proposal CO-166 - £ 113 21-Feb-24 Building A & B Manifestation CO-163 5,994.12 £ 114 23-Feb-24 Building C Shower Shelf & Soap Dispenser Omission CO-154 7,663.42 £ 115 18-Mar-24 Network Infrastructure CO-167 371,916.59 £ 116 19-Mar-24 BOH Door CO-122 23,976.48 £ 117 21-Mar-24 Building B Changing Places Construction CO-144 TBC 118 22-Mar-24 Access Control Hardware/ Containment & CCTV Mounts CO-168 177,601.07 £ 119 26-Mar-24 Brook Street Trees CO-169 TBC 120 26-Mar-24 Water Reduction CO -084 TBC 121 19-Apr-24 Floor Screed CO-172 - £ 122 19-Apr-24 Irrigation to Building C Roof Terrace CO-173 50,085.76 £ FH020- 151015 https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/08 Instructions/EAI Tracker and Instructions/230605 EA instructions inc register Project Honey 103721 R20 LIVE CHANGE
outline programme
FH090-151015 appendix d
PossessionNoticetoMCLH
Contractormobilisation
OriginalSection1CompletionDate(B)
OriginalSection2CompletionDate(AandC)
Constructionperiod-Section1-BuildingB
tenantsearlyaccessBuildingB
Constructionperiod-Section2-BuildingsAandC
tenantsearlyaccessBuildingA
Contigencyto27MonthsTargetPracticalCompletion Date
KeyPackages-StartonSite/Milestones
Piling-VanElle
GroundWorksandFrame-Mitchellsons
CarParkStructure-FPMcCann
Townhallsteelworkscommence
MEPHinstallations-Halsion
Internalfinishes
Toppingout-Allbuildings
Facade-ClarkeFacades
Poweron
Buildingssubstantiallyweathertight
Lifts-Otis
Commencecommissioning
ExtensionsofTime
EoT1-Deferment-Section1(BuildingB)
EoT1-Deferment-Section2(BuildingAandC)
EoT2-TownHallDesign(TVR)-Section1(Building B)
EoT2-TownHallDesign(TVR)-Section2(BuildingA andC)
EoT3-TownHallconstructionimpact-Expected Section1(BuildingB)
EoT3-TownHallconstructionimpact-Expected Section2(BuildingAandC)
15/06/2022
09/11/2024
15/07/2022
15/09/2022
15/07/2022
15/07/2022
15/07/2022
15/09/2022
07/06/2024
07/06/2024
23/08/2024
23/08/2024
12/09/2022
04/08/2024
15/05/2024
06/08/2024
12/09/2022
20/10/2024
29/07/2024
20/10/2024
20/09/2022
20/09/2022
07/10/2022
31/07/2023
18/08/2023
29/08/2023
18/09/2023
08/11/2023
21/11/2023
08/01/2024
23/01/2024
08/01/2024
25/06/2024
02/06/2024
02/06/2024
23/08/2024
18/06/2024
03/09/2024
01/07/2024
16/09/2024
24/07/2023 C:\Users\LukeNurser\Francis Hunter\Francis Hunter - Documents\Projects\03 current\10372 - Project Honey\17 Programme\Surrey House - Post Contract Strat Prog 001e 230724.pp Surrey House, Kingston upon Thames - PROJECT HONEY Outline programme Cube Real Estate/NUFM Line Name StartFinish 2023 2022 2024 JAODFAJ AugustSeptemberOctoberNovemberDecemberFebMarAprMayJunJulAugSepOctNovDec Jan 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 unconditional+permitteddelays Construction
15/08/2024 20/09/2022 07/10/2022 31/07/2023 18/08/2023 29/08/2023
08/01/2024 11/03/2024 08/01/2024 15/08/2024 20/10/2024 12/06/2024 02/09/2024 01/07/2024 16/09/2024 04/08/2024 20/10/2024 1 1 22 33 44 55 66 7 7 8 8 9 9 10 10 1111 12 12 1313 1414 1515 1616 1717 1818 19 19 2020 2121 2222 2323 2424 25 25 2626 2727 2828 2929 3030 3131 20/10/2024 9 Weeks 3 weeks 04/08/2024 27 MONTHS + 8 weeks A B & C Section 1 PC Section 2 PC A B C B A C 22 33 44 7 7 8 8 9 9 12 12 1313 1414 1515 1717 1818 19 19 2020 2424 25 25 2626 2828 2929 3030 3131 Line Name StartFinish JAODFAJ AugustSeptemberOctoberNovemberDecemberFebMarAprMayJunJulAugSepOctNovDec Jan 2023 2022 2024
20/10/2024 09/11/2024
18/09/2023 08/12/2023 21/11/2023
FH090-151015 appendix e G&T
update report
Project Honey
Gardiner & Theobald Progress Report at 25 April 2024
General Update
Building facades and fit out are progressing.
Activities & Progress in Period
Contractor
Valuation and recommendation no 27 of MCLH works for March 2024.
Ongoing review of general & tenant variations.
Interface with tenant team
Ongoing dialogue with MACE cost team in relation tenant changes
Interface with funder team
None in the period
Cost Status
Gardiner & Theobald Cost Report 22 issued 26 March 2024 and Report 23 to be issued 26 April 2024
Procurement
Deck car park MCLH final procurement to allow final agreement.
Design Development
None in the period
Project Honey
Gardiner & Theobald Progress Report at 25 April 2024
Future Works
Continuing valuation of the works. Valuation 27 due date 6 May 2024.
Agreement of remaining provisional sums.
Agreement of further tenant changes.
Agreement of costs with MACE against AFL position.
Information Required
MCLH final costs for deck car park.
MCLH response to outstanding TVO’S
Team
No changes
MCLH update report
FH090-151015 appendix f
25.04.24
2024 Progress
24
Progress Report 24 -
Report
Project Honey
Progress Report 24 - 25.04.24 Contents 1. CDM / Health and Safety ........................................................................................................ 3 2. List of sub-contractors on site: ................................................................................................ 3 3. Construction Update .............................................................................................................. 3 4. Progress/Programme Dropline ............................................................................................... 3 5. Lookahead Activities ............................................................................................................... 3 6. Key Risk Schedule ................................................................................................................... 4 7. Outstanding Instructions/Tennant Variations ......................................................................... 4 8. Site Wide Issues / Matters Affecting Progress ......................................................................... 5 9. Quality and Environmental ..................................................................................................... 5 10. Sustainability ......................................................................................................................... 6 11. Architects Report ................................................................................................................... 7 12. Civils/Structures Report ............................................................... Error! Bookmark not defined. 13. MEP Report ................................................................................. Error! Bookmark not defined. 14. Utility Tracker ........................................................................................................................ 8 15 Contract and Commercial Matters 15 15.1 Valuation ..............................................................................................................................15 15.2 Projected Final Account ........................................................................................................15 15.3 Provisional Sum ....................................................................................................................15 15.5 Project Cash Flow .................................................................................................................19 16 Warranty Tracker ..................................................................................................................20 17 Progress Photos ....................................................................................................................20 18 SHEQ Audit ...........................................................................................................................25 19 Planning Tracker/Update ......................................................................................................32 20 Building Control Tracker........................................................................................................32 21 AOB .............................................................................................Error! Bookmark not defined.

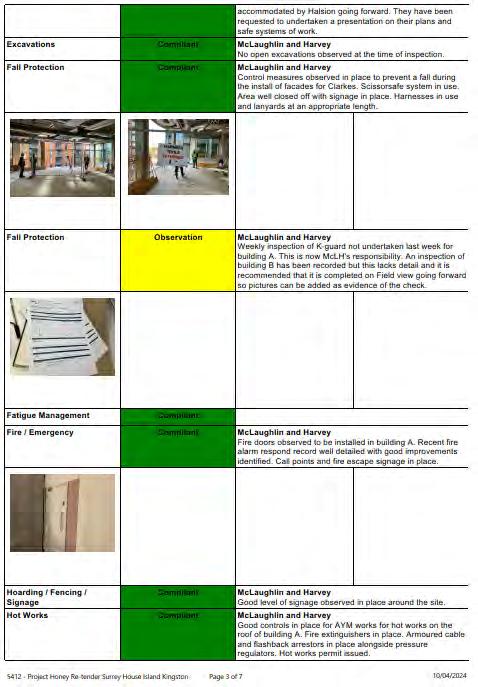

1. CDM / Health and Safety
• Construction Phase and Environmental plans are in place and updated as required.
• All risk assessments / method statements and COSHH assessments currently up to date for the work activities on site.
2. List of sub-contractors on site:
• FP McCann – Precast Multistorey Carpark
• O’Neill & Brennan – Logistics/Waste Management
• Trident – Temporary Electrics & Water
• LTC – Tower Cranes
• ATJ – Partitions/Ceilings
• Halsion – MEP
• RECO – Hoists
• CMF – Metalwork
• Clarkes – Façade
• AYM – Roofing & Cladding
• Swiftcrafted – Core fit out/Joinery.
• Maple – Carpark Façade
• Kingspan – Raised Access Flooring
• Original Joinery – Building C Fitout
3. Construction Update
• Partitions are complete up to level 8 building A, and level 10 building B.
• CAT A - Ceilings ongoing to all floors.
• MEP is up to level 8 building A, and level 10 building B
• UKPN have completed their installations.
• Clarke Façades currently progressing:
Block A: Unitised progressing to level 4. Stick CW from GF – Level 1 ongoing. Block B: Unitised complete to level 7, level 8 ongoing Stick CW from GF- Level 1 ongoing
• AYM Roofing 95% complete on Buildings A, B & C.
• Swift crafted progressing with joinery/tiling/vanity units/doors to Building A & B cores
• Car park fit out ongoing.
• Plant room cladding complete.
• Key plant positioned on to the roof.
• Otis have completed 5No. lifts (Tested). Currently working on the next batch of lifts.
• Raised Access Flooring complete in Building B to levels 2,3 & 4
4. Progress/Programme Dropline
• Block A – 3 weeks and 4 days behind programme due to Twin wall delay
• Block B – 4 weeks and 3 days behind programme due to Twin wall delay
• Block C – 1 week behind programme
5. Lookahead Activities
• FP McCann snagging complete
• CAT A ceilings ongoing
• MEP works ongoing
• CMF steelwork ongoing (Feature stair, reception steel, balustrades etc)
• Roofing ongoing to all three blocks
• Frost Landscaping to Block C roof
25.04.24
Progress
Report 24 -
• Maple completion of façade to car park.
• Clarkes Façade progressing to buildings A & B
• Lift installations ongoing
• Power on
• Building C Fitout ongoing
6. Key Risk Schedule
• Future client variations/TVR’s
• Twin Wall Core impact
• MSCP Provisional Sum
• Planning
o Building A & B Spandrel Panel – NMA Granted 7th September 23
o Building A & B Equitone
o Building C Façade
• LFB ‘sign off’
o CAT A Omissions / Temporary Measures – discussions ongoing regarding Building Control Final Certification
o Building C Façade – LFB submission agreed on current Maple proposal
o Building C Sprinkler Requirements – Insurance Acceptance issued via email from client

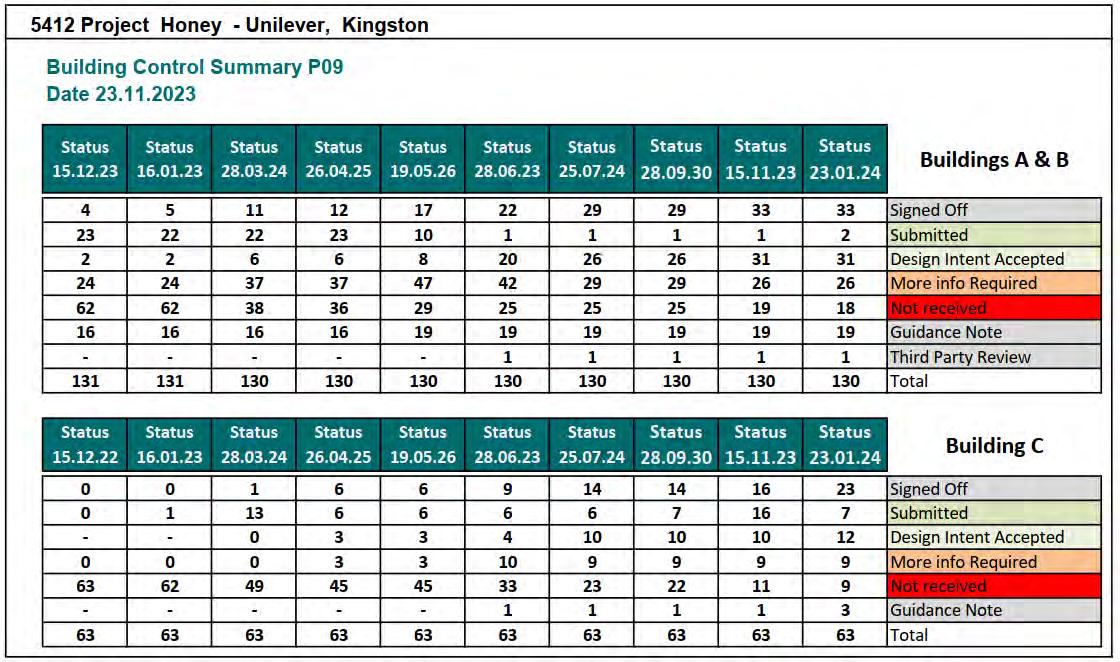

• Building Control Certification
o Discussions ongoing with SWECO regarding Final Cert and Letter of Comfort
• Building C Parkmark Accreditation – instruction issued in part
• Tenant Fit-Out design potentially not aligned with MCLH ER’s / Instructed works (e.g. Modified CAT A/Omissions)
• Access Control – Omitted from MCLH Contract – EAI 118 Issued
• S278 Works
o Tender Pack issued for pricing. Quotations due Mid May ‘24
o RFC now issued
o Works will not be completed for Practical Completion
• SMART Buildings – EAI 115 issued and programme impact being discussed
7. Outstanding Instructions/Tenant Variations
• Integration of Smart Building Technology – EAI 115 issued
• External Lighting – cost currently being rationalised by FH. EAI to be issued
• EAI 29 Rev 1 to be reviewed and comments updated: Anti Drumming, Reverberation etc
• EOT 3 to be updated – Removal of Early Access Dates Schedule, draft dates and protocol submitted to Francis Hunter
• Terrace Façade Penetrations (RFC 54) – cost submitted but revised brief now issued
• General Instructions – future RFC’s instructed will more than likely impact Programme, for example -
- RFC 005 – External Building Signage
- RFC 061 & 070 – Woodland Walk and Building C Roof Terrace; more information required from client
- EAI 089 – Louvres to Façade; design instruction received and being progressed. Impact on construction to be reviewed following detailed design and instructed.
- EAI 096 Public Artwork – RBG & Clarke’s design instructed and completed. FH to issue instruction for detailed design in order to progress.
- EAI 117 – Building B GF Changing Layout; reduced Scope instructed, potential risk to Programme
Progress Report 24 - 25.04.24
- EAI 118 – Access Control Hardware & CCTV Mounts – potential risk to programme (Glazed Door lead in times)
- EAI 104 Rev 3 – Blind Boxes have been instructed including recommencement of Curved Grill procurement. Potential Programme impact as already advised
8. Site Wide Issues / Matters Affecting Progress
• Twin Wall impact
• Wayleaves
9. Quality and Environmental
• Environmental plan in place
• Section 61 approved
• CPDs carried out: Pudlo Waterproofing, quelfire (fire collars), CCL (post tensioning), Imperial Ductwork, British Gypsum and Wicona.
Progress Report 24 - 25.04.24
Progress Report 24

10. Sustainability
- 25.04.24
BREEAM (Tracker attached)
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24

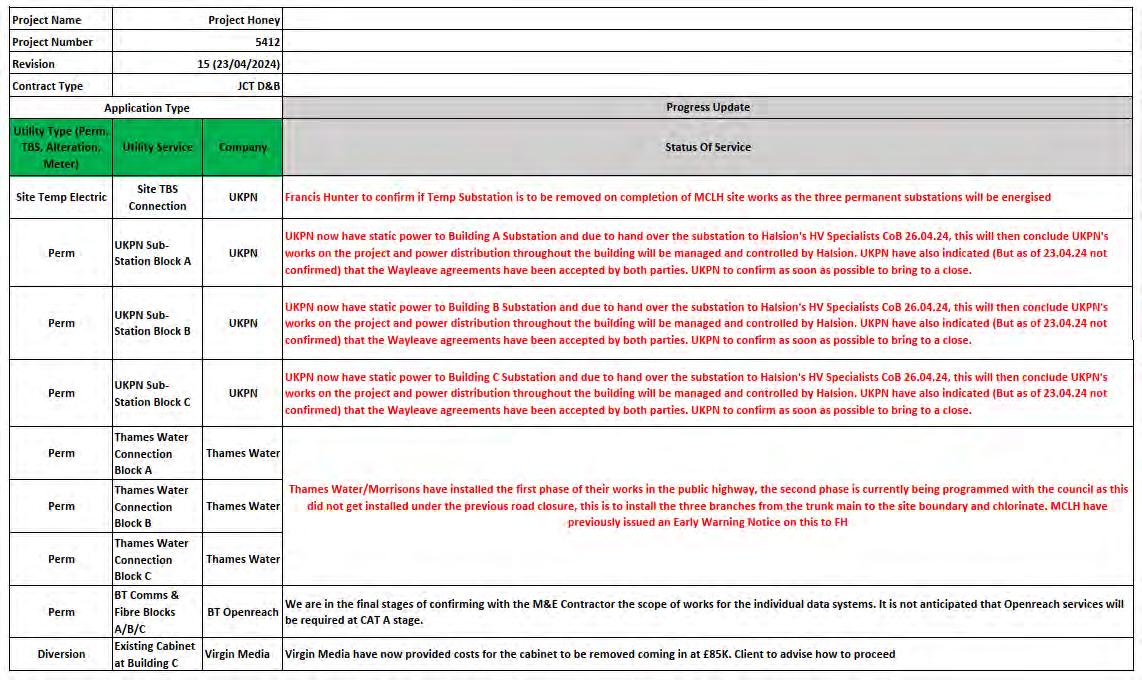

11. Utility Tracker
Progress
12 MEP Report

Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24

13 Civils
Structures Report
- 25.04.24
&
Report 24 - 25.04.24
Progress
14.

Architectural Report

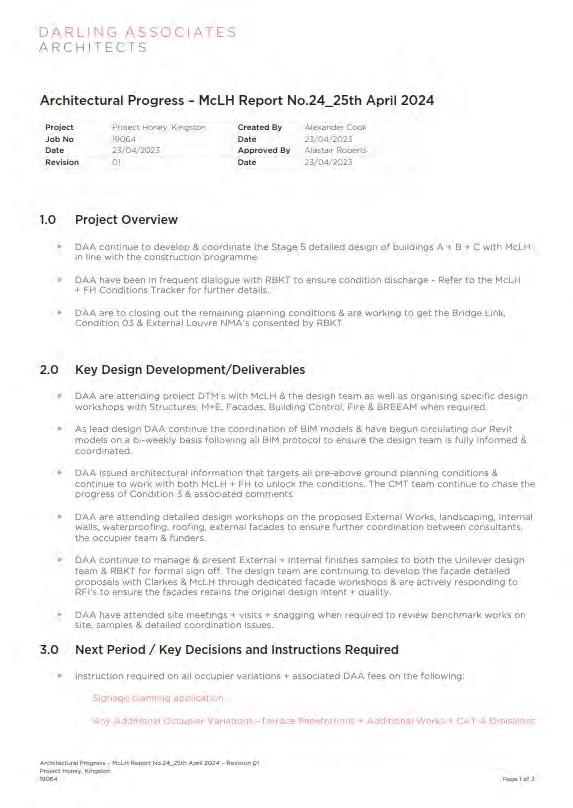

Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
15.1 Valuation
- Valuation Nr 28 to be submitted on the 29th April 2024
- Next payment Cert. due on the 9th May 2024
15.2 Projected Final Account
£121,032,434
15.3 Provisional Sums
• Statutory Authorities £735,000
o £735,000 Omitted (under EAI 063)
o £461,993.51 Addition (under EAI 063)
• Bird Deterrent to Facades £50,000 – to be omitted
• Fibre Backbone Cabling for Wired Score £180,000
• Public Art Works £50,000 (design instructed under EAI 096)
• Asbestos £5,000 (Omitted under EAI 063)
• Newts, bats & bat roosts, Japanese knotweed and hogweed. £5,000 (Omitted under EAI 063)
• UXO £5,000 (Omitted under EAI 063)
• Cycle Path Works including Green Wall to Carpark £295,000 – to be omitted
Progress Report 24 -
15 Contract and Commercial Matters
25.04.24
15.4 Employer Instructions
• EAI 001 – BIM Level 2
• EAI 002 – Townhall design feasibility
• EAI 003 – Gym design feasibility
• EAI 004 – Drop kerb
• EAI 005 – S106
• EAI 006 – Townhall & Gym additional piles (only)
• EAI 007 – ASHRAE
• EAI 008 – Below ground drainage
• EAI 009 – CAT A Omission
• EAI 010 – Bridge Link Widening
• EAI 011 – Townhall & Gym
• EAI 012 – MER and SER Loading Design
• EAI 013 – S73 Façade and Plant Screen Amendment Rev1
• EAI 014 – MER and SER Loading Changes - 6th Floor Building B
• EAI 015 – Building B Column Sizes
• EAI 016 – Above Ground Drainage
• EAI 017 – Greywater and Rainwater Design
• EAI 018 – Additional Pile Mat
• EAI 019 – Change in RAL Colours
• EAI 020 – Gym Structural Changes
• EAI 021 – Building C Fees
• EAI 022 – Building A Ground Floor Amendments
• EAI 023 – Signage Design Costs
• EAI 024 – Rainwater Harvesting Tank (Supply Only)
• EAI 025 – CHW and LTHW Design
• EAI 026 – Ventilation Uplift Design
• EAI 027 – Splice Details
• EAI 028 – Green and White Brick Confirmation
• EAI 029 – GRC Alternative
• EAI 030 – Expenditure of FP McCann MSCP Structure
• EAI 031 – Green Wall Design
• EAI 032 – Town Hall Design Amendments
Report 24 - 25.04.24
Progress
• EAI 033 – Building C Below Ground Obstruction
• EAI 034 – LV Design
• EAI 035 – Domestic Water
• EAI 036 – Structural Penetrations
• EAI 037 - Wicona
• EAI 038 – Rainwater Harvesting Tank
• EAI 039 – New Sewer Connection & Manhole
• EAI 040 – Internal Ramps
• EAI 041 – Townhall Amendments
• EAI 042 – Spandrel Panels
• EAI 043 – Terrace Doors
• EAI 044 – SMART Buildings Design
• EAI 045 – Building A – Slab Penetrations for Future MEP
• EAI 046 – Building B Slab Penetrations
• EAI 047 – MSCP Cast In Channels
• EAI 048 – WC Corridor RCPs
• EAI 049 – Secondary CAT A Omissions
• EAI 050 – CCTV and Access Control Omissions
• EAI 051 – Terrace Finishes
• EAI 052 – Building A and B Spandrels
• EAI 053 – Building C Ramp Ducts
• EAI 054 – Building A Column Sizes
• EAI 055 – Building A Soffit to Retail Entrance
• EAI 056 – Expenditure of Building C Lifts
• EAI 057 – Circleslide Doors
• EAI 058 – Generator Uplift TVR Construction Works
• EAI 059 – Domestic Water TVR Construction Works
• EAI 060 – Gym Floor Design
• EAI 061 – Building B Stair Glazed Screen/Fire Curtain Omission (Levels 1-10)
• EAI 062 – Expenditure of Utilities Prov Sum
• EAI 063 – Omission of Undefined Provisional Sums
• EAI 064 – Service Yard Door
• EAI 065 – Mullion Cover Strips
Progress Report 24 - 25.04.24
• EAI 066 – Ventilation TVR Construction Works
• EAI 067 – LV Panel Enhancement Construction Works
• EAI 068 – Modified CAT A
• EAI 069 – Maple & Halsion MSCP Construction Works
• EAI 070 – Gym Floor Dead Load Increase
• EAI 071 – Omission of Soap Dispensers
• EAI 072 – MSCP Additional Fire Alarm Protection
• EAI 073 – CHW & LTHW Uplift
• EAI 074 – RAL 9010
• EAI 075 – BOH Corridor Ceilings
• EAI 076 – Building A & B Shell and Core Sockets
• EAI 077 – Rainwater Above Ground
• EAI 078 – WC Hand Driers
• EAI 079 – Building B Opening
• EAI 080 – Corian Alternative
• EAI 081 – Building C Packages (Brick, Block, Roof)
• EAI 082 – Bridge Link Design
• EAI 083 – Building A Feature Stair Nosing
• EAI 084 – Omission of Toilet Roll Holders
• EAI 085 – CAT A Temporary Measures
• EAI 086 – Façade Lighting
• EAI 087 – Internal & External Doors (Design)
• EAI 088 – Building B Changing Places (Design)
• EAI 089 – External Louvres (Design)
• EAI 090 – Door Vision Panel Beads
• EAI 091 – Building A & B GF Screed and RAF Omission
• EAI 092 – Building C Planning Approval
• EAI 093 – BREEAM MAN02 Credit omission
• EAI 094 – Building C Fitout and Metalwork Packages
• EAI 095 – Town Hall Intumescent paint
• EAI 096 – Public Art Design
• EAI 097 – Feature Stair Curtains
• EAI 098 – MSCP Access Control/Park Mark/CCTV
Progress Report 24 - 25.04.24
• EAI 099 – Blind Box Design
• EAI 100 – Woodland Walk Widening Design
• EAI 101 – WC Frameless Grilles
• EAI 102 – Omission of Tea Point Fans & Ducts
• EAI 103 – Wiring Accessories
• EAI 104 – Blind Box Construction Rev3
• EAI 105 – Disabled Refuge Phone Recess
• EAI 106 – Public Art Schematic & Connection
• EAI 107 – RAF Omissions
• EAI 108 – Galv. Brackets
• EAI 109 – Building A Baby Changing
• EAI 110 – Building C roof Landscaping
• EAI 111 – Building A Level 9 AHU Clash
• EAI 112 – Service Yard Door
• EAI 113 – Building A & B Manifestation
• EAI 114 – Building C Shower Shelf
• EAI 115 – SMART Network Infrastructure
• EAI 116 – BOH Door
• EAI 117 – Building B Changing Places Instruction
• EAI 118 – Access Control Hardware & CCTV Mounts
• EAI 119 – Brook Street Trees
• EAI 120 – Water Reduction
• EAI 121 – Floor Screed
• EAI 122 – Irrigation to Building C
15.5 Project Cash Flow
• Cashflow issued on 1st December 22 in line with Townhall Instruction
• Cashflow Rev 1 issued on 8th August 23
• Cashflow Rev 2 issued on 6th February 24
• Cashflow Rev 3 issued on 6th March 24
Progress Report 24 - 25.04.24
16 Warranty / Sub-Contract / Appointment Tracker
• See attached
• Key Changes in the period
o Warranties – Francis Hunter have issued client version as a REV E Tracker
o Certified Sub-Contracts
AYM issued
Sub-Sub-Contracts – clarity needed around certifying of these
MCLH to issue any further redacted Sub-Contracts upon signing
17 Procurement schedule
Key Changes in the Period
• Building A & B (see attached)
• Building C (see attached)
18 Commercial and Contractual (in the Period)
• Early Access Protocol
o DRAFT issued to Francis Hunter
Overbury/Mace have returned comments; MCLH to review
o Early Access Protocol meetings ongoing with Overbury & Mace
o Point cloud Survey Parameters issued by MCLH
• Early Warnings
o EWN 001 – Brooke Street Closure; issued on 24/03/23
o EWN 002 – Thames Water; issued on 18/10/23
o EWN 003 – UKPN Wayleaves; issued on 19/03/24
Progress Report 24
- 25.04.24

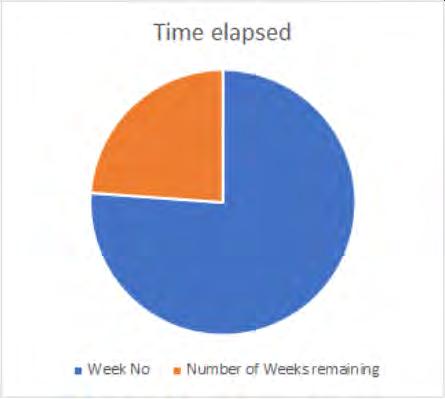

Progress
A Unitised Progressing

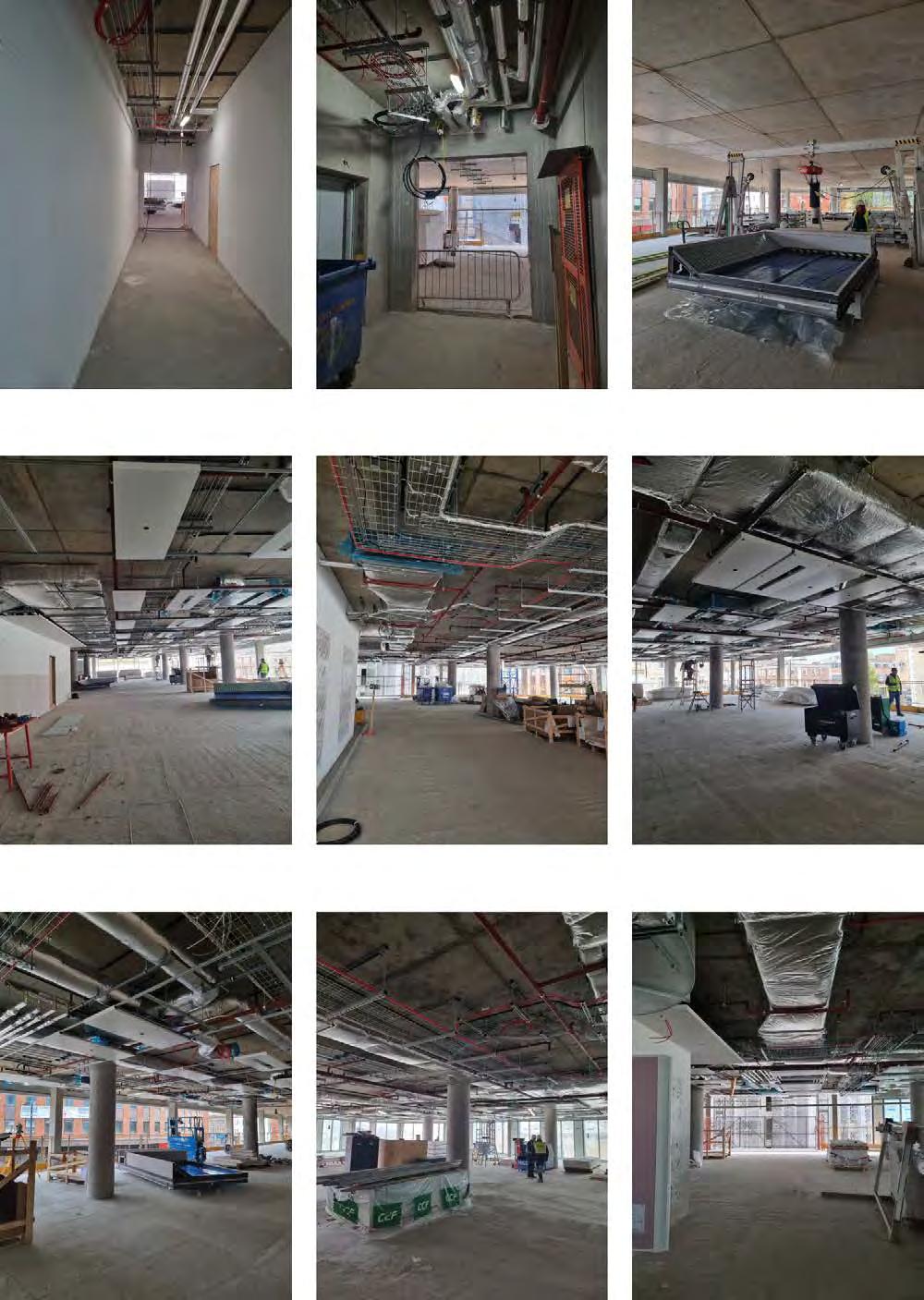

Report 24 - 25.04.24 19 Progress Photos Block

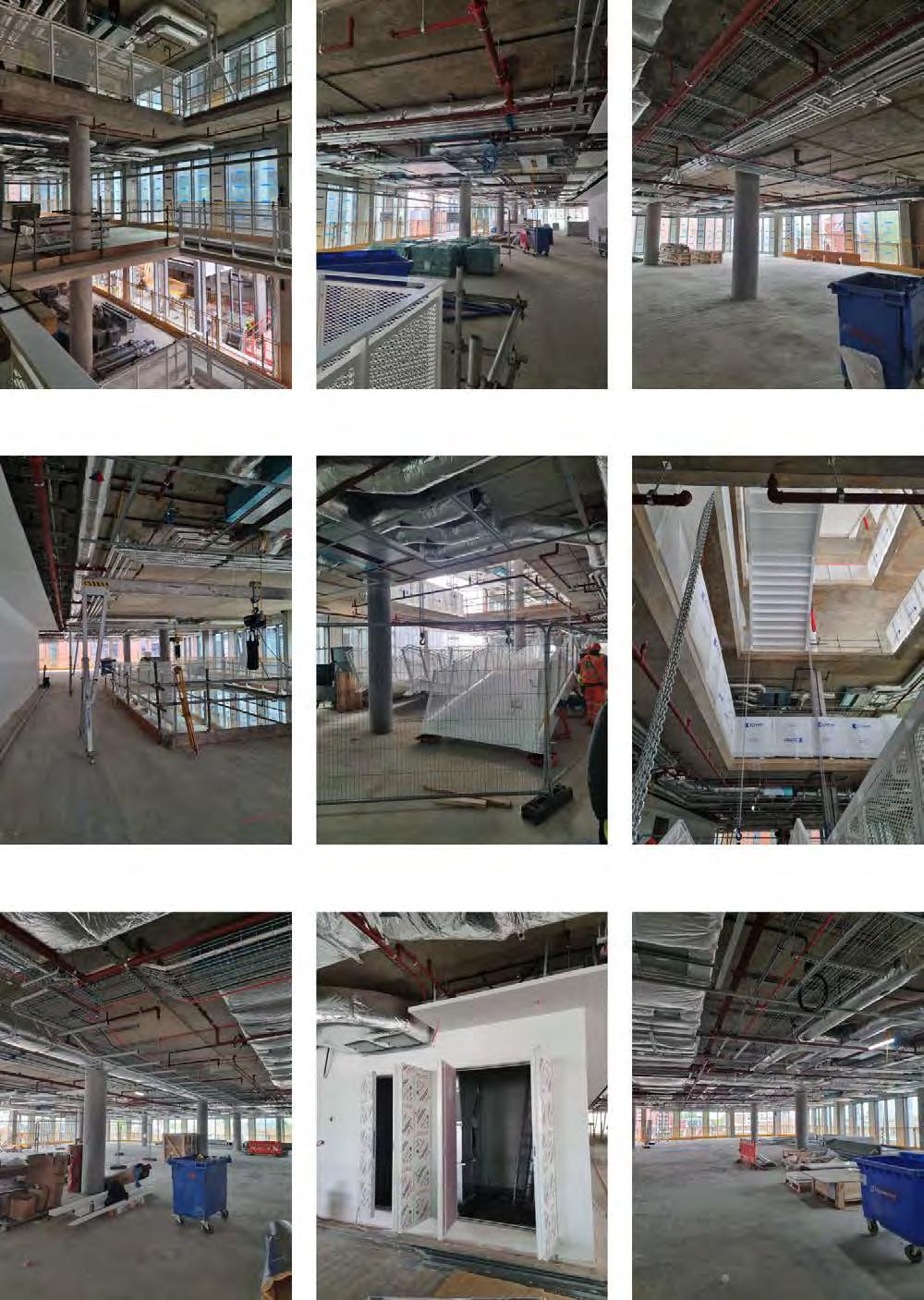

Progress Report 24 - 25.04.24

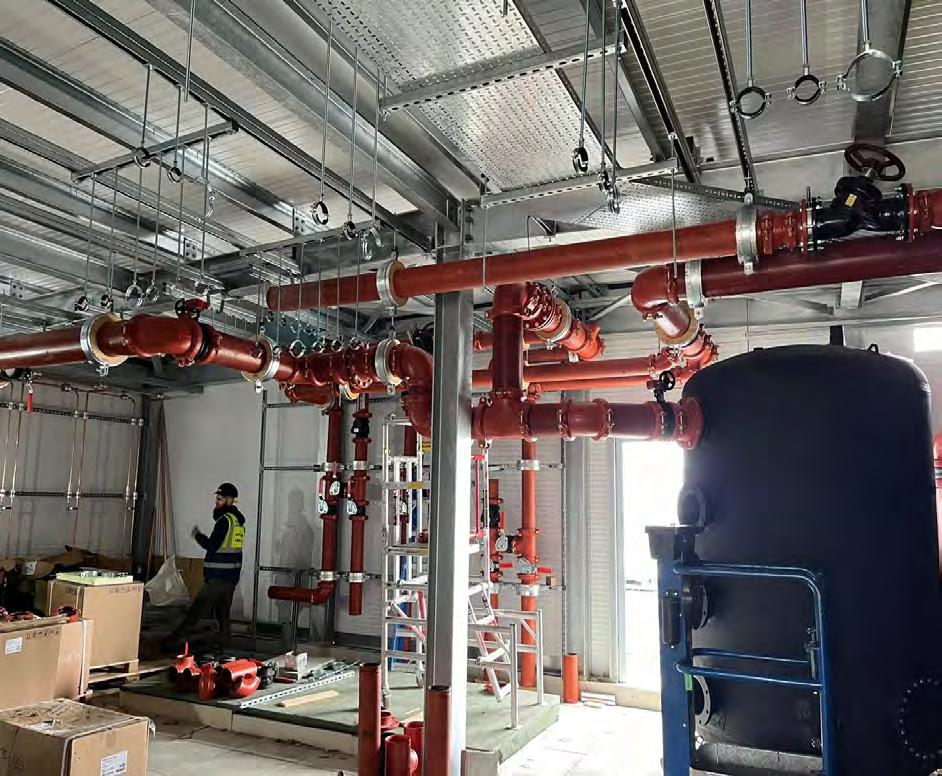

Block A Pipework Progressing
Progress Report 24 - 25.04.24
Building B Roof Plant Room
Progress Report 24 - 25.04.24
Car Park MEP Ongoing
Progress Report 24

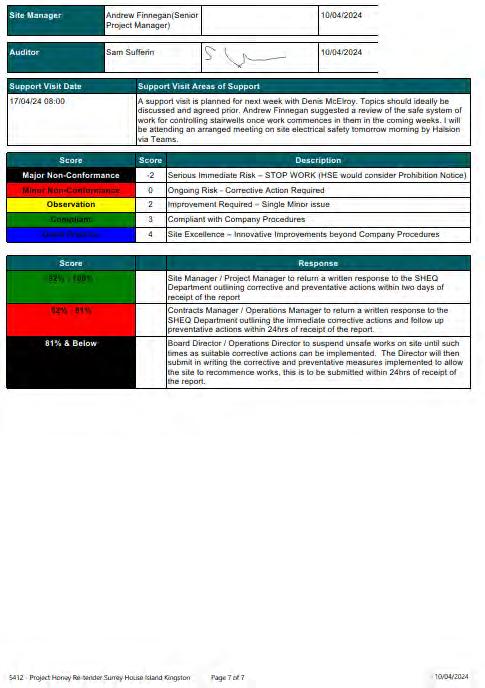

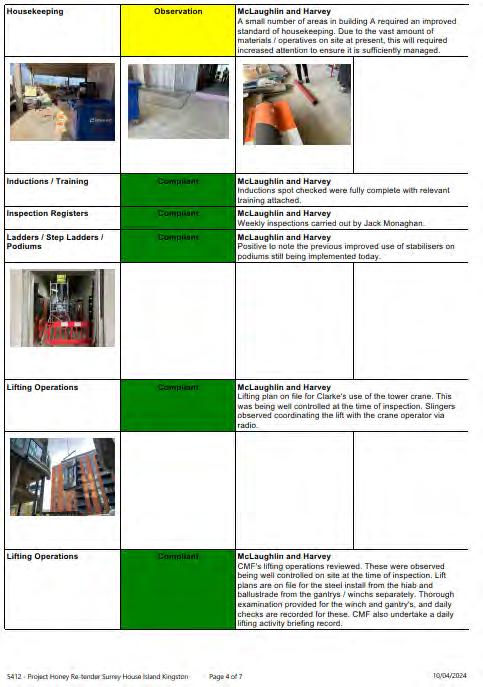

20 SHEQ Audit
- 25.04.24
Report 24 - 25.04.24
Progress
Report 24 - 25.04.24
Progress
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24

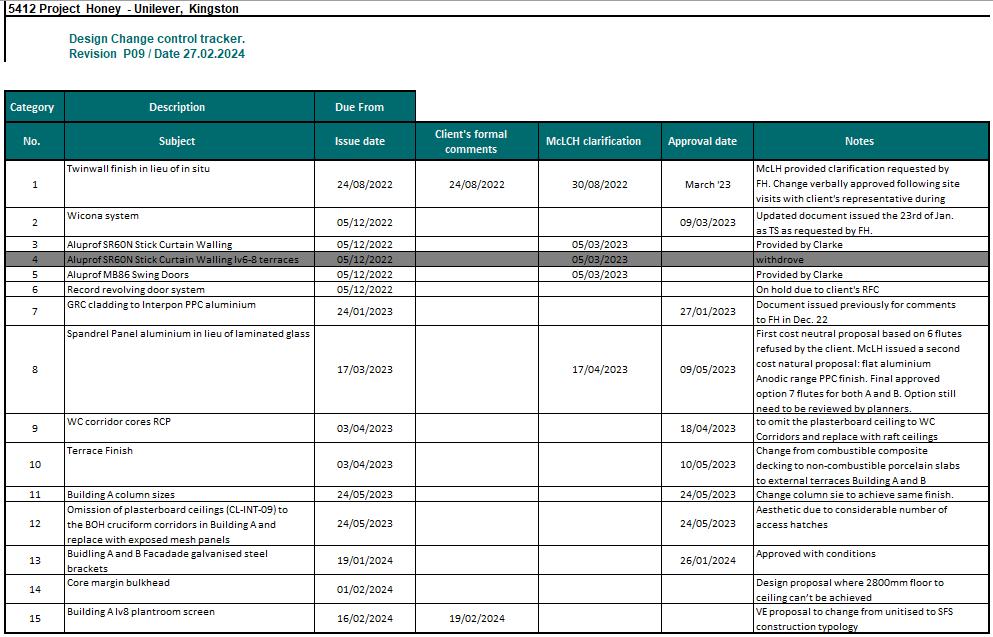

Progress Report 24 - 25.04.24 21 Planning Tracker/Update *Latest planning condition tracker has been issued 22 Building Control Tracker 23 Change Control Tracker
FH090-151015 appendix g
BREEAM tracker
Project Honey BREEAM Tracker - Design Stage
Ref Issue Credit Credit requirements Credits available Targeted Stage 4 Design Stage credit status Credit evidence responsibility Target completion date Credit progress Project delivery planning Project delivery stakeholders have met to identify and define their roles, responsibilities and contributions for each of the key phases of project delivery 1 1 Complete McLH / Design Team Evidence should demonstrate activities have taken place prior to RIBA stage 2 completion Evidence provided in support of this credit: • Design responsibility matrix confirms roles, responsibilities and contributions. • Project Execution Plan • Communication Strategy (covered in digital collaboration plan) • Initial Project Brief (early sustainability options appraisal has been provided) Also provided: • DAA - Completed Man 01 stakeholder consultation matrix - this will summarise contribution stakeholders made in influencing the design and delivery of project throughout the concept (and technical) design stages. Stakeholder consultation (interested party) Prior to completion of the Concept Design stage, all relevant third party stakeholders have been consulted by the design team Demonstrate how the stakeholder contributions and consultation exercise outcomes influence the Initial Project Brief and Concept Design Prior to completion of the detailed design (RIBA Stage 4, Technical Design or equivalent), all interested parties give and receive consultation feedback 1 1 Complete McLH / DAA Evidence should demonstrate activities have commenced prior to RIBA stage 2 completion and continue to RIBA Stage 4 As above, Please complete the Man 01 stakeholder consultation matrix - this will demonstrate how the engagement exercise influenced the brief and design and how this was communicated to stakeholders. DAA have completed Man 01 matrix (with input from McLH as appropriate) BREEAM AP (Concept Design) A BREEAM AP has been appointed to facilitate the setting and achievement of BREEAM performance targets for the project (Stage 1) 1 1 Evidence provided in support of credit - accreditation number of the BREEAM AP and examples of concept design stage pre-assessment activity and support. BREEAM AP (Developed Design) A BREEAM AP has been appointed to monitor progress against the agreed BREEAM performance targets throughout the design process 1 1 As above Elemental life cycle cost (LCC) An outline, entire asset elemental life cycle cost (LCC) plan has been carried out at Process Stage 2 2 2 Elemental LCC report has been prepared. Component level LCC Plan A component level LCC option appraisal has been developed by the end of Process Stage 4 1 No longer targeted. Component level LCC report - team report that this has been completed?? McL&H please confirm appointment and share completed component level LCC reporting, complete with options appraisal and demonstrate how this has influenced building and systems design and specification to minimise life cycle costs. Capital cost reporting The capital cost for the building in pounds per square metre (£k/m²) is reported Capital cost The capital cost for the building includes the expenses related to the initial construction of the building: – Construction, including preparatory works, materials, equipment and labour – Site management – Construction financing – Insurance and taxes during construction – Inspection and testing Costs related to land procurement, clearance, design, statutory approvals and post occupancy aftercare are not included 1 1 Work in progress McLH QS (G&T) Client (commitment) Feb-23 Please predict capital cost. This should be confirmed in writing on headed paper and signed by appropriate individual. Environmental management All timber and timber-based products used during the construction process of the project must be legal and sustainable timber (e.g. FSC PEFC recycled). The principal contractor operates an environmental management system (e.g. ISO 14001) covering their main operations and implements best practice pollution prevention policies and procedures (e.g. PPG6 ). 1 1 Almost complete Demolition (Shorts) and Principal Contractor (McLH) Jan-23 Draft letter template under review with McL&H, this will help to confirm: All timber and timber-based products used during the construction process of the project are legal and sustainable timber and provide copies of PEFC / FSC certificates. McLH Please sign and return letter. McLH Please complete, sign and date a copy of the attached Man 03 Pollution Prevention checklist. McLH has provided a copy of their ISO 14001 cert. Shorts have provided: A copy of the ISO 14001 cert has been receievd. Early site activity: copies of FSC certs have been provided from McLH please also provide copiesof invoices from relevant suppliers.
Agreed target rating: BREEAM Excellent (score of >70% required PLUS mandatory credits / issues highlighted in red) Current projected design stage score (All 'Targeted' credits): 79.54% Latest revision:02/02/2024 BREEAM New Construction, 2018 - Shell and Core assessment EDC-ARM-xx-xx-SH-A0100 Management (0.61% per 1 credit) Man 01 McLH to apt QS (G&T) Sustainable Procurement Man 02 Life Cycle Cost and Service Planning BREEAM AP Complete Complete
Please
Training,
Monitoring
principal contractor. The principal contractor analyses these items.
Draft letter template under review with McL&H - please sign and send back
Early stage site activity: CLOCS and CCS accreditation being sought by McL&H certificate of compliance and 1st CCS repor issued, performance on track.
Draft letter template under review with
McL&H has registered the site with SMARTWaste - this is the confirmed method for monitoring and reporting energy and water consumption
PLEASE CONTINUE TO PROVIDE MONTHLY UPDATES AND AN UPDATED REPORT ON COMPLETION OF PROJECT
Draft
Transport impacts must be monitored. This information must be recorded in SMARTWaste (or similar) for credit to be targeted.
PLEASE ENSURE THIS IS MONITORED AND PROVIDE MONTHLY UPDATES AND AN UPDATED REPORT ON COMPLETION OF PROJECT
BREEAM AP (Site) BREEAM AP is appointed during construction stage to monitor the project to ensure ongoing compliance with the relevant sustainability performance/process criteria, and therefore BREEAM target(s), during the Construction, Handover and Close Out stages 1 1 Complete BREEAM AP (ARMILA) BREEAM AP appointed. On-going engagement. Performance targets to be agreed and worked towards. Responsible site management One credit mandatory for Excellent Site managed in accordance with the BREEAM responsible site management requirements as highlighted in BREEAM table 4.1. 2 2 Jan-23
letter template under review with McL&H . McL&H has registered site with CCS scheme and will commit to targeting a score of no less than 39.
recent site visit and CCS score of 43 noted. Exemplary level criteria All site management requirements, as outlined in BREEAM table 4.1, will be addressed. 1 1 Jan-23 AS above PLUS
Draft
Most
also provide evidence to confirm the following will be committed to: Tidiness
Ensure clear and safe access in and around the buildings at the point of handover.
g.
awareness and feedback
The fleet operators, undertakes driver training and awareness to promote safety within the development footprint and off site.
p.
and reporting
The fleet operators, captures and investigates any road accidents, incidents
near misses
reports them back to the
q.
and
and
Monitoring of construction site impacts - Utility consumption (energy and water) Monitor and record data on energy consumption (kWh) and water consumption (m3) as a result of the use of construction plant, equipment and site accommodation 1 1 Jan-23
McL&H
.
Monitoring
construction site impacts
Transport
construction materials
waste Monitor
record data
consumption (litres) and total carbon dioxide emissions (kgCO2 eq)) on transport movements and impacts resulting from delivery of the majority of construction materials to site and construction waste from site 1 1 Jan-23
of
-
of
and
and
(fuel
letter template under review with McL&H .
Commissioning testing schedule and responsibilities One credit mandatory for Excellent Prepare a schedule of commissioning and testing. Appropriate project team member(s) is appointed to monitor and programme pre-commissioning, commissioning, testing and, where necessary, re-commissioning activities in compliance with Building Regulations, BSRIA and CIBSE guidelines. Fully train the occupier or facilities team in the operation of the system. 1 1 Jan-23
letter template under review with McL&H . Please provide copies of commissioning schedule, confirming testing schedule and inspection of building fabric (in accordance with required standards, within suitable timescales
prior to handover).
training requirements.
individual
monitor
testing
where necessary include re-commissioning
client). Commissioning design and preparation During the design stage, the client or the principal contractor appoints an appropriate project team member, provided they are not involved in the general installation works for the building services systems: .a Undertaking design reviews and giving advice on suitability for ease of commissioning. .b Providing commissioning management input to construction programming and during installation stages. .c Management of commissioning, performance testing and handover or post-handover stages. 1 1 By end of RIBA 4 Draft letter template under review with McL&H . Please provide confirmation of the individual (who is not involved in the general installation works for the building services systems and who is a specialist commissioning manager) who at design stage can provide: a.design reviews and giving advice on suitability for ease of commissioning.
commissioning management input to construction programming and during installation stages.
Management of commissioning, performance testing and handover or post-handover stages. Testing and inspectingbuilding fabric The integrity of the building fabric, including continuity of insulation, avoidance of thermal bridging and air leakage paths is quality assured through completion of post construction testing (thermographic survey and air pressure test) 1 1 Almost complete McLH Jan-23 Draft letter template under review with McL&H. Please provide confirmation that the following will be allowed for: post-construction testing and inspection to quality-assure the integrity of the building fabric, including continuity of insulation, avoidance of thermal bridging and air leakage paths. Commitment to rectify any defects identified during post-construction testing and inspection prior to building handover and close out. Handover BUGs One credit mandatory for Excellent A Building User Guide (BUG) is developed prior to handover AND a training schedule is prepared for building occupiers/premises managers 1 1 Almost complete McLH Jan-23 Draft letter template under review with McL&H. McLH committed to preparing BUGs for FM and everyday user and a training schedule for building occupiers / managers. Copies of POs provided in support of evidence requirements. Commitment to deliver training within letter template - please sign and return letter. Almost complete Almost complete Man 03 Responsible Construction Practices McLH McLH Commissioning and Handover Man 04 McLH Health and Wellbeing (0.72% per 1 credit) Complete
Draft
and
Confirm
Confirm
with responsibility to
and programme pre-commissioning, commissioning and
(and
activities on behalf of the
b.
c.
View out 95% of the floor area in 95% of spaces for each relevant building areas is within 8m of a wall which has a window or permanent opening that provides an adequate view out AND window/opening must be ≥ 20% of the surrounding wall area Where the room depth is greater than 8m, the percentage of window or opening must instead be the same as, or greater than, the values in Table 1.0 BS8206 1 1 Complete DAA Complete Marked-up drawings and elevations have been provided by DAA for Building A and Building B. The room depth is greater than 8m, therefore the percentage of window / glazing has been calculated and confirmed to be greater than the values in Table 1.0 BS8206: Part 2 (i.e. likely required to be at least 35%) . Marked-up drawings recived for Building A and Building B demonstrate an adequate view out will be achieved from a seated position. It is confirmed that this is of a landscape or buildings (rather than just the sky) at seated eye level (1.2–1.3m) within the relevant building areas and will be through an external window glazing. Internal and external lighting levels, zoning and control Internal: Internal lighting in all relevant areas of the building is designed to provide illuminance (lux) levels and colouring rendering index in accordance with the SLL Code for Lighting 2012 and any other relevant industry standard. Internal lighting should be appropriate to the tasks undertaken, accounting for building user concentration and comfort levels. For areas where computer screens are regularly used, the lighting design complies with CIBSE Lighting Guide 7 sections 2.4, 2.13 to 2.15, 2.20, and 6.10 to 6.20. This gives recommendations highlighting: a. Limits to the luminance of the luminaires to avoid screen reflections. (Manufacturers’ data for the luminaires should be sought to confirm this.) b. Any area where a surface is used to reflect light in to a space, such as uplighting, the recommendations refer to the luminance of the lit ceiling rather than the luminaire; a design team calculation is usually required to demonstrate this. c. Recommendations for direct lighting, ceiling illuminance, and average wall illuminance. External: External lighting design in accordance with BS 5489-1:2013 Lighting of roads and public amenity areas3 and BS EN 12464-2:2014 Light and lighting Lighting of work places Part 2: Outdoor work places. External Lighting should provide illuminance levels that enable users to perform outdoor visual tasks efficiently and accurately, especially during the night. Zoning: Internal lighting is zoned to allow for occupant control (In office areas, zones of no more than four workplaces Workstations adjacent to windows or atria and other building areas separately zoned and controlled Seminar and lecture rooms: zoned for presentation and audience areas demonstration area Auditoria: zoning of seating areas, circulation space and lectern area) AND lighting designed in accordance with CIBSE Lighting Guide 5 1 1 More information required External lighting designer May 2023 External lighting designer to confirm: External lighting design in accordance with BS 5489-1:2013 Lighting of roads and public amenity areas3 and BS EN 12464-2:2014 Light and lighting - Lighting of work places - Part 2: Outdoor work places. External Lighting should provide illuminance levels that enable users to perform outdoor visual tasks efficiently and accurately, especially during the night. External lighting plan and calculations to be provided.
provided from Halsion confirms: 'All internal lighting to be LED and designed to LG7. External lighting to be designed to BS12464-2. Zonal philosophy to be produced. LG5 not applicable.' Internal lighting calculations provided for Building A and Building B. written confirmation (email / letter) that these meet the BREEAM requirements as noted opposite. Indoor air quality (IAQ) plan An indoor air quality plan has been produced, must consider the following: .a Removal of contaminant sources b Dilution and control of contaminant sources: .i Where present, consideration is given to the air quality requirements of specialist areas such as laboratories c Procedures for pre-occupancy flush out d Third party testing and analysis e Maintaining good indoor air quality in-use. pre-requisite More information required McL&H May 2023 IAQ planprovided by Halsion. MCL&H Please prepare compliant IAQ plan as per guidance issued. Ventilation Provide fresh air into the building in accordance with the criteria of the relevant standard for ventilation; Ventilation pathways are designed to minimise the ingress and build-up of air pollutants inside the building (The building has been designed to minimise the concentration and recirculation of pollutants in the building (intakes and exhausts 10m apart and in accordance with relevant standards); Where present, HVAC systems must incorporate suitable filtration to minimise external air pollution, as defined in BS EN 16798-3:2017. The specified filters should achieve supply air classification of at least SUP 2; Areas of the building subject to large and unpredictable or variable occupancy patterns have carbon dioxide (CO ₂ or air quality sensors specified and: i. In mechanically ventilated buildings or spaces: sensors are linked to the mechanical ventilation system and provide demand-controlled ventilation to the space ii. In naturally ventilated buildings or spaces: sensors either have the ability to alert the building owner or manager when CO ₂ levels exceed the recommended set point, or are linked to controls with the ability to adjust the quantity of fresh air, i.e. automatic opening windows or O36 For naturally ventilated or mixed mode buildings, the design demonstrates that the ventilation strategy provides adequate cross flow of air to maintain the required thermal comfort conditions and ventilation rates in accordance with CIBSE AM10 1 1 Complete Halsion May 2023 Halsion confirm design will be developed to be BREEAM compliant and any required sensor locations will be included on final layouts.
of the ventilation layout plan drawings have been provided. Mark-up drawings confirming CO2 sensor locations have been provided. Relevant specifications to be provide and confirmation that these comply with requirements (as per letter template provided). - email 2/2/2024 Please ensure spec is updated to read: ' The specified filters should achieve supply air classification of at least SUP 2'. Page 7 provides a 'sample' Thermal modelling Thermal modelling has been carried out using software in accordance with CIBSE AM11 demonstrating required thermal comfort levels have been achieved The modelling demonstrates that: For air-conditioned buildings, summer and winter operative temperature ranges in occupied spaces are in accordance with the criteria set out in CIBSE Guide A Environmental design(80), Table 1.5; or other appropriate industry standard (where this sets a higher or more appropriate requirement or level for the building type); or the thermal environment in occupied spaces meet the Category B requirements for PPD, PMV and local discomfort set out in Table A.1 of Annex A of ISO 7730:2005. For air-conditioned buildings, the PMV (predicted mean vote) and PPD (predicted percentage of dissatisfied) indices based on the above modelling are reported via the BREEAM assessment scoring and reporting tool. 1 1 Complete Halsion May 2023 Copies of thermal comfort modelling report received and compliance demondtrated. Suitably Qualified Acoustician Holds a degree, PhD or equivalent qualification in acoustics/sound testing Has a minimum of three years relevant experience Holds a recognised acoustic qualification and membership of an appropriate professional body (e.g. Institute of Acoustics) - Complete Acoustician Confirmation of SQA qualification. Hea 04 Thermal comfort Visual comfort Hea 01 Hea 02 Indoor Air Quality
Feedback
Copies
A copy of the architectural acoustic and BS reports confirm that the requirements are being targeted.
SQA has provided confirmation proposed design is expected to achieve indoor ambient noise levels that comply with the design ranges given in Section 7 of BS 8233:2014.
McLH - confirmation has been provided SQA is appointed to provide this post-completion review. McLH to provide written confirmation as per letter template.
Marked-up
McL&H
Proposed plan to be discussed:
Dedicated and safe cycle paths are provided from the site entrance to any cycle storage, and connect to offsite cycle paths where applicable.
Adequate external lighting in accordance with BS 5489-1:2013 Lighting of roads and public amenity areas.
2. Appropriate sized, designed and constructed. The following publications offer guidance on how to demonstrate this:
a. Local transport Note 2/08 Cycle infrastructure design, Department of Transport, 2008. b. Sustrans design guidance (www.sustrans.org.uk), specifically the Sustrans design manual handbookfor cyclefriendly design
Dedicated and safe footpaths are provided on and around the site providing suitable links for the following:
a The site entrance to the building entrance
b Car parks (where present) to the building entrance
c The building to outdoor space
d Connecting to off-site paths where applicable.
Pedestrian drop-off areas are designed off, or adjoining to, the access road and should provide direct access to other footpaths.
Where vehicle delivery access and drop-off areas form part of the assessed development, the following apply: Delivery areas are not accessed through general parking areas and do not cross or share the following: a pedestrian and cyclist paths b outside amenity areas accessible to building users and general public.
There is a dedicated parking or waiting area for goods vehicles with appropriate separation from the manoeuvring area and staff and visitor car parking.
Parking and turning areas are designed for simple manoeuvring according to the type of delivery vehicle likely to access the site, avoiding the need for repeated shunting.
Indoor ambient noise level
the indoor ambient noise level standards set out within performance criteria given in Section 7 of BS 8233:2014. A programme of pre-completion acoustic testing is carried out by a compliant test body in accordance with the acoustic testing and measurement procedures outlined in BREEAM Methodology. 1 1 Complete DAA / Acoustician / McLH
Achieve
Hea 06 Security Security of site and building A Suitably Qualified Security Specialist (SQSS) conducts an evidence-based Security needs assessment (SNA) during or prior to Concept Design. The purpose of the SNA will be to identify attributes of the proposal, site and surroundings which may influence the approach to security for the development. The SQSS develops a set of security controls and recommendations for incorporation into the proposals. Those controls and recommendations shall directly relate to the threats and assets identified in the preceding SNA. The controls and recommendations shall be incorporated into proposals and implemented in the as-built development. Any deviation from those controls and recommendations shall be justified and agreed with the SQSS 1 1 Almost complete McL&H May 2023
SQSS
addressed.
drawings have been provided which demonstrate how the
feedback recommendations have been
SQSS
Safe access Safe access for pedestrians and cyclists is provided (to, from and within site), and deliveries areas are not directly accessed through general parking areas and do not cross or share pedestrian and cyclist routes 1 1 Complete Gillespies & DAA Drawings submitted confirming safe access routes to / from / within site.
- Please provide confirmation that recommendations have been taken on-board and reflected in designs, as per
report.
Outside space There is an outside space providing building users with an external amenity area 1 1 Comeplete DAA Plan drawings demonstrate outside space will be provided for users to enjoy. Energy performance Four credits mandatory for Excellent Up to 9 credits based on energy performance rating and carbon emissions 9 6 Complete Halsion Updated BRUKLs report has been provided
.inp file.
updated BRUKL suggesting that 6 credits should be targeted (this is an increase of 2 credit from previous predictions). Safe and healthy surroundings Reduction of energy use and carbon emissions Ene 01 Hea 07 Energy (0.66% per 1 credit) Acoustic Performance Hea 05
and
Halsion confirmed
Specifications
Watt AND All external light fittings are automatically controlled for prevention of operation during daylight hours and presence detection in areas of intermittent pedestrian traffic.
The above requirements include decorative & floodlighting.'
Emergency light fittings, including security lighting, that are also used for normal operation are assessed for this issue - please confirm if this will be the case.
External lighting drawings still to be provided confirming compliance with requirements.
Please obtain appropriate confrimation and spec and drawings from external lighting designer.
LZCT feasibility study has been
Specified local LZC technologies for the building have been shown in line with the feasibility study recommendation.
The reduced regulated carbon dioxide (CO ₂ -eq) emissions have been reported.
Copies of Part L received. energy specialist - Patel Jayesh, CIBSE reg.
Sub-metering of major energy consuming systems One credit mandatory for Excellent Energy metering systems are installed that enable at least 90% of the estimated annual energy consumption of each fuel to be assigned to the various end-use categories of energy consuming systems Building users can identify the energy consuming end uses, for example through labelling or data outputs. All pulsed output meters to be connected to Building Energy Management System 1 1 Complete Halsion May 2023 Halsion confirm credit is being targeted. Schematics have been provided. On Page 4 of the Specifications please confirm sub-metering will meet BRREAM requirements: 'Install energy metering systems so that at least 90% of the estimated annual energy consumption of each fuel is assigned to the end-use categories' End-use categories include: 1. Space heating 2. Domestic hot water heating 3. Humidification* 4. Cooling* 5. Ventilation, i.e. fans (major)* 6. Pumps 7. Lighting 8. Small power 9. Renewable or low carbon systems (separately) 10. Controls 11. Other major energy consuming systems or plant, where appropriate. Depending on the building type, this might include for example: plant used for swimming or hydrotherapy pools; other sports and leisure facilities; kitchen plant or catering equipment; office equipment; cold storage plant; laboratory plant; sterile services equipment; transportation systems (e.g. lifts and escalators); drama studios and theatres with large lighting rigs; telecommunications; dedicated computer room or suite; server rooms; dealing rooms; covered car parks; ovens or furnaces; and floodlighting. Sub-metering of high energy load and tenancy areas Sub-meters provided per floor plate and for relevant function areas (e.g. where catering is provided) 1 1 Complete Halsion May 2023
confirm credit is being targeted.
have been provided. On Page 4 of the Specifications please confirm sub-metering will meet BRREAM requirements: 'Monitor a significant majority of the energy supply with an accessible energy monitoring and management system for relevant function areas or departments; Sub-meter per floor plate.' Ene 03 External lighting External lighting The average initial luminous efficacy of the external light fittings within the construction zone is not less than 70 luminaire lumens per circuit Watt AND All external light fittings are automatically controlled for prevention of operation during daylight hours and presence detection in areas of intermittent pedestrian traffic. The above requirements include decorative & floodlighting. Emergency light fittings, including security lighting, that are also used for normal operation are assessed for this issue. 1 1 More information required External lighting designer May 2023
Halsion
Schematics
credit is being targeted.
Halsion confirm
average
luminous efficacy
external light
zone
than 70
lumens
circuit
page 257 clause E3-8 more details, please confirm: 'The
initial
of the
fittings within the construction
is not less
luminaire
per
Passive design analysis Hea 04 Thermal comfort credit must be achieved. Project team carries out an analysis of the proposed building design to influence decisions made during Concept Design stage (RIBA Stage 2 ) and identifies opportunities for the implementation of passive design solutions that reduce demands for energy consuming building services 1 1 Complete AECOM A copy of the report confirming Passive design analysis findings and quantified energy reductions has been received Low zero carbon (LZC) feasibility study A feasibility study has been carried out by the completion of the Concept Design stage (RIBA Stage 2 ) by an energy specialist to establish the most appropriate low or zero carbon energy source(s) for the building Quantify the reduced regulated carbon dioxide (CO -eq) emissions resulting from the feasibility study 1 1 Complete Halsion May 2023
shared.
Energy monitoring Ene 02 Low carbon design Ene 04
Energy consumption Analyse the transportation demand and usage patterns for the building to determine the optimum number and size of lifts Energy consumption must be calculated in accordance with BS EN ISO 25745 Part 2 for one of the following: At least two options for each transportation type (e.g. for lifts, hydraulic, traction or machine roomless (MRL)) OR ii At least two options considering different system arrangements and control strategies. Consider the use of regenerative drives only where a saving can be demonstrated Specify the transportation system with the lowest energy consumption 1 1 Complete DAA Jan-23
copy of the Transport demand analysis has been received. Specification currently being considered in consultation with manufacture. Of the energy efficient lift options available, the most efficiecnt has been selected (OTIS Gen2 lifts).
populate the ENE06_Lift Data sheet with the energy consumption figures for the two types of lift options that were considered - this will confirm that the lowest energy consuming lift has been selected (manufacture may provide the calculations please request these). Energy efficient features For each lift, the following three energy efficient features are specified: a. The lifts operate in a standby condition during off-peak periods b. The lift car lighting and display lighting provides an average luminous efficacy across all fittings in the car of > 70 luminaire lumens per circuit Watt c. The lift uses a drive controller capable of variable speed, variable-voltage, and variable-frequency (VVVF) control of the drive motor. Where the use of regenerative drives is demonstrated to save energy, they are specified 1 1 Complete DAA Jan-23 Manufacturers confirmation received - the specified lift benefits from the three energy efficient features recognised by BREEAM. Lift manufacturers literature has been shared and confirms the following energy efficient features would be possible with OTIS Gen2 Stream: The lifts can operate in a standby condition during off-peak periods. Variable speed, voltage and frequency options. LED lightning in car and for hall fixture - confirmation received from manufacturer that the lift car lighting and display lighting provides an average luminous efficacy across all fittings in the car of > 70 luminaire lumens per circuit Watt. Regenerative drive option is available and has been specified - please provide calculations demonstrating the savings with and without regenerative drive option. Currently with OTIS. Tra 01 Transport assessment and travel plan Transport assessment and travel plan No later than Concept Design stage, undertake a site-specific transport assessment (or develop a travel statement) and draft travel plan, which can demonstrably be used to influence the site layout and built form 2 2 Complete Milestone Transport assessment and travel plan has been prepared. Tra 02 Sustainable transport options Transport options implementation Identify the sustainable transport measures, see BREEAM Table 7.4 Credits awarded according to the existing Accessible Index (AI) of the project, and the total number of points achieved for the options implemented 10 9 Complete DAA / McL&H May 2023 Relevant confirmation, confirming sustainable transport options that will be provided for: Accessibility index calculated previously as 8 (as per Tra 01 - complete) EV charging (10% car charging spaces min 3kW) Cyclist spaces (Building A = 1 covered space per 20 predicted staff = 94 spaces AND Building B = 46 spaces) Cycle facilities (showers Building A = 10 & Building B = 5; changing rooms; lockers Building A = 95 & Building B = 48; drying space) Local amenities (at least 3 within 500m) On site amenities (provision of outdoor open space) Halsion has confirmed- Pubic transport Information system in a publicly accessible area - Halsion please identify a suitable location for power outlet that would allow for the public transport informaiton system to be installed and send a marked-up drawing. Confirmation received for cycle storage, demonstrating that compliance with requirements can be met: Cycles can be secured within spaces in racks with overhead covering. The cycle racks are set in or fixed to a permanent structure (building or hardstanding) or alternatively, may be located in a locked structure fixed to, or part of, a permanent structure with appropriate surveillance The distance between each cycle rack, and the cycle racks and other obstructions, e.g. a wall, allows appropriate access to the cycle storage space for easy storage and access to bikes The storage facility or entrance to the facility is in a prominent site location visible to potential users from either an occupied building or a main access to a building Halsion - evidence received confirms the cycle storage facility has adequate lighting. The lighting must be controlled to avoid out-of-hours use - PIR spec issued. Wat 01 Water consumption Water consumption One credit mandatory for Excellent An assessment of the efficiency of the building’s domestic water-consuming components is undertaken using the BREEAM Wat 01 calculator: a. WCs b. Urinals c. Taps (wash hand basins and where specified kitchen taps) d. Showers e. Baths f. Dishwashers (domestic and commercial sized) g. Washing machines (domestic and commercial/industrial) 5 3 Complete DAA 20-Jan-23 Wat 01 calc confirms improvement. Manufacturers information has been indicated (e.g. confirming sanitary / taps / domestic goods water consumption spec) - water consumption determined for each item. Transport (0.95% per 1 credit) Water (0.77% per 1 credit) Energy efficient transportation system (lifts) Ene 06
A
Please
3
2
1
Schenatics
Water
1.a
supply and the buildings under assessment.
2 The leak detection system is:
2.a A permanent automated water leak detection system that alerts the building occupants to the leak OR an inbuilt automated diagnostic procedure for detecting leaks
2.b Activated when the flow of water passing through the water meter or data logger is at
2.c
high or low level, over set time periods. Although high and low level leakage rates are not specified, the leak detection equipment installed must have the flexibility to distinguish between different flow rates to enable it to be programmed to suit the building type and owner's or occupier's usage patterns.
2.d Programmable to suit the owner's or occupier's water consumption criteria
2.e Where applicable, designed to avoid false alarms caused by normal operation of large water consuming plant such as chillers.
Where there is physically no space for a leak detection system between the utilities water meter and the building, alternative solutions can be used, provided that a major leak can still be detected.
Schematics have been provided confirming presence.
Leak detection - Page 334 clause M1-7 - Please provide additional specifications details: 1.a On the utilities water supply within the buildings, to detect any major leaks within the buildings AND
1.b Between the buildings and the utilities water supply, to detect any major leaks between the utilities
2 The leak detection system is:
2.a A permanent automated water leak detection system that alerts the building occupants to the leak OR an inbuilt automated diagnostic procedure for detecting leaks - PLEASE CONFIRM
2.b Activated when the flow of water passing through the water meter or data logger is at a flow rate above a pre ‐set maximum for a pre ‐set period of time. It does not necessarily require a system that directly detects water leakage along part or the whole length of the water supply system
2.c Able to identify different flow and therefore leakage rates, e.g. continuous, high or low level, over set time periods. Although high and low level leakage rates are not specified, the leak detection equipment installed must have the flexibility to distinguish between different flow rates to enable it to be programmed to suit the building type and owner's or occupier's usage patterns.
2.d Programmable to suit the owner's or occupier's water consumption criteria
2.e Where applicable, designed to avoid false alarms caused by normal operation of large water consuming plant such as chillers.
Wat 02 Water monitoring Water monitoring Mandatory for Excellent - Specification of a water meter on the mains water supply Water-consuming plant or building areas, consuming 10% or more of the building’s total water demand are sub metered - Each meter has a pulsed output or is linked to a BMS 1 1 Complete Halsion May 2023
provided confirming presence.
have been
348
specifications
compliance
requirements:
meters Spec claue M1-31-1 page
- Please provide
confirming
with
a water meter on the mains water supply to each building. This includes instances where water
supplied via a borehole
other private source.
Specify
is
or
water-consuming plant
building areas consuming 10%
more
building’s total water demand:
Fit easily accessible sub-meters OR 2.b Install water monitoring equipment integral to the plant or area.
For
or
or
of the
2.a
For each meter (main and sub):
Install a pulsed or other open protocol communication output AND 3.b Connect it to an appropriate utility monitoring and management system, e.g. a building management system (BMS), for the monitoring of water consumption. If there is no BMS system in operation at PostConstruction stage, award credits provided that the system used enables connection when the BMS becomes operational. Leak detection system A leak detection system which is capable of detecting a major water leak on the mains water supply within the building and between the building and the utilities water meter is installed
3.a
On the utilities water supply within the buildings, to detect any major leaks within the buildings AND 1.b Between the buildings and the utilities water supply, to detect any major leaks between the utilities
a flow rate above a pre ‐set maximum for a pre ‐set period of time. It does not necessarily require a system that directly detects water leakage along part or the whole length of the water supply system
identify different flow and therefore leakage rates,
continuous,
Able to
e.g.
1
May 2023
1
Flow control devices Flow control devices that regulate the supply of water to each WC area/facility according to demand are installed 1 1 May 2023 Plan drawings showing flow restriction valves have been issued. written confirmation provided Wat 04 Water efficient equipment Water efficient equipment Unregulated water demand: Identify all water demands from uses other - Where there is no water demand from uses other than domestic-scale, sanitary use components in the building, this issue is not applicable. Identify systems or processes to reduce the relevant water demand (relevant to the above), and establish, through either good practice design or specification, a demonstrable reduction in the total water demand of the building. This issue includes, but is not limited to the following: – Swimming pools – Recreational hot tubs and hydrotherapy pools – Equipment used for irrigation – Vehicle wash equipment – Project-specific industrial processes – Water filtration and treatment processes – Building services (e.g. cooling towers and humidification systems) 1 1 Complete Halsion McLarc Mar-23 Plan drawings received. Please provide information on the energy efficient irrigation systemsIdentify systems or processes to reduce the relevant water demand, and establish, through either good practice design or specification, a demonstrable reduction in the total water demand of the building Life cycle impacts Carry out a building LCA on of the superstructure design, substructure and hard landscaping 7 4 RIBA 4 Stage 3 LCA received . Exemplary level criteria Core Building Services LCA During Concept Design identify opportunities for reducing environmental impacts 1 1 Complete Concept Stage LCA received. Pre-requisite Mandatory All timber and timber-based products used on the project is Legally harvested and traded timber - Y Complete McLH Jan-23 Draft letter with McL&H for review Please provide written confirmation statement as per letter template. Sample FSC certification has been provided. Sustainable procurement plan The principal contractor sources materials for the project in accordance with a documented sustainable procurement plan 1 1 Complete AECOM & McLH Complete Copy of sustainable procurement plan previously provided Complete Comeplete Materials (1.25% per 1 credit) Halsion Life cycle impacts Mat 01 McLH Water leak detection Wat 03
Template
Certs being
Calculation is underway.
DAA has
review and assessment additional narrative has been provided in addition to the drawings issued.
Confirmation design provides adequate protection for exposed parts of the building from material degradation.
Drawings and strategy confirm and demonstrate i) there is convenient access to the roof and façade for costeffective cleaning, replacement and repair in the building's design and ii) the roof and façade has been designed to prevent water damage, ingress and detrimental ponding
Progess is on-going. - report has been updated to include Technical Design Stage. consider methods that have been adopted that aim to optimise the use of materials to cover all of the following stages:
a. Preparation and Brief (e.g. re-use, adaption and expansion of existing building / services, need for flexibility and adaptability etc.)
b.
Responsible sourcing of materials Responsible sourcing is demonstrated for major building elements, through ISO 14001, FSC and BES 6001 certificates for the following: - Ceiling (including ceiling finishes) Door/window Floor (including floor finishes) - Insulation Internal partition/internal walls (including finishes) Roof (including roof finishes) - Structural frame, foundation and substructure - External wall - Building service - Hard landscaping Stairs and ramps 3 1 Almost complete McLH May 2023
responsible sourcing of construction materials has been provided for materials listed.
Confirmation of
for gathering information has been issued and
being populated.
is
sought
quants
calculated by McLH.
and
being
Protecting vulnerable parts of the building from damage The building incorporates suitable durability and protection measures or design features/solutions to prevent damage to vulnerable parts of the internal and external building and landscaping elements These measures must provide protection against: 1.a Negative impacts of high user numbers in relevant areas of the building (e.g. corridors, lifts, stairs, doors etc.). 1.b Damage from any vehicle or trolley movements within 1m of the internal building fabric in storage, delivery, corridor and kitchen areas. 1.c External building fabric damage by a vehicle. Protection where parking or manoeuvring areas are within 1 metre of the building façade and where delivery areas or routes are within 2 metres of the façade, i.e. specifying bollards or protection rails. 1.d Potential malicious damage to building materials and finishes, in public and common areas where appropriate. Marked-up drawings confirm how the design provides protection to vulnerable parts of the building from damageadditional narrative has been added to the drawings provided. Protecting exposed parts of the building from material degradation Relevant building elements incorporate appropriate design and specification measures to limit material degradation due to environmental factors, such as: Environmental agents, including: a. Solar radiation b. Temperature variation c. Water/moisture d. Wind e. Precipitation, e.g. rain and snow f. Extreme weather conditions: high wind speeds, flooding, driving rain, snow Biological agents, including: a. Vegetation b. Pests, insects Pollutants, including: a. Air contaminants b. Ground contaminants
summarised
Mat 06 Material efficiency Material efficiency Opportunities have been identified, and appropriate measures investigated and implemented, to optimise the use of materials in building design, procurement, construction, maintenance and end of life - a summary report should be provided to cover: a. Preparation and Brief b. Concept Design c. Developed Design d. Technical Design e. Construction. 1 1 Complete DAA with McLH and wider team input
Concept Design
structural, architectural, building services)
Developed Design
designing to standard sizes
reduce waste, optimise resource use etc.) d. Technical Design
material efficiency measures) e. Construction
waste reduction strategies, resource efficiency etc.) Construction resource efficiency Prepare a construction resource management plan complete with targets. Amount of waste generated per 100m² (gross internal floor area): 1 credit: ≤ 13.3 m3 or ≤ 11.1 tonnes 2 credits: ≤ 7.5 m3 or ≤ 6.5 tonnes 3 credits: ≤ 3.4 m3 or ≤ 3.2 tonnes 3 1 May 2023 Draft letter with McL&H for review please confirm resource targets Resource management plan in place (SMARTWaste template used). Please include demolition waste info. SMARTWaste being used by McL&H to monitor. Pre-demo audit Complete a pre-demolition audit of any existing buildings, structures or hard surfaces being considered for, no later than RIBA Stage 2. Maximise the opportunity for reuse and recovery of materials for high-grade/ value application. 1 1 May 2023 A copy of the pre-demo audit has been provided. Diversion of resources from landfill Diversion from landfill targets: Non-demolition waste: 70% by volume or 80% by tonnage Demolition (if appropriate): 80% by volume or 90% by tonnage 1 1 Complete Almost complete May 2023 McLH DAA and wider team update Construction waste management Responsible sourcing of materials Mat 03 Designing for durability and resilience Mat 05 1 1 Waste (0.63% per 1 credit) Draft letter with McL&H for review Please confirm processes and aspirations of project to meet required targets. Wst 01
(e.g.
c.
(e.g.
to
(e.g.
(e.g.
Please
This
of overheating
- Ene 01 approach, Maximise energy efficiency to tackle energy demand
- Ene 04 approach, passive design - Maximise opportunities to avoid unnecessary carbon emissions
- Mat 05 approach - durability and resilience - Avoid increased risks of deterioration and higher maintenance demands
- Pol 03 - Minimise the risks of increased flood risk and surface water run-off affecting the site or others Conduct
Wst 03 Operational waste Operational waste One credit mandatory for Excellent Dedicated space is provided for the segregation and storage of operational recyclable waste volumes: a. Clearly labelled b. Accessible to building occupants or facilities operators c. Of a capacity appropriate to the building type The design team demonstrates that the provision of waste management facilities for the assessed building is adequate given the building type, occupier (if known), operational function and likely waste streams and volumes to be generated. Where it is not possible to determine what provision should be made, use the following guide for minimum storage space provision: 1. At least 2m² per 1000m² of net floor area for buildings < 5000m² 2. A minimum of 10m² for buildings ≥ 5000m² 3. An additional 2m² per 1000m² of net floor area where catering is provided (with an additional minimum of 10m² for buildings ≥ 5000m²). The net floor area should be rounded up to the nearest 1000m². 1 1 Complete DAA Jan-23 Adequate space will be provided to accommodate operational waste streams (as per requirements) Marked-up drawings have been provided showing dedicated space as per requirements - please confirm the space will be clearly labelled, to assist with segregation, storage and collection of the recyclable waste streams Wst 04 Speculative finishes Flooring and Ceiling Finishes Office building types only For tenanted areas, where the future occupant is not known and carpets or other floor or ceiling finishes are installed, these must be limited to a show area only. OR Only install floor and ceiling finishes selected by the known occupant of a development. Alternatively, where only ceiling finishes and no carpets are installed, the building owner confirms that the first tenants will not be permitted to make substantial alterations to the ceiling finishes. 1 1 Complete DAA / Client Jan-23 DAA has confirmed - Raised Floor access and Ceilings to be provided as part of CAT design. Office floor finishes and ceilings to townhall and Gym subject to tenants’ fitout. DAA Please confirm in writing as per letter template. Structural and fabric resilience Conduct a climate change adaptation strategy appraisal for structural and fabric resilience by the end of Concept Design (RIBA Stage 2 or equivalent) through a risk assessment to identify and evaluate the impact on the building over its projected life cycle from expected extreme weather conditions arising from climate change and, where feasible, mitigate against these impacts. The assessment should cover the following stages: i. Hazard identification ii. Hazard assessment iii. Risk estimation iv. Risk evaluation v. Risk management. 1 1 Complete DAA Civil and structural engineer wider team input complete
adaptation strategy demonstrates how the climate change adaptation strategy appraisal has influenced the technical design.
Updated
consider risk
mitigation: i. Hazard identification ii. Hazard assessment iii. Risk estimation iv. Risk evaluation v. Risk management.
and
could include:
- Hea04 approach, preventing increasing risk
functional
potential
different design scenarios by Concept
Stage 2) Develop
study,
aim to enable and facilitate disassembly and functional adaptation 1 1 Complete DAA / McLH complete Stage 2 study received - confirms how the ease of disassembly and the functional adaptation of different scenarios was considered and responded Provide an update, during Technical Design, on: a How the recommendations or solutions proposed by Concept Design have been implemented where practical and cost effective. Omissions have been justified in writing to the assessor. b Changes to the recommendations and solutions during the development of the Technical Design Produce a building adaptability and disassembly guide to communicate the characteristics allowing functional adaptability and disassembly to prospective tenants 1 1 Complete DAA / McLH complete Updated report covers technical design stage - final contributions being added. This confirms how proposals were evaluated and progressed during technical development stage, justifying any omissions. A building adaptability and disassembly guide has been developed to communicate the characteristics allowing functional adaptability and disassembly to client. Previously occupied land At least 75% of the proposed development’s footprint is on an area of land which has previously been occupied 1 1 Complete DAA Complete Confirmation provided - planning documentation and google map Contaminated land A contaminated land professional's site investigation, risk assessment and appraisal has deemed land within the site to be affected by contamination 1 0 Under review McL&H May-23 SI reports shared confirms conamination and remediation options. Assuming no remediation required McL&H to confirm and draft letter template to be signed? Removed from scoring. Suitably qualified ecologist Holds a degree or equivalent qualification in ecology or a related subject. - Is a practising ecologist, with a minimum of three years relevant experience Is covered by a professional code of conduct and subject to peer review - Y Complete Ecologist Feb-23 Original Ecology report has been shared. Details of the SQE appointment have been shared. LUE 01 Site selection Land Use and Ecology (1.15% per 1 credit) Wst 06 Design for disassembly and functional adaptability Design for disassembly and functional adaptability Adaptation to climate change Wst 05
a study to explore the ease of disassembly and the
adaptation
of
Design (RIBA
recommendations or solutions based on the
during or prior to Concept Design, that
Ecological value of site
Site survey:
A Suitably Qualified Ecologist (SQE) carries out a survey and evaluation for the site early enough to influence site preparation works, layout and, where necessary, strategic planning decisions (typically Preparation and brief stage) .
The SQE’s survey and evaluation determines the site’s ecological baseline, including:
a Current and potential ecological value and condition of the site and related areas within the Zone of Influence.
b Direct and indirect risks to current ecological value from the project.
c Capacity and feasibility for enhancement of the site's ecological value and, where relevant, areas within the Zone of Influence.
Recommendations and data collected from the survey and evaluation are shared with appropriate project team members to influence decisions made for activities during site preparation, design and construction works, which can support ecological features.
Determining ecological outcomes:
The project team liaise and collaborate with representative stakeholders early enough to influence key planning decisions (typically Concept Design stage), to:
a Identify the optimal ecological outcomes for the site.
b Identify, appraise and select measures to meet the optimal ecological outcomes for the site, in line with the mitigation hierarchy of action, according to the route being used:
1. Avoidance
2. Protection
3. Reduction or limitation of negative impacts
4. On site compensation and 5. Enhancement, considering the capacity and feasibility within the site, or where viable, offsite. 2
LE 02's 'Survey and evaluation and Determining ecological outcomes’ criteria have been achieved.
1 credit: Further planning to avoid and manage negative ecological impacts on-site is carried out early enough to influence the concept design and design brief as well as site preparation planning (typically Concept Design stage). On-site measures for managing negative ecological impacts during site preparation and construction are implemented inpractice.
The above is based on input from the project team in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02 Ecological risks and opportunities
1 or 2 credits: Achieve 1st credit.
Negative impacts from site preparation and construction works are managed according to the mitigation hierarchy: No overall loss of ecological value has occurred (two credits).
OR The loss of ecological value has been minimised (Minimising Loss) (one credit)
A copy of the ecology report has been provided and confirms site is of low ecological value.
Written confirmation required from Landscpae architect: - that the ecologist report was received at an early enough stage to help inform the landscaping and ecological enhancement strategy
- that the project team liaised and collaborated with representative stakeholders early enough to influence key planning decisions (typically Concept Design stage), to:
a Identify the optimal ecological outcomes for the site.
b Identify, appraise and select measures to meet the optimal ecological outcomes for the site, in line with the mitigation hierarchy of action:
1. Avoidance
2. Protection
3. Reduction or limitation of negative impacts
4. On site compensation and 5. Enhancement, considering the capacity and feasibility within the site, or where viable, offsite.
Ecologist has visited site and confirms compliance is being met.
McL&H to sign and return letter template, confirming below
One credit – Planning and measures on-site
Further planning is required to be carried out for activities during site clearance and construction. McLH to confirm mitigation strategy - requirement for On-site measures for managing negative ecological impacts during site preparation and construction are implemented in-practice (e.g. mitigation measures to protect existing ecological features), as per ecologist recommendations.
Two credits Managing negative impacts the following hierarchy must be followed when managing negative impacts of the site preparation and construction works:
– Avoidance of negative impacts on habitats and features of ecological value on the site.
– If it is not possible to avoid negative impacts completely; protect habitats and features of ecological value from damage during development works in accordance with best practice guidelines to minimise negative impacts.
- If it is not possible to achieve the above, fully reduce, limit or control negative impacts as far as possible
- Where it is not possible for avoidance, protection, limitation or control of the negative impacts on features of ecological value on site; compensation has taken place to ensure the existing ecological value is maintained during and after the project.
This builds on the measures agreed for delivering optimal ecological outcomes in LE 02 Ecological risks and opportunities.
where this is not feasible, b Off site within the Zone of Influence.
Data collated are analysed and where potentially valuable, provided to the local environmental records centres nearest to, or relevant for, the site 1 1
Commit to ensuring measures are implemented that enhance ecological value, which are based on input from the project team and SQE in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02.
This issue intends to recognise enhancement measures that have been carried out in line with good practice recommended by an SQE, which build on mitigation measures taken in LE 03. enhancement measures must meaningfully enhance the site's ecological value - it would be benefical to discuss and agree this with input from the SQE.
McLH - please complete letter template - written confirmation compliance will be monitored against all relevant UK, EU or international legislation relating to the ecology of the site, as per SQE recommendation and that measures will be implemented as per SQE recommendations.
Landscape architect - please confirm final design. ecologist has deemed current proposals appropriate.
Three credits are to be targeted and will be awarded based on the change in ecological value occurring as a result of the project. This must be calculated in accordance with the process set out in GN36 - BREEAM, CEEQUAL and HQM Ecology Calculation Methodology – Route 2. Credits are awarded in line with the Reward Scale table in GN36 where there are no residual impacts on protected sites or irreplaceable habitats.
Biodiversity metric confirms significant net gain.
2 May 2023
LUE 03 Managing impacts on ecology Managing impacts on ecology
3 Complete Ecologist DAA / McLH Feb-23
3
Pre-requisite Confirmation that the following LUE 03 issues has been achieved: Negative impacts from site preparation and construction works have been managed according to the mitigation hierarchy, in line with the SQE's recommendations - - Feb-23 SQE confirmationprovided as per LUE 02. Ecological enhancement Measures have been implemented that enhance ecological value, which are based on input from the project team and SQE in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02 Measures are implemented in the following order: a On site, and
Feb-23
Change and enhancement of ecology Up to three credits are awarded based on the change in ecological value occurring as a result of the project. 3 3 Feb-23
Exemplary level criteria The change in ecological value calculated under criterion above confirms significant net gain has been achieved as 1 1 Feb-23 The change in ecological value calculated as above confirms significant net gain has been achieved. Almost complete Complete Ecologist Landscape architect LUE 04 Ecological change and enhancement Ecologist Landscape architect Ecological risks and opportunities LUE 02
Pre-requisite
The client or contractor has confirmed that compliance is being monitored against all relevant UK, EU and international standards relating to the ecology of the site.
Comprehensive route (Route 2) - Criterion 8 in LE 03 has been achieved (Negative impacts from site preparation and construction works have been managed according to the mitigation hierarchy, in line with the SQE's recommendations) and at least one credit under LE04 for 'Change and Enhancement of Ecology' has been awarded.
Measures have been implemented to manage and maintain ecology throughout the project. These measures are based on input from the project team in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02 To ensure the optimal ecological outcomes agreed in LE 02 are met in-practice, these measures must monitor and review the effectiveness of the mitigation and enhancement measures in place for LE 03 & LE 04 to ensure they are implemented.
Management and maintenance throughout the project
- Contractor nominates biodiversity champion - Contractor trains the site workforce on how to protect site ecology during the project - Contractor records actions taken to protect biodiversity and monitor their effectiveness A new ecologically valuable habitat appropriate to the local area is created
- Where flora and/or fauna habitats exist on-site, the contractor programmes site works to minimise disturbance to wildlife
A section on Ecology and Biodiversity has been included as part of the tenant or building owner information supplied, to inform the owner or occupant of local ecological features, value and biodiversity on or near the site. This should include detailed management and maintenance plans as required by landscape and asset managers as well as relevant parts of the handover information for occupiers written in a format that encourages understanding and supportive behaviours 1 1
Contractor to confirm compliance will be monitored against all relevant UK, EU and international standards relating to the ecology of the site.
McLH to please confirm measures will be implemented to manage and maintain ecology throughout the project - as per letter template.
- Y Comeplete Ecologist /McLH Feb-23
Complete
McLH Ecologist Feb-23
the first five years, includes: Actions and responsibilities of relevant individuals prior to handover The ecological value and condition of the site at handover and how this is expected to develop and change over time Identification of opportunities for ongoing alignment with activities beyond the development project, which support the aims of BREEAM's Strategic
1 1 Complete Ecologist McLH May 2023 Landscape
plan provided. McL&H to confirm via letter template Pre-requisite All systems with electric compressors comply with the requirements of BS EN 378:2016(207) (parts 2 and 3). Refrigeration systems containing ammonia comply with the Institute of Refrigeration Ammonia Refrigeration Systems code of practice - Y May 2023 Halsion has provided manufacturers guidance and confirmation that all systems meet requirements Impact of refrigerant The systems using refrigerants have Direct Effect Life Cycle CO2 equivalent emissions (DELC CO2e) of ≤ 100 kgCO2e/kW cooling/heating capacity OR Where air-conditioning or refrigeration systems are installed the refrigerants used have a Global Warming Potential (GWP) ≤10 2 2 Complete Halsion shas issued guidance for refrigerant R513A. Pol 01 calculator confirms 2 credits. Impact of refrigerant OR 1 credit Where the systems using refrigerants have Direct Effect Life Cycle CO2 equivalent emissions (DELC CO2e) of ≤1000 kgCO2e/kW cooling/heating capacity. 1 1 Complete as above Pol 02 NOx emissions NOx Emission levels for heating and hot water (mg/kWh) All heating and hot water is supplied by non-combustion systems OR The plant installed to meet the building’s delivered heating and hot water demand has, under normal operating conditions, a Maximum NOₓ emission levels as follows: GAS boiler: 1 credit: ≤27 mg/kWh 2 credits: ≤ 24mg/kWh 2 2 Complete Halsion Complete Halsion has confirmed no gas boilers to be provided. Flood resilience A site-specific flood risk assessment (FRA) confirms the development is situated in a flood zone that is defined as: 2 credits: having a low annual probability of flooding 1 credit: having a medium high annual probability of flooding AND increase the resilience and resistance of the development to flooding To increase the resilience and resistance of the development to flooding, one of the following must be achieved: a The ground level of the building and access to both the building and the site, are designed (or zoned) so they are at least 600 mm above the design flood level of the site's flood zone. OR b The final design of the building and the wider site reflects the recommendations made by an appropriate consultant in accordance with the hierarchy approach outlined in section 5 of BS 8533:2017 2 1 Complete 1 Credit to be targeted. Flood Risk Assessment has been updated and report shared. Confirmation provided from team that additional resilience is being added. Design team to confirm that the final design of the building and the wider site reflects the recommendations made by the flood risk consultant letter from Maggie should suffice Pollution (0.75% per 1 credit) Impact of refrigerants Pol 01 Halsion LUE 05 Long term ecological management and maintenance Complete
Ecologist satisfied with first visit.. Jack Monaghan was appointed as Biodiversity Champion and his responsibilities were clearly defined. Landscape and ecology management plan Landscape and habitat management plan is produced, in accordance with BS 42020:2013 Section 11.1, covering at least
Ecology Framework Identification and guidance to trigger appropriate remedial actions to address previously unforeseen impacts Clearly defined and allocated roles and responsibilities for delivering the plan The landscape and management plan or similar will be updated to support maintenance of the ecological value of the site
and ecology management
For brownfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) shows a 30% improvement for the developed site compared with the predeveloped site. This should comply at the 1-year and 100-year return period events.
For Greenfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) is no greater for the developed site than it was for the pre-development site. This should comply at the 1-year and 100-year return period events.
Relevant
Surface water run-off rate calcs have been provided for 1-year and 100-year.
Calculations appear to demonstrate that a 40% allowance for climate change has been provided.
Written summary confirmation has been provided demonstrating compliance can be met: Confirmation that surface water run-off design solutions are bespoke, i.e. they take account of the specific site requirements and natural or man-made environment of and surrounding the site. Please confirm the priority levels detailed in BREEAM have been followed, with justification given where water is allowed to leave the site. For brownfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) shows a 30% improvement for the developed site compared with the predeveloped site. This should comply at the 1-year and 100-year return period events. OR For Greenfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) is no greater for the developed site than it was for the pre-development site. This should comply at the 1-year and 100-year return period events.
Please confirm calculations and reports are for both buildings, noted Building A and Building B on the submitted drawings.
Please confirm maintenance agreements for the ownership, long term operation and maintenance of all specified Sustainable Drainage Systems (SuDS) are in place.
Calculations have been provided.
Calculations and reports are for both buildings, noted Building A and Building B on the submitted drawings.
Flooding of property will not occur in the event of local drainage system failure (caused either by extreme rainfall or a lack of maintenance); AND EITHER
Drainage design measures are specified so that the post-development run-off volume, over the development lifetime, is no greater than it would have been prior to the assessed site’s development. This must be for the 100year 6-hour event, including an allowance for climate change.
Any additional predicted volume of run-off for this event is prevented from leaving the site by using infiltration or other SuDS techniques.
OR (only where criteria above cannot be achieved):
Justification from the appropriate consultant indicating why the above criteria cannot be achieved, i.e. where infiltration or other SuDS techniques are not technically viable options.
Drainage design measures are specified so that the post-development peak rate of run-off is reduced to the limiting discharge. The limiting discharge is defined as the highest flow rate from the following options:
a.The pre-development one-year peak flow rate
b. The mean annual flow rate (Qbar)
c. 2L/s/ha.
For the one-year peak flow rate, the one-year return period event criterion applies.
For either option, above calculations must include an allowance for climate change; this should be made in accordance with current best practice planning guidance.
Please also confirm relevant maintenance agreements for the ownership, long term operation and maintenance of all specified SuDS are in place.
Surface water run-off rate
maintenance agreements for the ownership, long term operation and maintenance of all specified Sustainable Drainage Systems (SuDS) are in place.
planning guidance 1 1 Complete
Calculations include an allowance for climate change. This should be made in accordance with current best practice
Surface water run-off volume Flooding of property will not occur in the event of local drainage system failure AND Drainage design measures are specified so that the post-development run-off volume, over the development lifetime, is no greater than it would have been prior to the
1 1 Complete
assessed site’s development. This must be for the 100-year 6-hour event, including an allowance for climate change, Any additional predicted volume of run-off for this event is prevented from leaving the site by using infiltration or other SuDS techniques
Pol 04 Reduction of night time light pollution Reduction of night time light pollution The external lighting strategy has been designed in compliance with Table 2 of the ILP Guidance notes for the reduction of obtrusive light, 2011 AND All external lighting (except for safety and security lighting) can be automatically switched off between 23:00 and 07:00 If safety or security lighting is provided and will be used between 23:00 and 07:00, this part of the lighting system complies with the lower levels of lighting recommended during these hours in Table 2 of the ILP guidance notes 1 1 Complete Halsion May 2023 Halsion has confirmed all external lighting will be designed to IPL guidance notes. Spec - page 257 clause E3-8 External Lighting Pol 05 Reduction of noise pollution Reduction of noise pollution There are no noise-sensitive areas within the assessed building or within 800 m radius of the assessed site OR Noise level from the proposed site/building, as measured in the locality of the nearest or most exposed noise-sensitive development, is a difference no greater than +5dB 1 1 Complete Acoustician / McLH Jan-23 Draft letter with McL&H for review. Copy of the acoustician report received - noise impact assessment Please confirm commitment to undertaking a noise impact assessment compliant with BS 4142:2014 at an appropriate time. Surface water run-off Pol 03 Robert Bird Almost complete
FH090-151015 appendix h
Aecom CMT report
To: FrancisHunter – Luke Nurser
CC: meeting distribution
Monthly Report : TA/CMT No 22: 24/04/24
Report up to 23/04/2024
1.Key Actions in Month
1.1 Review of packages on Viewpoint – Stage 5 drawings
1.2 Review of packages on Viewpoint – Stage 5 tech subs are ongoing .
1.3Site visit No6 for MEP – SVR issued.
AECOM Sunley House 4 Bedford Park Croydon CR0 2AP, UK T +44(0)203 043 9200 aecom.com
Project name: Project Honey - Kingston Project ref: 60627560
By : D Emerson
Date: 24/04/24
1.4Workshops with MCLH re key issues, inc Stage 5 o/s comments on tech subs
2. Status of Document Submittals
2.1 Comments issued on a number of items listed above.
- public health - sprinkler
- mechanical
- electrical
2.2 Workshop held to agree remaining comments
3.Any key issues / comments / quality issues related to site/Test activities
3.1 no signifianct issues – see SVR006. Issues ongoing in other correspondence. Installation benchmark reviewed on visit.
3.2 LV FAT undertaken in month
4.Key actions for next month
4.1 Review of packages to be submitted
4.2 Stage 5 deliverables.
4.3 Continue schedule of visits.
4.4 FAT to be organised
5.Key decisions required / variations
5.1 Timescale to be agreed for development of any further Tenant variations request schedule
5.2 Commissioning and completion programme.
6.Any CDM issues
6.1 n/a
Memo \\na.aecomnet.com\lfs\EMEA\London-UKLON06\Legacy\UKLON06PFPSW001\UFI\Jobs\PR469433_Project_Honey\500_Deliverables\570_Reports\PHK_AECOM_CMT report 22 2024_04_24.docx
FH090-151015 appendix i
MNP CMT report
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
1 General Progress of the Works: Site Works
No. of CMR site visits to date: 18
MNP last attended site on 20th March 2024 and reported in CMR 21. Structural works are complete.
• The focus of MNP work this month has been on the review of low concrete cube results, which have been reported on by RBG and issued for review on 28th March 2024. The MNP review is largely complete and we will be issuing our report next week
• We will also meet with McL&H over the coming month to review comments schedules and close out comments base don Field View Records, and we will review final BC reports.
• MNP will review final for-construction documents for all three blocks and will make a final statement on compliance with ERs.
• We are informed that the planning condition tracker is currently being updated. We will report on final condition status on receipt of this document.
2 General Progress of the Works: Design Submissions
The following packages have been reviewed, blue items within this period. Refer to Appendix B: Technical Submission Tracker.
• Attenuation product data sheet (ahead of final design information)
• Piling Specification – RBG
• Piling Package – Van Elle
• RBG Loading Plans
• RBG Building A Superstructure GAs (design still in progress)
• RBG Building B Superstructure GAs (design still in progress)
• RBG Building C Substructure (in progress)
• RBG Drainage
• RBG Building A and B Pile-caps
• RBG Building C Piling
• RBG Block B revised loading plans
• RBG Block B Foundation Revision
• RBG Block B L10 Revision
• McL&H Benchmark Columns
• RBG Block A Core Plans
• RBG Block B Core Plans
• RBG Block C Drainage
• RBG Block A Townhall Steelwork
• RBG Block C Drainage
• RBG Blocks B and C Cores
• RBG Block A L06 amendment
• RBG Block A,B,C concrete cube report
3 Contractor’s Quality Control
Implementation of the Contractor’s Quality Control Systems in relation to ERs and Building Contract We can confirm that the design development and/or construction work carried out to date has been regularly inspected/reviewed by the Contractor in this period of reporting
We list any suspected defective work and recommend procedures for remedial action including, where necessary, a regime of testing or exposure. Refer to Appendix A: Site observations tracker.
4 Statutory Approval Status
Report on current status of local authority and other statutory approvals relating to Civil and Structural Engineering. Discharge of reserved planning matters or conditions. We report in reference to Eden Campus Conditions Matrix (Chartplan) tracker dated 23/08/2023 Refer to Appendix C: Planning conditions tracker. There has been no change to status of conditions since this date.
Approval of Building Regulations submissions and discharge of any conditions hereto.
• All building control approvals are recorded in the McL&H monthly contractor’s report.
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
Comment on satisfaction of Building Inspector’s routine inspections.
• No Building Regulation Inspection Reports are known to have been submitted.
5 Prohibited Materials
MNP has not become aware in carrying out its duties under the Appointment and/or this deed that any of the materials or substances referred to in clause 6 of this agreement (Prohibited Materials) are being or has been used in the Development.
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
Appendix A – Site Observation Tracker
1 22.07.22 Demolition of the NCP car park is approaching the shared foundation with Lever House. Discussions with the demolition contractor on site indicated that the presence of the shared foundation may not be well understood
2 24.08.22 Demolition of the NCP car park is approaching the shared foundation with Lever House. McL&H and RGB attending site to monitor demo works in vicinity of shared foundation.
The demolition contractor is to demonstrate by RAMS how the works in the vicinity of the shared foundations are to be controlled and the main contractor team is to put in place controls to ensure that the Lever House foundation is protected.
3 20.10.22 No additional comments to make No additional comments to make
4 28.11.22 Rebar cage in Block B central core pile has displaced
5 28.11.22 Rebar to top of Block A pile cap appears to be set lower than the cover zone.
Check the cover on the pile is as required to ensure durability meets the ERs
Check the cover over the rebar cage is as expected and that it complies with the design intent, and controls cracking.
6 11.01.23 Excavation close to Brook St bus stops. MNP discuss temporary stability of berm on site with McL&H who confirm temporary stability has been discussed with RBG and earth is stable No additional comments to make
7 11.01.23 MNP / McL&H review Field View Quality system in site office.
8 21.02.23 Column rebar arrangement in a Block A column. Lower start bars set inboard of cranked bar..
9 24.02.23 Block A L01 slab soffit – rebar marking and grout leakage at day joints.
10 24.02.23 Block A L01,L02 slab soffit – Most of the soffit is very good but some areas of poorer finish are emerging.
A L02
and
Good QA/QC systems in place. No additional comments to make.
McL&H asked to check rebar arrangement is as required and log via field view.
McL&H to check rebar pattern is not associated with low cover (it looks like staining only from rebar stored on the shutter). McL&H to comment as to whether the staining will be removed and to review shutter cleaning near rebar stock pile locations.
McL&H to comment on how marking can be avoided by the subcontractor in the future. Check ply liners are not damaged and are cleaned.
To be addressed prior to offering for inspection. Agree repair with client by establishing benchmark for repaired column. We recommend grout at head of column is removed by slab follow up team after shutters are removed to limit staining potential.
be addressed prior to offering for inspection. Recommend establishing a benchmark area at an earlier stage to set expectations for exposed concrete finish.
Site Visit Date Observations Recommendation
Ditto
11 24.02.23 Block A L02 Column – Grout leakage from slab at head and blow holes require repair.
12
Block
13 25.05.23 Block A L01 slab soffit – grout loss at day joint and rebar rust staining To be reviewed and discussed with concrete contractor to ensure quality of finishes can be achieved by the follow up team 14 25.05.23 Block A L02 soffit – marks on soffit from damaged shutters To be reviewed and discussed with concrete contractor to ensure quality of finishes can be achieved by the follow up team 15 25.05.23 Block A Lift Lobby – marks on soffit from water staining and laitance, grout runs on walls
reviewed
discussed
concrete contractor to ensure quality of finishes can be achieved by the follow up team.
after preparation. 16 25.05.23 Block B L01 corbel slab drops – crack in column head (possibly – viewed from afar) To be reviewed by the SE 17 14.07.23 Block A slab soffit – rust staining at tie wire debris To be reviewed and discussed with concrete contractor to ensure quality of finishes can be achieved. Can tie wires can be swept away earlier? 18 30.08.23 Block B back propping. On review of site photographs we can see that three levels of back propping is in place in block A
part block B, but over half of the block B footprint, back-props to the flat slab are limited to two levels.
24.02.23
lift lobby. Grout leakage
soffit staining. To
To be
and
with
Recommend offering for benchmark inspection
and
McL&H to please confirm this sequence is as used in the temporary loading calculations and long term creep calcs.
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
19 30.08.23
20 30.08.23
21 03.10.23
22 03.10.23
23 03.10.23
24 03.10.23
25 03.10.23
26 23.10.23
27 23.10.23
Plywood closures have been fitted to the flood void entry points to prevent vermin entering the voids. The flood void is therefore closed.
Block C Ramp Tie pars have been cold worked and do not align with topping / tie slots in PCC
Block C – Overspill concrete in flood void to be removed
Block C – Use of PT tendon as tie bar through Delta Beams
Block C – Damage to PCC elements to be repairs prior to handover to McL&H for snagging
Does this affect the flood performance of the site during the works? Could there be adverse comment from the EA?
Post 3/10/23 visit – suggest McL&H simply have a policy to remove covers in the case that the site is shut down through a flood event.
McL&H to review and advise how the tie bars will be resolved.
McL&H confirmed on site that this in on their snagging schedule
McL&H to review and confirm this is as the required tie detail
McL&H confirmed on site that this will happen. Snagging will on be when the PCC formally offers the system.
Block B – L09 slab construction joint – remove laitance form shutter prior to pour McL&H confirmed on site that this in on their snagging schedule
B – Core door enlargement – cover protection to be added McL&H confirmed on site that this in on their snagging schedule
A – Steel beams in Town Hall are propped with two floors of RC cast above McL&H to confirm TW release strategy to avoid ‘shocking’ the concrete structure above when steel deflects.
A – L6 slab soffit appears to
Block
Block
be very wet so looks highly variable Assumed to be storm related – MNP to inspect when dry 28 06.12.23 Block A Town Hall steel McL&H to confirm they have primed site welding prior to over coating and site welds have test certifications. 29 06.12.23 Block A Roof – Poorly formed column head and marks to column shaft McL&H to remediate prior to handover 30 06.12.23 Block A roof slab soffit – very poor finish McL&H to confirm if this is to be treated 31 06.12.23 Block B – Cast in steels in soffits of slabs McL&H to remediate prior to handover 32 06.12.23 Block C – Defects at Delta Beam bearings and corbels McL&H to remediate prior to handover 33 07.02.24 Block A – temporary bracket within galvanised steel plant frame MNP note that this was resolved on 20.3.24 visit 34 07.02.24 Block C Roof Access Staircase - staining FHPM to confirm if this finish requires enhancement 35 07.02.24 Block C – Cracking to column corbel McL&H to ask FC McCann Engineer to review 36 07.02.24 Block C – Cracking to beam corbel McL&H to ask FC McCann Engineer to review 37 07.02.24 Block C – Delta Beam Corrosion where supporting PCC McL&H to confirm how steel paint will be made good to offer required protection 38 07.02.24 Block C – Steel tendon within PCC joint McL&H to confirm how this will be treated to avoid future corrosion / spalling 39 20.03.24 Block C – Vehicle impact damage to L00 blockwork McL&H to rebuild blockwork / reapir as required Appendix
Tracker Technical Submission Planned Received Progress CMR Comments Status (No.) A B C Piling Design (Van Elle) 29.07.22 15.08.22 Issued 19.08.22 UXO risk expected in RAMS Pile design Cu max commented on Pile design eccentricity commented on Preliminary pile test results requested Piling near to Lever House pending existing foundation survey 5 1 0 Piling Design Intent (RBG) 29.07.22 09.08.22 Issued 19.08.22 Block B piles close to Lever House. Advisory comment on proximity and centres. 1 0 0 Attenuation Tanks 29.07.22 26.07.22 Issued 04.08.22 Product data sheet only reviewed. No design intent received. No comments on data sheet 1 0 0
Block
B – Technical Submission
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
RBG Block A B C concrete cube test report on low results
In progress MNP have reviewed and will release report on findings week commencing 29th April 2024
Building C - Substructure - 15.08.22 26.09.22 Design in progress and requires coordination. General comments made. 0 5 0 RBG Loading Plans –Buildings A and B - 25.08.22 26.09.22 Loading Plans all as ERs 20 0 0 RBG Constraints Drawings - 01.09.22 26.09.22 Site constraints and Lever House Interface. Comments made on drainage and site risks 0 2 0 RBG Superstructure GAs Buildings A and B - 02.09.22 26.09.22 Design in progress and requires coordination. General comments made. 0 20 0 RBG Substructure Building B– Layouts - 02.09.22 26.09.22 Design in progress and requires coordination. General comments made. 1 0 0 RBG Drainage – Layouts and scheduled - 05.09.22 05.10.22 General comments on design principles and details to be addressed 0 6 0 Van Elle Pile Tests - 08.09.22 13.10.22 No comments 5 0 0 RBG Building A and B Pile caps - 04 10.22 19.10.22 Comments on GA plans relating to inline pile caps and restraint of ecc moment, as well as concrete grade interactions. 23 3 0 RBG Basement Waterproofing 01/12/22 13/10/22 Comments on drawings uploaded to VP 0 1 0 RBG Block A L00 06/12/22 13/10/22 Comments on drawings uploaded to VP 4 2 0 RBG Block B L00 06/12/22 13/10/22 Comments on drawings uploaded to VP 1 2 0 RBG Block C Piles 08/12/22 13/10/22 No comments 2 0 0 RBG Block B LoadplansL10 06/02/23 07/02/23 No comments 1 0 0 VanElle Pile design Block C 02/02/23 07/02/23 No comments 1 0 0 RBG Block C Foundation 14/02/23 14/03/23 Comments but drawing superseded on VP 0 1 0 RBG Block B Founds Rev 23/02/23 14/03/23 Comments on drawing uploaded to VP 0 1 0 RBG Block B L10 Revision 24/02/23 14/03/23 No comments 1 0 0 McL&H Benchmark Cols 24/02/23 14/03/23 Comments on benchmark column 0 1 0 RBG Block A Core Plans 28/02/23 12/05/23 No comments 7 0 0 RBG Block B Core Plans 28/02/23 12/05/23 No comments 7 0 0 RBG Block C Drainage 07/03/23 10/03/23 Comments made 0 3 0 RBG Block C Loading Plan 23/03/23 12/05/23 No comments 1 0 0 Block A Townhall Steelwork 23/03/23 12/05/23 No comments 13 0 0 RBG Block C Drainage 17/04/23 17/04/23 Comments made 0 3 0 RBG Blocks B and C Cores 25/04/23 12/05/23 No comments 8 0 0 RBG Block A L06 Plans 26/06/23 30/08/23 No comments 1 0 0 RBG Block A L08,9,10 03/08/23 24/08/23 No comment 3 0 0
28/03/24
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
Appendix C - Planning Condition Tracker
Ref Planning Condition (Civil and Structural Only)
8. All works on site shall take place in accordance with…details which shall have…been submitted…in the form of a Demolition and Construction Environmental Management Plan.
9. The levels of buildings, roads, parking areas and pathways within the site shall… have previously been submitted to and approved in writing by the LPA before development is commenced.
10. Prior to the commencement… a Site Waste Management Plan/Circular Economy Statement shall be submitted…and approved in writing by the LPA.
14. Hard surfaces … shall be made of porous materials and … retained thereafter to direct run-off water … to a permeable or porous area or surface within the curtilage of the property.
19. The development shall be carried out in accordance with the details approved on 25.02.2022 Reference 21/04117/CLC (Written Scheme of Investigation WSI - Archaeology).
23. The development … shall not be commenced until a detailed Ecological Management Plan has been submitted …and agreed in writing by the LPA.
34. Should remedial works be required in relation to contaminated land, the remedial strategy shall be submitted to and agreed in writing by the LPA, prior to the commencement of the development works and remedial works. On completion of the agreed remedial works, a closure report and certificate of compliance endorsed by the interested party/parties, shall be submitted to and agreed in writing by the LPA, prior to occupation.
35. If during implementation, contamination is encountered, it shall be fully assessed and a contaminated land assessment and remedial strategy shall be agreed by the LPA before the additional remediation works are carried out. The strategy shall be implemented prior to completion of the development.
36. Prior to commencement of groundworks (excluding SI and demo), a final detailed drainage design, including drawings, calculations, SuDS Statement and Drainage Assessment Form shall be submitted to and approved by the LPA. A detailed management plan must also be submitted for the lifetime of the development.
37. No building shall be occupied until evidence is submitted to demonstrate that the SuDS scheme has been completed in accordance with the submitted details. The SuDS scheme shall be managed and maintained in accordance with the agreed management and maintenance plan
41 The development shall be carried out in accordance with the submitted FRA by Cole Easdon (ref: 7378, issue no.5; dated November 2020) and the following mitigation measures:
FFL no lower than 8.8mAOD for more vulnerable residential uses
FFL no lower than 8.4mAOD for less vulnerable commercial uses
FFL no lower than 7.9mAOD for the commercial reception area
Flood storage mitigation shall be provided Flood voids shall be installed
42 The development shall be carried out in accordance with the submitted Interim Flood Storage Scheme detailed within the letter from MNP to the Environment Agency (SV/ib/220051-04; dated 15 February 2021). The car park ramp tank will be implemented at the trigger points specified and remain in perpetuity until the demolition of Lever House is complete.
43 Prior to occupation, a maintenance plan to manage the flood voids and grilles over the lifetime of the development will be submitted to, and approved in writing by, the LPA in consultation with the EA.
44 Prior to occupation, a scheme detailing the flood resistance measures must be submitted to, and approved in writing by, the LPA with guidance from the EA. The scheme should include passive flood barriers up to 8.31 mAOD to protect the shared reception of the Hive and Honey Buildings and the car park basement access ramp, stairwell and lift lobbies.
45 Surface water draining from areas of car park hardstanding shall be passed through an oil separator or series of oil separators, prior to being discharged into any watercourse, soakaway or surface water sewer.
53 The development shall be implemented in accordance with the details approved on 07.03.2022 under reference 22/00292/CLC (Water re-use/harvesting).
59 No piling shall take place until a piling method statement (detailing the depth and type of piling to be undertaken and the methodology by which such piling will be carried out, including measures to prevent and minimise the potential for damage to subsurface water infrastructure, and the programme for the works) has been submitted to and approved in writing by the LPA in consultation with TW.
64 Prior to the occupation of each building the post-construction tab of the GLA’s whole life carbon assessment template should be completed accurately and in its entirety in line with the GLA’s Whole Life Carbon Assessment Guidance.
No No
Yes Yes
Yes Yes
No No
Submitted? Approved?
Yes Yes
Yes Yes
Yes Yes
Yes Yes
Yes Yes
Yes Yes
Informative Informative
Informative Informative
Yes Yes
No No
Informative Informative
Informative Informative
No
No
Informative
Informative
220051 Eden Campus Kingston
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 22
25th April 2024
D – Building Control Submission and Approval Tracker
Ref Building Control Submission Submitted? Approved? 1 REFER TO McL&H MONTHLY REPORT FOR A FULL UPDATE 2 3 4 5 6 Ref Building Control Inspection Report Submitted? Approved? 1 REFER TO McL&H MONTHLY REPORT FOR A FULL UPDATE 2 3 4 5 6
Appendix
ORSA monthly CDM report
FH090-151015 appendix j
Site Inspection
Eden
Campus Eden Street Kingston Upon Thames KT1 1ER Globe Kingston Ltd 25 April 2024
0.0 Document Verification
Job Number 2800 Job Eden Campus
Document Title Site Inspection File Reference SI1 ORSA_H&S Site Inspection February 2024.docx
Document Information
Revision Issue Date Filename 2800_Eden Campus_ORSA Site Inspection_FJMK250424
A 30/04/24 Description Site Inspection
Prepared By Checked By Approved By Name Francis J M Kenny James Bucknall James Bucknall
Signature Date 25/04/24 30/04/24 30/04/24
Revision Issue Date Filename Description
Prepared By Checked By Approved By Name
Signature Date dd/mm/yy dd/mm/yy dd/mm/yy
Revision Issue Date Filename dd/mm/yy Description
Prepared By Checked By Approved By Name
Signature Date dd/mm/yy dd/mm/yy dd/mm/yy
1 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
1.0 Key Project Details
Client Globe Kingston Ltd
Site Eden Campus, Eden Street, Kingston Upon Thames KT1 1ER.
Principal Contractor McLaughlin & Harvey Ltd
Inspected by Francis J M Kenny
Date 25 April 2024
Programme Completion due Sept 2024
2.0 Site Inspection
A site inspection of the Eden Campus Project was undertaken on the 25th April 2024 in the company of Jack Monaghan, Assistant Site Manager for Principal Contractor McLaughlin & Harvey Ltd.
The Project comprises the erection of 3 blocks. An 11-storey office block, a 9-storey office and retail block and a multi storey car park with 354 spaces.
The car park will contain ground floor changing area with showers and lockers. The office block will be occupied by Unilever when completed.
The purpose of the site inspection was to highlight any Health, Safety and Environmental observations and undertake a review of the on-site documentation in relation to the work activities that were being carried out.
3.0 Work activities ongoing at time of inspection
§ Roofing.
§ Glazing.
§ Metsec Partitioning.
§ Plaster Boarding.
§ Cladding.
§ M&E
§ Cable containment.
§ Rebar Installation.
§ Containment.
§ Waste removal.
§ Lifting operations.
§ Traffic management
§ Deliveries.
4.0 Site Attendance
The current average daily site attendance is approximately 240 including operatives and site management.
5.0 Accidents, Incidents & Near Misses
It was confirmed by Jack Monaghan that there have been no recorded accidents, incidents or near misses or Enforcing Authority visits since our last inspection.
6.0 Compliance Actions that the contractor needs to implement
Concluding this visit there were one issue or action raised, and all issues or actions raised last month have been addressed by McLaughlin & Harvey Ltd.
§ Dust management.
7.0 Comments
I conducted a thorough safety inspection of the project site, aiming to assess overall safety performance and ensure compliance with health and safety regulations and best practices.
Operatives were observed diligently following safety protocols with evident supervision, reflecting the management team's active engagement in promoting and enforcing safety measures, setting a commendable example for the project.
Biometric turnstiles effectively control site access, enhancing security and safety by permitting only authorized personnel entry.
The high-quality hoarding and fencing are regularly maintained, while up-to-date health and safety noticeboards ensure operatives are well-informed about safety requirements and legal obligations.
Daily hazard and briefing boards provide essential safety updates, enhancing operatives' awareness of potential hazards and safety precautions.
Adequate PPE usage was observed among all operatives, ensuring their safety during tasks.
While work areas, walkways, and routes were well-organized and maintained, dust management standards need improvement.
Certified portable fire extinguishers and visible fire exit signage are crucial for emergency protection, while exclusion zones with effective barriers and signage minimize risks.
Method statements and risk assessments were deemed suitable, considering project-related health and safety risks.
Access to suitable first aid equipment and competent first aiders on-site ensure prompt medical attention.
The site offers adequate toilet and washing facilities, drinking water, and a well-maintained canteen area, with designated spaces for changing and storing clothing and PPE, prioritising workforce well-being and comfort.
Daily coordination briefings, while held, could be utilised more effectively to address safety improvement areas, thereby enhancing project standards and contributing to a wellcoordinated and safe work environment.
Documents observed while on site included:
§ Safety posters
§ Safety notice and hazard boards.
2 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
8.0 Temporary Works Design & Coordination
McLaughlin & Harvey Ltd. has established a robust system to ensure that any temporary works installed on-site are appropriately designed and approved by competent engineers.
This measure is crucial to mitigate potential risks associated with temporary structures and ensure their stability throughout their intended use.
A comprehensive temporary works register is in place on the project. The register provides detailed information about all temporary works on-site, including their design specifications, installation dates, responsible personnel, and approval status, and the register is updated regularly to reflect any changes or new installations.
Andy Finnigan has been formally appointed as the responsible person for overseeing temporary works at the project site.
This appointment demonstrates a clear commitment to ensuring that temporary works are managed by a competent individual with the necessary expertise to assess and oversee their design, installation, and maintenance.
In line with best practices, McLaughlin & Harvey Ltd. has ensured that engineers responsible for designing and approving temporary works possess the required competencies and qualifications. This approach guarantees that temporary structures are designed and executed by individuals with the appropriate expertise.
9.0 Site Inspection Assessment Criteria below
The scoring criteria adopted for our site inspection is given as
3 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx § Permits.
Exemplar Acceptable Improvement Needed Critical
10.0 Site Inspection Checklist & Actions
Observation
Project H&S Organisation
Project Arrangements
Project Risk Register
Project Methodology Statements
Inductions
Register/Notices/Forms
Permits to Work
Construction Phase Health & Safety Plan
Information
Communications/Consultation/Training
Site Establishment
Welfare-General
Status Comments
Acceptable Contained within the CPP. - -
Acceptable Project risk register available.
Acceptable In place for live works. - -
Acceptable Inductions carried out and recorded. - -
Acceptable Displayed.
Acceptable Issued and controlled.
Acceptable In place.
Acceptable Displayed on notice boards.
Acceptable Briefings undertaken daily. - -
Acceptable Good standard, clean and tidy. -Canteen
Rest/Drying/Changing Room
First Aid
Sanitary/Washing Facilities
Walkways/safe routes
Fire escape routes
Access and Egress on site
Offices
Storage
Segregation of substances
Access / Egress
Site Boundary
Hoarding/Fence/Other
Security
Signage
Traffic Management
Acceptable Good standard, clean and tidy.
Acceptable Good standard, clean and tidy.
Acceptable First aid equipment available on site.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Access and egress sufficient and not obstructed.
Acceptable Weil controlled
Acceptable Clean and tidy.
Acceptable Stored in line with COSHH assessment. -
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Good standard and well maintained
Acceptable No issues identified.
Acceptable Good signage in place.
Acceptable Managed well.
4 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
Action Date
- -
- -
-
-
-
-
- -
- -
- -
-
-
-
-
- -
- -
-
-
- -
-
-
-
-
-
- -
- -
- -
- -
- -
Observation
One Way System?
Site internal turning
Banks man supervision
Vehicle/Pedestrian Segregation
Wheel wash
Site Access-General
Operations - Safety Management – Planning
Risk Assessment-General
Method Statement-General
Roles and Responsibilities-General
Scaffold/Register
Plant/Register
False work
Temporary Works Design Brief
Temporary Works Appointments
Temporary Works Register
Operations - Safe Methods of Work
Compliance with method statement
Method Statement-General
Signature/Documentation
Risk Assessments
Permit system responsible person
Internal site safety tours
Documentation Acceptable
Considerate Constructors Registered
Water Management Plan
Emergency Fire evacuation Plan
Use of Scaff-inspection tags
Slips/`Trips /Falls
RPE - Face Fit testing
Acceptable Site has two gates, and a one-way system is used as required.
Acceptable Traffic marshals in place.
Acceptable In place.
Acceptable Good segregation is in place.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable RAMS are in place.
Acceptable Suitable and sufficient.
Acceptable In place and listed within CPP.
Acceptable Suitable and sufficient.
Acceptable Completed.
Acceptable. No issues raised.
Acceptable In place.
Acceptable In place for Andy Finnigan
Acceptable In place and up to date.
Acceptable No issues raised.
Acceptable Suitable and sufficient.
Acceptable In place within the site files.
Acceptable In place.
Acceptable In place and up to date.
Acceptable Regular tours undertaken.
Acceptable In place and relevant.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable In place.
Acceptable In place.
Acceptable No issues raised.
Acceptable No issues raised.
5 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
Action Date
Status Comments
- -
- -
- -
-
-
-
-
-
-
-
-
- -
- -
-
-
-
-
-
-
- -
- -
-
-
-
-
-
-
- -
-
-
-
-
-
-
-
-
-
-
-
-
Observation
Asbestos Register and Awareness Training
Good Practice - Safe Working
Work areas tidy
Walkways/safe routes clear of obstruction
Tools & Equipment suitable for the task
Safe manual handling
Signage
Storage of materials
Compliance with method statement
Personnel Protective Equipment PPE
Operations - Activity Set Up
Resources
Operatives Certification
Plant Certification
PUWER Register
Hoist Register
Crane Register
Lifting Equipment Register
Induction Register
Tool box talks
Contractor's team briefings
Operations - Activities -Safe Working
Site tidiness-Housekeeping
Fire Precautions
Fire safety route
Fire Fighting Equipment [Site]
Fire Signage
Fire Escape route
Fire Assembly
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable In place and sufficient.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Clear and un-obstructed.
Acceptable Suitable for current activities.
Acceptable No issues raised.
Acceptable Plant registers maintained
Acceptable Records in place and up to date.
Acceptable Records in place and up to date. - -
Acceptable Four cranes in place, and rescue team trained.
Acceptable In place.
Acceptable In place and signed by site operatives.
Acceptable No issues raised.
Acceptable In place and completed.
Acceptable Good standard
Acceptable No issues raised.
Acceptable Clear and unobstructed.
Acceptable Suitable and sufficient.
Acceptable Displayed.
Acceptable Clear and unobstructed.
Acceptable In place.
6 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
Action Date
Status Comments
- -
- -
- -
-
-
-
-
-
-
-
-
-
-
- -
- -
-
-
- -
-
-
- -
- -
-
-
- -
-
-
-
-
-
-
- -
- -
- -
- -
Observation Status Comments
Fire register [Site]
COSHH
Safe Storage
Hazardous Substance Register
MSDS Sheets Documented
Hand Tools/Plant/Transport
Hand Tools [PAT]
Plant
Transport Equipment
Excavation
Electricity
Acceptable In place.
Acceptable Assessments in place.
Acceptable No issues raised.
Acceptable In place and sufficient.
Acceptable Attached to assessments.
Acceptable No defects noted.
Acceptable PAT tested and in date.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Good practice
Acceptable No issues raised.
Overhead Power Lines Not Applicable Not Applicable.
Underground Services
Acceptable No issues raised.
HV Electrical installation Not Applicable Not Applicable.
Working at Height
Ladders
Step Ladders
Mobile Scaffold Towers
Roof work
Mobile Elevated Working Platforms [MEWP]
Hoists
Mechanical Lifting
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Clear and unobstructed.
Confined Space Not Applicable. Not Applicable.
Permit
Floor openings
Edge Protection
Signage
Safe working practices
Protective clothing /equipment
PPE-General
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable in place where required.
Acceptable Relevant safety signage is in place.
Acceptable No issues raised.
Acceptable 5 points of PPE as per site rules.
Acceptable No issues raised.
7 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
Action Date
- -
-
-
-
-
-
-
-
-
-
-
- -
- -
-
-
- -
- -
-
-
- -
-
-
-
-
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
- -
Observation
Manual handling
Environmental
Air Pollution
Water Pollution
Land Pollution
Noise Pollution
Dust Pollution
Acceptable No issues raised. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. -
Improvement Needed Dust management throughout the project needs to be improved. McLaughlin & Harvey Ltd Immediately
Working over /adjacent to water Not Applicable. Not Applicable.
Roadwork's Not Applicable. Not Applicable.
Working over/adjacent to railways Not applicable Not Applicable. - -
8 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
Action Date
Status Comments
-
- -
- -
Appendix 1 Photographs
9 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
10 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
11 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
12 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
13 2800_Eden Campus_ORSA Site Inspection_FJMK250424.docx
FH090-151015 appendix k
DAA CMT report
Architectural Progress Report _25th April 2024
Project Project Honey, Kingston Created By Alexander Cook
Job No 19064
Date 23/04/2023
Revision 01
1.0 Project Overview
Date 23/04/2023
Approved By Alastair Roberts
Date 23/04/2023
DAA continue to develop & coordinate the Stage 5 detailed design of buildings A + B + C with McLH in line with the construction programme.
DAA have been in frequent dialogue with RBKT to ensure condition discharge - Refer to the McLH + FH Conditions Tracker for further details.
DAA are to clos ing out the remaining planning conditions & are working to get the Bridge Link, Condition 03 & External Louvre NMA’s consented by RBKT.
2.0 Key Design Development/Deliverables
DAA are attending project DTM’s with McLH & the design team as well as organising specific design workshops with Structures, M+E, Facades, Building Control, Fire & BREEAM when required
A s lead design DAA continue the coordination of BIM models & have begun circulat ing our Revit models on a bi-weekly basis following all BIM protocol to ensure the design team is fully informed & coordinated
DAA issued architectural information that targets all pre-above ground planning conditions & continue to work with both McLH + FH to unlock the conditions. The CMT team continue to chase the progress of Condition 3 & associated comments
DAA are attending detailed design workshops on the proposed External Works, landscaping, Internal walls , waterproofing, roofing , external f acades to ensure further coordination between consultants, the occupier team & funders.
DAA continue to manage & present E xternal + Internal finishes samples to both the Unilever design team & RBKT for formal sign off. The design team are continuing to develop the façade detailed proposals with Clarkes & McLH through dedicated façade workshops & a re actively responding to RFI’s to ensure the façades retains the original design intent + quality.
DAA have attended site meetings + visits + snagging when required to review benchmark works on site, samples & detailed coordination issues.
3.0 Next Period / Key Decisions and Instructions Required
Instruction required on all occupier variations + associated DAA fees on the following: - Signage planning application.
- Any Additional Occupier Variations –Terrace Penetrations + Additional Works + CAT A Omissions
Architectural Progress Report _25th April 2024 – Revision 01 Project Honey, Kingston 19064 Page 1 of 3
Full understanding of any other new UL variations which could potentially affect the S tage 5 design programme is critical for avoiding redundant work.
4.0 Issued Documentation + Information.
DAA have issued design sketches + Updated Stage 5 Design Packs for the following :
MSCP Wayfinding
MSCP Roller Shutter Proposals
Entrance Link + BL Coordination
External Lighting + CCTV TVR
Blind Box design updates + coordination
External Works + Site coordination – Ramps / Stairs / Flood Voids / Railings – A + B + C
Fire Curtains + interface detailing – Bridge Link
RCP’s + MEP coordination/Set out
Service Yard elevations – External Lourves
Drylining Workshops + BWH coordination
RAF construction detailing
Area Drawings
Roller Shutter Construction Issue
Reception Screed Drawings + associated details
Roof Package Updates
Firestopping details – A + B + C
MSCP External Wall / Flood void / Blockwork
BC Tracker Development
Façade Coordination + Comments – A + B
Access + Security Strategy
DAA have fully updated their Architectural folder on Viewpoint + associated TIDP which now contains all issued drawings / specifications / reports / design options / sketches through to end of February
DAA have continued to attend BIM clash detection workshops when required & have always ensured that design development of Revit models are frequently issued following coordination workshops & key design changes/variations.
DAA have responded to all required RFI’s & provided comments via Viewpoint on all consultant drawings & design information.
Latest Stage 5 Car Park Architectural Information Issued within this period [Buildings C] :
13000 – Floorbeds - A5
21000 – External Walls + Façade Packages - A5
22000 – Internal Walls – A5
24000 – Stairs - A5
25000 – Cores - A5
2 7 000 – Roof Package - A5
30000 – GA Drawings - A5
34000 – Metalwork - A5
35000 – RCPs - A5
42000 – Wall Finishes - A5
43000 – Floor Finishes - A5
68000 – Fire Strategy - A5
44000 – Skirtings - A5
74000 – Sanitaryware Package - A5
Outline Finishes Specification
External Door Schedule - A5
Internal Door Schedule - A5
NBS Specifications - A5
Architectural Progress Report _25th April 2024 – Revision 01 Project Honey, Kingston 19064 Page 2 of 3
External Roller Shutter Proposal - A5
Floor beds + Gullies Changing village - A5
Latest Stage 5 Architectural Information Issued within this period [Buildings A + B] :
03000 – GA’s - A5 – CAT A Omissions
04000 – Ground Floor Setting Out + Slab Edge Set Out + Builders Works Penetrations - A5
13000 – Floorbeds - A5
23000 - Thermal Zones - A5
21000 – External Walls + Façade Packages - A5
22000 – Internal Walls - A5
23000 – Building Links – Reception + Bridge - A5
24000 – Stairs + Feature Stair Building B - A5
25000 – Core Package - A5
27000 – Roof Package - A5
31000 - External Door Schedule - A5
32000 – Internal Door Schedule - A5
33000 – RAF - A5
34000 – Metalwork - A5
35000 – RCP’s - A5 – CAT A Omissions
42000 – Wall Finishes - A5 – CAT A Omissions
43000 – Floor Finishes – A5 – CAT A Omissions
44000 – Skirtings – A5 – CAT A Omissions
68000 – Fire Strategy - A5
74000 – Sanitaryware Package - A5
80000 – Areas - A5
90000 – External Works - A5
External Door Schedule – A5
Internal Door Schedule – A5
NBS Specifications – A5
External Shutter – A5
Lift Finishes + Lobby - A5
Fire Stop Details + Fire Curtains - A5
Architectural Progress Report _25th April 2024 – Revision 01 Project Honey, Kingston 19064 Page 3 of 3
FH090-151015 appendix l
package review schedule
Architectural
Architectural Lifts (Internal finish) Lifts (Internal finish) RIBA 4
Architectural M10 Cement Base Levelling Wearing Screeds Technical Submittal RIBA 4 N/A
Architectural M60 Painting / Clear Finishing Technical Submittal RIBA 4 N/A
Architectural NIA Plans - Areas Building A & B RIBA 4 22/12/2022 24/01/2023 17 days 24/01/2023
Architectural Circleslide Curved Sliding Door Technical Submittal RIBA 5 N/A 13/10/2023 N/A 13/10/2023 02/11/2023
02/10/2023 B 02/10/2023 B 02/10/2023 B
package review schedule Project Honey 07/05/2024 issue date discipline package description design stage planned release date (programme dated xxxx) actual release date delta all developer occupier/ fund date received status given date received status given date received status given comments Architectural Ceilings Building C RIBA 4 N/A 26/11/2022 N/A 26/11/2022 15/12/2022 13/12/2022 23/12/2022 A 23/12/2022 A 23/12/2022 A All plans received 26/11/2022. Architectural Circulation Stairs Circulation Stairs Building A RIBA 4 25/08/2022 02/09/2022 6 days 02/09/2022 22/09/2022 20/09/2022 29/09/2022 B 29/09/2022 B 29/09/2022 B All plans received on 02/09/2022 Architectural External Door Schedule & Plans Building C RIBA 5 N/A 02/08/2023 N/A 02/08/2023 22/08/2023 18/08/2023 17/08/2023 B 17/08/2023 B 17/08/2023 B Architectural External Doors (tbc with Clarkes) External Doors (tbc with Clarkes) RIBA 4 06/10/2022 15/11/2022 28 days 15/11/2022 05/12/2022 01/12/2022 01/12/2022 B 29/11/2022 A/B 29/11/2022 B All plans received 15/11/2022 Architectural External Doors Plan Building C RIBA 5 N/A 07/11/2023 N/A 07/11/2023 27/11/2023 23/11/2023 01/12/2023 B 01/12/2023 B 01/12/2023 B Architectural External works External works RIBA 4 15/08/2022 16/08/2022 1 day 16/08/2022 05/09/2022 01/09/2022 14/09/2022 A 14/09/2022 A 14/09/2022 A Woodland ramp building B external works received 23/08/2022 Architectural Façade Façade RIBA 4 N/A 02/12/2022 N/A 02/12/2022 22/12/2022 20/12/2022 Not issued for CMT review. Architectural Feature Stair Feature Stair - Building B RIBA 4 N/A 26/09/2022 N/A 26/09/2022 14/10/2022 12/10/2022 09/11/2022 B 09/11/2022 B 09/11/2022 B All plans received 26/09/2022 Architectural Feature Stair Feature Stair Building A RIBA 4 08/12/2022 15/12/2022 5 days 15/12/2022 13/01/2023 11/01/2023 12/01/2023 B 12/01/2023 B 12/01/2023 B Architectural Fire Strategy Fire Strategy Building A + B RIBA 4 03/10/2022 11/10/2022 6 days 11/10/2022 31/10/2022 27/10/2022 14/11/2022 B 14/11/2022 B 14/11/2022 B p Mace agreed to downgrade HL status C to Status B on 21/11/2022 Architectural Floor Finishes Floor Finishes RIBA 4 05/09/2022 20/09/2022 11 days 20/09/2022 10/10/2022 06/10/2022 11/10/2022 B 11/10/2022 B 11/10/2022 B All plans received on 20/09/2022 Architectural Floor finishes Building C RIBA 4 N/A 26/11/2022 26/11/2022 15/12/2022 13/12/2022 03/01/2023 A 03/01/2023 A 03/01/2023 A
Floor
Door Stop
16/10/2023 N/A 16/10/2023 03/11/2023 01/11/2023 31/10/2023 A 31/10/2023 A 31/10/2023 A Architectural Green Wall Design Drawings RIBA 5 N/A 01/11/2023 N/A 01/11/2023 21/11/2023 17/11/2023 21/11/2023 A 21/11/2023 A 21/11/2023 A All plans received 20/11/2023. Architectural Internal lighting Block A + B calculations RIBA 4 N/A 08/09/2022 N/A 08/09/2022 28/09/2022 26/09/2022 13/10/2022 B 13/10/2022 B 13/10/2022 B All plans received on 08/09/2022
Architectural
Mounted
Sample Submittal RIBA 5 N/A
20/10/2022 13/12/2022 13/12/2022 11/01/2023 09/01/2023 22/12/2022 B 22/12/2022 B 22/12/2022 B
Internal Walls and ironmongery Internal Walls and ironmongery RIBA 4
RIBA 4 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 06/02/2023 A/B 06/02/2023 A/B 06/02/2023
Architectural K41 Raised Access Floors Technical Submittal
A/B
28/11/2022 28/11/2022 16/12/2022 14/12/2022 19/12/2022
19/12/2022
19/12/2022
A
A
A
25/01/2023 14/02/2023 10/02/2023 21/02/2023 A/B 21/02/2023 A/B 21/02/2023 A/B Received comments from Perkins and Will on 21/02/2023
25/01/2023 N/A
25/01/2023
25/01/2023 14/02/2023 10/02/2023 21/02/2023 A/B 21/02/2023 A/B 21/02/2023
Received comments from Perkins and Will on 21/02/2023
26/11/2022
26/11/2022 15/12/2022 13/12/2022 23/12/2022
23/12/2022
23/12/2022
N/A
A/B
Architectural Metalwork Building C RIBA 4 N/A
N/A
A
A
A
02/11/2022 31/10/2022 14/11/2022 B 14/11/2022 B 14/11/2022 B All plans received 13/10/2022
Architectural Metalwork (Plantroom steel) (tbs with Clarkes) Metalwork (Plantroom steel?) (tbs with Clarkes) RIBA 4 13/10/2022 13/10/2022 0 days 13/10/2022
Architectural Metalworks Design Building A & B Stairs RIBA 5 N/A 16/11/2023 N/A 16/11/2023 06/12/2023 04/12/2023
13/02/2023 09/02/2023 16/03/2023 A 16/03/2023 A 16/03/2023 A
Raised Access Floor Raised Access Floor RIBA 4 13/10/2022 14/10/2022 1 day 14/10/2022 03/11/2022 01/11/2022 07/11/2022 B 07/11/2022 B 07/11/2022 B All plans received 14/10/2022 Architectural Roof Roof RIBA 4 06/10/2022 07/10/2022 1 day 07/10/2022 27/10/2022 25/10/2022 09/11/2022 A 09/11/2022 A 09/11/2022 A All plans received 07/10/2022 Architectural Roof Completions Roof Details RIBA 4 06/10/2022 07/10/2022 1 day 07/10/2022 27/10/2022 25/10/2022 09/11/2022 A 09/11/2022 A 09/11/2022 A All plans received 07/10/2022 Architectural Sanitary Building C RIBA 4 13/10/2022 30/11/2022 34 days 30/11/2022 20/12/2022 16/12/2022 03/01/2023 B 03/01/2023 B 03/01/2023 B Architectural sanitary Building A + B RIBA 4 N/A 24/11/2022 N/A 09/01/2023 27/01/2023 25/01/2023 09/01/2023 B 09/01/2023 B 09/01/2023 B All plans received 24/11/2022 Architectural Site layout and landscape plan Site layout and landscape plan RIBA 4 N/A 22/11/2022 N/A 22/11/2022 12/12/2022 08/12/2022 22/12/2022 B 22/12/2022 B 22/12/2022 B All plans received 21/10/2022 Architectural Skirting Skirting RIBA 4 08/08/2022 09/08/2022 1 day 09/08/2022 30/08/2022 25/08/2022 30/08/2022 A 30/08/2022 A 25/08/2022 A 11th floor skirting plan received on 10th August Architectural Stairs Building C RIBA 4 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 12/01/2023 B 12/01/2023 B 12/01/2023 B Architectural Sub Floors Sub Floors RIBA 4 15/09/2022 31/08/2022 -11 days 31/08/2022 06/10/2022 04/10/2022 11/10/2022 B 11/10/2022 B 11/10/2022 B All plans received on 31/08/2022 Architectural Subfloors Building C RIBA 4 N/A 26/11/2022 N/A 26/11/2022 15/12/2022 13/12/2022 23/12/2022 A 23/12/2022 A 23/12/2022 A Architectural Wall Finishes Wall Finishes RIBA 4 08/08/2022 09/08/2022 1 day 09/08/2022 30/08/2022 25/08/2022 30/08/2022 A 30/08/2022 A 25/08/2022 A All plans received on 09/08/2022 Architectural Wall finishes Building C RIBA 4 N/A 26/11/2022 N/A 26/11/2022 15/12/2022 13/12/2022 14/01/2023 B 14/01/2023 B 14/01/2023 B Architectural Way finding strategy Ground Floor C RIBA 4 N/A 12/11/2022 N/A 12/11/2022 01/12/2022 29/11/2022 09/12/2022 B 09/12/2022 B 09/12/2022 B All plans received 12/11/2022 Architectural Woodland walk- GA Woodland walk- GA RIBA 4 N/A 22/11/2022 N/A 22/11/2022 12/12/2022 08/12/2022 03/01/2023 B 03/01/2023 B 03/01/2023 B All plans received 21/10/2022
Soffit Building A Details & Sections RIBA 5
05/02/2024 N/A 05/02/2024 23/02/2024 21/02/2024 21/02/2024 B 21/02/2024 B 21/02/2024 B Architectural Building A Façade Plan Details Façade details RIBA 5 N/A 16/09/2023 N/A 16/09/2023 05/10/2023 03/10/2023
Architectural
Architectural
N/A
20/11/2023 A 20/11/2023 A
A
01/12/2023 08/01/2024 A 08/01/2024 A 08/01/2024 A Architectural
Fire Strategy Report Report RIBA
13/12/2023 11/12/2023 18/12/2023 B 18/12/2023 B 18/12/2023 B Architectural Fire Strategy Report RIBA 4 N/A 24/01/2023 N/A 24/01/2023 13/02/2023 09/02/2023 08/02/2023 A/B 08/02/2023 A/B 08/02/2023 A/B Architectural Fire Strategy Site Wide Plan RIBA 4 N/A 14/02/2023 N/A 14/02/2023 06/03/2023 02/03/2023 21/02/2023 B 21/02/2023 B 21/02/2023 B Architectural yp y g Ceilings Architectural Technical Submittal RIBA 4 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2023 B 12/01/2023 B 31/01/2023 B Closed out on 31/01/2023 Architectural K20 Timber Board Flooring Architectural Technical Submittal RIBA 5 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 14/03/2023 B 14/03/2023 B 14/03/2023 B Awaiting comments. comments received/ status given developer occupier fund response required by https://francishunter-my.sharepoint.com/personal/kyra_bosompem_francishunter_co_uk/Documents/Documents/Project Honey/Package Review Schedule/Project Honey Package Review Schedule 231120
31/10/2023
20/11/2023
Architectural External Works Site Wide Woodland Walk Path RIBA 5 N/A 15/11/2023 N/A 15/11/2023 05/12/2023
Façade
4 23/11/2023 23/11/2023 23/11/2023
Architectural
Architectural
MEP
MEP
MEP
MEP
MEP
MEP BMS description of operations BMS description of operations RIBA 3 14/10/2022 14/10/2022 0 days 14/10/2022 03/11/2022 01/11/2022 04/11/2022 B 04/11/2022 B 04/11/2022 B All plans received on 14/10/2023
MEP Cable connections Cable connections RIBA 3 N/A 03/10/2022 N/A 03/10/2022 21/10/2022 19/10/2022 19/10/2022
MEP
MEP Chilled water schematic Building A & B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 20/01/2023
MEP Cold Water Booster Tank Room Building B RIBA 3 N/A 05/12/2022 05/12/2022 23/12/2022 21/12/2022 04/01/2023
20/01/2023
20/01/2023 B
MEP Containment Sizing calculations RIBA 3 10/10/2022 03/10/2022 -5 days 03/10/2022 21/10/2022 19/10/2022 20/10/2022 B 20/10/2022 B 20/10/2022 B All plans received 03/10/2022
MEP Containment Specification RIBA 3 N/A 10/10/2022 N/A 10/10/2022 28/10/2022 26/10/2022 20/10/2022 B 20/10/2022 B 20/10/2022 B All plans received 10/10/2022
MEP Containment Layouts (Building A) RIBA 3 21/11/2022 11/11/2022 -6 days 11/11/2022 01/12/2022 29/11/2022 12/12/2022 B 12/12/2022 B 12/12/2022 B All plans received 11/11/2022.
MEP Containment Layouts (Building C) RIBA 4 N/A 09/03/2023 N/A 31/07/2023 18/08/2023 16/08/2023 29/08/2023
MEP Containment Layouts (Building A) RIBA 4 N/A 14/04/2023 N/A 14/04/2023 04/05/2023 02/05/2023 30/05/2023
MEP Containment Layouts (Building B) RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 30/05/2023 C 30/05/2023 C 30/05/2023 C
MEP Containment Layouts Building A & B RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 19/12/2023 B 19/12/2023 B 19/12/2023
MEP Containment Layouts Building B RIBA 3 N/A 03/11/2022 03/11/2022 23/11/2022 21/11/2022
MEP Containment Layouts Building C RIBA 3 05/12/2022 05/12/2022 0 days 05/12/2022 23/12/2022 21/12/2022 08/12/2022
MEP Controls (BMS)
18/07/2022 14/10/2022
package review schedule Project Honey 07/05/2024 issue date discipline package description design stage planned release date (programme dated xxxx) actual release date delta all developer occupier/ fund date received status given date received status given date received status given comments comments received/ status given developer occupier fund response required by Architectural Lift Finishes Schedule Building C RIBA 4 N/A 13/04/2023 N/A 13/04/2023 03/05/2023 01/05/2023 Architectural Link Bridge Elevations, Sections and Details RIBA 5 N/A 22/08/2023 N/A 22/08/2023 11/09/2023 07/09/2023 04/09/2023 B 04/09/2023 B 04/09/2023 B Status C received on 04/09/2023 on the following drawings. - Level 06 Block A & Link Bridge Interface Plan Details at Vision and Corner - Level 06 Block B & Link Bridge Interface Plan Details at Vision and Corner - Level 06 Block B & Link Bridge Interface Plan Details at Cladding/Spandrel - Level 06 Block A & Link Bridge Interface Plan Details at Cladding/Spandrel (A) Architectural Balustrade Calculations Technical Submittal RIBA 5 N/A 20/01/2024 N/A 20/01/2024 08/02/2024 06/02/2024 05/02/2024 C 05/02/2024 C 05/02/2024 C Architectural Section details Underside Building B RIBA 4 N/A 18/01/2024 N/A 18/01/2024 07/02/2024 05/02/2024 05/02/2024 B 05/02/2024 B 05/02/2024 B Architectural M40 stone /concrete/quarry/ ceramic tiling / Architectural Technical Submittal RIBA 4 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2023 B 12/01/2023 B 31/01/2023 B Closed out on 31/01/2023 Architectural Maple Drawings Building C RIBA 4 N/A 10/05/2023 N/A 10/05/2023 30/05/2023 26/05/2023 02/05/2023 A/B 02/05/2023 A/B 02/05/2023 A/B Received all plans on
10/05/2023.
the
Panel Setting Out Plans Building A & B RIBA 4 N/A 24/01/2023 N/A 24/01/2023 13/02/2023 09/02/2023 14/02/2023 B 14/02/2023 B 14/02/2023 B All plans received.
Sample Sheets Building C RIBA 5 N/A 24/11/2023 N/A 24/11/2023 14/12/2023 12/12/2023 05/02/2024 A/B 05/02/2024 A/B 05/02/2024 A/B Awaiting comments on sample approval form 26, 27 and 49. Architectural Stick Curtain Wall Building A & B RIBA 4 N/A 29/06/2023 N/A 29/06/2023 19/07/2023 17/07/2023 21/07/2023 B 21/07/2023 B 21/07/2023 B All plans received. Architectural U- Value and Condensation Risk Assessment Building B Level 02 Unitised Facade Technical Submittal RIBA 5 N/A 19/06/2023 N/A 19/06/2023 07/07/2023 05/07/2023 13/07/2023 C 13/07/2023 C 13/07/2023 C Architectural Z20 Fixings and Adhesives Architectural Technical Submittal RIBA 5 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2022 B 12/01/2023 A 31/01/2022 B Closed out on 31/01/2023 Architectural Z22 Sealants Architectural Technical Submittal RIBA 4 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2022 B 12/01/2023 B 31/01/2023 B Closed out on 31/01/2023 Architectural Z31 Powder Coatings Architectural Technical Submittal RIBA 4 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2023 B 31/01/2023 B 31/01/2023 B Closed out on 31/01/2023 Architectural Z33 Anodizing Architectural Technical Submittal RIBA 5 N/A 11/01/2023 N/A 11/01/2023 31/01/2023 27/01/2023 31/01/2023 B 12/01/2023 B 31/01/2023 B Closed out on 31/01/2023 Architectural Floor finishes Building C RIBA 5 N/A 15/12/2023 N/A 15/12/2023 12/01/2024 10/01/2024 Removed from CMT Workflow. Architecture Thermal Zones Thermal Zone package for Buildings A and B RIBA 4 07/07/2022 08/07/2022 1 day 08/07/2022 27/07/2022 26/07/2022 27/07/2022 B 27/07/2022 B 27/07/2022 B All plans received on 08/07/2022 MEP Above Ground Drainage Building C RIBA 3 N/A 27/01/2023 N/A 27/01/2023 16/02/2023 14/02/2023 15th floor rejected. MCLH & Delivery team review status B given. MEP Above Ground Drainage Building B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 18/01/2023 B Awaiting comments from developer and fund. MEP Above Ground Drainage Building A RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 18/01/2023 B Awaiting comments from developer and fund.
20/12/2022 19/01/2023 17/01/2023 17/01/2023 B 17/01/2023 B 17/01/2023 B
MEP Above ground drainage stack positions Building C RIBA 3 N/A 20/12/2022 N/A
Above
stack positions Building
5
13/03/2024
13/03/2024 02/04/2024 29/03/2024 15/03/2024 A 18/03/2024 A 18/03/2024 A
ground drainage
C RIBA
N/A
N/A
12/03/2024 01/04/2024 28/03/2024 20/03/2024 A/B 20/03/2024 A/B 20/03/2024 A/B
ABS Pipe and Fittings for Condensate Drainage Technical Submittal RIBA 5 N/A 12/03/2024 N/A
Gong Technical Submittal RIBA 4
17/04/2023 N/A 17/04/2023 05/05/2023 03/05/2023 24/04/2023 B 24/04/2023 B 24/04/2023 B
Ancillary ventilation schematic Building B RIBA 3 N/A 44915 N/A 44915 44945 17/01/2023 16/01/2023 B 16/01/2023 B 16/01/2023 B
MEP Alarm
N/A
MEP
ASHRAE Modelling ASHRAE Modelling RIBA 3 N/A 25/09/2022 N/A 25/09/2022 13/10/2022 11/10/2022 20/10/2022 B 20/10/2022 B 20/10/2022 B All plans received 25/09/2022
Below ground drainage Below ground drainage RIBA 3 N/A 13/09/2022 N/A 13/09/2022 03/10/2022 29/09/2022 05/10/2022 B 05/10/2022 B 05/10/2022 B All plans received on 31/08/2022
B
Below ground drainage Construction details RIBA 3 N/A 13/09/2022 N/A 13/09/2022 03/10/2022 29/09/2022 05/10/2022
05/10/2022 B 05/10/2022 B All plans received on 13/09/2022
B
B
B
19/10/2022
19/10/2022
All plans received 03/10/2022
Chilled Water Pump Technical Submittal RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 21/11/2023 B
B
B
B 04/01/2023 B 04/01/2023 B
B 29/08/2023 B 29/08/2023 B
B 30/05/2023 B 30/05/2023 B Building A 1st, 5th and 8th floor status C due to CAT A.
B
B 13/02/2023 B 08/12/2022 B
MEP
A schematic RIBA 5
13/03/2024 -43 days 13/03/2024 02/04/2024 29/03/2024 14/03/2024 A 08/04/2024 B MEP Cooling load and heat loss calculationsBuilding A, B & C Cooling load and heat loss calculationsBuilding A, B & C RIBA 3 N/A 03/10/2022 N/A 03/10/2022 21/10/2022 19/10/2022 19/10/2022 B 19/10/2022 B 19/10/2022 B All plans received
20/02/2023 60 days 21/02/2023 13/03/2023 09/03/2023 05/04/2023 C 05/04/2023 C 05/04/2023 C
Disabled Refuge Alarm System Alarm System RIBA 4 N/A 30/05/2023 N/A 30/05/2023 19/06/2023 15/06/2023 08/06/2023 A MEP Disabled refuge schematic Building C RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 22/03/2023 C 22/03/2023 C 22/03/2023 C MEP Disabled refuge schematic Building A & B RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 08/12/2022 B MEP Disabled Toilet Alarm System Alarm System RIBA 4 N/A 30/05/2023 N/A 30/05/2023 19/06/2023 15/06/2023 02/06/2023 B 01/08/2023 B 01/08/2023 B MEP Domestic schematics Building A & B RIBA 4 N/A 15/03/2023 N/A 15/03/2023 04/04/2023 31/03/2023 06/06/2023 C 06/06/2023 C 06/06/2023 C https://francishunter-my.sharepoint.com/personal/kyra_bosompem_francishunter_co_uk/Documents/Documents/Project Honey/Package Review Schedule/Project Honey Package Review Schedule 231120
Description of operations RIBA 3
88 days 14/10/2022 03/11/2022 01/11/2022 04/11/2022 B 02/11/2022 B 04/11/2022 B All plans received 14/10/2022
Cooling (CHW) system Building
N/A
03/10/2022 MEP Design report Design report RIBA 3 23/11/2022
MEP
MEP
MEP
MEP Drainage Layout Building B & C RIBA 4 N/A 14/04/2023 N/A 14/04/2023 04/05/2023 02/05/2023 12/05/2023 B 02/05/2023 B 12/05/2023 B
MEP Drainage Layout Building C RIBA 5 N/A 13/03/2024 N/A 13/03/2024 02/04/2024 29/03/2024 15/03/02024 A/B 18/03/2024 A/B 18/03/2024 A/B Status B given on the following floors - 7th floor
MEP Dry Riser Building A RIBA 4 N/A 23/05/2023 N/A 23/05/2023 12/06/2023 08/06/2023 20/06/2023 A/B 07/06/2023 A/B 20/06/2023 A/B
MEP Dry Riser Building A + B RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 10/01/2023 B 10/01/2023 B 10/01/2023 B
MEP Dry Riser Building A & B RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 01/12/2023 A/B 14/12/2023 A/B 14/12/2023 A/B
MEP Dry Riser Building C RIBA 4 N/A 12/06/2023 N/A 12/06/2023 30/06/2023 28/06/2023 20/06/2023 B 20/06/2023 B 20/06/2023 B
MEP Dry Riser Building C RIBA 3 N/A 14/02/2022 N/A 14/02/2022 04/03/2022 02/03/2022 17/03/2023 B 13/03/2023 B 13/03/2023 B
MEP Electrical riser Drawings Building A + B RIBA 3 N/A 11/11/2022 N/A 11/11/2022 01/12/2022 29/11/2022 11/11/2022 C C C All plans received 11/11/2022. Reason rejected: Provide LV schematics.
MEP Electrical riser Drawings Building A + B+C RIBA 4 N/A 15/03/2023 N/A 15/03/2023 04/04/2023 31/03/2023 30/05/2023 C 30/05/2023 C 30/05/2023 C
MEP Electrical Vehicle charging Electrical Vehicle charging RIBA 3 N/A 27/03/2023 N/A 27/03/2023 14/04/2023 12/04/2023 31/05/2023 C 31/05/2023 C 31/05/2023 C
MEP Emergency Exit Light Fitting Light Fitting RIBA 4 N/A 30/05/2023 N/A 30/05/2023 19/06/2023 15/06/2023 02/06/2023 A 02/06/2023 A 02/06/2023 A
MEP Energy statement Energy statement RIBA 3 N/A 12/09/2022 N/A 12/09/2022 30/09/2022 28/09/2022 20/10/2022 B 20/10/2022 B 20/10/2022 B All plans received on 12/09/2023
MEP Exterior Lighting Design Site Wide RIBA 4 N/A 15/05/2023 N/A 15/05/2023 02/06/2023 31/05/2023 01/06/2023 B 01/06/2023 B 01/06/2023 B
MEP Fire Alarm Building A Layout RIBA 5 N/A 04/12/2023 N/A 04/12/2023 22/12/2023 20/12/2023 21/12/2023
MEP Fire Alarm and Security Building A Layouts RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 22/05/2023 B 09/06/2023 B 22/05/2023 B
MEP Fire Alarm and Security Building B RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 22/05/2023 B 09/06/2023 B 22/05/2023 B
MEP Fire Alarm and Security Building A, B & C Layouts RIBA 5 N/A 04/12/2023 N/A 04/12/2023 22/12/2023 20/12/2023 06/12/2023 A/B 21/12/2023 A/B 21/12/2023 A/B
MEP Fire alarm
MEP Generator Technical Submittal RIBA 5 N/A 12/03/2024 N/A 12/03/2024 01/04/2024 28/03/2024 20/03/2024 B 20/03/2024 B 20/03/2024 B
MEP Generator controls schematic Site wide RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 08/12/2022 B 08/12/2022 B 08/12/2022 B
MEP
20/12/2022
20/12/2022 19/01/2023
N/A
N/A
Layout. MEP Lighting and emergency lighting Drawings building B RIBA 3 05/11/2022 20/12/2022 0 days 20/12/2022 09/01/2023 05/01/2023 All plans received 03/11/2022
MEP Lighting and emergency lighting Building B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 09/01/2023 05/01/2023 18/01/2023
and Building C - M0
18/01/2023 B 18/01/2023 B All
MEP Lighting Layout Building A RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 02/06/2023 A/B 02/06/2023 A/B 02/06/2023 A/B MEP Lighting Layout Building B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 18/01/2023 B 18/01/2023 B 18/01/2023 B All packages received.
MEP Lighting Layout Building A, B, & C RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024 02/02/2024 B
MEP Lightning protection Layouts Building C RIBA 4 N/A 02/05/2023 N/A 02/05/2023 22/05/2023 18/05/2023 31/05/2023 B 31/05/2023 B 31/05/2023 B Status C received on 13/12/2022. Revision plans uploaded on 16/02/2023.
MEP
package review schedule Project Honey 07/05/2024 issue date discipline package description design stage planned release date (programme dated xxxx) actual release date delta all developer occupier/ fund date received status given date received status given date received status given comments comments received/ status given developer occupier fund response required by MEP Domestic schematics Building A & B RIBA 3 05/11/2022 03/11/2022 - 2 days 03/11/2022 23/11/2022 21/11/2022 18/11/2022 C 18/11/2022 C 18/11/2022 C Status C received. MEP Domestic schematics Building C RIBA 3 05/11/2022 05/12/2022 0 days 05/12/2022 23/12/2022 21/12/2022 16/01/2023 C 16/01/2023 C 16/01/2023 C Status C received MEP Domestic Schematics Building C RIBA 5 N/A 13/03/2024 N/A 13/03/2024 02/04/2024 29/03/2024 21/03/2024 C 21/03/2024 C 21/03/2024 C MEP Domestic Services Layouts Building A & B RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 02/06/2023 C 22/06/2023 C 22/06/2023 C MEP Domestic services Layouts - Building A + B RIBA 3 N/A 17/11/2022 N/A 17/11/2022
C C C Status
received
07/12/2022 05/12/2022
C
Domestic Services Building A
B Layout
C
&
RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 20/06/2023
20/06/2023 C 20/06/2023 C
B 22/09/2023 B 22/09/2023 B
Domestic tank schematic Building A & B RIBA 3
02/02/2023 B 18/01/2023 B 02/02/2023 B
Domestic water (H&C) systems Schedules RIBA 3 26/10/2022 03/11/2022 6 days 03/11/2022 23/11/2022 21/11/2022 All plans received 03/11/2022
Domestic water (H&C) systems Drawings RIBA 3 05/11/2022 03/11/2022 0 days 03/11/2022 23/11/2022 21/11/2022 All plans received 03/11/2022
MEP Domestic Services Building B RIBA 5 N/A 28/08/2023 N/A 28/08/2023 15/09/2023 13/09/2023 22/09/2023
MEP
N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023
MEP
MEP
day 25/09/2022
11/10/2022 20/10/2022 B 20/10/2022 B 20/10/2022 B All plans received 25/09/2022
MEP Domestic water (H&C) systems Design and Calculations RIBA 3 26/09/2022 25/09/2022 -1
13/10/2022
Drainage Layout Building A RIBA 4
23/05/2023 23/05/2023 08/06/2023
N/A 14/04/2023 N/A
12/06/2023 B 07/06/2023 B 20/06/2023 B
schematic Building B RIBA 5 N/A 17/10/2023
17/10/2023 06/11/2023 02/11/2023 08/11/2023 B 08/11/2023 B 08/11/2023 B
Fire alarm schematic Building C RIBA 5 N/A 17/10/2023 N/A 17/10/2023 06/11/2023 02/11/2023 08/11/2023 B 16/11/2023 B 16/11/2023
Fire alarm schematic Building A RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 08/12/2022 C 08/12/2022 C 08/12/2022 C Status C received.
Fittings Site wide RIBA 4 N/A 28/03/2023 N/A 28/03/2023 17/04/2023 13/04/2023 31/05/2023 B 20/06/2023 B 20/06/2023 B Following dwgs received status C - Type A & AE Fitting - Type G Fitting
Flow Meter Technical Submittal RIBA 4 N/A 17/04/2023 N/A 17/04/2023 05/05/2023 03/05/2023 24/04/2023 B 24/04/2023 B 24/04/2023
12/05/2023 A
B
B
N/A
MEP
Awaiting Occupier and Fund comments. MEP
MEP
MEP
B MEP Foul Drainage Diagrammatic Building C RIBA 4 N/A 02/05/2023 N/A 02/05/2023 22/05/2023 18/05/2023
19/05/2023
19/05/2023
MEP Foul Drainage Schematic Building A RIBA 4 N/A 03/04/2023 N/A 03/04/2023 21/04/2023 19/04/2023 11/04/2023 B 02/05/2023 B 02/05/2023 B
Building
GF Lighting
Generator Exhaust Flue Systems Technical Submittal RIBA 5 N/A 15/12/2023 N/A 15/12/2023 04/01/2024 02/01/2024 21/03/2024 A 21/01/2024 A 21/01/2024 A MEP Grooved NRV Technical Submittal RIBA 4 N/A 17/04/2023 N/A 17/04/2023 05/05/2023 03/05/2023 24/04/2023 B 01/05/2023 A 24/04/2023 B MEP Heating (LTHW) system Building A schematic RIBA 3 22/10/2022
0 days
17/01/2023 20/01/2023 B Awaiting comments from developer and fund. MEP Lighting Building A, B & C Layouts RIBA 4
09/03/2023
09/03/2023 29/03/2023 27/03/2023 22/05/2023 B 14/06/2023 B 14/06/2023 B MEP Lighting and emergency lighting Building A, B & C Layouts RIBA 3 02/11/2022 20/12/2022 0 days 25/11/2022 15/12/2022 13/12/2022 08/12/2022 B 08/12/2022 B 08/12/2022 B Awaiting comments from all parties for
C -
Layout
Lighting
B
plans received.
Lightning protection Layouts Building C RIBA 5 N/A 12/03/2024 N/A 12/03/2024 01/04/2024 28/03/2024 20/03/2024 B 20/03/2024 B 20/03/2024 B MEP Lightning protection Drawings (Building A + B GF and roof) RIBA 3 N/A 16/02/2023 N/A 16/02/2023 08/03/2023 06/03/2023 All plans received 11/11/2022. Previous Plans were given status C on 21/11/2022. Revisions received 16/02/2022.
31/05/2023 B 31/05/2023 B MEP Lightning protection Drawings and design RIBA 3 08/09/2022 10/10/2022 21 days 10/10/2022 28/10/2022 26/10/2022 21/10/2022 B 20/10/2022 B 21/10/2022 B All plans
10/10/2022.
11/11/2022
Low temperature hot
schematic Building
20/12/2022
20/12/2022 17/01/2023 13/01/2023 18/01/2023 B Awaiting comments. MEP Low temperature hot water schematic Building A RIBA 5 N/A 13/03/2024 N/A 13/03/2024 02/04/2024 29/03/2024 14/03/2024 A/B 08/04/2024 A/B 08/04/2024 A/B MEP LTHW Pump Technical Submittal RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 22/11/2023 B MEP Luminaire Specification Initial load assessment calculations RIBA 5 N/A 09/12/2022 09/12/2022 06/01/2023 04/01/2023 13/12/2022 B MEP LV & LV life Safety Schematic Building A RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024 19/02/2024 C 19/02/2024 C 19/02/2024 C MEP LV & LV life Safety Schematic Building C RIBA 3 04/11/2022 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 07/02/2023 B 07/02/2023 B 07/02/2023 B MEP LV Power Switch Room Schematics RIBA 3 02/11/2022 03/11/2022 0 days 03/11/2022 23/11/2022 21/11/2022 All plans received 03/11/2022 MEP LV Power Switch Room Schematics (Building C) RIBA 3 04/11/2022 19/01/2023 10 days 19/01/2023 08/02/2023 06/02/2023 14/02/2023 C 14/02/2023 C 14/02/2023 C All plans received 18/11/2022 MEP LV Switchboard SB-OC Building C RIBA 5 N/A 12/03/2024 N/A 12/03/2024 01/04/2024 28/03/2024 20/03/2024 B 20/03/2024 B 20/03/2024 B https://francishunter-my.sharepoint.com/personal/kyra_bosompem_francishunter_co_uk/Documents/Documents/Project Honey/Package Review Schedule/Project Honey Package Review Schedule 231120
MEP Lightning protection Building B RIBA 3 N/A 20/02/2023 N/A 20/02/2023 10/03/2023 08/03/2023 31/05/2023 B
received
Roof and GF drawings received
MEP
water
A + B RIBA 3 N/A
N/A
MEP
MEP Potable Cold Water Storage Building A,B & C RIBA 4 N/A 17/07/2023 N/A 17/07/2023 04/08/2023 02/08/2023 24/07/2023 C 16/08/2023 C 16/08/2023 C
MEP Pressure Switch Technical Submittal RIBA 4 N/A 17/04/2023 N/A 17/04/2023 05/05/2023 03/05/2023 24/04/2023 B 24/04/2023 B 24/04/2023 B
MEP Project Honey MEP Spec Specification RIBA 4 N/A 03/11/2023 N/A 03/11/2023 23/11/2023 21/11/2023 26/01/2024 B 26/01/2024 B 26/01/2024 B
MEP Pump House Building B - Level 00 RIBA 4 N/A 31/08/2023 N/A 31/08/2023 20/09/2023 18/09/2023 27/11/2023 A 27/11/2023 A 27/11/2023 A
MEP Pump House Building B - Level 00 RIBA 3 N/A 19/01/2023 N/A 19/01/2023 08/02/2023 06/02/2023 06/02/2023 B
MEP PV PV RIBA 3 N/A 25/09/2022 N/A 25/09/2022 13/10/2022 11/10/2022 25/09/2022 C 25/09/2022 C 25/09/2022 C All plans received 25/09/2022. Status C was received
MEP QAHV Sanitary Hot Water Pump Building C RIBA 5 N/A 17/07/2023 N/A 17/07/2023 04/08/2023 02/08/2023 14/08/2023 C 16/08/2023
MEP Rainwater diagrammatic Building C RIBA 4 N/A 02/05/2023 N/A 02/05/2023 22/05/2023 18/05/2023 12/05/2023 A 19/05/2023 B 19/05/2023 B
MEP Rainwater drainage schematic Building A & B RIBA 4 N/A 03/04/2023 N/A 03/04/2023 21/04/2023 19/04/2023 11/04/2023 B 02/05/2023 B 02/05/2023 B
MEP RD102 Sprinkler Specification RIBA 4 N/A 31/03/2023 N/A 31/03/2023 20/04/2023 18/04/2023 11/04/2023 A 20/06/2023 A 20/06/2023 A
MEP Sanitaryware Technical submittal RIBA 5 N/A 12/01/2024 N/A 12/01/2024 01/02/2024 30/01/2024 13/02/2024 B 22/02/2024 B 22/02/2024 B
MEP Shower Channel Gullies Technical Submittal RIBA 4 N/A 14/06/2023 N/A 14/06/2023 04/07/2023 30/06/2023 30/06/2023 B
MEP Site Utilities Incoming Services Plans RIBA 4 N/A 11/09/2023 N/A 11/09/2023 29/09/2023 27/09/2023 02/10/2023 C 02/10/2023 C 02/10/2023 C Status B given by MCLH and closed out on 22/02/2023.
MEP Site Wide
MEP Small Power and Data Layouts (Building C) RIBA 4 N/A 12/06/2023 N/A 12/06/2023 30/06/2023 28/06/2023 29/08/2023 B 29/08/2023 B 29/08/2023 B All plans received 12/06/2023.
MEP Small power and data Layouts (building C) RIBA 3 N/A 18/11/2022 N/A 18/11/2022 08/12/2022 06/12/2022 08/12/2022 B 13/02/2023 B 08/12/2022 B All plans received 18/11/2022.
MEP Small power and data Layouts (building A + B) RIBA 3 N/A 25/11/2022 N/A 25/11/2022 15/12/2022 13/12/2022 15/12/2022 B 15/12/2022 B 15/12/2022 B All plans received 25/11/2022
MEP Small power layout Building A & B RIBA 4 N/A 23/03/2023 N/A 23/03/2023 12/04/2023 10/04/2023 08/06/2023 B 07/06/2023 B 08/06/2023 B
MEP Small power layout Building A RIBA 5 N/A 04/12/2023 N/A 04/12/2023 22/12/2023 20/12/2023
MEP
MEP Smoke Ventilation System Design RIBA 4 N/A 24/08/2023 N/A 24/08/2023 13/09/2023 11/09/2023 28/11/2023 C 28/11/2023 C 28/11/2023 C Status C given to allow Halsion to reupload updated drawings.
MEP Smoke Ventilation System Wiring Schematic Building A, B & C RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 22/11/2023 C 22/11/2023 C 22/11/2023 C Status C given to allow Halsion to reupload updated drawings.
MEP Sprinkler and Dry Riser Mains Layout Building A +B RIBA 4 N/A 19/07/2023 NA 19/07/2023 08/08/2023 04/08/2023 24/07/2023 A 16/08/2023 A 16/08/2023 A
MEP Sprinkler Block Plan Building A & B RIBA 4 N/A 06/04/2023 N/A 06/04/2023 26/04/2023 24/04/2023 24/04/2023 B 02/05/2023 B 02/05/2023 B awaiting UL response.
MEP Sprinkler Protection Building A
MEP Sprinkler protection Building B RIBA 3 N/A 25/11/2022 N/A 25/11/2022 15/12/2022 13/12/2022 03/01/2023 A/B 03/01/2023 A/B 03/01/2023 A/B
MEP Sprinkler protection Layouts Building A RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 14/12/2022 C 14/12/2022 C 14/12/2022 C Status C received
MEP Sprinkler protection RCP Layouts Building A RIBA 3 N/A 03/11/2022 N/A 03/11/2022 23/11/2022 21/11/2022 10/01/2023 B 10/01/2023 B 10/01/2023 B Awaiting comment from occupier for Level 01 Sprinkler Protection Layout.
MEP Sprinkler Protection Pipework Layout Building B RIBA 4 N/A 07/08/2023 NA 07/08/2023 25/08/2023 23/08/2023 14/08/2023 B 29/08/2023 B 29/08/2023 B Status C given to Level 1 on 28/11/2023.
MEP Sprinkler Protection Pipework Layout Layouts Building B RIBA 3 01/12/2022 25/11/2022 -4 days 25/11/2022 15/12/2022 13/12/2022 09/01/2023 B 09/01/2023 B 09/01/2023 B
MEP Sprinkler protection RCP layout Building B RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 01/12/2023 A 07/12/2023 A
MEP Sprinkler protection RCP layout Building A RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 06/12/2022 A Revisions uploaded on 27/01/2023, awaiting comments.
MEP Sprinkler protection RCP layout Building A & B RIBA 4 N/A 15/05/2023 N/A 15/05/2023 02/06/2023 31/05/2023 30/05/2023 B 02/06/2023 B 02/06/2023 B
MEP Sprinkler protection RCP layout Building B RIBA 3 N/A 06/12/2022 N/A 06/12/2022 26/12/2022 22/12/2022 16/01/2023 A/B 16/01/2023 A/B 16/01/2023 A/B All plans received 06/12/2022
MEP Sprinkler riser Building A + B RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 06/01/2023 B 04/01/2023 B 04/01/2023 B
MEP Sprinkler riser Building A +B RIBA 4 N/A 12/06/2023 N/A 12/06/2023 30/06/2023 28/06/2023 20/06/2023 A 16/08/2023 A 16/08/2023 A
MEP Sprinkler Riser Building A & B RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 21/12/2023 A 21/12/2023 A 21/12/2023 A
MEP Sprinkler Schematic Layout RIBA 3 N/A 20/02/2023 N/A 21/02/2023 13/03/2023 09/03/2023 29/06/2023 B 29/06/2023 B 29/06/2023 B
MEP Sprinkler Schematic Layout Site Wide RIBA 4 N/A 06/04/2023 N/A 06/04/2023 26/04/2023 24/04/2023 24/04/2023 B 02/05/2023 B 02/05/2023 B
MEP
MEP Sprinkler Tanks Technical Submittal RIBA 4 N/A 14/06/2023 N/A 14/06/2023 04/07/2023 30/06/2023 30/06/2023 A/B 30/06/2023 A/B 30/06/2023
MEP
MEP
package review schedule Project Honey 07/05/2024 issue date discipline package description design stage planned release date (programme dated xxxx) actual release date delta all developer occupier/ fund date received status given date received status given date received status given comments comments received/ status given developer occupier fund response required by MEP Mechanical plantroom schematic Building B RIBA 3 18/11/2022 05/12/2022 -11 days 05/12/2022 23/12/2022 21/12/2022 05/12/2022 B Awaiting comments from occupier and fund. MEP Mechanical riser Building B RIBA 3 N/A 18/11/2022 N/A 18/11/2022 08/12/2022 06/12/2022 Awaiting comments. MEP Mechanical riser Building A RIBA 3 N/A 03/11/2022 N/A 03/11/2022 23/11/2022 21/11/2022 24/11/2022 B 24/11/2022 B 24/11/2022 B All plans received 03/11/2022 MEP Network schematic Building A, B & C RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 19/12/2023 C 19/12/2023 C 19/12/2023 C Status C received. MEP Network schematic Building A + B RIBA 3 N/A 05/12/2022 N/A 05/12/2022 23/12/2022 21/12/2022 08/12/2022 C C C Status C received. MEP Network schematic Building A, B & C RIBA 4 N/A 02/05/2023 N/A 02/05/2023 22/05/2023 18/05/2023 24/05/2023 B 19/05/2023 B 19/05/2023 B MEP Office and ancillary ventilation schematics Building A + B RIBA 3 01/11/2022 03/11/2022 0 days 03/11/2022 23/11/2022 21/11/2022 21/11/2022 B 21/11/2022 B 21/11/2022 B All plans received 03/11/2022
Office WC Ventilation Schematic Building B RIBA 3
05/12/2022 B awaiting response from occupier and fund. MEP Office WC Ventilation Schematic Building A + B RIBA 4 N/A 31/08/2023 N/A 31/08/2023 20/09/2023 18/09/2023 27/09/2023 C 24/09/2023 C 24/09/2023 C awaiting response from occupier and fund. MEP OTIS technical drawings Building A RIBA 3 N/A 28/11/2022 N/A 28/11/2022 16/12/2022 14/12/2022 19/12/2022 A/B 19/12/2022 A/B 19/12/2022 A/B MEP Piped services layouts Building A & B RIBA 5 N/A 13/03/2024 N/A 13/03/2024 02/04/2024 29/03/2024 14/03/2024 B 08/04/2024 B 08/04/2024 B Status C given on Building A 6th,8th floor layouts. MEP Piped services layouts Building A + B RIBA 3 N/A 25/11/2022 N/A 25/11/2022 15/12/2022 13/12/2022 18/01/2023 B 18/01/2023 B 18/01/2023 B Building B 6th Floor Piped services layout received status C. MEP Piped Services Layouts Building B RIBA 4 N/A 14/04/2023 N/A 14/04/2023 04/05/2023 12/05/2023 10/05/2023 C 10/05/2023 C 10/05/2023 C The following floors received status B - 7th Floor - 8th Floor - 10th Floor MEP Plantroom Layout Building A RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 19/01/2023 C 19/01/2023 C 19/01/2023 C
Plantroom Layout Ground Floor C RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 Awaiting comments
MEP
N/A 11/11/2022 N/A 11/11/2022 01/12/2022 29/11/2022
MEP
Plantroom Layout Building A RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 18/01/2023 C 18/01/2023 C 18/01/2023 C
Generator Controls Schematic RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 19/12/2023 B 19/12/2023 B 19/12/2023 B
B
B
B
06/12/2023
20/12/2023
20/12/2023
Small power layout Building A RIBA 5 N/A 04/03/2024 N/A 04/03/2024 22/03/2024 20/03/2024
& B
5
21/12/2023 A/B 21/12/2023
RIBA
N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023
A/B 21/12/2023 A/B
Sprinkler system System Design RIBA 3 02/11/2022 03/11/2022 0 days 03/11/2022 23/11/2022 21/11/2022 All plans received 03/11/2022
A/B
MEP Stage 4 Design Report MEP Stage 4 Report RIBA 4 N/A 15/03/2023 N/A 15/03/2023 04/04/2023 31/03/2023 29/08/2023 C 29/08/2023 C 29/08/2023 C
Substation Earthing RAMS RIBA 3 N/A 03/11/2022 N/A 03/11/2022 23/11/2022 21/11/2022 30/01/2023 B Removed from CMT Workflow.
MEP Tech subs MEP Tech Subs RIBA 4 N/A 01/08/2023 N/A 01/08/2023 21/08/2023 17/08/2023 20/09/2023 B 20/09/2023 B 20/09/2023 B
Underground GRP Storage Tank With Granula Infill/TF4 Filter RIBA 3 N/A 15/12/2022 N/A 15/12/2022 12/01/2023 10/01/2023 Given status A by MCLH on 22/02/2023. MEP Valves Site wide RIBA 4 N/A 28/03/2023 N/A 28/03/2023 17/04/2023 13/04/2023 20/06/2023 A/B 06/06/2023 A/B 20/06/2023
Building A
B RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 20/12/2023 B 07/01/2023 B 07/01/2023 B Received all plans. MEP Ventilation Building C RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024 15/02/2024 A 15/02/2024 A 15/02/2024 A MEP Ventilation Layout Building A RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 06/01/2023 B 06/01/2023 B 06/01/2023 B Received all plans. MEP Ventilation Layout Building B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 06/01/2023 B 06/01/2023 B 06/01/2023 B Awaiting Occupier and Fund comments. MEP Ventilation layout Building C RIBA 4 N/A 06/04/2023 N/A 06/04/2023 26/04/2023 24/04/2023 14/06/2023 B 09/06/2023 B 14/06/2023 B MEP Ventilation layouts Building B RIBA 3 N/A 20/12/2022 N/A 20/12/2022 19/01/2023 17/01/2023 06/01/2023 B 19/01/2023 B 06/01/2023 B MEP Ventilation systems Calculations RIBA 3 10/10/2022 25/09/2022 -10 days 25/09/2022 13/10/2022 11/10/2022 24/10/2022 B 24/10/2022 B 24/10/2022 B All plans received 25/09/2022 https://francishunter-my.sharepoint.com/personal/kyra_bosompem_francishunter_co_uk/Documents/Documents/Project Honey/Package Review Schedule/Project Honey Package Review Schedule 231120
A/B MEP Ventilation
&
MEP
MEP
MEP
MEP Plantroom Schematic Building C RIBA 3 N/A 20/12/2022 N/A 20/12/2022 17/01/2023 13/01/2023 07/02/2023 B 10/02/2023 B 07/02/2023 B
MEP Site Utilities Incoming Services Plans RIBA 4 N/A 14/04/2023 N/A 14/04/2023 04/05/2023 02/05/2023 23/05/2023 C 23/05/2023 C 23/05/2023 C
Structural Basement waterproofing system Basement waterproofing system RIBA 4 N/A 30/11/2022 N/A 05/12/2022 23/12/2022 21/12/2022 Not issued for
Structural
Structural Cast - In Channel Technical Submittal RIBA 3 N/A Not issued for review.
Structural Civils (tbc) Attenuation (CPD) RIBA 4 21/12/2022
Structural Core Plans Building A & B RIBA 4 N/A 27/02/2023 N/A 27/02/2023 17/03/2023 15/03/2023 12/05/2023 A 12/05/2023 A 12/05/2023 A
Structural First Floor GA Building B RIBA 4 N/A 16/12/2022 N/A 16/12/2022 13/01/2023 11/01/2023 MCLH closed out as status A ON 03/02/2023.
Structural GA's Building A & B RIBA 4 N/A 30/11/2022 N/A 30/11/2022 20/12/2022 16/12/2022
Structural GA's Building C RIBA 3 N/A 07/12/2022 N/A 07/12/2022 04/01/2023 23/12/2022 15/12/2022 A/B 15/12/2022 A/B 15/12/2022 A/B
Structural General Arrangement Plan Foundations RIBA 4 N/A 13/02/2023 N/A 13/02/2023 03/03/2023 01/03/2023
Structural General arrangements Building A+ B RIBA 4 N/A 26/09/2022 N/A 26/09/2022 14/10/2022 12/10/2022 13/01/2023 A 13/01/2023 A 13/01/2023 A All plans received. Awaiting comments for building B - first floor GA.
Structural Glass Balustrade Technical Submittal RIBA 4 N/A 11/04/2023 N/A 11/04/2023 01/05/2023 27/04/2023 11/05/2023 B 11/05/2023 B 11/05/2023 B
Structural Glass Technical Report Technical Submittal RIBA 4 N/A 06/04/2023 N/A 06/04/2023 26/04/2023 24/04/2023 25/04/2023 C 25/04/2023 C 25/04/2023 C MCLH delivery team and review - status C given.
Structural Grd Floor and L06 Link Bridge Grd Floor and L06 Link Bridge RIBA 4 29/11/2022 14/01/2023 N/A 14/01/2023 02/02/2023 31/01/2023 06/02/2023 B
Structural Ground Floor Building B RIBA 4 04/11/2022 Not issued for review.
Structural Loading plans Loading plans RIBA 4 02/11/2022 02/11/2022 0 days 02/11/2022 22/11/2022 18/11/2022 31/10/2022 B 31/10/2022 B 31/10/2022 B
20/10/2022 18/10/2022 19/10/2022 A/B 19/10/2022 A/B 19/10/2022 A/B All plans received 30/09/2022
Structural Pile caps Pile Caps C RIBA 4 23/09/2022 Not issued for review.
Structural Piling Piling A + B RIBA 4 11/08/2022 09/08/2022 -2 days 09/08/2022 30/08/2022 25/08/2022 25/08/2022 A/B
A/B 25/08/2022 A/B All plans received on 09/08/2022
Structural Piling Concrete mix design RIBA 4 N/A 09/09/2022 N/A 09/09/2022 29/09/2022 27/09/2022 24/09/2022 A 24/09/2022 A 24/09/2022 A All plans received on 09/09/2022
Structural Piling Piling C RIBA 4 27/09/2022 07/12/2022 51 days 07/12/2022 05/01/2023 03/01/2023 16/12/2022 A 16/12/2022 A 16/12/2022 A
Structural Plant Steel frame Building A RIBA 4 15/03/2023
Structural Siderise CW-FS120 Technical Submittal RIBA 4 N/A 27/02/2023 N/A
Structural Specialist CDP Design (FP McCann) Specialist CDP Design (FP McCann) RIBA 4 13/10/2022
Structural Superstructure PT Floors (CPD) Building A RIBA 4 09/11/2022
Structural Superstructure PT Floors (CPD) Building B RIBA 4 09/11/2022
Not issued for review.
Structural Test piling Results and proposal RIBA 4 N/A 25/09/2022 N/A 25/09/2022 13/10/2022 11/10/2022 13/10/2022 A 13/10/2022 A 13/10/2022 A All plans received 25/09/2022
Structural Town Hall Building A RIBA 4 N/A 03/04/2023 N/A 03/04/2023 21/04/2023 19/04/2023 05/04/2023 A 05/04/2023 A 05/04/2023 A
Structural Walls and Columns inc Stairs Building A RIBA 4 20/10/2022
Structural Walls and Columns inc Stairs Building B RIBA 4 21/10/2022
Structural Wicona EL Evo Technical Submittal RIBA 4 N/A 23/01/2023 N/A 23/01/2023 10/02/2023 08/02/2023 01/02/2023 B Received EOC comments on 01/02/2023.
Structural Wind calculations Wind calculations RIBA 4 TBC 01/02/2023 N/A 01/02/2023 21/02/2023 17/02/2023
Structural Ash and Lacy Mechslip Brickslip Technical Submittal RIBA 4 N/A 09/03/2023 N/A 09/03/2023 29/03/2023 27/03/2023 24/05/2023 B 24/05/2023 B 24/05/2023 B
Structural Benchmark Approval Form Rectangular Columns RIBA 5 N/A 08/02/2023 N/A 08/02/2023 28/02/2023 24/02/2023 17/03/2023 B 20/03/2023 B 20/03/2023 B
Structural Kilsaran Inspection and Test Plan Test Plan RIBA 4 N/A 20/02/2023 N/A 20/02/2023 10/03/2023 08/03/2023 Not issued for review.
Structural Loading Plan Building C level 00 RIBA 4 N/A 22/03/2023 N/A 22/03/2023 11/04/2023 07/04/2023 24/04/2023 A 24/04/2023 A 24/04/2023 A
Structural Performance mark ups Building A & B RIBA 4 N/A 13/01/2023 N/A 13/01/2023 02/02/2023 31/01/2023 18/01/2023 B 01/02/2023 B 01/02/2023 B Received comments from EOC on 18/01/2023.
package review schedule Project Honey 07/05/2024 issue date discipline package description design stage planned release date (programme dated xxxx) actual release date delta all developer occupier/ fund date received status given date received status given date received status given comments comments received/ status given developer occupier fund response required by MEP Wet Alarm Valve Set Technical Submittal RIBA 4 N/A 17/04/2023 N/A 17/04/2023 05/05/2023 03/05/2023 24/04/2023 B 24/04/2023 B 24/04/2023 B MEP Zonecheck Technical Submittal RIBA 4 N/A 04/04/2023 N/A 04/04/2023 24/04/2023 20/04/2023 11/04/2023 A 02/05/2023 A 02/05/2023 A MEP Electrical riser Building A RIBA 5 N/A 04/03/2024 N/A 04/03/2024 22/03/2024 20/03/2024 20/03/2024 B 13/03/2024 B 20/03/2024 B MEP Office Floor Ventilation Distribution Schematic Building A RIBA 5 N/A 06/02/2024 N/A 06/02/2024 26/02/2024 22/02/2024 12/02/2024 B 05/03/2024 B 05/03/2024 B MEP Containment Layouts Building C RIBA 5 N/A 05/12/2023 N/A 05/12/2023 25/12/2023 21/12/2023 19/12/2023 B 21/12/2023 B 21/12/2023 B MEP External Louvres Schedule RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024
Tech subs MEP Tech Subs RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024 14/02/2024 A/B 14/02/2024 A/B 14/02/2024 A/B
Domestic Services Building A &B RIBA 5 N/A 15/01/2024 N/A 15/01/2024 02/02/2024 31/01/2024 21/02/2024 B 21/02/2024 B 21/02/2024
MEP
MEP
B
A Status B given on Building A 7th floor drainage layout.
Dry Riser Schematic Layout Building C RIBA 4
28/06/2023 20/06/2023 B
Drainage Layout Building A & B RIBA 5 N/A 13/03/2024 N/A 13/03/2024 02/04/2024 29/03/2024 19/03/2024 A 19/03/2024 A 19/03/2024
MEP
N/A 12/06/2023 N/A 12/06/2023 30/06/2023
16/08/2023 A/B
C 19/12/2023 C 19/12/2023 C
Earthing Schematic Building A, B & C RIBA 5 N/A 14/11/2023 N/A 14/11/2023 04/12/2023 30/11/2023 19/12/2023
Initiation Board Technical Submittal RIBA 4
30/08/2023 30/08/2023
N/A 14/08/2023 N/A 14/08/2023 01/09/2023
A 30/08/2023 A 30/08/2023 A
review.
Car park GA's and sections Car park GA's and sections RIBA 4 N/A 10/11/2022 N/A 10/11/2022 30/11/2022 28/11/2022 All plans received 10/11/2022
06/02/2023 B 06/02/2023 B
All plans received 02/11/2022
Lower Ground floor Lower Ground Floor C RIBA 4 20/10/2022
Pile and core Caps Pile and core - caps A + B RIBA 4 23/09/2022 30/09/2022 7 days 30/09/2022
Structural
Structural
25/08/2022
27/02/2023 17/03/2023 15/03/2023
https://francishunter-my.sharepoint.com/personal/kyra_bosompem_francishunter_co_uk/Documents/Documents/Project Honey/Package Review Schedule/Project Honey Package Review Schedule 231120
McLH procurement schedule
FH090-151015 appendix m
McLaughlin & Harvey Ltd Y Procurement Schedule Doc Ref: BO/3-2940 5412 - Project Honey 09 May 2024 Key: Order Complete Procured By Package Subcontractor / Supplier (Potential) Latest Award Date Lead In Period inc. Design (wks) Start On Site Date LOI Issued (Y/N) Order Placed (Y/N) Order Date Status Monitor (wks) Final Clean TBC 25/04/2024 4 23/05/24 -2 Flood Grilles/Steelwork TBC 25/04/2024 4 23/05/24 -2 External Works/Landscaping TBC 11/05/2024 10 20/07/24 0 Decoration (excluding WC's) TBC 22/05/2024 2 05/06/24 2 Glazed Doors/Screens OWS 23/01/2024 12 16/04/24 Y ISSUED Service Yard Gte TBC 14/02/2024 12 08/05/24 Y ISSUED O & M Manuals Riddell 02/02/2024 4 01/03/24 Y ISSUED Air Test Air Leakage Testing 16/03/2024 4 13/04/24 Y ISSUED Raised Access Floors Kingspan 29/11/2023 10 07/02/24 Y ISSUED Lift Lobby Fire Curtains A1S Shutters 04/12/2023 8 29/01/24 Y ISSUED Feature Stair Fire Curtains Coopers 04/12/2023 8 29/01/24 Y ISSUED Commissioning Manager Ashford 27/10/2023 1 03/11/23 Y ISSUED Green Roof AYM 12/09/2023 12 05/12/23 Y ISSUED Roofing & Waterproofing AYM 12/09/2023 12 05/12/23 Y ISSUED Firestopping Middlesex 25/09/2023 6 06/11/23 Y ISSUED Fit-Out including WC's Swift Crafted 12/08/2023 21 06/01/24 Y ISSUED Partitions & Ceilings AT Jones 02/08/2023 5 06/09/23 Y ISSUED Structural Steel CMF Limited 24/08/2023 8 19/10/23 Y ISSUED Feature stair/Architectural Metalwork CMF Limited 22/07/2023 12 14/10/23 Y ISSUED Screeds UK Subfloors 27/07/2023 6 07/09/23 Y ISSUED Secondary Steel CMF Limited 19/08/2023 8 14/10/23 Y ISSUED Scaffolding Kitts 01/11/2023 4 26/06/23 Y ISSUED Sewer Connection Riney 10/07/2023 12 02/10/23 Y ISSUED Plant Screens Clarke Facades 12/06/2023 8 07/08/23 Y ISSUED Blockwork Swift 19/06/2023 8 14/08/23 Y ISSUED Facade Clarke Facades 17/10/2022 48 18/09/23 Y Y ISSUED Mansafe System PTSG 23/05/2023 15 05/09/23 Y Y ISSUED Roof Access Strategy PTSG 08/08/2023 4 05/09/23 Y Y ISSUED Temporary Electrics Trident 11/01/2023 15 26/04/23 Y ISSUED Sanitary Appliances Halsion 13/03/2023 15 26/06/23 Y ISSUED Lifts Otis 05/01/2023 35 07/09/23 Y ISSUED Hoists Reco 16/01/2023 16 08/05/23 Y ISSUED BREEAM Consultant Armila 06/11/2022 2 20/11/22 Y Y ISSUED Site Temps (Enabling) Wysepower 07/11/2022 1 14/11/22 Y ISSUED Building Control Sweco 13/11/2022 1 20/11/22 Y ISSUED Principal Designer Orsa/Ridge 06/11/2022 2 20/11/22 Y ISSUED Logistic Management & Security Avondale 24/10/2022 2 07/11/22 Y ISSUED Car Park - Structure FP McCann 28/11/2022 12 20/02/23 Y Y ISSUED Temporary Works AWD 26/09/2022 2 10/10/22 Y Y ISSUED Landscape Architect McIlwaine 03/10/2022 2 17/10/22 Y Y ISSUED Precast Stairs Mitchellson 04/01/2023 8 01/03/23 Y Y ISSUED GRP Grating Mitchellson 06/04/2023 21 31/08/23 Y ISSUED Ground Investigation Survey Geotech 12/09/2022 0 12/09/22 Y ISSUED M&E Installations Halsion 15/08/2022 45 26/06/23 Y Y ISSUED Acoustic Consultant Hann Tucker 05/09/2022 1 12/09/22 Y ISSUED Fire Consultant Marshall Fire 05/09/2022 1 12/09/22 Y ISSUED Groundworker & Frame Mitchellson 26/08/2022 6 07/10/22 Y ISSUED Biometrics M Site 29/08/2022 2 12/09/22 Y ISSUED Piling Van Elle 22/08/2022 3 12/09/22 Y ISSUED Surveys SES 29/08/2022 2 12/09/22 Y ISSUED Architect Darlings 11/02/2022 2 25/02/22 Y ISSUED Structural & Civil Consultant Robert Bird 11/02/2022 2 25/02/22 Y ISSUED Hoarding (Alterations) Shorts 18/07/2022 3 08/08/22 Y ISSUED Site Accomodation; including Electrics Avondale 18/07/2022 3 08/08/22 Y ISSUED Hoarding License Council 12/09/2022 0 12/09/22 Y ISSUED Buildings A and B Page 1 of 1 09/05/2024
Contract:
Building C - MSCP
5412 - Project Honey 01 May 2024 Key: Order Complete Package Subcontractor Supplier (Potential) Design Responsibility (Y/N) Go To Tender Tender Period (wks) Latest Award Date Lead In Period inc. Design (wks) Start On Site Date LOI Issued (Y/N) Order Placed (Y/N) Order Date Status Monitor (wks) Comments Status Waterproofing - Above Changing Village 4M Floors N 22/03/2024 6 03/05/2024 8 28/06/24 0 Finalising sub-contractor appointment Resin Flooring & Line Marking 4M Floors N 22/03/2024 6 03/05/2024 8 28/06/24 0 Finalising sub-contractor appointment Cycle Storage Turvec Y 08/04/2024 6 20/05/2024 12 12/08/24 3 Finalising sub-contractor appointment Final Clean TBC N 23/05/2024 6 04/07/2024 4 01/08/24 9 External Doors/Louvres Clarke Facades Y 26/02/2024 6 08/04/2024 12 01/07/24 Y ISSUED Roof Landscaping Frost Landscapes Y 10/12/2023 8 04/02/2024 14 12/05/24 Y ISSUED Fit Out (including Changing Rooms ) Original Joinery Y 03/10/2023 6 14/11/2023 8 09/01/24 Y ISSUED Architectural Metalwork CMF Y 19/10/2023 6 30/11/2023 8 25/01/24 Y ISSUED Brickwork Swift N 02/10/2023 6 13/11/2023 20 01/04/24 Y ISSUED GRP Grating Dura N 06/09/2023 6 18/10/2023 6 29/11/23 Y ISSUED Firestopping Middlesex N 03/10/2023 6 14/11/2023 8 09/01/24 Y ISSUED Roofing & Waterproofing AYM Y 10/08/2023 8 05/10/2023 12 28/12/23 Y ISSUED Blockwork Swift Block N 03/08/2023 4 31/08/2023 4 28/09/23 Y ISSUED Screeds TBC N 09/08/2023 6 20/09/2023 10 29/11/23 Y ISSUED Perforated Façade Envelope Maple Y 30/05/2023 6 11/07/2023 20 28/11/23 Y Y ISSUED MEP Halsion Y 01/06/2023 6 13/07/2023 15 26/10/23 Y ISSUED Lifts Otis Y 19/09/2023 6 31/10/2023 35 02/07/24 Y Y ISSUED Car Park - Superstructure FP McCann Y 24/04/2023 6 05/06/2023 6 17/07/23 Y Y ISSUED
Page 1 of 1 01/05/2024
Schedule Date: Procurement Schedule
FH090-151015 appendix n
McLH programme
09/11/22A 10/11/22A 09/11/22A 13/01/23A 02/06/23A 27/07/23A 03/02/23A 08/04/24 12/09/22A 19/09/22A 03/10/22A 21/10/24 21/10/24 24/10/22A 10/10/22A 16/02/23A 10/02/23A 09/03/23A 02/02/23A 02/02/23A 28/06/23A 27/11/23A 31/10/23A 07/11/23A 15/11/23A 02/10/23A 13/12/23A 06/10/23A 13/09/24 27/06/24 06/10/23A 06/10/23A
CONTRACTOR PROGRAMME DESCRIPTION: PROJECTHONEY - Construction Progress - 17/04/24 - Jagged Line Summary CLIENT STATUS CODE: FILE NAME: EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.00 - Client Issue PROGRAMME REFERENCE: 5412-C03 LAST ACCEPTED PROG: ISSUE/REVISION DATE: 22/03/2024 REVISION COMMENT: S2 - For Information NATIVE FILE REFERENCE:-S:\Planning\_1 workspace\Project Honey 2021\Programmes\Project Honey Progress 170424\EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.03 - progress 170424 Jagged.pp PROGRAMME STATUS: C03.03 Print Date: 19/04/2024 12:18:09 Page 1 of 2 REVISION AUTHOR: JP/SL PROGRAMME VIEW: working LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete 2023 2022 2024 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43 44 45 46 47 48 49 50 51 52 53 54 55 56 57 58 59 60 61 62 63 64 65 66 67 68 69 70 71 72 73 74 75 76 77 78 79 80 81 82 83 84 85 86 87 88 89 90 91 92 93 94 95 96 97 Pre-Construction,Mobilisation,Co-ordinatedDesign ContractSignature DefermentPeriod McLHLongstopDate MainContractorMobilisation DateofPossession Section1Completion Section2Completion ProvisonalSums(latestinstructiondate) Stage4DesignCommence PlanningConditionDischarge ExistingMSCPDemolition Stat.Consents MainContractorMobilisation MainAccommodation(off-site) StartonSite(BuildingAPossession) OverallSummaryBar ProjectHoneyConstructionProgramme StartonSite SiteWideUtilities(tbc) Cranage ExcavationsandPrep CompletionofDraiangeAheadofTCInstall SurfaceWaterandAttenuationTank FoulWater ApplicationstoThamesWater ConnectionsIntoExistingThamesWater IncomingServices/Ducting Hoists OriginalStartonSite DeferementofDateofPossession(1) TownHallInstructionEAI011(newbaselinedate) Section02BuildingAandBuildingC TheHoneyBuilding(BuildingA)(Grd,1st-8th,Roof) Bearing/FoundationPiling MitchellsonsStartasperDeferementProgramme Sub-Structures MezzanineArea MezzFloorComplete GroundFloorUpstands InsituColumnsGround1st LGFandGFWorks(installfrombelowlevel1) UpperFloorstoRoofLevel FRCCOREWALLOVERRUNS FRCCAPPINGSLABTOCORE FRCPERIMETERPARAPETWALLS Pre-CastStairInstallationsB1-L9Roof BlockAStrikeandClear FacadeMobilisation BuildingEnvelopeWorks ABlockInstallation SFS SlabEdgeBrackets GfLevel01 Level2 Level3 Level4 Level5 Level6 Level7 Level6LinkBridge Level8 Level9/Roof GF1Floor ReceptionLink GRCCladding BrickCladding/Screens/Balustrades Cappings HoistInfillstoBuildingA FinishingWorks RoofWorks Level09 TerraceLevel08 TerraceLevel06 PlantAreaLevel08 BriseSoleiltoRoofLevel InfillsfollowingRemovalofHoist1 TemporaryWeatheringtoUpperFloorsfrom6thFloorto CommenceStage1Finishes OriginalCoreDate C01CoreDate C02CoreDate CoreSubstantiallyWeathertighttoCommenceFitOut BuildingProgressivelySubstantiallyWeathertighttoCommence Stage2Finishes LinkBridgeCompleteandAccess(1)Closed LiftInstallationsBuildingA WeatheringtoLiftShafts/Cores TemporaryPower/LightingtoLiftShafts Strip/CleanLiftShafts OTISInstallationsBuildingA BBUlinktohoist BBUDurationfor00-L07and00-L06 Re-InstatementsandTestingandCommissioning HandoverandCompletion BuildingServices InternalFinishesNEW MEPMezzanineFit-Out FirstFloor(EastShellandCore+RAFWestCATA) 23w1d 8w 8w 65w1d 26w2d 15w2d 16w 11w 14w 103w1d 103w1d 41w4d 75w 4w 1w3d 10w1d 2w 4w 33w3d 102w1d 102w1d 5w 15w4d 5w 3w 1w 7w 44w1d 1w1d 1w 3w1d 23w4d 4w 4w3d 48w3d 37w3d 2w3d 2w3d 1w2d 5w2d 5w2d 5w2d 5w2d 5w2d 5w2d 3w3d 11w1d 3w4d 14w3d 8w3d 21w3d 16w2d 4w 1w 15w3d 26w2d 12w 23w2d 12w1d 23w4d 6w 3w 46w4d 1w4d 7w 7w 36w2d 20w2d 4w 55w2d 54w1d 6w 42w4d 06/09/21A 17/05/22A 18/05/22A 14/07/22A 15/07/22A 20/09/22A 05/08/24 21/10/24 20/06/22A 30/05/22A 18/05/22A 14/06/22A 01/07/22A 17/06/22A 15/07/22A 20/09/22A 12/09/22A 12/09/22A 20/09/22A 14/02/23A 10/10/22A 13/10/22A 10/11/22A 31/10/22A 21/10/22A 02/06/23A 14/07/23A 09/01/23A 31/07/23A 12/09/22A 19/09/22A 03/10/22A 20/09/22A 20/09/22A 20/09/22A 10/10/22A 17/10/22A 04/01/23A 09/03/23A 13/01/23A 27/01/23A 10/05/23A 09/01/23A 24/10/23A 01/11/23A 25/10/23A 06/04/23A 16/11/23A 06/09/23A 20/09/23A 20/09/23A 20/09/23A 20/09/23A 09/10/23A 11/10/23A 03/11/23A 28/11/23A 21/12/23A 29/01/24A 21/02/24A 22/03/24 12/03/24A 16/04/24 26/02/24A 26/04/24 27/03/24 19/04/24 29/07/24* 23/04/24 28/05/24* 07/11/23A 07/11/23A 28/11/23A 28/02/24A 16/11/23A 16/11/23 15/01/24 18/08/23A 13/09/23A 21/09/23A 05/10/23A 08/11/23A 28/02/24 26/04/24 06/11/23A 06/11/23A 06/11/23A 13/11/23A 31/01/24A 22/04/24 22/04/24 16/09/24 11/10/24 04/09/23A 18/09/23A 22/03/24A 18/09/23A 28/02/22A 17/05/22A 14/07/22A 14/07/22A 09/09/22A 20/09/22A 05/08/24* 21/10/24* 18/10/23 30/05/22A 23/11/22A 30/09/22A 24/10/22A 02/09/22A 24/10/22A 20/09/22A 21/10/24 21/10/24
05/03/24
30/08/24 14/08/24 23/08/24 29/04/24 13/09/24 28/05/24 12/02/24 28/05/24 28/05/24 17/05/24 10/01/24 02/02/24 18/08/23A 13/09/23A 21/09/23A 05/10/23A 08/11/23A 28/02/24 26/04/24 17/10/24 16/11/23A 22/12/23A 12/01/24A 17/10/24 22/04/24 13/09/24 11/10/24 11/10/24 15/10/24 21/10/24 07/05/24 31/07/24 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 66% 66% 100% 100% 99% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 57% 57% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 41% 65% 100% 100% 100% 100% 100% 100% 100% 100% 100% 87% 54% 8% 57% 18% 73% 100% 74% 66% 42% 100% 100% 100% 100% 100% 100% 100% 100% 31% 100% 100% 100% 26% 71% 46% 44% 83% 100% 100% 100% 100% 100% 100% 70% 100% 100% 100% 100% 100% 100% 100% 52% 52% 100% 93% 91% 100% 100% 100% 100% 100% 100% 100% 58% 100% 100% 100% 48% 48% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 15% 24% 100% 100% 100% 82% 55% 38% 21% 19% 19% 8% 10% 46% 80% 53% 21% 42% 100% 100% 100% 100% 100% 39% 100% 100% 100% 38% 55% 40% 10% 56% 2ContractSignature 3DefermentPeriod 4McLHLongstopDate 5MainContractorMobilisation 6DateofPossession 7Section1Completion Section2Completion 9 ProvisonalSums(latestinstructiondate) 10StageDesignCommence 11 PlanningConditionDischarge 12 ExistingMSCPDemolition 13 Stat.Consents 14MainContractorMobilisation 15 MainAccommodation(off-site) 16StartonSite(BuildingAPossession) 17 OverallSummaryBar 18 ProjectHoneyConstructionProgramme 19StartonSite SiteWideUtilities(tbc) 21 Cranage 22ExcavationsandPrep 23CompletionofDraiangeAheadofTCInstall 24SurfaceWaterandAttenuationTank 25FoulWater 26ApplicationstoThamesWater 27ConnectionsIntoExistingThamesWater 28IncomingServices/Ducting 30OriginalStartonSite 31DeferementofDateofPossession(1) 32TownHallInstructionEAI011(newbaselinedate) 33 Section02BuildingAandBuildingC 34 TheHoneyBuilding(BuildingA)(Grd, 35Bearing/FoundationPiling 36MitchellsonsStartasperDeferementProgramme 37 Sub-Structures 38MezzanineArea 39MezzFloorComplete 40GroundFloorUpstands 41InsituColumnsGround1st 42LGFandGFWorks(installfrombelowlevel1) 43 UpperFloorstoRoofLevel 44FRCCOREWALLOVERRUNS 45FRCCAPPINGSLABTOCORE 46FRCPERIMETERPARAPETWALLS 47 Pre-CastStairInstallationsB1-L9Roof BlockAStrikeandClear 49FacadeMobilisation 50 BuildingEnvelopeWorks 51 ABlockInstallation 52SFS 53SlabEdgeBrackets 54GfLevel01 55Level2 56Level3 57Level4 58Level5 59Level6 60Level7 61Level6LinkBridge 62Level8 63Level9/Roof 64 GF1Floor 65ReceptionLink 66 GRCCladding 67 BrickCladding/Screens/Balustrades 68Cappings 69HoistInfillstoBuildingA 70 FinishingWorks 71 RoofWorks 72Level09 73 TerraceLevel08 74TerraceLevel06 75 PlantAreaLevel08 76BriseSoleiltoRoofLevel 77InfillsfollowingRemovalofHoist1 78TemporaryWeatheringtoUpperFloorsfrom6thFloortoCommenceStage1Finishes 79OriginalCoreDate 80C01CoreDate 81C02CoreDate 82CoreSubstantiallyWeathertighttoCommenceFitOut 83BuildingProgressivelySubstantiallyWeathertighttoCommenceStage2Finishes 84LinkBridgeCompleteandAccess(1)Closed 85 LiftInstallationsBuildingA 86WeatheringtoLiftShafts/Cores 87TemporaryPower/LightingtoLiftShafts 88Strip/CleanLiftShafts 89 OTISInstallationsBuildingA BBUlinktohoist 91 BBUDurationfor00-L07and00-L06 92Re-InstatementsandTestingandCommissioning 93HandoverandCompletion 94 BuildingServices 95 InternalFinishesNEW 96MEPMezzanineFit-Out 97 FirstFloor(EastShellandCore+RAF/WestCATA) + + + + + + ++ + + + + ++ + + + + ++ ++ + + ++ ++ ++ ++ ++ ++ ++ ++ ++ ++ + + + + ++ + + ++ + + ++ + + 6w LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 2023 2022 2024
20/09/22A 15/12/23 29/04/24
17/10/23A 16/11/23 11/12/23 17/01/24 09/02/24
28/03/24 18/04/24 03/06/24 13/05/24 11/06/24 27/06/24
CONTRACTOR PROGRAMME DESCRIPTION: PROJECTHONEY - Construction Progress - 17/04/24 - Jagged Line Summary CLIENT STATUS CODE: FILE NAME: EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.00 - Client Issue PROGRAMME REFERENCE: 5412-C03 LAST ACCEPTED PROG: ISSUE/REVISION DATE: 22/03/2024 REVISION COMMENT: S2 - For Information NATIVE FILE REFERENCE:-S:\Planning\_1 workspace\Project Honey 2021\Programmes\Project Honey Progress 170424\EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.03 - progress 170424 Jagged.pp PROGRAMME STATUS: C03.03 Print Date: 19/04/2024 12:18:12 Page 2 of 2 REVISION AUTHOR: JP/SL PROGRAMME VIEW: working LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete 2023 2022 2024 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 98 99 100 101 102 103 104 105 106 107 108 109 110 111 112 113 114 115 116 117 118 119 120 121 122 123 124 125 126 127 128 129 130 131 132 133 134 135 136 137 138 139 140 141 142 143 144 145 146 147 148 149 150 151 152 153 154 155 156 157 158 159 160 161 162 163 164 165 166 167 168 169 170 171 172 173 174 175 176 177 178 179 180 181 182 183 184 185 186 187 188 189 190 191 192 193 SecondFloor(CATA) ThirdFloor(CATA) FourthFloor(CATA) FifthFloor(WestShellandCore+RAFEastCATA) SixthFloor(ShellandCore+RAF) SeventhFloor(ShellandCore+RAF) EighthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) CompletionofFit-OutfollowingRemovalofHoist1 StairsandLobbies CompletionActivities TargetEarlyAccessDates FirstFloor(EastShellandCore+RAFWestCATA) SecondFloor(CATA) ThirdFloor(CATA) FourthFloor(CATA) FifthFloor(WestShellandCore+RAFEastCATA) SixthFloor(ShellandCore+RAF) SeventhFloor(ShellandCore+RAF) EighthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) HandoverofTheHoney TheBee-keepers(CarPark)(indicativeProgramme) InstructionRequiredtoCompleteOutstandingClientWorks GasDiversionComplete(byothers)(tbc) OutstandingClientWorks(includingpilingmat,breakoutfootpath) InstructionRequiredtoCompleteOutstandingClientWorks GasDiversionComplete(byothers)(tbc) OutstandingClientWorks(includingpilingmat,breakoutfootpath) PlanningApprovalGrantedforBuildingC VanElleOriginalPilingDate VanElleActualStartonSiteDuetoPlanning EAI017RainwaterHarvestingTankDesignInstructionIssued EAI024RainwaterHarvestingTankProcurementInstructionIssued EAI038RainwaterHarvestingTankInstallInstructionIssued Bearing/FoundationPiling BLOCKCCARPARK Pre-CastSuperstructure BlockCEnvelope BlockCInternalFit-OutandBuildingServices HandoverofTheBeeKeepers OriginalStartonSite DefermentofBuildingBandBuildingCDateofPossession(2) Section01BuildingB TheHiveBuilding(BuildingB)(Grd,1st-10th,Roof) Bearing/FoundationPiling Sub-Structures Pre-CastGroundFloorSlab InstallPre-CastPlanks ScreedTopping(75mm) Superstructure BlockBStrikeandClear Upstands+PlinthsonRoof Pre-CastStairInstallationsB1-L9Roof LiftCoresCappedat11thFloorLevel FacadeMobilisation BuildingEnvelopeWorks RoofingWorks TerraceLevel10 RoofLevel CoreSubstantiallyWeathertighttoCommenceFitOut BuildingProgressivelySubstantiallyWeathertight LiftInstallationsBuildingB BuildingServices InternalFinishesNEW FirstFloor(ShellandCore+RAF) SecondFloor(ShellandCore+RAF) ThirdFloor(ShellandCore+RAF) FourthFloor(CATA) FifthFloor(CATA) SixthFloor(ShellandCore+RAF) SeventhFloor(CATA) EighthFloor(CATA) NinthFloor(ShellandCore+RAF) TenthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF)(instructedtostopworksonground floor21/03/24duetoclientchanges) ClearOutandCleanFloor ReceptionArea(Shell) RetailArea CompletionofFIt-OutfollowingRemovalofHoist2 StairsandLobbies CompletionActivities TargetEarlyAccessDates FirstFloor(ShellandCore+RAF) SecondFloor(ShellandCore+RAF) ThirdFloor(ShellandCore+RAF) FourthFloor(CATA) FifthFloor(CATA) SixthFloor(ShellandCore+RAF) SeventhFloor(CATA) EighthFloor(CATA) NinthFloor(ShellandCore+RAF) TenthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) HandoverofTheHive(BuildingB) LandscapingandPublicRealm 39w3d 38w3d 37w4d 37w3d 37w3d 35w3d 36w1d 36w3d 6w 32w1d 15w3d 8w 99w2d 1w 2w 1w 2w 3w3d 4w 8w3d 38w3d 23w2d 42w1d 88w3d 88w3d 3w3d 8w4d 5w 1w 1w 40w2d 2w 2w3d 20w4d 2w 37w 15w 12w 12w 44w1d 40w 47w1d 38w 33w2d 32w2d 31w3d 30w1d 29w1d 28w1d 27w1d 26w2d 25w2d 28w2d 4d 14w 14w 6w 17w 11w4d 10w 32w4d 02/10/23A 16/10/23A 30/10/23A 13/11/23A 27/11/23A 11/12/23A 08/01/24A 08/01/24A 12/06/24 16/02/24A 03/07/24 12/08/24 01/10/24 12/08/24 27/08/24 17/09/24 24/09/24 10/09/24 17/09/24 01/10/24 07/10/24 21/10/24 10/10/22A Week8A Week10A Week13A 07/11/22A 21/11/22A 12/12/22A 11/01/23A 10/10/22A 17/01/23A 31/10/22A 27/01/23A 10/03/23A 17/01/23A 20/02/23A 21/04/23A 29/11/23A 11/12/23A 21/10/24 12/09/22A 26/09/22A 10/10/22A 10/10/22A 10/10/22A 14/11/22A 19/04/23A 25/05/23A 30/06/23A 16/01/23A 07/11/23A 06/10/23A 26/04/23A 06/10/23A 29/08/23A 12/09/23A 04/10/23A 04/10/23A 25/10/23A 06/10/23A 09/01/24A 11/09/23A 29/09/23A 21/08/23A 21/08/23A 04/09/23A 18/09/23A 02/10/23A 16/10/23A 30/10/23A 13/11/23A 27/11/23A 11/12/23A 08/01/24A 08/01/24A 30/07/24 16/04/24 16/04/24 02/05/24 05/04/24A 14/05/24 13/05/24 09/07/24 13/05/24 20/05/24 18/06/24 02/07/24 11/06/24 02/07/24 23/07/24 09/07/24 16/07/24 23/07/24 05/08/24 28/02/24 23/07/24 30/07/24 07/08/24 20/08/24 04/09/24 04/09/24 23/09/24 25/09/24 23/07/24 04/10/24 21/10/24 07/10/24 01/10/24 12/08/24 27/08/24 17/09/24 24/09/24 10/09/24 17/09/24 01/10/24 07/10/24 21/10/24* 21/10/24 Week8A Week10A Week14A 07/11/22A 25/11/22A 23/12/22A 11/01/23A 02/11/22A 17/01/23A 31/10/22A 27/01/23A 10/03/23A 13/02/23A 27/04/23A 02/02/24A 29/05/24 21/10/24 21/10/24* 12/09/22A
05/08/24
02/11/22A
20/11/23A 24/10/23A 21/09/23A 06/10/23A 11/09/23A 14/06/24 30/01/24 09/01/24 30/01/24 06/10/23A
02/08/24 24/07/24 05/08/24 31/05/24 10/05/24 17/05/24 28/05/24 31/05/24 07/06/24 14/06/24 21/06/24 01/07/24 08/07/24 29/07/24 02/08/24 24/07/24 24/07/24 14/06/24 05/08/24 05/08/24 23/07/24 09/07/24 13/05/24 20/05/24 18/06/24 02/07/24 11/06/24 02/07/24 23/07/24 09/07/24 16/07/24 23/07/24 05/08/24* 21/10/24 77% 60% 56% 47% 41% 37% 34% 16% 1% 58% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 90% 30% 100% 100% 74% 74% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 90% 100% 100% 100% 100% 100% 86% 92% 60% 93% 93% 88% 88% 85% 52% 63% 55% 42% 38% 38% 1% 1% 5% 12% 56% 57% 50% 49% 41% 30% 20% 24% 3% 49% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 70% 20% 100% 100% 53% 53% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 32% 70% 71% 70% 100% 100% 35% 73% 44% 48% 59% 55% 59% 55% 45% 52% 50% 40% 35% 33% 2% 98 SecondFloor(CATA) 99 ThirdFloor(CATA) 100 FourthFloor(CATA) 101 FifthFloor(WestShellandCore+RAFEastCATA) 102 SixthFloor(ShellandCore+RAF) 103 SeventhFloor(ShellandCore+RAF) 104 EighthFloor(ShellandCore+RAF) 105 GroundFloor(ShellandCore+RAF) 106CompletionofFit-OutfollowingRemovalofHoist1 107 StairsandLobbies 108 CompletionActivities 109TargetEarlyAccessDates 110FirstFloor(EastShellandCore+RAFWestCAT 111SecondFloor(CATA) 112ThirdFloor(CATA) 113FourthFloor(CATA) 114FifthFloor(WestShellandCore+RAF/EastCAT 115SixthFloor(ShellandCore+RAF) 116SeventhFloor(ShellandCore+RAF) 117EighthFloor(ShellandCore+RAF) 118GroundFloor(ShellandCore+RAF) 119HandoverofTheHoney 120 TheBee-keepers(CarPark)(indicative 121InstructionRequiredtoCompleteOutstandingClientWorks 122GasDiversionComplete(byothers)(tbc) 123OutstandingClientWorks(includingpilingmat,breakoutfootpath) 124InstructionRequiredtoCompleteOutstandingClientWorks 125GasDiversionComplete(byothers)(tbc) 126OutstandingClientWorks(includingpilingmat,breakoutfootpath) 127PlanningApprovalGrantedforBuildingC 128VanElleOriginalPilingDate 129VanElleActualStartonSiteDuetoPlanning 130EAI017RainwaterHarvestingTankDesignInstructionIssued 131EAI024RainwaterHarvestingTankProcurementInstructionIssued 132EAI038RainwaterHarvestingTankInstallInstructionIssued 133Bearing/FoundationPiling 134BLOCKCCARPARK 135 Pre-CastSuperstructure 136 BlockCEnvelope 137 BlockCInternalFit-OutandBuildingServices 138HandoverofTheBeeKeepers 139OriginalStartonSite 140DefermentofBuildingBandBuildingCDateofPossession(2) 141 Section01BuildingB 142 TheHiveBuilding(BuildingB)(Grd,1st-10th,Roof) 143Bearing/FoundationPiling 144Sub-Structures 145Pre-CastGroundFloorSlab 146InstallPre-CastPlanks 147ScreedTopping(75mm) 148 Superstructure 149BlockBStrikeandClear 150Upstands+PlinthsonRoof 151 Pre-CastStairInstallationsB1-L9Roof 152LiftCoresCappedat11thFloorLevel 153FacadeMobilisation 154 BuildingEnvelopeWorks 155 RoofingWorks 156TerraceLevel10 157RoofLevel 158CoreSubstantiallyWeathertighttoCommenceFitOut 159BuildingProgressivelySubstantiallyWeathertight 160 LiftInstallationsBuildingB 161 BuildingServices 162 InternalFinishesNEW 163 FirstFloor(ShellandCore+RAF) 164 SecondFloor(ShellandCore+RAF) 165 ThirdFloor(ShellandCore+RAF) 166 FourthFloor(CATA) 167 FifthFloor(CATA) 168 SixthFloor(ShellandCore+RAF) 169 SeventhFloor(CATA) 170 EighthFloor(CATA) 171 NinthFloor(ShellandCore+RAF) 172 TenthFloor(ShellandCore+RAF) 173 GroundFloor(ShellandCore+RAF)(instructedtostopworksongroundfloor 174ClearOutandCleanFloor 175ReceptionArea(Shell) 176RetailArea 177CompletionofFIt-OutfollowingRemovalofHoist2 178 StairsandLobbies 179CompletionActivities 180TargetEarlyAccessDates 181FirstFloor(ShellandCore+RAF) 182SecondFloor(ShellandCore+RAF) 183ThirdFloor(ShellandCore+RAF) 184FourthFloor(CATA) 185FifthFloor(CATA) 186SixthFloor(ShellandCore+RAF) 187SeventhFloor(CATA) 188EighthFloor(CATA) 189NinthFloor(ShellandCore+RAF) 190TenthFloor(ShellandCore+RAF) 191GroundFloor(ShellandCore+RAF) 192HandoverofTheHive(BuildingB) 193 LandscapingandPublicRealm + + + + + + + + + + + + + + + + + + ++ + + + + ++ ++ + + ++ ++ + + + + + + + + + + + + + + + + + + + + + + 4w LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 2023 2022 2024
26/09/22A
05/08/24
26/01/23A 24/05/23A 01/06/23A 06/07/23A 06/11/23A
09/01/24A
Lautus progress report
FH090-151015 appendix
o
Planning Report
Project Honey
1 April 24
Project Honey
Total number of weeks
109751B5 August 24
2A21 October 24
2C21 October 24
Summary
Progress
Due to the poor performance of the installation of Utilised cladding the philosophy had been to complete two floors of cladding before finishes commence on the floor. This has been relaxed to complete a floor of cladding and then start finishes on that floor. This again was changed to carry out finishes to a floor independent to cladding installation leaving just the perimter works until the cladding is finished on a floor. This approach results in a higher risk of water damage but reduces the projection delays in completion.
A key link between the completion of utilised cladding on a floor and commencing the perimeter floor plate fit out is missing.
SectionBlockCompletion
Week Number
2 Block Present position Previous position + /A -5W 0D -6W 0D +1 B - 7W 0D -6W 0D -1 C - ½ W - ½ W 0

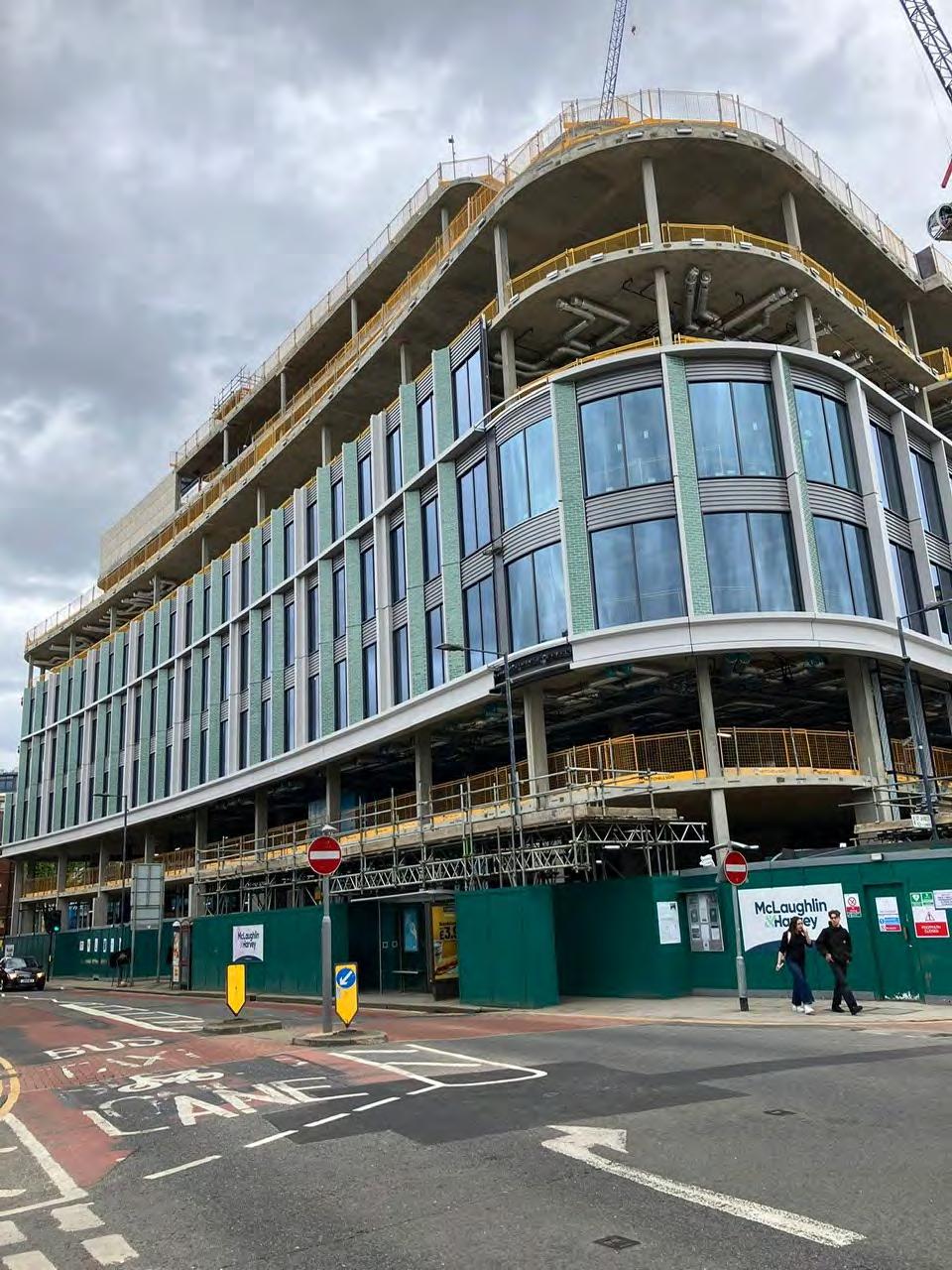

Building A - on site
Envelope
Cladding brackets installed to level 2,3 4 5 and 7.
Due to reported production issues, cladding works had ceased. Cladding re started on the 18th March 24 10 days later than the last report that had projected recommencement the 4 March 24.
Utilised Cladding now 16 weeks in delay.
There are continuing discussions underway on a revised programme of works.
Utilised panels have been installed under the link bridge in order that the installation of the link bridge can be carried out.
Roof
Roof works:
Level 9 insulation and the top layer membrane laid. This leaves completion of paving, handrails and mansafe.
Majority of Major Plant installed.
Roof finish originally planned to be complete by 12 February now projected completion 2 May 24.
Level 9 shows 11 weeks in delay.
Level 8 terrace roof works have commenced membrane 75% complete. Roof paving works on level 8 were due to be complete by 12 February 24 now projected completion 2 May 24.
Level 8 terrace shows 11 weeks in delay.
Level 8 plant area, roof membrane is 90%.
3
Level 8 plant area shows 8 weeks in delay.
Level 6 membrane 100%.
Finishes
Lift installation – Work commenced on 3 lifts L01, L07, and L05 which are running ahead of current programme. (Original planned for the 9 Oct 23 then 8 January 24). Lift 1 & 7 due to finish in three weeks. Lift 5 due to finish in 7 weeks.
Work to risers 75% complete.
Works to core delayed awaiting joinery delivery. 1st stage finishes to cores level 5 not started.
Building B- on site
Envelope
Original completion of the utilised cladding was the 10 April 24, not projected completion 10 July 24.
Cladding installation is running approximately 13 weeks late.
Due to production issues, supply of utilised cladding panels are being reported on a weekly basis.
Roof
Terrace level 10 roof finishes 80% complete. 14 weeks delay.
4
Roof Membrane , insualtion and top layer installed. Roof finishes not commenced. 13 weeks in delay.
Finishes Lift installation.
Work on L02 and LO3 underway LO2 complete in 3 weeks and LO3 complete in 6 weeks. 15 weeks late LO2 and 17 weeks late LO3.
There is a possible issue where the lift will not be available for beneficial access.
Dry riser installation 90% complete. 13 weeks late.
Level 2 4 weeks late
Level 3 3 weeks late
Level 4 5 weeks late.
Level 5 4 weeks late.
Level 6 4 weeks late
Level 7 3 ½ weeks late.
Level 8 2 ½ weeks late.
Finishes to Stairs 01 and 02 now running together rather than one at a time. This may cause access restrictions for labour and materials.
Building C- on site
Roof waterproofing 90 % complete. (originally due to be complete mid Oct 23) Cladding works projected completion 17 April 24.
Work progressing with fit out on the ground floor a critical area. M & E works commenced 18 March 24 3 weeks later than planned. Reported that the screed
5
has been omitted from the contract.
Utilities
Power On
Switchgear installed into substations in Building A & B. HV cable installed between Building A & B and site entrance. HV cable to be installed from Building C.
Power will be avaiable to the switchgear from the 12 April 24. Materials for the plantrooms is reported as not an issue. Lack of progress is due to a shortage of labour.
Water
The incoming water supply is now to be laid in St James Road. The date for completion now projected end of April 24.
Critical issues
• Agreeing timing of incoming services to site.
• Incoming services and achieving power on, now projected as the 12 April 24.
• Confirmation required that the required lifts will be aavilable at the start of the benefical access dates.
• Method to clad link bridge (this will possibly block access through the site).
• Construction programme only gives a start and end date for the roof, envelope and fit out works for Block C.
6
• Poor performance of installation of unitised cladding panels will affect the final fitting out of upper floors.
Access for materials and labour will be via one lift in each building. Two lifts therefore need to be in operation to achieve the Target Early Access dates. One for the clients use and one to serve construction works. Confirmation is required that this can be achieved.
7
8
FH090-151015 appendix p
Clarke’s manufacturing update
Project Honey - Block B Straight Panels (including linkbridge)
Block B Straight Panels
22/01/202429/01/202405/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
10/06/202417/06/202424/06/202401/07/2024
22/01/202429/01/202405/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
10/06/202417/06/202424/06/202401/07/2024
202308/01/202415/01/202422/01/202429/01/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
17/06/202424/06/202401/07/202408/07/202415/07/2024
22/07/202429/07/202405/08/202412/08/202419/08/2024
05/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024 26/08/2024 10/06/2024
15/01/202422/01/202429/01/202405/02/202412/02/202419/02/2024
26/02/202404/03/202411/03/202418/03/202425/03/202401/04/2024
08/04/202415/04/202422/04/202429/04/202406/05/202413/05/2024
20/05/202427/05/202403/06/202410/06/202417/06/202424/06/2024
01/07/202408/07/202415/07/202422/07/202429/07/202405/08/2024
12/08/202419/08/202426/08/202402/09/2024
Total Check Panels Fabrication (Planned) 332 0 71 17 15 12 12 14 14 17 18 18 18 18 18 18 18 18 16 Panels Fabrication (Actual) 332 -101 71 17 15 16 22 21 23 22 17 5 1 0 1 0 Cumulative Fabricated (Planned) 71 88 103 115 127 141 155 172 190 208 226 244 262 280 298 316 332 332 332 332 332 332 332 332 Cumulative Fabricated (Actual) 71 88 103 119 141 162 185 207 224 229 230 230 231 231 Installed On-site (Planned) 332 0 50 20 15 16 8 15 19 12 17 13 17 13 21 9 15 24 16 10 10 10 2 Installed On-site (Actual) 332 -150 86 27 13 10 0 27 1 0 7 0 11 Cumulative Installed (Planned) 50 50 70 85 101 109 124 143 155 172 185 202 215 236 245 260 284 300 300 310 320 330 332 332 Cumulative Installed (Actual) 86 113 126 136 136 163 164 164 171 171 182 21 38 33 30 26 32 31 29 35 36 41 42 47 44 53 56 48 32 32 22 12 2 0 0 Total Check Panels Fabrication (Planned) 82 0 19 2 3 4 4 5 5 5 5 4 4 5 5 5 5 2 Panels Fabrication (Actual) 82 -35 19 2 3 3 4 5 3 4 2 0 1 1 0 0 Cumulative Fabricated (Planned) 19 21 24 28 32 37 42 47 52 56 60 65 70 75 80 82 82 82 82 82 82 82 82 82 Cumulative Fabricated (Actual) 19 21 24 27 31 36 39 43 45 45 46 47 47 47 Installed On-site (Planned) 82 0 14 4 5 4 4 5 5 4 5 4 5 5 7 2 5 1 3 Installed On-site (Actual) 82 -40 25 2 2 6 2 2 2 0 0 0 1 Cumulative Installed (Planned) 14 14 18 23 27 31 36 41 45 50 54 59 64 71 73 78 79 82 82 82 82 82 82 82 Cumulative Installed (Actual) 25 27 29 35 37 39 41 41 41 41 42 5 7 6 5 5 6 6 6 7 6 6 6 6 4 7 4 3 0 0 0 0 0 0 0 Total Check Panels Fabricated (Planned) 436 0 16 6 5 6 5 6 10 11 19 21 22 22 22 22 22 22 21 24 41 36 45 32 Panels Fabrication (Actual) 436 -188 16 0 0 6 5 6 17 13 19 27 24 24 18 14 15 29 15 Cumulative Fabricated (Planned) 16 16 16 22 27 33 38 44 54 65 84 105 127 149 171 193 215 237 258 282 323 359 404 436 436 436 436 436 436 436 436 436 436 436 436 436 Cumulative Fabricated (Actual) 16 16 16 22 27 33 50 63 82 109 133 157 175 189 204 233 248 Installed On-site (Planned) 436 0 16 19 15 26 27 20 22 18 16 17 5 18 19 18 20 22 22 20 21 23 17 9 9 9 8 Installed On-site (Actual) 436 -283 16 0 0 0 0 0 0 2 0 11 10 15 9 23 20 31 16 Cumulative Installed (Planned) 16 16 16 16 16 16 16 16 16 16 16 35 50 76 103 123 145 163 179 196 201 219 238 256 276 298 320 340 361 384 401 410 419 428 436 436 Cumulative Installed (Actual) 16 16 16 16 16 16 16 18 18 29 39 54 63 86 106 137 153 0 0 0 6 11 17 22 28 38 49 68 70 77 73 68 70 70 74 79 86 122 140 166 180 160 138 116 96 75 52 35 26 17 8 0 0 Total Check Panels Fabricated (Planned) 69 0 0 2 3 5 5 5 5 4 4 5 5 5 5 4 5 4 3 Panels Fabrication (Actual) 69 -39 0 4 1 1 1 2 3 5 3 5 5 Cumulative Fabricated (Planned) 0 0 0 0 0 0 2 5 10 15 20 25 29 33 38 43 48 53 57 62 66 69 69 69 69 69 69 69 69 69 69 69 69 69 69 69 Cumulative Fabricated (Actual) 0 4 5 6 7 9 12 17 20 25 30 Installed On-site (Planned) 69 0 0 4 2 12 5 3 6 4 3 0 6 0 6 4 2 2 4 3 1 2 Installed On-site (Actual) 69 -56 7 2 2 0 2 Cumulative Installed (Planned) 0 0 0 0 0 0 0 0 0 0 0 0 4 6 18 23 26 32 36 39 39 45 45 51 55 57 59 63 66 67 69 69 69 69 69 69 Cumulative Installed (Actual) 7 9 11 11 13 0 0 0 0 0 0 2 5 10 15 20 25 25 27 20 20 22 21 21 23 27 24 24 18 14 12 10 6 3 2 0 0 0 0 0 0 Stock available at Week End
Stock available at Week End Block A Curved Panels Project Honey - Block A Curved Panels
02/09/2024 Stock available at Week End
202308/01/2024
Block B Curved Panels Project Honey - Block B Curved Panels
Stock available at Week End Block A Straight Panels Project Honey - Block A Straight Panels (including linkbridge)
