prepared for Globe Kingston Limited September 2024

prepared for Globe Kingston Limited September 2024
Surrey House Island Site – Project Honey (10372)
contents
1.0 executive summary
2.0 programme
3.0 planning update
4.0 legals
5.0 design and project update
6.0 procurement update
7.0 construction works update
8.0 health and safety matters
9.0 tenant variations and approvals update
10.0 sustainability / Net Zero Carbon
11.0 environmental status update
12.0 key risks
13.0 areas of concern
14.0 key activities in the reporting period
15.0 lookahead – key activities in the next reporting period
appendices
appendix a - AfL completion deliverables tracker
appendix b – LoR & warranties tracker
appendix c – planning / S106 conditions
appendix d – EAI tracker
appendix e – outline programme
https://francishunter.sharepoint.com/sites/FH/Shared
appendix f– G&T update report
appendix g – MCLH update report
appendix h – BREEAM tracker
appendix i– Aecom CMT report
appendix j – MNP CMT report
appendix k – ORSA monthly CDM report
appendix l – DAA CMT report
appendix m – McLH procurement schedule
appendix n – McLH programme
appendix o – Lautus progress report
appendix p – latest Buildzone tracker/report
appendix q – commissioning meeting notes
appendix r – Plowman Craven latest measure
appendix s – guarantee schedule
appendix t – extension of time 05
appendix u – extension of time 06
https://francishunter.sharepoint.com/sites/FH/Shared
project: Surrey House Island Site, Project Honey
client: Globe Kingston Ltd/Cube Advisers Ltd r eport: summarised progress report – September 2024
distribution: Cube
1.0 executive summary
The purpose of this summary statement, is to provide a periodic update of activities undertaken by the developer’s project team, currently engaged to implement the redevelopment of Surrey House Island Site and to discharge Hathaway Opportunity Fund/Globe Kingston’s obligations under the Agreement for Development and Lease dated 9 December 2020 (and it’s Deed of Variations dated 8 April 2021 and 25 May 2022) with Unilever; and the Development Funding Agreement with LCN exchanged on 25 May 2022 and completed on the 14 June 2022.
The Main Contractor, Mclaughlin & Harvey Construction are appointed under a JCT Design & Build Contract dated 25 May 2022. The Contract has been signed based on a fixed price for Buildings A and B, and a guaranteed maximum price (Provisional Sum) for Building C.
MCLH are reporting that works on site are currently 4 weeks behind on Building A, on programme on Building B and 2 weeks behind programme on Building C The MCLH construction programme has now been issued, and progress is being tracked against this updated programme (R16)
On Building A – MEP install is progressing up to level 8 Unitised f açade works are now complete The stick system continues on the ground and first floor. Otis have completed their installation of lifts Feature stair install is ongoing on all floors. The terrace roofing is underway, and commissioning is ongoing.
On Building B - MEP install is complete The stick system glazing is complete on ground and 1st floor. Otis have installed all lifts Equitone façade is complete.

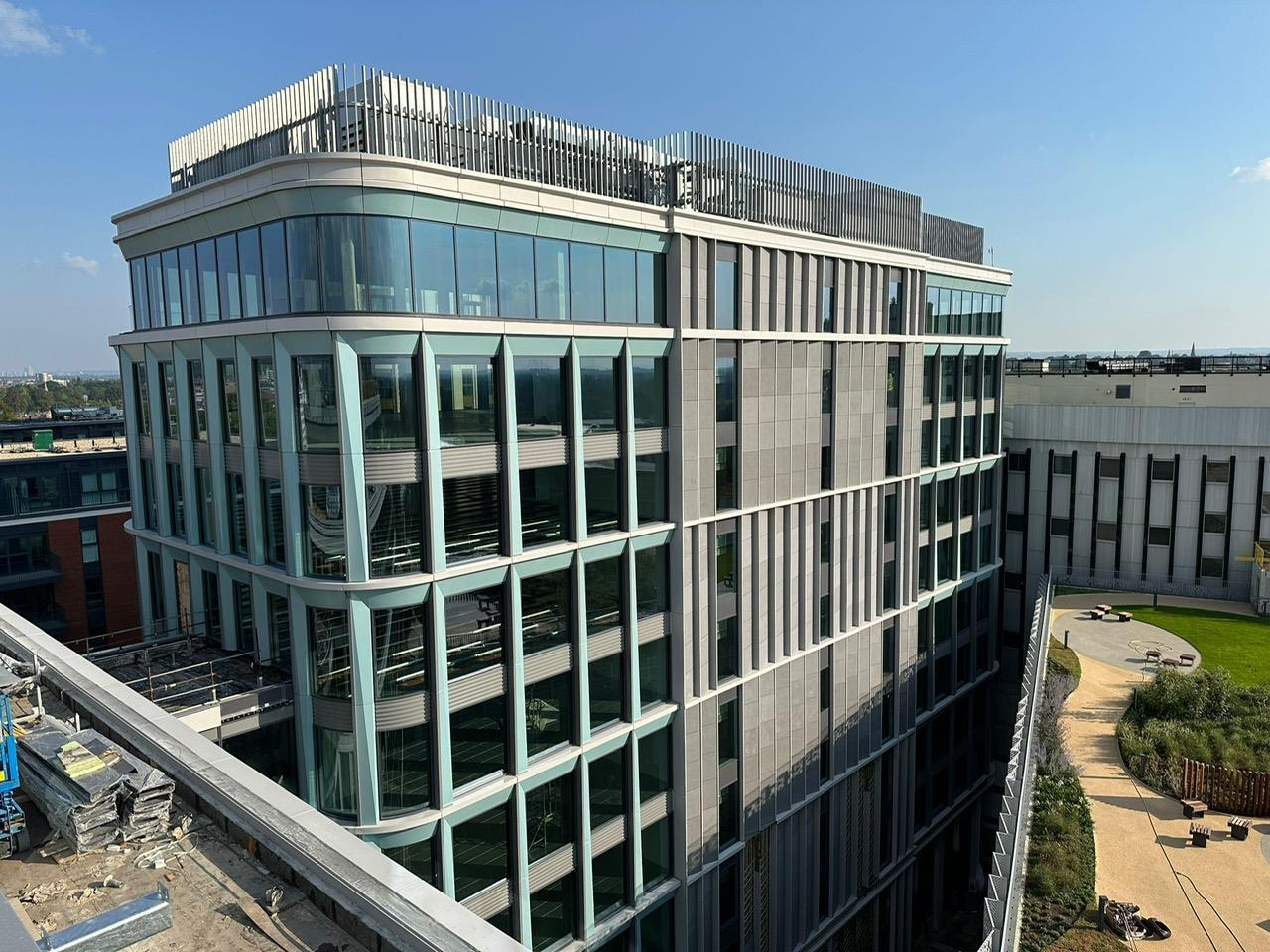

On Building C – Façade is complete with green brick complete at ground floor The changing area fit out is ongoing Landscape works on the roof is complete. The line painting has commenced on the parking decks.
The key risk previously reported relating to UKPN and Thames Water has now been fully resolved. All three buildings have power and water on The impact on programme has been realised with Notice of Relevant Event 06 and 07 being raised due to late Utility (both water and power) connections. FHPM have issued EOT 5 and 6, noted later in the report taking PC of all three buildings to 11th November 2024.
The façade continues to be a risk on the project due to programme challenges and issues with alignment The majority of remaining works relate to the Equitone core cladding on Building A and B and resolving alignment issues.
A further key risk is the S278 works, which due to a significantly elongated technical approval period is being carried out far later than envisaged. The works commenced on the 9th September, although were held up for a week on Brook Street due to the crane removal by MCLH The works on St James’s and Brook Street are due to be complete by early November prior to the Christmas Moratorium. Eden Street works will commence late January.
some key activities that have been undertaken in the current reporting period include.
• S278 – Put in place Bond for the S278 works.
• Executed LOI with S278 Contractor
• Continue to review design packages received from MCLH and progress the approval process with UL and LCN in line with the programme.
• Completed Building B façade (ground and first)
• Completed Building A façade (unitised)
• Snagged all floors of Building B
• Commenced snagging of Building A
• Removed remaining tower crane TC3
• Placed contract for FLOW artwork to commence fabrication
• Confirmed instruction to proceed with fabrication of Public Art on Car Park.
some key activities that will be undertaken within the next reporting period include.
• Execute Contracts with S278 Contractor
• Continue to review design packages received from MCLH and progress the approval process with UL and LCN in line with the programme
• Close out outstanding alignment/ snags of Building B facade
• Complete stick system and Equitone façade on Building A
• Snag all floors of Building A
• Complete de-snagging of Building B
• Remove remaining tower crane TC3
• Agree programme of installation of connections/ cables and FLOW art
• Agree list of outstanding works to be carried out post PC
high level financials
• Contract Sum - £122,962,469.66
• Contract variations to date - -£821,561.69 (net)
• Projected Final Account - £122,140,907.97
2.0 programme
Following the Unconditional date being confirmed on the 14 June 2022, which has commenced the 27-month construction
Longstop period the below schedule reflects the latest programme attached to this report in Appendix E and follows the issue of the Possession Notice on 4 July 2022 and Deferment of Possession commencing works on the 20th September 2022
MCLH are now reporting against their Construction programme July 2024 Rev 16, which we are reporting against.
Following a review of MCLH programme and MCLH progress on site, FHPM’s current view on programme is as follows;
- Building A – 4 weeks behind
- Building B – on programme
- Building C – 2 weeks and 1 day behind
The key risks to MCLH programme are as follows;
- Access to site – External works being carried out within site and the S278 works are likely to impact access to site. This is being closely co-ordinated and monitored.
- S278 works – Works will need to commence prior to PC, and this is likely to impact on the site logistics. This will need to be managed closely and co-ordinated with MCLH to minimise any impact.
- Fit-out of the changing village in Building C – Now on critical path and likely to overrun.
- Equitone Cladding – Delay to Equitone cladding has led to a delay in being able to remove the two mast climbers on site as well as TC3. This has had a knock-on impact on the ability of MCLH to progress the External Works. One mast climber and TC 3 were removed in the last period, with one remaining mast climber being removed this week.
3.0 planning update
3.1 general update
All pre-occupation conditions that can be submitted, have been. Please see Condition Tracker for further detail. In the last reporting period conditions 43 and 44 have been resubmitted.
3.2 planning conditions & S278 agreements
Highways have now agreed the scope of the S278 works, with the S278 agreement itself agreed and ready for engrossment. Riney have been selected as the S278 Contractor and are under a letter of instruction to progress long lead items and traffic management. Works are to start on site on the 9 th September 2024, where both Brook Street and St James’s Road will be closed for 8 weeks.
The scope of the Secure by Design requirements for Building C have now been agreed with the DOCO. The updated pack has been issued to the DOCO. Once external doors are in place, the DOCO and Park Mark will inspect and sign off works. Outstanding conditions set out below;
Park Mark will inspect site in October to
submitted to amend this to
3.3 progress against S106 employment and procurement requirement
MCLH have now issued to the Council confirmation of their procurement of 15% of works in the local area as well as their current status of local employment. We have had several queries from the Council which have been responded to.
There are now monthly meetings in place with representatives of the Council to demonstrate the team’s willingness to meet the set targets.
4.0 legals
4.1 AfDL conditions update
The AfDL is now Unconditional, and therefore conditionality will not be reported on going forward.
4.2 appointments and warranties
Terms have been agreed with all principal consultants together with all relevant fees and cash flows based upon the current programme A schedule of appointments and warranties has been agreed with both the Fund and the Occupier.
A full schedule of appointments and contracts is being managed and monitored by Francis Hunter, a copy of which is included within the appendix.
It has been 12 months since Unconditional and therefore additional pressure is being put on MCLH and Gowlings to resolve the outstanding Warranties. Regarding Lender Warranties, the majority of current significant designers/ subcontractors have now been signed
The additional warranties requested by the Lender have been provided and are currently being executed
4.3 construction documents
The JCT D&B Contract was signed and dated on the 25th May 2022 with all terms agreed with the Contractor, Funder and Occupier. A Possession Notice was signed and issued on the 4th July 2022 to enact the Contract confirming a
possession date of 12th September 2022 Following a number of obstructions and issues found on site during demolition, the Date of Possession was deferred to the 20th September 2022.
Buildings B and C were deferred until 26th September 2022, although MCLH have since confirmed the second deferment had no impact on the overall programme
A breakdown of extensions of time and expected relevant events is shown in the programme section of this report.
The Employer’s Requirements are back-to-back with drawings and specifications within the DOV and DFA.

5.0 design and project updat e

MEPH, Architectural and Structural Stage 5 design is complete and As-Built drawings are now being issued.
5 1 k ey design changes/ issues under consideration
Fire Curtains/ Shutters – The revised proposal is for UL to provide a formal letter confirming that they will not occupy until the works set out in the base build fire strategy and in particular the fire curtain around the feature stair of level 6 and 7 are completed. On this basis SWECO are willing to give a full Final Certificate for the works of Building A. We await formal confirmation of this.
Public Art design – Connection design is underway Due to the Public Art interface with the façade and the structure of three separate buildings it continues to cause complications. Connections, cables and the public art itself will be installed post PC.

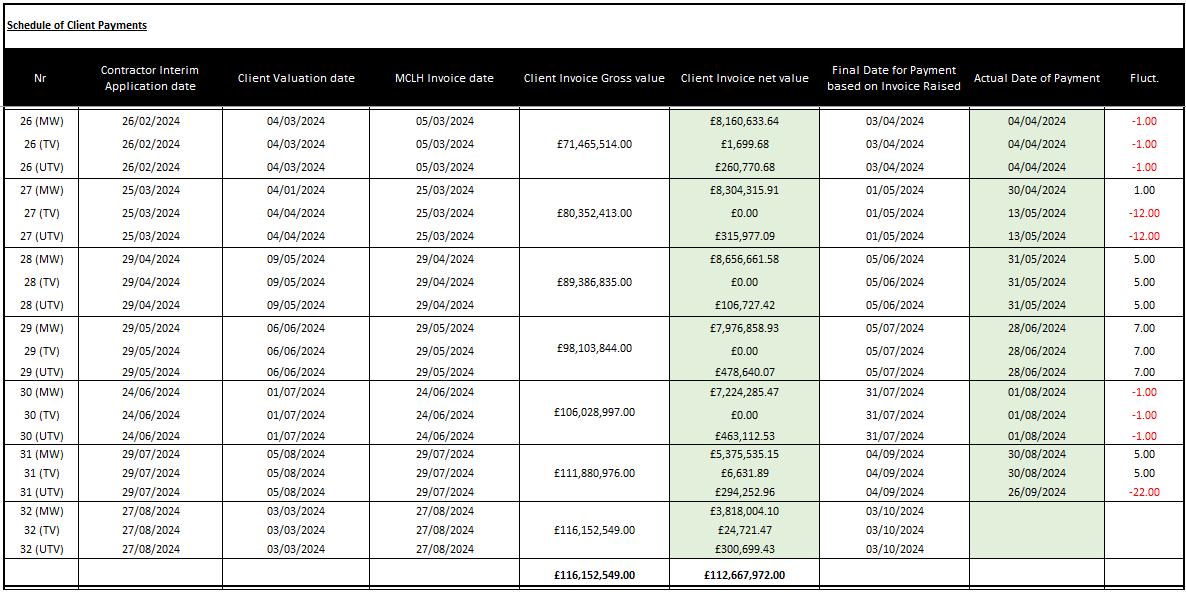

6.0 procurement update
Following lengthy negotiations with MCLH, the JCT D&B Contract was signed with a Contract Sum of £122,962,469.66 dated 25th May 2022.

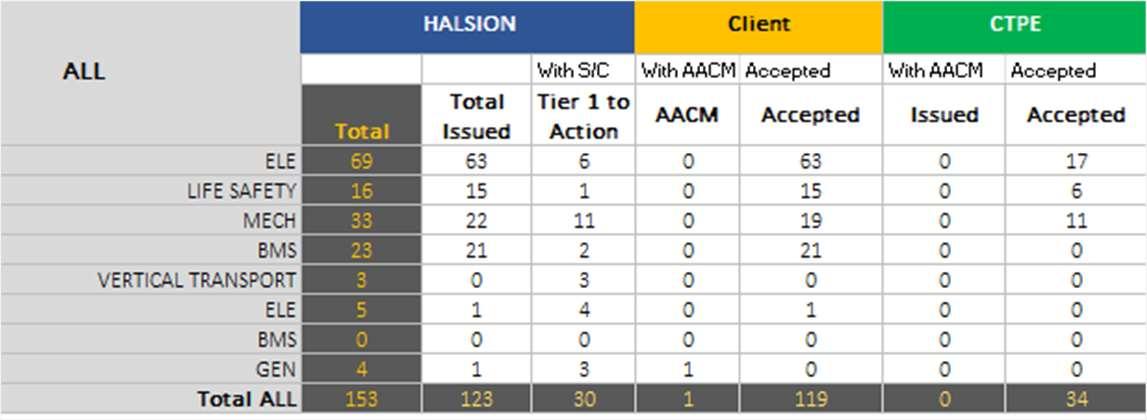

MCLH have issued a revised procurement schedule, which is appended to this report This will be tracked by FHPM going forward.
The G&T Report is appended in Appendix F.

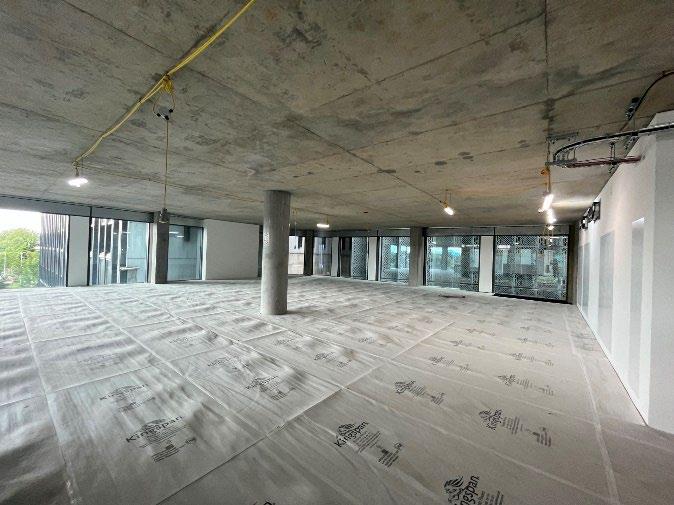

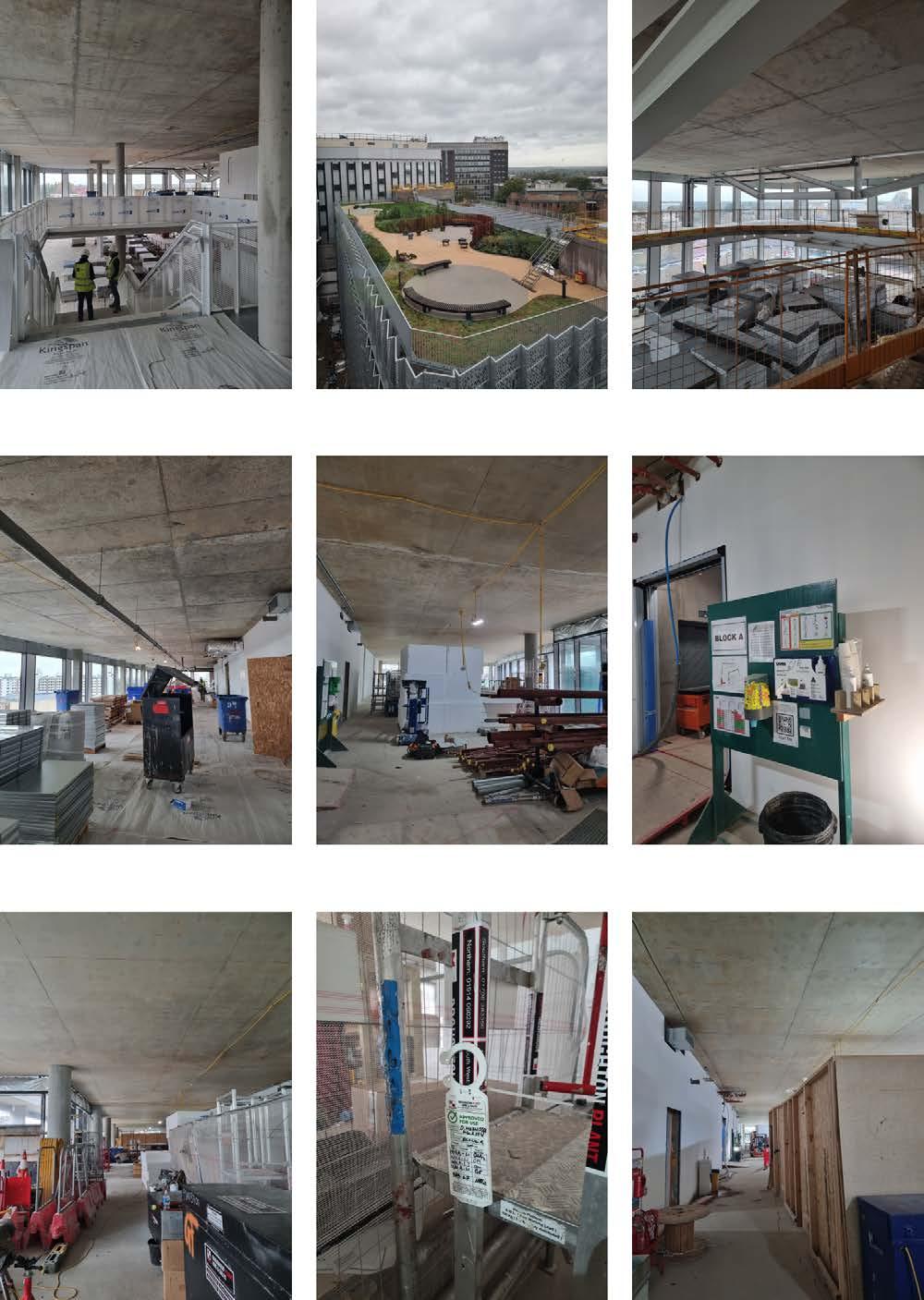

7.0 construction works update

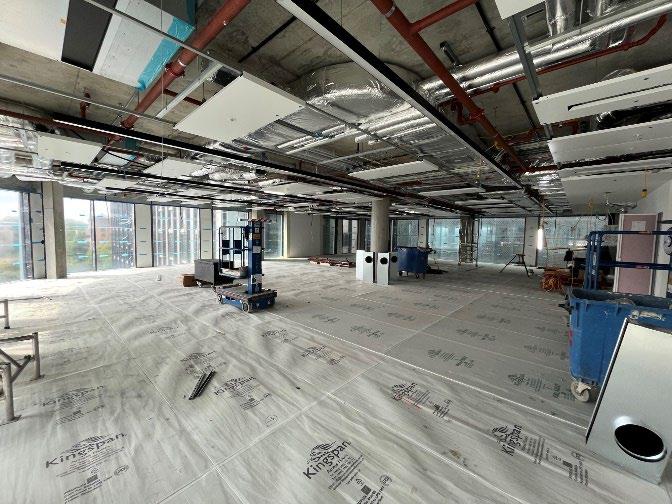

Below is an update on progress in the last reporting period:
• Continuing commissioning through buildings A and B
• Continued roofing works to Building A
• Continued lift works to Building C
• Continued ceiling works in Building A and B

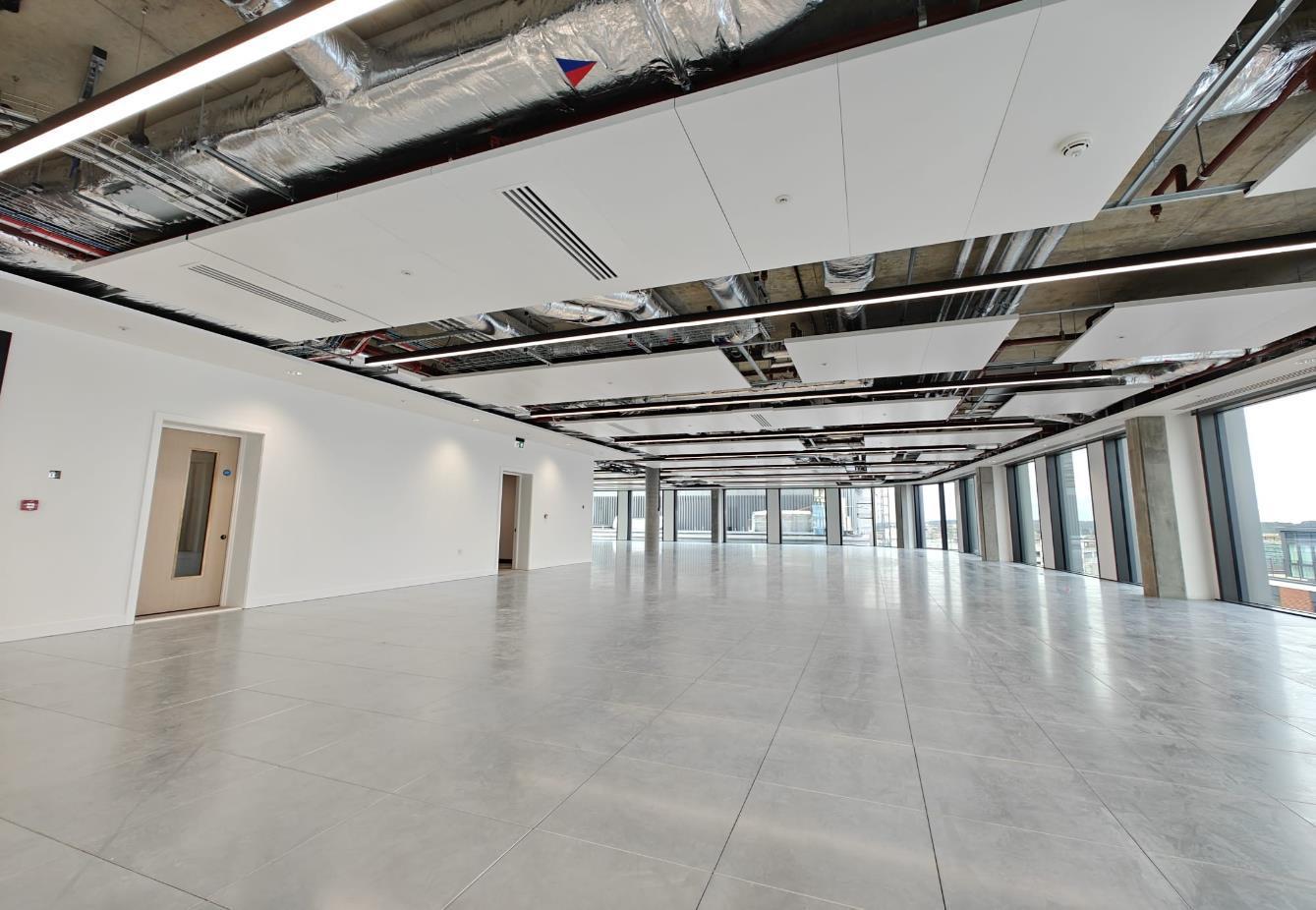

• Continuing floor finish to feature stair of Building A

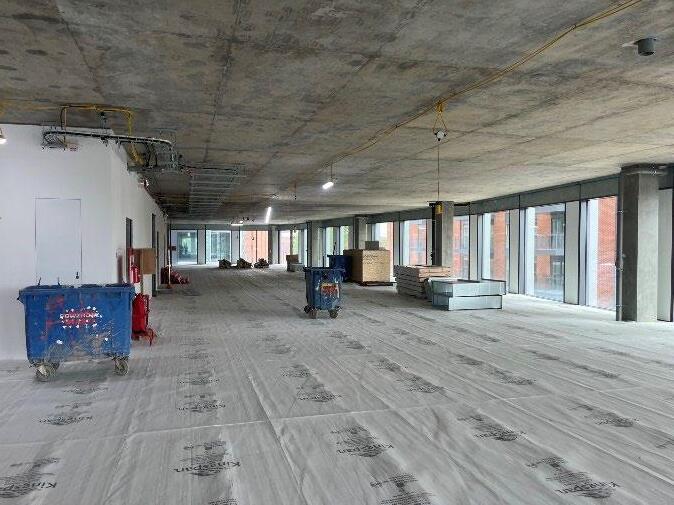

• Continued external works in Woodland Walk
• Continued snagging of Buildings A and B
8.0 health and safety matters

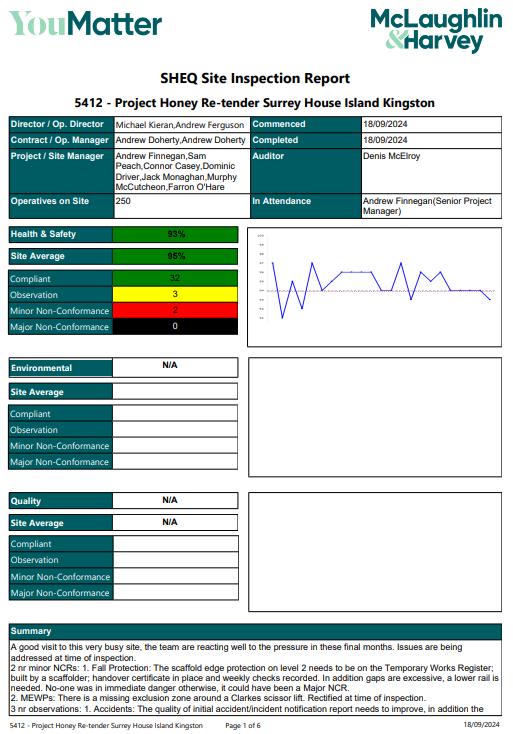

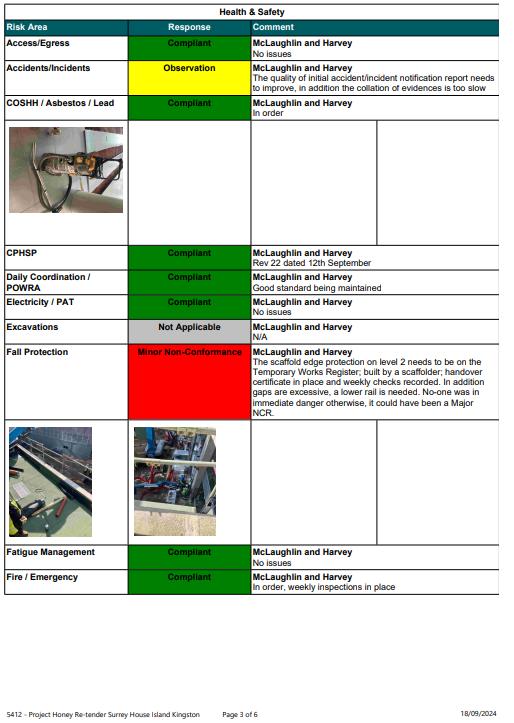

ORSA, as Principal Designer, are progressing key design risk assessments with the team as the design develops and continue to keep the professional team informed at all stages. ORSA are carrying out monthly site inspections of works being undertaken by MCLH and providing reports.
ORSA carried out a site inspection on the 27th September 2024, and their findings are appended to this report.
9.0 tenant variations and approvals update
Variations instructed in the last reporting period are set out below (and set out in more detail in the variation tracker within the appendix)
- EAI 146 – 20th September 2024 - Service Notch Construction
- EAI 147 – 24th September 2024 – Building C External Render
- EAI 148 – 24th September 2024 – Fence Height Increase
- EAI 149 – 30th September 2024 – External Highway Work Omission
- EAI 150 – 4th October 2024 – Omission of Prov Sums
As noted earlier in the report, given the stage the project is at, variations are becoming more impactful and will potentially result in abortive design costs, cancellation charges and programme delays. The below table sets out in more detail the variations in the last reporting period. This is the capital cost of the variation and does not include any finance costs;
11.0 environmental status update
As it stands, there are no environmental issues identified on site. This will continue to be monitored as the project progresses.
12.0 measured surveys update
Below table sets out the NIA of each floor as set out in DFA and DOV compared to actual measures currently being carried out by Plowman Craven (see appendix R). These numbers are inclusive of tenant variation changes.
Omission of

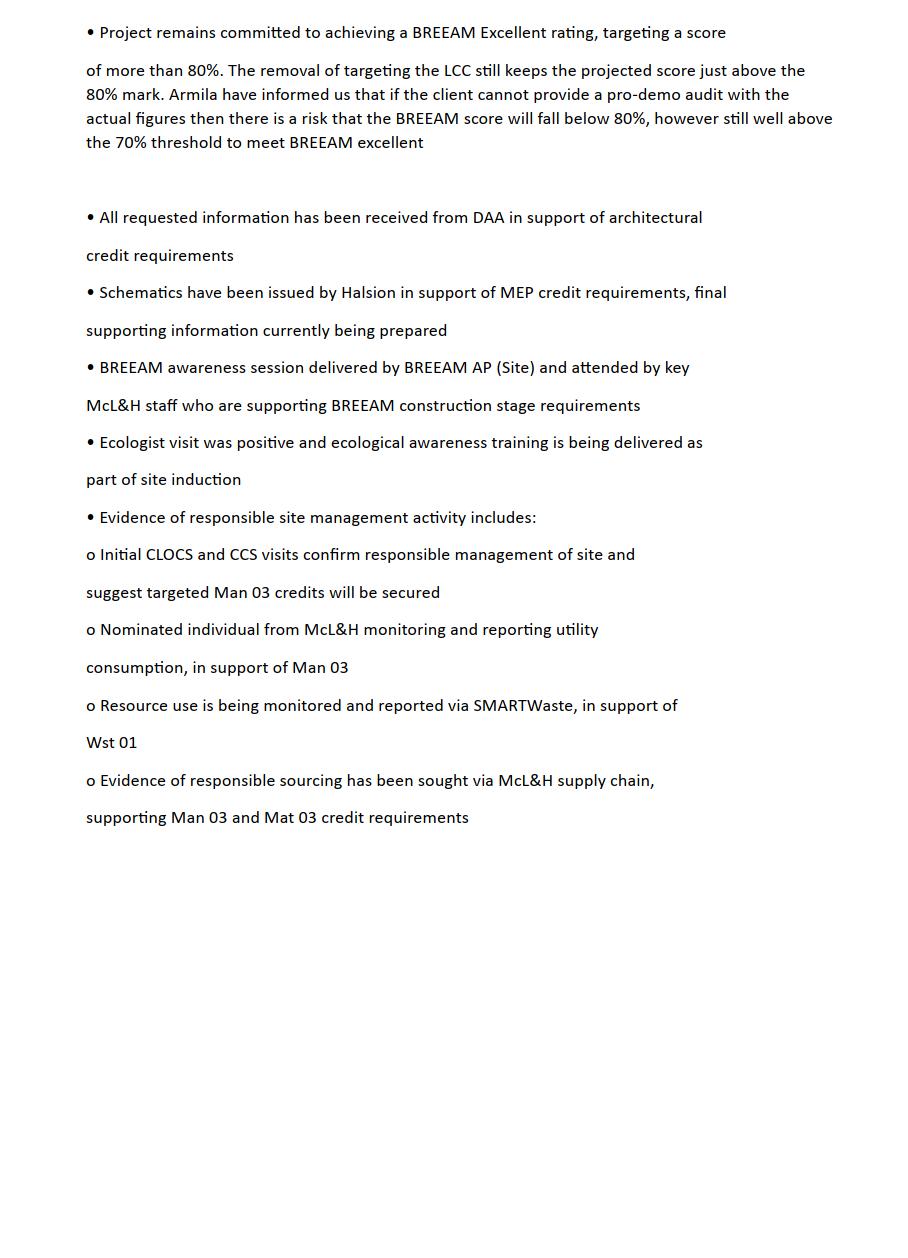

10.0 sustainability/ Net Zero Carbon
In line with undertakings within the AfDL, the developer team continue to follow the sustainability commitments. All members of the design team are specifically charged with supporting the objectives and developing the design accordingly. Design is progressing based on achieving BREEAM Excellent and EPC A. Currently ac hieving
which is the same projected figure as the previous month.
Principal risks during the immediate next phases that could impact on the deliverability of the scheme are as follows;
ref. risk item status update
R1 Health & Safety The Principal Designer (ORSA) are fully integrated into the team and providing regular updates, as well as carrying out monthly site inspections during the construction contract
R2 Programme delays due to COVID 19
R3 Construction (Contractor) delays
R4 Planning Condition Delays
R5 Contractor/ sub-contractor insolvency
No programme impact as yet and risk mitigated within AfDL.
Tight town centre site with complex logistics will increase risks of delay significantly. This is now primarily a contractor risk item S278 works will impact logistics on site and these works/ road closures will need to be co-ordinated with MCLH and the Highways Contractor
The planning conditions are being tracked on a weekly basis, with Chartplan in discussions with RBKT. The pre-occupation conditions are currently being submitted
The financial status of the Main Contractor and its key supply chain is checked on a quarterly basis. The financial stability of all sub-contractors is the Contractor’s risk. The latest checks were carried out in September 2024, which raised no significant concerns.
R6 Achieving areas To ensure the targeted areas are achieved, these will be checked at each design stage and as Construction progresses to ensure the development is falling within the min/max area brackets.
Section 12 outlines the measures to date. All areas measured with areas achieved.
R7 Cost Overrun The Contract has been signed on a fixed price, however there are Provisional Sums which could lead to an overspend and require expenditure of the contingency. These are reported on each month by G&T and the Provisional Sums are to be closed out as early as possible.
R8 Twin Wall An alternative LDI policy with Build-Zone has been agreed, and the Deed of Variation to replace the Aviva policy has been agreed and signed. The cost and programme impact of the twin-wall has been closed with the signing of the DOV. It should be noted that delays during resolving the issue have impacted the programme and resulted in delays beyond the current reported delay.
R9 Utilities –UKPN/ Thames Water
The UKPN works are complete with substations in place and highway works complete. Power-on is now on in all three buildings, however this is later than planned and has impacted the Commissioning programme. Notice of Relevant Event 06 and 07 have now been issued by MCLH for delay to Power and Water on. EOT 5 and 6 have been issued due to Utilities being connected later than required.
R10 S278 Agreement S278 Agreement has been signed and works commenced on site. Brook Street and St James’s Road to be complete prior to December, however due to delays in agreeing the scope and S278 Agreement, Eden Street will be carried out in January/ February 2025.
R11 Clarkes façade programme Clarkes façade manufacturing and installation programme is behind. MCLH have put forward a recovery programme which will be updated weekly. Majority of unitised works complete. Work now focused on stick at Ground and First, as well as the Equitone cladding on core walls of Building A. These works will be complete at the end of October
R12 MEPH weather damage MEPH works are progressing on floors prior to the façade being installed. This is not necessarily an issue; however, a concern has been raised by Aecom and the tenant team. MCLH have provided an uplifted testing regime to deal with these out of sequence works. This is under review
R13 LFB Sign off LFB have been formally responded to however MCLH confirmed at the reporting meeting that all points have been responded back to SWECO who have raised no significant concerns.
likelihood of risk impact of risk contractor or developer risk
and Developer
and
14.0 areas of concern

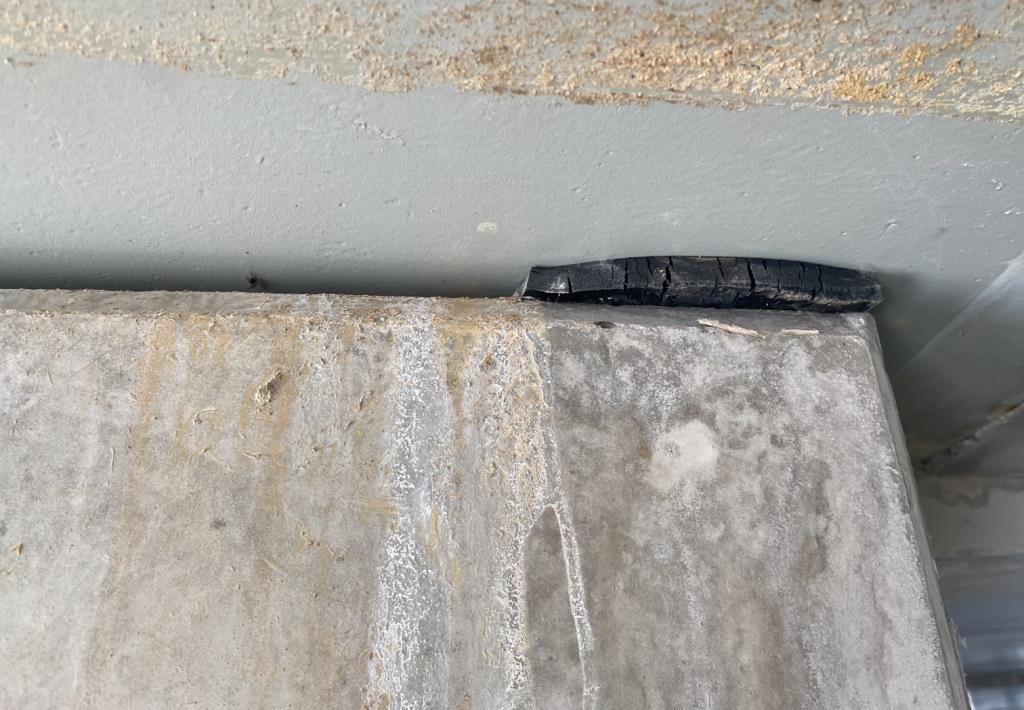

Façade – Install is ongoing, and report issued on the alignment issues which is under review by EOC.
S278 Agreement – Works ongoing and S278 Agreement is in place.
Fire Curtains/ Shutters – Still awaiting instruction to proceed with the 6th and 7th floor fire curtain. An alternative proposal is under review which will negate the requirement for these works to form part of the base build development works.
15.0 k ey activities in the reporting period

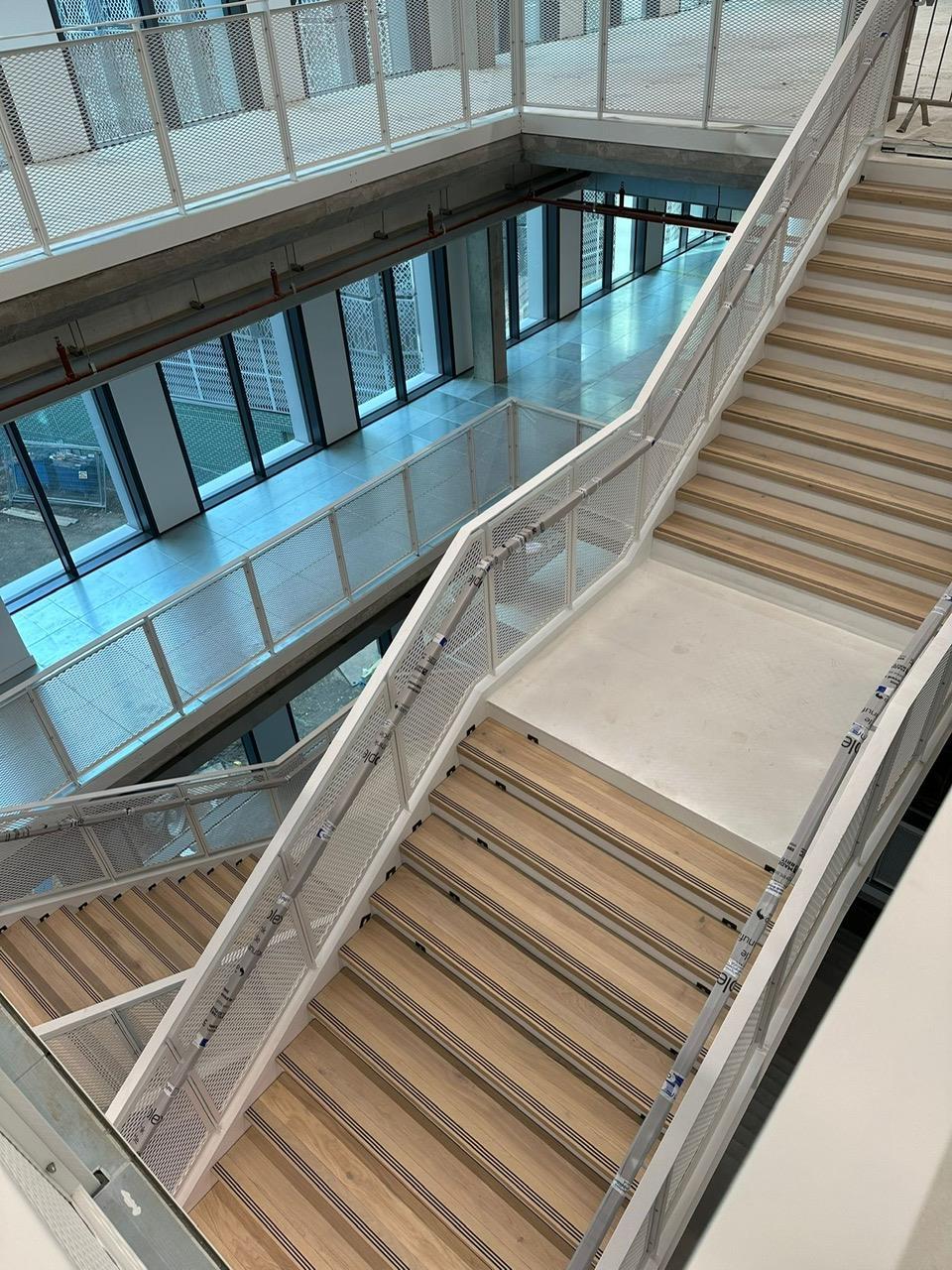

I. Complete façade works to Building B
II. Progress tenant variations.
III. Review design release packages issued by MCLH.
IV. Continue to look at options of reducing the carbon impact of the development.
V. Formally appointed Highways Contractor to carry out S278 works
VI. Removed one mast climber and crane from site
VII. Continue snagging to Building B and commenced snagging to Building A
VIII. Continue to close out conditions as per 3.2
IX. MCLH issued façade alignment issues report for review
X. Instruct connection details design for the public art to Buildings A, B and C.
XI. Completed measure for all of Building A
XII. Commenced highway works
lookahead – k ey activities in the next reporting period
I. Complete façade works
II. Progress tenant variations
III. Review design release packages issued by MCLH.
IV. Continue to look at options of reducing the carbon impact of the development.
V. Complete St James’s Road S278 Works
VI. Remove mast climber on Brook Street
VII. Close out Park Mark with Car Park Operator
VIII. Close out conditions as per 3.2
IX. EOC to review alignment issue report.
X. Agreeing installation dates for connection details/ FLOW art
XI. Complete external works
XII. Continue highway works
appendices
A. AfDL completion deliverables tracker
B LoR & warranties tracker
C Planning/ S106 Conditions
D EAI Tracker
E Outline Programme
F G&T Update Report
G MCLH Update Report
H BREEAM Tracker
I Aecom Update Report
J MNP Update Report
K ORSA Update Report
L DAA Update Report
M McLH Procurement Schedule
N McLH Construction Programme
O. Lautus Progress Report
P Buildzone tracker/ report
Q Commissioning Meeting Notes
R Plowman Craven latest measure
S. Guarantee Schedule
T. Extension of Time 05
U. Extension of Time 06
AfL completion deliverables tracker
4 Licence for Alterations (tenant works) and Tenants Drawings
4.3 Tenants building contracts/warranties
8 Environmental Consultant Duty of Care letters
18.5 Car Park Works updated Construction Costs figure
9.2 s 278 Agreement and any highways licences
8 - Environmental Consultant Duty of Care Letters
Also clause 12. No LTA required at point of lease signature, updated LTA programme to be agreed between Unilever and KF.
Not required at point of Lease signature.
13.8 Snagging /defects lists (13.8 & 17)

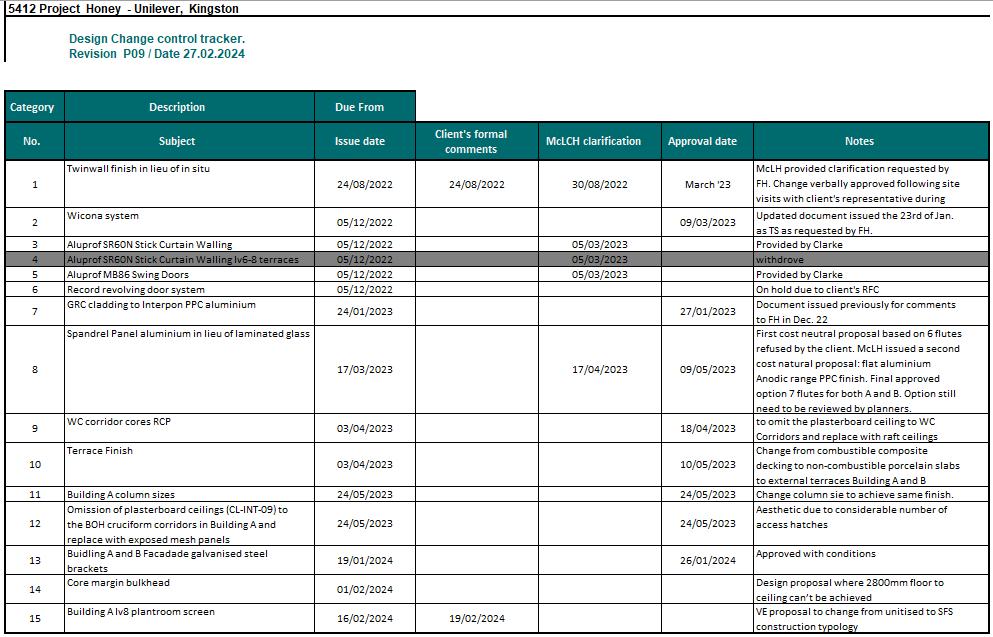

4 Variations to the building contract - Signed RFCs
18.5 - Car Park Works Updated Construction Costs
Email sent 18/6/24. IR: We have reliance letters from GEA dated 22 December 2022.
KF/Unilever N/A - Not required for Lease Signature Not relevant to Developer works and only required for fit-out
24/09/24 - UL have accepted that the Capped Provisional Sum for Car Park has been exceeded and therefore no savings G &
and Mace to agree.
9.2 - 278 Agreement and Any Highways Licences
Signed by all parties. Final S278 and surety etc to be issued to FHPM to upload. DL to send through pack to TA hving gone through with Farid. Gwlngs SATISFIED 3.4-PCD(+2months)
Ongoing. Need list by sectional completion. Ongoing.

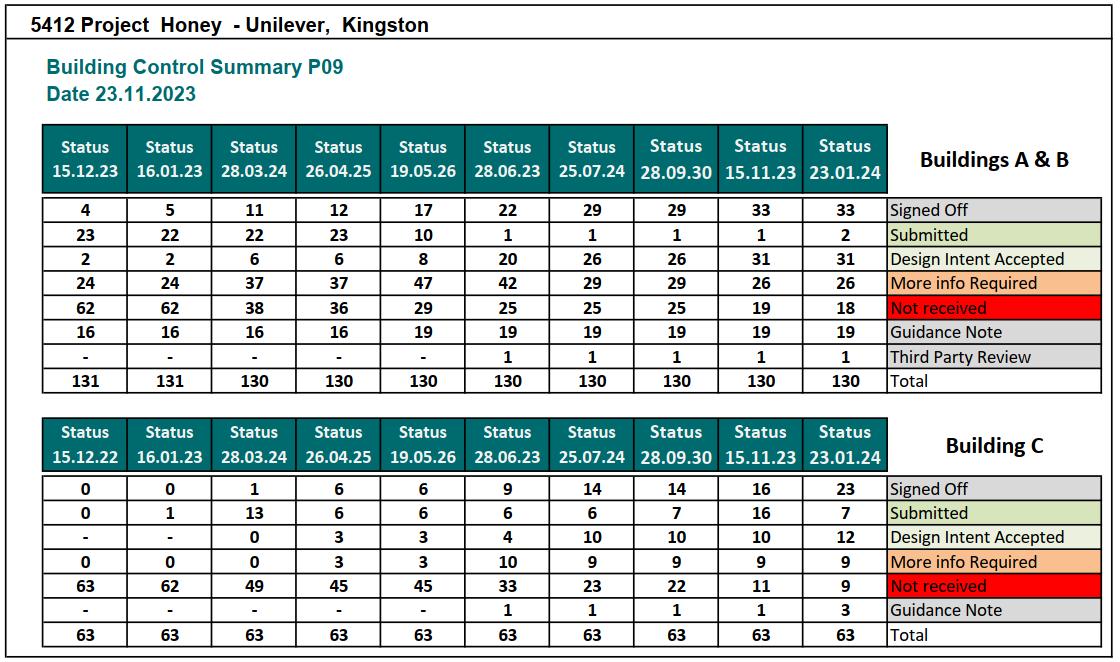

48 of 68 variations have been signed by Unilever. In progress. FHPM/ Mace carried out review with general agreement on variations. UL team to respond by 7th Oct.
9.7 BIM model provided
9.3 DRAFT H&S files
9.6 O&M manuals (9.6 (b)) SEE 9.3
FHPM to maintain. Still awaiting stage 05 model and associated COBIE data. This needs to be audited by tenant team before acceptance. Full Stage 5 model to be issued on 18th October 2024 for review.
Draft Stage 05 issued
Draft H & S File to be provided 2 weeks before PCD . FHPM have requested them from MCLH Ongoing. Awaiting confirmation of date of draft issue
CMT to provide formal letter confirming acceptance of contents of
One set of maintenance & operation manuals to be provided 2 weeks before PCD. LN: Access given to Unilever's Team plus Colliers, in draft format and are under review - Issued last week. CMT to provide formal letter confirming happy with contents of H&S File. WIth UTeam for review.
4.7 Final licence plan (car park) (4.7 & 22)
To be closed out by the end of the month so that invoicing can de done at the end of the month with payment 10 days before PC. Meeting held on 23 September to close out . Final comments expected 27/9/24.
RT - Query regarding rent free - 29.89 months rent free is the latest sum. Invoice process for Tenant CAT A omission to be confirmed by UL team. Waiting for Mace to
Sent to GWL 27.08.24 for issue. Still awaiting comment - 17/09/24 - Technical team to review Lease plansIssue to KF and Mace for FHPM/Mace then GWlngs to MB
Car Park Meeting to be arranged with all parties to close out and agree. DAA to produce plans. . FHPM to issue to Gowlings. Unilever and Mace have reviewed but LN still expects some comments.
15 Measured surveys. All floor plans have now been measured, with comments issued back to P&C. Final measure to be circulated to all parties once received.
18 Agreed rents Building A/B/Ground Floor Link rent
23 Engrossment leases/Licences to Alter/Estate Deed (and Defects Deed) plus Current lease surrender Unilever House/new lease Unilever House
6.2 A certified copy of each Professional Appointment (covered in clause 5) plus copy of current PII certificate
6.2 - Professional Team Appointments and Insurances
In progress. See P & C schedule to be attached to monthly report. Previous measure issued on 02/09/24 to UL and LCN for review and comment. No comments received from UL or LCN team. UL team confirmed no further comment. Survey to be issued to Agents to agree rents. LN to confirm with J L and then DS can get started
Agents have provided first pass at rents. JL to issue once agreed
KF/ LCN to provide sign off on acceptance of a delay to the Lease Surrender. GWL have confirmed next steps and issued summary. Awaiting LCN confirmation. MNP instructed to provide interim strategy Still awaiting BCLP response. Still waiting and with LCN team. DL - no committent re timing. V much up in the air atm
TA has issued (another link requested) Full certified redacted copies received. Will be uploaded once link re-sent. In progress but cannot be green until all complete FHPM/Gwlngs
6.2 Professional Team/Subcontractors and Contractor Warranties/ Third Party Rights….the following have warranties that are not completed: (6.2 & 6.3)
6.3 Copy of each sub-contract and current PII certificate of each Principal Sub-Contractor
6.4 Product guarantees (separate schedule to be attached) to include those identified at RIBA stage 4/ plus for Tenant Variations.
TA- some warranties still circulating. ….Awaiting response from BCLP on subsub Contractor Warranties.
TA has issued warrantiesFHPM to upload. (Rec'd by FHPM 26/9/24) FHPM to review tenant require warranties . TA all sub-sub should go out this week. BCLP happy with content...just asked for PI certs. No need to go down another level with Intersteel. ...draw a line at
In progress…will be moved across before PC. Check that none run out before PC. Sub-Contractor insurances not expiring before PC moved across Those renewing between September and December to be noted. Ongoing.
Mace have provided list of guarantees required. MCLH confirming these are being provided. UL and LCN to provide any required wording for Guarantees.Resent to KF and Mace for BCLP to review. FHPM to chase for
Minutes, variations, progress reports, costs etc all provided before PCD. Circulated to all parties on an ongoing basis and therefore not included as a hyperlink. Ongoing. FHPM to upload minutes/ reports
In progress… list of Certificates to be be provided are in PC Checklist. Being uploaded and KF and Mace given access to review
Meeting with UL on 23rd September to close out. To be agreed w/c 7th October. With Mace to agree still.
and Mace to agree.
5 Appointments and novations (5 & 6)
9.6 DRAFT As built drawings (CAD) Buildings A/B and Estate including installations and services (9.6 (a)) including O&Ms
6.2 - Professional Team Appointments and Insurances All main appointments completed ..BRE (L of R) and P&C (Appointment) plus various Contractor Appts outstanding. . LN: Mace have full access to Centrodoc folder containing all PI certs and kept up to date. Mecserve drafted. Not yet signed. TA has issued professional team appointments. Await Contractor appointments. Colliers and Mecserve still not completed
Ongoing..to be reviewed with MCLH at the start of August. Starting to be issued. Ongoing.
8 Measurement Surveyor Duty of Care letters
8 Validation Engineer Duty of Care letters
Gwlngs to confirm….Appointment and Lender and Funder warranty with Client for signature. Tracker notes "Reliance letters (for Tenant) to be issued once reports are prepared" FHPM checking with Gowlings. Cannot be done until all measurements are completed. - FHPM to issue P&C final report so that TA h f f ili
Gwlng provided. DL to chase.
Latent Defects Policy
Policy on cover from PC. Progress being made with draft updated wording issued to all parties for review. No comments received. 'Route to LDI' to be circualted. Meeting to be arranged between UL/ FHPM to progress. BZ to provide proposal with separate policies ...2 with UL principally insured and one for Rocket for Car Park. ...interests for Unilever and LCN included. IR happy
9.2/9.6 Copies of Building Regulations and certificates confirming compliance Ongoing. To be done at PC. MCLH
9.2/9.6 Evidence of ALL planning permissions (including pre-commencement and pre-demolition) 9.2/9.6 - Evidence of all Planning Permissions
9.2/9.6 Evidence of discharge of planning conditions (discharge notices). The following have not yet been discharged:
37 Sustainable Drainage Scheme
43 Flood Void Maintenance Plan
44 Flood Resistance measures
46 Car Park Management Plan
49 Park Mark/ SBD
50 Retail Management Plan
64 GLA Whole Life Carbon Assessment
66 Circular Economy Statement
uploading decision notices as and when…to be copied over to appropriate folder when completed. In progress Should all be th
List of planning conditions that have not been discharged….list circulated by Chartplan. No decision notice/ council confirmation to be provided for informative conditions. UL/ LCN to comment. Ones we have have been uploaded…still waiting on some.
Chartplan
9.6 As built drawings (CAD) Buildings A/B and Estate including installations and services (9.6 (a))IR: Should include testing and commissioning certificates for machinery.
D to provide to T no later than 2 months following PCD. Ongoing
9.6 Copies of consents etc (9.6 (d)) - SEE 9.2 - List outstanding items All conditions and approvals contained in
9.6 EPCs (9.6 (e)) Ongoing …not completed yet.
9.6 BREEAM within 6 months of PC/drafts?
23.7 Copies of any consents needed to grant/register the Leases
Currently at 79.54%. Not completed until PC.
LN- includes anything not picked up above. DS- need consent of bank as soon as have engrossments (LCN). Will follow…Confirmation required as to anything that is missing. DS …will be thigs from LCN's side.
100 Note - Warranties - See Warranty Tracker Warranty tracker provided on a monthly basis to Mace and UL.
3.4-PCD(+2months)
months)
2.17
confirmed that she has sent a draft form of warranty to BCLP for all 5 of these subsubbies…....and will arrange for these to be issued once approved.
planning / S106 conditions
Detail Planning Application No: 22/02905/FUL – Consented 11/01/2023
Updated 06/08/2024
Surrey House, 34 Eden Street NCP Car Park, St James Road Former Hippodrome, Eden Street And Bo Concept, The Roundhouse 20 Eden Street
PROPOSAL: Application under S73 of the Town & Country Planning Act 1990 to carry out development without compliance with condition 1 (Approved plans) of planning permission ref: 21/04022/FUL (Application under Section 73 of the Town and Country Planning Act 1990 to carry out development without compliance with Condition 1 (Approved Plans) of Planning Permission ref: 20/02495/FUL (Full Planning application for the demolition of Surrey House, Multi Storey Car Park, Hippodrome and Bo Concept and the erection of 2 (two) Office buildings [Use Class - E(g)(i)] Building A and Building B: Building A 9 storeys (22,144 (GEA) sqms) Building B 11 storeys (11,587 (GEA) sqms). The erection of a replacement multi storey car park of 354 spaces plus cycle parking (for use as a public car park at weekends) landscaping, public realm upgrades, servicing, pedestrian and vehicular access) dated 02/12/2021. Variations to include alterations to bridge link, elevations, floorplates, ground floor level access, rooftop plant and screen, service yard, reduction to height of Buildings A and B, alterations to landscaping/public realm, removal of basements and stairs on sides of Building A. T
This application is accompanied by an Environmental Statement.
Taking into account the Environmental Information contained within the Environmental Statement and addenda thereto, which was submitted under the Town and Country Planning (Environmental Impact Assessment) Regulations 2017 and subject to a ‘Legal Agreement’, PERMIT subject to the following conditions:
This application is accompanied by an Environmental Statement.
(See Notice of Decision of Planning Application 22/02905/FUL for Full Specification)
1 The approved development shall be carried out in accordance with the following drawings/details: (See consent for full list of drawings) Informative
NMA App deposited re cladding deposited and validated 27/04/23
Ref: 23/01117/NMA
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Consented 25/05/23
2 The development hereby permitted shall begin before the expiration of three years from 2nd December 2021 (2nd December 2024)
3 . The development shall be completed in accordance with samples for all facing materials including fenestration and boundary treatments (gates, fences / walls, other) including details of manufacturing specification which shall be submitted to and approved in writing by the Local Planning Authority before above ground works on site are commenced. The development shall then be built in accordance with these approved samples and completed prior to occupation.
Pre above ground works condition
MCLH 11th November 2022
Validation details 22/03576/CLC
Consented 30/01/23
22/03576/CLC
4 Notwithstanding the details shown on the approved plans additional architectural detailing plans at scale 1:10/ 1:5 showing all openings and key elements of the building / landscape (windows, doors, facade glazing, fins and parapets, spandrel panels, entrance and associated publicly visible features, signage, lighting in publicly accessible areas, vents / intakes / exhausts, grilles / louvres, rooftop plant, other elevational features shall be submitted to and approved in writing by the Local Planning Authority before the relevant element is commenced on site. The development shall be constructed in accordance with the approved details.
5 Prior to any occupation an updated full and detailed landscape and planting plan, including details of additional tree planting on Brook Street shall have been submitted to and approved in writing by the local planning authority. The Strategy shall include the details of the 6 trees to be planted in Brook Street along with the proposed locations and details of the tree pits and tree grilles. The Trees planted on Brook Street shall comprise of 3no. Fastigiate Hornbeam (Carpinus betulus ‘Fastigiata’) planted at a minimum of 550cm tall with a minimum single clear stem of 200cm and a girth of 30-35cm, and 3no. Fastigiate Hornbeam (Pyrus calleryana ‘Chanticleer’) planted at a minimum of 450cm tall with a minimum single clear stem of 200cm and a girth of 25-30cm. The Strategy shall be implemented within the first planting season following
Pre development condition, relevant to each section
Pre above ground development
Pre-occupation condition
MCLH Application deposited 15/08/23
Ref: 23/02245/CLC
Validated 22/08/23
Consented 10/10/23
MCLH Application deposited 11/06/24
Ref: 24/01446/CLC
Consented 06/08/24
completion of the development and the landscape and planting shall thereafter be maintained for five years to the satisfaction of the Local Planning Authority. Any trees or planting that die during this period shall be replaced during the following planting season, and the areas shown to be landscaped shall be permanently retained for that purpose.
6 No above ground development shall take place until details of all external lighting have been submitted to and approved in writing by the Local Planning Authority. The external lighting shall be installed in accordance with the approved details and thereby retained as such unless a variation is subsequently submitted to and approved in writing by the Local Planning Authority.
7 Notwithstanding the provisions of the Town and Country Planning (General Permitted Development) (England) Order 2015 (or any Order revoking or re-enacting this Order) No fans, louvres, ducts, external lighting or other external plant other than those shown on the drawings hereby approved shall be installed without the prior written approval of the Local Planning Authority.
Pre above groundworks condition
MCLH Application deposited 31/10/22
Validated Ref: 22/03480/CLC
8 All works on site shall take place in accordance with the details approved pursuant to 22/00273/CLC (Details of Demolition and Construction Environmental Management Plan)
9 The development shall be carried out in accordance with details approved by 22/00759/CLC (Levels).
Informative
Informative
10 The development shall be carried out in accordance with details approved under 22/00371/CLC pursuant to Condition 10 (Site Waste Management Plan). Informative
11 Within 6 months of above ground works a Public Realm Management Plan, including measures to minimise any adverse microclimatic impacts of the development have been submitted to and approved in writing by the Local Planning Authority. Prior to the beneficial occupation of the development hereby approved the hard and soft landscaping shall be fully
Within 6 months of commenceme nt of above ground works
MCLH Application deposited 10/05/24
Ref 24/01192/CLC
Decision due by 05/07/24
Consented 23/01/23
22/03480/CLC
implemented and made available for all residents and thereafter maintained for the lifetime of the development.
12 The development hereby permitted shall be carried out in accordance with the approved Transport Statement.
13 Prior to the commencement of any development above ground level, details of secure cycle parking facilities to serve the development to which this permission relates shall be submitted to and approved in writing by the local planning authority. The cycle parking facilities as shown in the approved details shall be provided prior to beneficial occupation of the development to which this permission relates and shall be permanently retained for that purpose and kept free from obstruction thereafter.
14 The hard surfaces hereby approved shall be made of porous materials and retained thereafter or provision shall be made and retained thereafter to direct run-off water from the hard surface to a permeable or porous area or surface within the /curtilage of the property.
15 The revised energy strategy as approved by 22/00683/CLC on 3rd January 2023 shall be implemented throughout the development of the site.
16 Any flat roofed area that is not identified as communal or private amenity space or roof terrace shall not be converted or used as a balcony or sitting out area, and no access shall be gained except for maintenance purposes.
17
Informative
development condition (above ground)
Informative
Informative
Informative
A public art and way-finding strategy should be submitted to the local planning authority for approval prior to commencement of above ground works. The public art and wayfinding strategy shall identify proposed public art and way-finding works to be installed as part of the detailed landscaping strategy. The Strategy shall detail the mechanism for selecting the public art and way-finding works and the maintenance and management of the art works. The works of art shall be installed prior to the beneficial use of the car park or in accordance with the timeframe set out in the public art and wayfinding strategy and thereafter retained in accordance with the Pre above groundworks condition
Consented 30/01/23
Ref: 22/03841/CLC
Consented 21/03/23
Ref: 22/03873/CLC
agreed maintenance and management plan.
18 Prior to the occupation of the development hereby approved, details of the works relating to highway works required in connection with the proposed bus stop and bus stand, including any relocation of services and pedestrian crossings, shall be submitted to and approved by the Local Planning Authority or by the Council as Highway Authority pursuant to Section 278 of the Highways Act 1980, and carried out in accordance with the approved details. Such details shall include the agreement of levels and construction details. All works are to be to the Council's adoptable highway standards and shall include any associated drainage works, lighting improvements, landscaping, street furniture, road markings, signage, traffic orders, and any necessary alterations to statutory undertakers equipment. Any widening to the public footways shall be retained permanently available for pedestrian circulation and the widened areas dedicated as highway pursuant to the Highways Act 1980.
19 The development shall be carried out in accordance with the details approved on 25.02.2022 Reference 22/02595/CLC (Written Scheme of Investigation WSI - Archaeology). No development shall take place other than in accordance with the agreed WSI, and the programme and methodology of site evaluation and the nomination of a competent person(s) or organisation to undertake the agreed works. If heritage assets of archaeological interest are identified by stage 1 then for those parts of the site which have archaeological interest a stage 2 WSI shall be submitted to and approved by the local planning authority in writing. For land that is included within the stage 2 WSI, no demolition/ development shall take place other than in accordance with the agreed stage 2 WSI which shall include: A. The statement of significance and research objectives, the programme and methodology of site investigation and recording and the nomination of a competent person(s) or organisation to undertake the agreed works; B. The programme for post-investigation assessment and subsequent analysis, publication & dissemination and deposition of resulting material. This part of the condition shall not be discharged until these elements have been fulfilled in accordance with the programme set out in the stage 2 WSI.
Pre occupation condition MCLH Application deposited 23/05/24
Ref: 24/01313/CLC
Decision due: 18/07/24
NMA application deposited 28/06/24
Ref: 24/01621/NMA
Pre demolition condition
FHPM/Ch art Plan DOC app deposited 31.12.21
App validated 05/01/22
Ref: 21/04117/CLC
Additional Archaeology report submitted to LPA, validated 10/08/22
Ref: 22/02595/CLC
Consented 25/02/22
Consented 23/09/22
20 The servicing of commercial unit(s) hereby permitted shall only take place between 0700 and 2000 on any day, including Sundays and Bank Holidays. Informative
21 Prior to occupation a Pedestrian Environment Review Study (PERS), considering the ten Healthy Streets indicators, as set out in the Mayor’s Transport Strategy, 2018 shall be submitted to and agreed in writing by the Local Planning Authority, the findings of which shall be implemented in accordance with timeframes agreed with the Local Planning Authority and thereafter permanently retained.
22 Prior to the occupation of the office, details as to how the approved development has been designed to connect to a future District Heating Network in the surrounding area and provision for the development’s connection shall be submitted to and agreed in writing by the Local Planning Authority and thereafter permanently retained.
23 The development shall be carried out in accordance with details approved pursuant to 22/00463/CLC in relation to Condition 23 (Ecological Management Plan)
Pre occupation condition Milestone Application deposited 17/06/24
Ref: 24/01511/CLC
Decision due 12/08/24
Pre occupation condition MCLH Application deposited and validated 23/11/23
Ref: 23/03103/CLC
Decision due by 16.01.24
Informative
24 Prior to the occupation of development a Delivery and Servicing Management Plan shall be submitted to and approved in writing by the Local Planning Authority.
25 The rating level of the noise determined by the cumulative sound emissions of the plant hereby permitted shall be at least 5dBA lower than the existing background noise level at any given time of operation. The noise levels shall be measured or predicted 1m externally to any window at the nearest residential facade. Measurements and assessment shall be made according to British Standard 4142:2014.
26 The site and building works required to implement the development shall be only carried out between the hours of 08.00
Pre occupation condition Chart Plan/Unilv er/MIlest one
Informative
Informative
Application deposited 17/06/24
Ref: 24/01510/CLC
Decision due: 12/08/24
and 18.00 Mondays to Fridays and between 08.00 and 13.00 on Saturdays and not at all on Bank Holidays and Sundays.
27 The demolition secured through demolition PD Consent 20/02696/PRA and construction works shall be implemented in accordance with details approved pursuant to Condition 27 (Section 61 of Control of Pollution Act 1974).
28 The Development shall be carried out in accordance with the details approved on 08.03.2022 Reference 22/00411/CLC (Air Quality Technical Note Technical Note J13011 F1)
29 All Non-Road Mobile Machinery (NRMM) of net power of 37kW and up to and including 560kW used during the course of the demolition, site preparation and construction phases shall comply with the emission standards set out in chapter 7 of the GLA’s supplementary planning guidance “Control of Dust and Emissions During Construction and Demolition” dated July 2014 (SPG), or subsequent guidance. Unless it complies with the standards set out in the SPG, no NRMM shall be on site, at any time, whether in use or not, without the prior written consent of the local planning authority. The developer shall keep an up to date list of all NRMM used during the demolition, site preparation and construction phases of the development on the online register.
30 Prior to commencement of above ground works on the development hereby permitted, a Damage Cost Assessment in line with the requirements of the GLA Sustainable Design and Construction Practice must be submitted to and approved in writing by the local authority.
31 The development shall be implemented in accordance with the Fire Statement approved under 22/00557/CLC and retained as such for the lifetime of the development.
32 The development shall be carried out in accordance with details approved by 22/03872/CLC on 5th January 2023 regarding the exhaust point to ensure the health and safety of residents nearby.
33 The Development shall be carried out in accordance with the details approved 11.03.2022 Reference 22/00359/CLC (Contamination Ground Investigation Report).
Informative
Informative
Informative
Pre above ground works condition AQ Consultan ts / Chart Plan
Informative
Informative
Informative
App deposited 25/10/22 PP-11645457
Validated Ref: . 22/03432/CLC
Consented 23/01/23
22/03432/CLC
34 Should remedial works be required in relation to contaminated land, the remedial strategy shall be submitted to and agreed in writing by the Local Planning Authority, prior to the commencement of the development works and remedial works. On completion of the agreed remedial works, a closure report and certificate of compliance endorsed by the interested party/parties, shall be submitted to and agreed in writing by the Local Planning Authority, prior to the occupation of the site by end users.
35 If during implementation of this development, contamination is encountered which has not previously been identified, the additional contamination shall be fully assessed and a specific contaminated land assessment and associated remedial strategy shall be submitted to and agreed in writing by the Local Planning Authority before the additional remediation works are carried out. The agreed strategy shall be implemented in full prior to completion of the development hereby approved.
36 Prior to commencement of groundworks (excluding site investigations and demolition), a final detailed drainage design, including drawings, supporting calculations, SuDS Statement and Drainage Assessment Form shall be submitted to and approved in writing by the local planning authority. A detailed management plan confirming routine maintenance tasks for all drainage components must also be submitted to demonstrate how the drainage system is to be maintained for the lifetime of the development. The system shall be implemented and thereafter managed and maintained in accordance with the approved details
37 No building hereby permitted shall be occupied until evidence (photographs and installation contracts) is submitted to demonstrate that the sustainable drainage scheme for the site has been completed in accordance with the submitted details. The sustainable drainage scheme shall be managed and maintained thereafter in accordance with the agreed management and maintenance plan for all of the proposed drainage components
38 Within 6 months of the commencement of any development above ground level, details of waste and recycling facilities to serve the development to which this permission relates shall be submitted to and approved in writing by the local planning authority.
InformativeRemedial works condition
InformativeContamination condition
Pre above groundworks condition
MCLH Application deposited and validated 22/09/22
Ref: 22/03000/CLC
Consented 09/05/23
Pre occupation condition
MCLH Application deposited 25/07/24
Validated 30/07/24
24/01842/CLC
Decision due by 19/09/24
Within 6 months of commencemen t of above
MCLH Application deposited with LPA 07/08/23
Ref: 23/02158/CLC
Validated 09/08/23
Consented 11/10/23
39 The development (including any works of demolition) shall be carried out in accordance with details approved under 22/00306/CLC (Arboricultural Report and Drawings).
Informative
40 The approved protection scheme (Condition 39) shall be implemented prior to commencement of any work on site including demolition, and be maintained to the reasonable satisfaction of the Local Planning Authority until the completion of the development or until such stage as detailed within the approved AMS. Informative
41 The development shall be carried out in accordance with the submitted Flood Risk Assessment (FRA) by Cole Easdon Consultants Limited (dated November 2022; issue no. 2; job no. 8922) and the Design Note by Robert Bird Group titled ‘Flood Volume Attenuation Strategy Clarifications – Updated MSCP’ (dated 02/09/2022; project no. 4881; document no. 4881-RBG-ZZ-XX-DN-CV-87002, issue 02) and the following mitigation measures it details:
Finished floor levels shall be set no lower than 8.8mAOD for more vulnerable residential uses
• Finished floor levels shall be set no lower than 8.4mAOD for less vulnerable commercial uses
• Finished floor levels shall be set no lower than 7.9mAOD for the commercial reception area
• Flood storage mitigation shall be provided • Flood voids shall be installed
These mitigation measures shall be fully implemented prior to occupation and subsequently in accordance with the scheme’s timing/phasing arrangements. The measures detailed above shall be retained and maintained thereafter throughout the lifetime of the development.
Informative
42 The development shall be carried out in accordance with the submitted Interim Flood Storage Scheme detailed within the letter from MNP to the Environment Agency (SV/ib/220051-04; dated 15 February 2021), with the location of the temporary storage amended in the Design Note by Robert Bird Group titled ‘Flood Volume Attenuation Strategy Clarifications – Updated MSCP’ (dated 02/09/2022; project no. 4881; document no. 4881-RBG-ZZXX-DN-CV-87002, issue 02). The car park ramp tank will be implemented at the trigger points specified and remain in perpetuity until the demolition of Lever House is complete
43 Prior to occupation, a maintenance plan to manage the flood voids and grilles over the lifetime of the development will be submitted to, and approved in writing by, the local planning authority in consultation with the Environment Agency. The Plan should cover general maintenance and inspection as well as maintenance after a flood event. The approved management plan will then be implemented in full throughout the lifetime of the development.
44 Prior to occupation, a scheme detailing the flood resistance measures must be submitted to, and approved in writing by, the local planning authority with guidance from the Environment Agency. The scheme should include details on the passive flood barriers up to 8.31 metres above Ordnance Datum (mAOD) to protect: The shared reception of the Hive and Honey Buildings The car park basement access ramp, stairwell and lift lobbies The scheme shall be fully implemented and subsequently maintained, in accordance with the scheme’s timing/phasing arrangements, or within any other period as may subsequently be agreed, in writing, by the local planning authority.
45 Surface water draining from areas of car park hardstanding shall be passed through an oil separator or series of oil separators, prior to being discharged into any watercourse, soakaway or surface water sewer. The separator(s) shall be designed and constructed to have a capacity compatible with the area being
Pre occupation condition MCLH Application deposited 11/07/24
Ref: 24/01739/CLC
Decision due 06/09/24
Pre occupation condition MCLH Application deposited 11/07/24
Ref: 24/01735/CLC
Decision due 05/09/24
drained, shall be installed prior to the occupation of the development and shall thereafter be retained and maintained throughout the lifetime of the development. Clean roof water or vehicle washdowns and detergents shall not pass through the separator(s) and should be drained instead to foul sewer or sealed system.
46 A Car Park Management Plan demonstrating how the use of the car park will be controlled, including any restrictions and detailing the signage necessary within the site to direct pedestrians and vehicles shall be submitted to and approved in writing by the local planning authority before the first occupation of the development. The development shall be carried out in accordance with the approved details.
47 By the time the development hereby permitted is substantially complete, pedestrian/vehicular intervisibility splays of 2.8 m x 3.3 m shall have been provided in each direction where the access meets the back edge of footway, and shall be permanently retained free from any obstruction to visibility higher than 1.0m above ground level.
48 'Within six months of the commencement of the above ground development' details regarding the relocated bus driver welfare facilities on Brook Street, have been submitted to and agreed in writing by the Local Planning Authority. The relocated bus driver welfare facilities shall be delivered in accordance with time frames agreed with the Local Planning Authority prior to development, other than demolition and thereafter permanently retained.
Bus driver welfare facilities will be retained throughout development.
Pre occupation condition MCLH / Occupier NMA application deposited 06/08/24 (See NMA table below)
Within 6 months of commencemen t of above groundworks condition
49 A. The development hereby permitted shall incorporate security measures to minimise the risk of crime and disorder and meet the specific security needs of this development in accordance with Secured by Design Commercial 2015 or its equivalent required security standards. Details of these measures shall be Pre development condition
MCLH Application deposited 03/04/23
Ref: 23/00892/CLC
Consented 31/05/23
MCLH / FHPM / Kabsec App deposited 21/02/22
Validated 22/02/22
Ref: 22/00558/CLC (TRANSIT APPLICATION )*
Consented 28/04/22
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
submitted to and approved in writing by the local planning authority prior to commencement of the development and shall be implemented in accordance with the approved details prior to occupation.
B. As the proposed development is in close proximity to Kingston Town Centre, a crowded place, I would seek that that a blast assessment be completed by a member of the Register of Security Engineers & Specialists (RSES); this is order to determine the appropriate glazing specification for the building(s).
C. Prior to occupation of the offices a Secured by Design accreditation certificate or its equivalent from the Metropolitan Police Design Out Crime Office shall be submitted to and approved by the Local Planning Authority.
D) Prior to the functioning of the multi-story carpark Park Mark Certification is achieved.
49 REVISED
. A. The development hereby permitted shall incorporate security measures to minimise the risk of crime and disorder and meet the specific security needs of this development in accordance with Secured by Design details approved under 22/00558/CLC (other than the car park/ cycle parking proposed in Building C which is superseded by this permission.) Details of the car park/ cycle parking measures shall be submitted to and approved in writing by the local planning authority within 3 months of commencement of above ground works of the car park. The development shall be implemented in accordance with the approved details prior to occupation. B. As the proposed development is in close proximity to Kingston Town Centre, a crowded place, I would seek that a blast assessment be completed by a member of the Register of Security Engineers & Specialists (RSES); this is in order to determine the appropriate glazing specification for the building(s). C. Prior to occupation of the offices a Secured by Design accreditation certificate or its equivalent from the Metropolitan Police Design Out Crime Office shall be submitted to and approved by the Local Planning Authority. D. Prior to the functioning of the multi-storey
Within 3 months post commencemen t of ground works.
(Originally submitted under Planning Consent 20/02499 /FUL – App form sent to LPA to request transfer to this app 19/04/2022) TO BE REVISED AS BELOW
car park, Park Mark Certification is achieved. The development shall be implemented in accordance with the approved details.
50 A retail management plan to include opening hours and the link to the wider occupation of the site shall be submitted to the local planning authority for approval prior to commencement of the use of the Eden St retail units. The retail units shall operate in accordance with the approved management plan.
51 Prior to occupation of the new office building, the woodland walk shall be made available to members of the public in accordance with hours of access and a management plan to be submitted to the local planning authority for approval. The woodland walk shall operate in accordance with the approved details.
52 The car park shall be implemented in accordance with the details approved under 22/03504/CLC dated 29th December 2022.
53 The development shall be implemented in accordance with the details approved on 07.03.2022 under reference 22/00292/CLC (Water re-use/harvesting).
Pre use condition
Occupier Application deposited 26/06/24
Ref: 24/01603/CLC
Decision due: 21/08/24
Pre occupation condition
Occupier Application deposited 17/06/24
Ref: 24/01509/CLC
Decision Due: 12/08/24
Informative
Informative
54 Details shall be submitted to the local planning authority prior to commencement of development to demonstrate how the comprehensive landscaping strategy would achieve the proposed Urban Greening Factor of at least 0.3 within the site. The development shall be carried out in accordance with the approved details prior to occupation of the development.
55 The minimum water consumption targets as per The London Plan 2021, i.e. 105 l/person/day for residential units and a BREEAM rating of ‘Excellent’ for the Wat 01 credits for non-residential uses. It should
Pre development condition
Informative
MCLH Application deposited 03/04/23
Ref: 23/00893/CLC
Consented 22/05/23
be stressed that these are the minimum requirements and need to be improved upon where possible
56 . Air Quality Neutral Assessment: A Damage Cost Assessment using the most up to date damage cost toolkit from Defra and the most recent version of the EFT must be submitted to and approved in writing by the local planning authority within 3 months of commencement of development.
57 The development must be carried out in accordance with the Dust Management Plan Reference 22/00618/CLC approved on 07.03.2022. The applicant must install PM10 monitoring equipment at the site boundary, with exact locations to be determined through discussion with the local authority Environmental Health department.
58 No construction shall take place within 5m of the water main. Information detailing how the developer intends to divert the asset / align the development, so as to prevent the potential for damage to subsurface potable water infrastructure, must be submitted to and approved in writing by the local planning authority in consultation with Thames Water. Any construction must be undertaken in accordance with the terms of the approved information. Unrestricted access must be available at all times for the maintenance and repair of the asset during and after the construction works.
59 Any piling must be undertaken in accordance with the terms of the approved piling method statement approved under 22/00390/CLC.
60 In order to demonstrate compliance with the ‘be seen’ postconstruction monitoring requirement of Policy SI 2 of the London Plan, the legal Owner shall at all times and all in all respects comply with the energy monitoring requirements set out in points a, b and c below. In the case of non-compliance the legal Owner shall upon written notice from the Local Planning Authority immediately take all steps reasonably required to remedy noncompliance. a. Within eight weeks of planning permission being issued by the Local Planning Authority, the Owner is required to submit to the GLA accurate and verified estimates of the ‘be seen’ energy performance
Within 3 months of commencemen t of development condition
Informative
Report to be submitted – No time constraint specified.
Consultan ts App deposited 25/10/22 PP-11645457 Consented 23/01/23
22/03432/CLC
Informative
Various submissions
MCLH Application deposited 05/08/24
indicators, as outlined in Chapter 3 ‘Planning stage’ of the GLA ‘Be seen’ energy monitoring guidance document, for the consented development. This should be submitted to the GLA's monitoring portal in accordance with the ‘Be seen’ energy monitoring guidance. b. Once the as-built design has been completed (upon commencement of RIBA Stage 6) and prior to the building(s) being occupied (or handed over to a new legal owner, if applicable), the legal Owner is required to provide updated accurate and verified estimates of the ‘be seen’ energy performance indicators for each reportable unit of the development, as per the methodology outlined in Chapter 4 ‘As-built stage’ of the GLA ‘Be seen’ energy monitoring guidance. All data and supporting evidence should be uploaded to the GLA’s monitoring portal. The owner should also confirm that suitable monitoring devices have been installed and maintained for the monitoring of the in-use energy performance indicators, as outlined in Chapter 5 ‘In-use stage’ of the GLA ‘Be seen’ energy monitoring guidance document. c. Upon completion of the first year of occupation following the end of the defects liability period (DLP) and for the following four years, the legal Owner is required to provide accurate and verified annual in-use energy performance data for all relevant indicators under each reportable unit of the development as per the methodology outlined in Chapter 5 ‘In-use stage’ of the GLA ‘Be seen’ energy monitoring guidance document. All data and supporting evidence should be uploaded to the GLA’s monitoring portal. This condition will be satisfied after the legal Owner has reported on all relevant indicators included in Chapter 5 ‘In-use stage’ of the GLA ‘Be Seen’ energy monitoring guidance document for at least five years. .
61 The development shall be carried out in accordance with the approved details ref. 22/00622/CLC and maintained as such in perpetuity.
62 The development shall be carried out in accordance with the plans and details approved under 22/03626/CLC (Drinking Water Infrastructure) approved 30/12/22, and drinking water made available to the public for free in accordance with the plans and details prior to occupation of the development, and in perpetuity.
Informative
Informative
63 The measures set out in the Air Quality Positive Statement AQPS approved on 08.03.2022 under reference 22/00412/CLC shall be implemented in accordance with the details so approved, and thereafter retained, unless otherwise agreed in writing by the local planning authority.
64 Prior to the occupation of each building the post-construction tab of the GLA’s whole life carbon assessment template should be completed accurately and in its entirety in line with the GLA’s Whole Life Carbon Assessment Guidance. The post-construction assessment should provide an update of the information submitted at planning submission stage, including the whole life carbon emission figures for all life-cycle modules based on the actual materials, products and systems used. This should be submitted to the GLA at: ZeroCarbonPlanning@london.gov.uk. along with any supporting evidence as per the guidance. Confirmation of submission to the GLA shall be submitted to, and approved in writing by, the local planning authority, prior to occupation of the relevant building
65 The development shall be carried out in accordance with the Ducting Space for Full Fibre Connectivity Infrastructure Plans approved on 07.03.2022 under reference 22/00681/CLC these plans shall be implemented prior to occupation and maintained as such in perpetuity.
66 Prior to the occupation any building, a Post Completion Report setting out the predicted and actual performance against all numerical targets in the relevant Circular Economy Statement shall be submitted to the GLA at: circulareconomystatements@london.gov.uk along with any supporting evidence as per the GLA’s Circular Economy Statement Guidance. The Post Completion Report shall provide updated versions of Tables 1 and 2 of the Circular Economy Statement, the Recycling and Waste Reporting form and Bill of Materials. Confirmation of submission to the GLA shall be submitted to, and approved in writing by, the local planning authority, prior to occupation.
67 Notwithstanding the submitted details, prior to commencement of any above ground development (excluding demolition), details of a
Informative
Pre occupation condition MCLH Timeline NMA deposited 05/08/24 (see NMA table below)
Informative
Pre occupation condition
MCLH Timeline NMA deposited 05/08/24 (See NMA table below)
plant screen on top of Block A and Block B shall have been submitted to and approved in writing by the local planning authority. The approved plant screen shall be installed in accordance with the approved details prior to the occupation of the development hereby approved. t of above ground works
NMA Application deposited re amendments to Building A and B Spandrel Panels
NMA Condition 3 (Facing Materials)
Foot Bridge Link
Deposited with LPA 09/08/23 Ref: 23/02182/NMA Validated 09/08/23
Deposited 25/09/23 Validated 27/09/23 23/02623/NMA
Deposited and validated 03/10/23 Ref: 23/02702/NMA
Consented 07/09/23
Consented 23/04/24
Consented 23/04/24
NMA Condition 1 – Louvre NMA Application validated 03/01/24 Ref: 24/00017/NMA Consented 23/04/24
NMA Condition 18 (Highways) Application deposited 28/06/24 Ref: 24/01621/NMA
NMA Condition 64 (Carbon Assessment – Timeline change) Application deposited 05/08/24
NMA Condition 66 (Economy Statement – Timeline change) Application deposited 05/08/24
NMA Condition 46 (Car Park Management Plan – Timeline Change) Application deposited 06/08/24
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
Item Description
1 Affordable Workspace contribution
The Owner covenants to pay the Affordable Workspace Contribution to the Council prior to Occupation of the Development.
2 Kingston Employment Support Services Contribution Kingston Employment Support Services Contribution" means the sum of £232,000
Index Linked to be paid by the Owner to the Council towards the Council's work match brokerage initiative;
3 Skills Employment and Apprenticeship Plan Contribution. Skills Employment and Apprenticeship Plan Contribution" means the sum of £50,000
Index Linked to be paid by the Owner to the Council towards implementation of the Skills Employment and Apprenticeship Plan.
4 The Owner covenants to submit to the Council for approval a Skills Employment and Apprenticeship Plan –Construction Phase within 3 • 70 employment opportunities for residents of the South London Partnership Boroughs or
£250,000 Prior to Occupation of the development
£232,000, Prior to Commencement of the development. Paid - 6th February 2023
£50,000 Prior to Commencement of the development Paid - 6th February 2023
Pre-Construction SEP & Stakeholder
Allocation sent to LPA 03.07.23
Within 3 month of commencement of the development
Submitted to the Council for approval
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
months of Commencement of the Development to include the following provisions:
students and graduates of the Mayor's Construction Academy.
• 20 apprenticeships for Local Residents.
• Two Local Businesses to be invited to quote for contracts less than £150,000 in value; and
• Not less than 15% of the total value of goods and services procured throughout the construction phase to be procured from Local Businesses or businesses based in Neighbouring Boroughs The Owner covenants to use its best endeavours to comply with the Skills Employment and Apprenticeship Plan –Construction Phase during the construction of the Development PROVIDED THAT the Owner and the Council may agree amendments to the Skills Employment and Apprenticeship Plan – Construction Phase in writing from time to time.
5 Skills Employment and Apprenticeship Plan –Operational phase
6 Carbon Dioxide Emissions Target
7 Carbon Dioxide Offsetting Contribution
Skills Employment and Apprenticeship Plan – Operational Phase" means a plan setting out targets for local employment, skills and training and detailing mechanisms for delivering such opportunities during the operational phase of the Development
Carbon Dioxide Emissions Target” means a 35% carbon reduction against Part L2a of the Building Regulations 2013. 35% carbon reduction against part L2a of the Building Regulations 2013
Carbon Dioxide Offsetting Contribution" means a sum of money (Index Linked)
£60 per tonne for 30 years to be agreed
Within 18 months of commencement of the development.
Following practical completion
Following practical completion
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
calculated on the basis of £60 per tonne for 30 years to be agreed between the Council and Owner (both parties acting reasonably) and paid by the Owner to the Council in the event that the Development cannot achieve the Carbon Dioxide Emissions Target and the shortfall in emissions reduction has not been offset through an accredited scheme or alternative off site off setting has not been agreed with the Council, to be used if payable towards the Council's Carbon Offset Fund which seeks the delivery of carbon dioxide emissions reductions projects within the Royal Borough of Kingston Upon Thames inter alia through retrofit of social housing, schools and civic buildings, investment in renewable energy projects and low-carbon lighting projects;
8 Energy Monitoring Portal “Energy Monitoring Portal” means the ‘Be seen’ webpage of the GLA’s website and the email address ZeroCarbonPlanning@london.gov.uk, or any other such method of submission that may replace this
N/A
To be submitted within 8 weeks of the grant of the Planning Permission
Completed
9 Construction Environmental Management Plan Construction Environmental Management Plan” means the plan to be submitted by the Owner to the Council for approval in accordance with paragraph 15 of Schedule 1; N/A
10 Construction Phase Flood Management Plan Construction Phase Flood Management Strategy" means the measures set out in the flood risk assessment prepared by Cole Easdon Consultants Limited dated November 2020 (issue 5) submitted with the Planning Application and the supplementary letter issued by Mason Navarro Pledge Limited dated February N/A
Prior to Commencement of the Development the Owner shall submit the Construction Environmental Management Plan
The Development shall be constructed and completed in accordance with the approved Construction Phase Flood Management Strategy.
Submitted and approved
Ongoing
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488
T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
2021 attached to this deed at Appendix 2 as the same relate to the Land;
11 Rooftop Garden Management Plan Rooftop Garden Management Plan" means the plan for the provision of managed public access to the Rooftop Garden as may be varied from time to time in writing; N/A
12 Car Park Management Plan "Car Park Management Plan" means a management plan detailing measures for the management of the use of the car park within the Development including restrictions on use of the car park by users other than the occupier(s) of the offices within the Development. N/A
13 Delivery and Service Management Plan
Delivery and Servicing Management Plan” means the plan to be submitted by the Owner to the Council for approval in accordance with paragraph 16 of Schedule 1; N/A
Prior to Occupation of the Development Rooftop Management Plan submitted to LPA 19/06/24
Prior to Occupation of the Development
Prior to Occupation of the Development Action for Unilever
14 District Heating Network “District Heating Network" means a third party district heating network to be developed within the Council's area and which is capable of providing electricity to the Development; N/A DHN rooms provided within Building A and B.
15 Highway and Public Realm Enhancement Works “Highway and Public Realm Enhancement Works" means the highway and public realm enhancements identified for indicative purposes only on the Highway and Public Realm Enhancements Plan N/A
16 TFL Works TfL Works" means the relocation of Transport for London's welfare facility from Brook Street near the corner of Eden Street as shown for indicative purposes only on the Highway and Public Realm Enhancements Plan; N/A
17 Travel Plan Travel Plan” means a full travel plan to be submitted to the Council for approval in consultation with Transport for London pursuant to paragraph 14 of the First Schedule; N/A
Following an agreement pursuant to section 278 of the Highways Act 1980 Discussions ongoing
Within 12 months following first Occupation of the Development Will form part of S278 works
Prior to Occupation of the Development Action for Unilever
Suite 21, High Cedars, 20 Wray Park Road, Reigate RH2 0DD – Registered in England: 5204488 T: 01883 730 877 M: 07843 661 054 E: barry@chartplan.co.uk
18 Woodland Walk Management Plan Woodland Walk Management Plan” means a management plan to be submitted to and agreed by the Council in accordance with paragraph 8 of the First Schedule which shall contain arrangements for management of the Woodland Walk including the management of public access to the Woodland Walk;
Prior to Occupation of the Development Action for Unilever
e outline programme
30/05/2024
09/07/2024
08/01/2024
25/06/2024
02/06/2024
02/06/2024
23/08/2024
20/06/2024
06/09/2024
02/07/2024
17/09/2024
06/08/2024 21/10/2024
09/09/2024 21/10/2024
21/10/2024
18/10/2024
02/12/2024
15/09/2022
15/07/2022
15/09/2022
07/06/2024
Project Honey
Gardiner & Theobald Progress Report at 26 September 2024
General Update
Building fit out continues towards completion and valuations have been broadly in line with anticipated cashflow. Small number of variation costs remain to be agreed to finalise the account.
Activities & Progress in Period
Contractor
Valuation and recommendation no 32 of MCLH works for August 2024.
Finalisation of general & tenant variations
Interface with tenant team
Ongoing dialogue with MACE cost team in relation tenant changes
Reconciliation of viability costs and working to agreement with MACE team
Interface with funder team
None in the period
Cost Status
Gardiner & Theobald Cost Report 27 issued 29 August 2024 and Report 28 to be issued 26 September 2024
Procurement
None in the period.
Design Development
None in the period.
Project Honey
Gardiner & Theobald Progress Report at 26 September 2024
Future Works
Continuing valuation of the works. Valuation 33 due date 7 October 2024.
Agreement of final tenant changes and developer changes.
Agreement of costs with MACE against AFL position.
Prepare & agree CAT A reconciliation.
Information Required
MCLH response to outstanding variations by 26 September
Team
No changes
MCLH update report
1. CDM / Health and Safety
• Construction Phase and Environmental plans are in place and updated as required.
• All risk assessments / method statements and COSHH assessments currently up to date for the work activities on site.
2. List of sub-contractors on site:
• O’Neill & Brennan – Logistics/Waste Management
• Trident – Temporary Electrics & Water
• ATJ – Partitions/Ceilings
• Halsion – MEP
• CMF – Metalwork
• Clarkes – Façade
• AYM – Roofing & Cladding
• Swiftcrafted – Core fit out/Joinery.
• Kingspan – Raised Access Flooring
• Original Joinery – Building C Fit out
• Riney – External Works
• Serna – Cleaning
• Contrasol – Louvres
• Koyda – External Metalwork

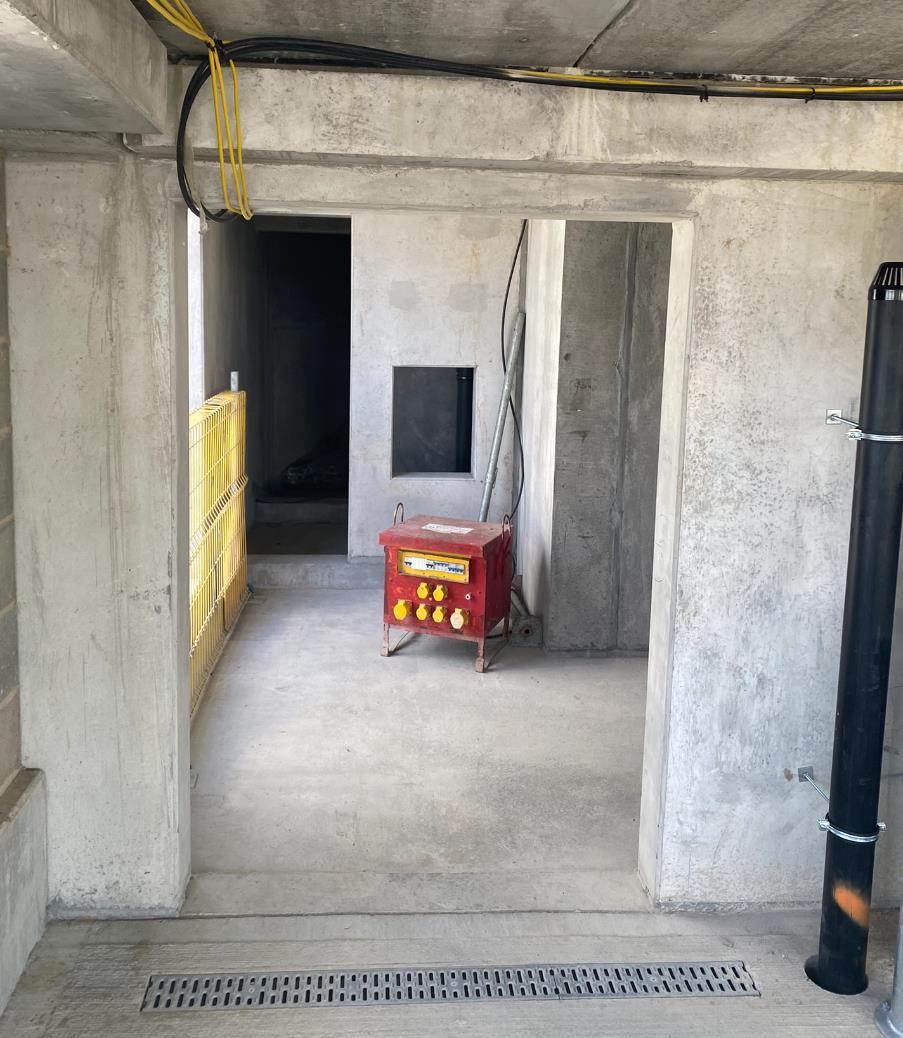

3. Construction Update
• Partitions and ceilings are complete in both blocks
• CAT A - Ceilings complete to all floors (Snagging)
• MEP is progressing up to level 8 building A and complete in Building B
• MEP commissioning ongoing to A and C (B cause and effect now ‘signed off’)
• Clarke Façades currently progressing: Block A: Unitised complete. Equitone ongoing. Revolving doors installed. Block B: Unitised complete. Equitone will be complete this week. Cleaning ongoing.
• AYM Roofing complete on Buildings A, B & C. Paving ongoing.
• Swift crafted progressing with joinery/tiling/vanity units/doors to Building A cores. B complete.
• Car park fit out ongoing.
• Otis have completed Block A & B lifts (excluding final commissioning), Block C ongoing.
• Raised Access Flooring complete in Buildings A&B
• Link bridge unitised installed
• Feature Stair Fire Curtains complete
• Riney external works ongoing
• Last Tower crane removed
• Building B mast climber removed
4. Progress/Programme Dropline
• Block A – 4 weeks behind programme
• Block B – On programme
• Block C – 2 weeks behind programme
5. Lookahead Activities
• Commissioning ongoing to A,B & C
• Building B PC
• Clarkes Façade completion to buildings A & B
• Completion of Lift installations/commissioning
• Building C Fitout complete
• Riney external works ongoing
• Koyda external metalwork complete
6. Key Risk Schedule
• Any Future client variations; MCLH using best endeavours to incorporate recent EAI’s into current programme
• Twin Wall Core impact
• MSCP Provisional Sum
• LFB ‘sign off’
o CAT A Omissions / Temporary Measures – discussions ongoing regarding Building Control
Final Certification
o Building C Façade – LFB submission agreed on current Maple proposal
o Building C Sprinkler Requirements – Insurance Acceptance issued via email from client
• Building Control Certification
o Discussions ongoing with SWECO / Shore regarding Final Cert and Letter of Comfort
o MCLH responded to Shore Comments (12th May 24)
o Final signoff procedure agreed in principle between MCLH, Sweco, Francis Hunter and Mace
o Francis Hunter to instruct Sweco to change inspections to from CAT A to Shell & Core
• Tenant Fit-Out design potentially not aligned with MCLH ER’s / Instructed works (e.g. Modified CAT A / Omissions)
7. Outstanding Instructions/Tenant Variations
• Inspection Procedure for Building Control; change from CAT A to Shell & Core
• EAI 29 Rev 1 to be reviewed and comments updated: Anti Drumming, Reverberation etc
• EOT 3 to be updated – Removal of Early Access Dates Schedule
• EAI 036 Rev1 Structural Penetrations – Client to advise if Building B Roof Penetrations are required. Construction costs/programme impact to be assessed following confirmation
• EAI 116 Building A Post Room Ventilation– Client Team to review Halsion’s design intent. Construction costs/programme impact to be assessed once design intent approved.
• EAI 127 Service Notch – Instruction received, MCLH to issue costs/programme for review
• EAI 144 Service Yard Amendments – MCLH reviewing costs/programme with supply chain
• Omission of S278 Temporary works from MCLH’s scope
8. Site Wide Issues / Matters Affecting Progress
• Twin Wall impact
• Wayleaves
• Water and power connected later than programmed
• S278 works
9. Quality and Environmental
• Environmental plan in place
• Section 61 approved
• CPDs carried out: Pudlo Waterproofing, quelfire (fire collars), CCL (post tensioning), Imperial Ductwork, British Gypsum and Wicona.
BREEAM (Tracker attached)
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
13 Civils & Structures Report
*No report issued
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
15.1 Valuation
- Valuation Nr 33 to be submitted on the 30th September 2024
- Next payment Cert. due on the 10th October 2024
15.2 Projected Final Account
£122,007,723
15.3 Provisional Sums
• Statutory Authorities
£735,000
o £735,000 Omitted (under EAI 063)
o £461,993.51 Addition (under EAI 063)
• Bird Deterrent to Facades £50,000 – to be omitted
• Fibre Backbone Cabling for Wired Score £180,000 (instructed under EAI 132)
• Public Art Works £50,000 (design instructed under EAI 096 & EAI 125)
• Asbestos £5,000 (Omitted under EAI 063)
• Newts, bats & bat roosts, Japanese knotweed and hogweed. £5,000 (Omitted under EAI 063)
• UXO £5,000 (Omitted under EAI 063)
• Cycle Path Works including Green Wall to Carpark £295,000 – (instructed under EAI 031 and EAI 134)
• EAI 001 – BIM Level 2
• EAI 002 – Townhall design feasibility
• EAI 003 – Gym design feasibility
• EAI 004 – Drop kerb
• EAI 005 – S106
• EAI 006 – Townhall & Gym additional piles (only)
• EAI 007 – ASHRAE
• EAI 008 – Below ground drainage
• EAI 009 – CAT A Omission
• EAI 010 – Bridge Link Widening
• EAI 011 – Townhall & Gym
• EAI 012 – MER and SER Loading Design
• EAI 013 – S73 Façade and Plant Screen Amendment Rev1
• EAI 014 – MER and SER Loading Changes - 6th Floor Building B
• EAI 015 – Building B Column Sizes
• EAI 016 – Above Ground Drainage
• EAI 017 – Greywater and Rainwater Design
• EAI 018 – Additional Pile Mat
• EAI 019 – Change in RAL Colours
• EAI 020 – Gym Structural Changes
• EAI 021 – Building C Fees
• EAI 022 – Building A Ground Floor Amendments
• EAI 023 – Signage Design Costs
• EAI 024 – Rainwater Harvesting Tank (Supply Only)
• EAI 025 – CHW and LTHW Design
• EAI 026 – Ventilation Uplift Design
• EAI 027 – Splice Details
• EAI 028 – Green and White Brick Confirmation
• EAI 029 – GRC Alternative
• EAI 030 – Expenditure of FP McCann MSCP Structure
• EAI 031 – Green Wall Design
• EAI 032 – Town Hall Design Amendments
• EAI 033 – Building C Below Ground Obstruction
• EAI 034 – LV Design
• EAI 035 – Domestic Water
• EAI 036 – Structural Penetrations
• EAI 037 - Wicona
• EAI 038 – Rainwater Harvesting Tank
• EAI 039 – New Sewer Connection & Manhole
• EAI 040 – Internal Ramps
• EAI 041 – Townhall Amendments
• EAI 042 – Spandrel Panels
• EAI 043 – Terrace Doors
• EAI 044 – SMART Buildings Design
• EAI 045 – Building A – Slab Penetrations for Future MEP
• EAI 046 – Building B Slab Penetrations
• EAI 047 – MSCP Cast In Channels
• EAI 048 – WC Corridor RCPs
• EAI 049 – Secondary CAT A Omissions
• EAI 050 – CCTV and Access Control Omissions
• EAI 051 – Terrace Finishes
• EAI 052 – Building A and B Spandrels
• EAI 053 – Building C Ramp Ducts
• EAI 054 – Building A Column Sizes
• EAI 055 – Building A Soffit to Retail Entrance
• EAI 056 – Expenditure of Building C Lifts
• EAI 057 – Circleslide Doors
• EAI 058 – Generator Uplift TVR Construction Works
• EAI 059 – Domestic Water TVR Construction Works
• EAI 060 – Gym Floor Design
• EAI 061 – Building B Stair Glazed Screen/Fire Curtain Omission (Levels 1-10)
• EAI 062 – Expenditure of Utilities Prov Sum
• EAI 063 – Omission of Undefined Provisional Sums
• EAI 064 – Service Yard Door
• EAI 065 – Mullion Cover Strips
• EAI 066 – Ventilation TVR Construction Works
Progress Report 29 - 26.09.24
• EAI 067 – LV Panel Enhancement Construction Works
• EAI 068 – Modified CAT A
• EAI 069 – Maple & Halsion MSCP Construction Works
• EAI 070 – Gym Floor Dead Load Increase
• EAI 071 – Omission of Soap Dispensers
• EAI 072 – MSCP Additional Fire Alarm Protection
• EAI 073 – CHW & LTHW Uplift
• EAI 074 – RAL 9010
• EAI 075 – BOH Corridor Ceilings
• EAI 076 – Building A & B Shell and Core Sockets
• EAI 077 – Rainwater Above Ground
• EAI 078 – WC Hand Driers
• EAI 079 – Building B Opening
• EAI 080 – Corian Alternative
• EAI 081 – Building C Packages (Brick, Block, Roof)
• EAI 082 – Bridge Link Design
• EAI 083 – Building A Feature Stair Nosing
• EAI 084 – Omission of Toilet Roll Holders
• EAI 085 – CAT A Temporary Measures
• EAI 086 – Façade Lighting
• EAI 087 – Internal & External Doors (Design)
• EAI 088 – Building B Changing Places (Design)
• EAI 089 – External Louvres (Design)
• EAI 090 – Door Vision Panel Beads
• EAI 091 – Building A & B GF Screed and RAF Omission
• EAI 092 – Building C Planning Approval
• EAI 093 – BREEAM MAN02 Credit omission
• EAI 094 – Building C Fitout and Metalwork Packages
• EAI 095 – Town Hall Intumescent paint
• EAI 096 – Public Art Design
• EAI 097 – Feature Stair Curtains
• EAI 098 – MSCP Access Control/Park Mark/CCTV
• EAI 099 – Blind Box Design
Progress Report 29 - 26.09.24
• EAI 100 – Woodland Walk Widening Design
• EAI 101 – WC Frameless Grilles
• EAI 102 – Omission of Tea Point Fans & Ducts
• EAI 103 – Wiring Accessories
• EAI 104 – Blind Box Construction Rev3
• EAI 105 – Disabled Refuge Phone Recess
• EAI 106 – Public Art Schematic & Connection
• EAI 107 – RAF Omissions
• EAI 108 – Galv Brackets
• EAI 109 – Building A Baby Changing
• EAI 110 – Building C roof Landscaping
• EAI 111 – Building A Level 9 AHU Clash
• EAI 112 – Service Yard Door
• EAI 113 – Building A & B Manifestation
• EAI 114 – Building C Shower Shelf
• EAI 115 – SMART Network Infrastructure
• EAI 116 – BOH Door
• EAI 117 – Building B Changing Places Instruction
• EAI 118 – Access Control Hardware & CCTV Mounts
• EAI 119 – Brook Street Trees
• EAI 120 – Water Reduction
• EAI 121 – Floor Screed
• EAI 122 – Irrigation to Building C
• EAI 123 – RAF Levels
• EAI 124 – Terrazzo Benching (Building C)
• EAI 125 – Public Art Detailed Design
• EAI 126 – MSCP Expenditure (Ext. Doors, Louvres, Vinyl, Cycle Storage)
• EAI 127 – Service Notch
• EAI 128 - Soffit Lighting and Cable Tray Rev 1
• EAI 129 - External Lighting to Car Park Roof Terrace
• EAI 130 - S278 Setting Out
• EAI 132 - Fibre Backbone Cabling
• EAI 133 - Tobermore Paving
Progress Report 29 - 26.09.24
• EAI 134 - Cycle Works Temp Path
• EAI 135 - Water Testing
• EAI 136 - Building B Louvres Construction Rev1
• EAI 137 - Woodland Walk Lighting Ducting
• EAI 138 - Building A Louvres Construction
• EAI 139 - Woodland Walk Lighting R1
• EAI 140 - Ramps and External Works
• EAI 141 - Cancellation of EAI 131 Retention of Temp Services
• EAI 142 - Building C Packages (Firestopping, Channels and Roller Shutter)
• EAI 143 - MSCP Wayfinding Prov Sum (Wayfinding Signage)
• EAI 144 - Service Yard Bollards
• EAI 145 - Cancellation of Building B Louvres
• EAI 146 – Service Notch Construction
15.5 Project Cash Flow
• Cashflow issued on 1st December 22 in line with Townhall Instruction
• Cashflow Rev 1 issued on 8th August 23
• Cashflow Rev 2 issued on 6th February 24
• Cashflow Rev 3 issued on 6th March 24
16 Warranty / Sub-Contract / Appointment Tracker
• See attached
• Key Changes in the period
o Warranties – Francis Hunter have issued client version as a REV E Tracker
o Certified Sub-Contracts
▪ Sub-Sub-Contracts – Awaiting Halsion Sub-Sub Contracts
▪ MCLH to issue any further redacted Sub-Contracts upon signing
17 Procurement schedule
• Key Procurement Complete
18 Commercial and Contractual
• Early Access Protocol
o DRAFT issued to Francis Hunter
o Early Access Protocol meetings ongoing with Overbury & Mace
▪ Early Access not going ahead
Progress Report 29 - 26.09.24
o Point cloud Survey Parameters issued by MCLH
• Early Warnings
o EWN 001 – Brooke Street Closure; issued on 24/03/23
o EWN 002 – Thames Water; issued on 18/10/23
o EWN 003 – UKPN Wayleaves; issued on 19/03/24
o EWN 004 – G99 Application; issued on 02/04/24
o EWN 005 – Thames Water Permanent Connection; issued on 13/06/24
• Relevant Events
o RE 001 – Deferment – EOT 01 issued
o RE 002 – Deferment – EOT 01 issued
o RE 003 – Townhall Design – EOT 02 issued
o RE 004 – Townhall Construction – EOT 3 issued
o RE 005 – Smart Buildings – EOT 4 issued
o RE 006 – Thames Water Connection – EOT 5 issued
o RE 007 – UKPN Wayleaves – EOT 5 issued
Progress Report 29 - 26.09.24

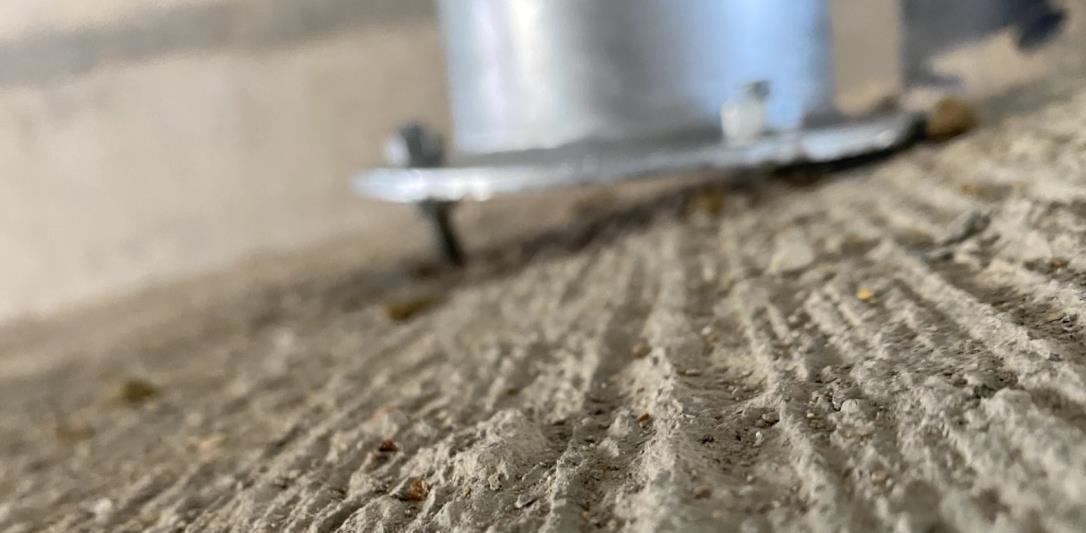

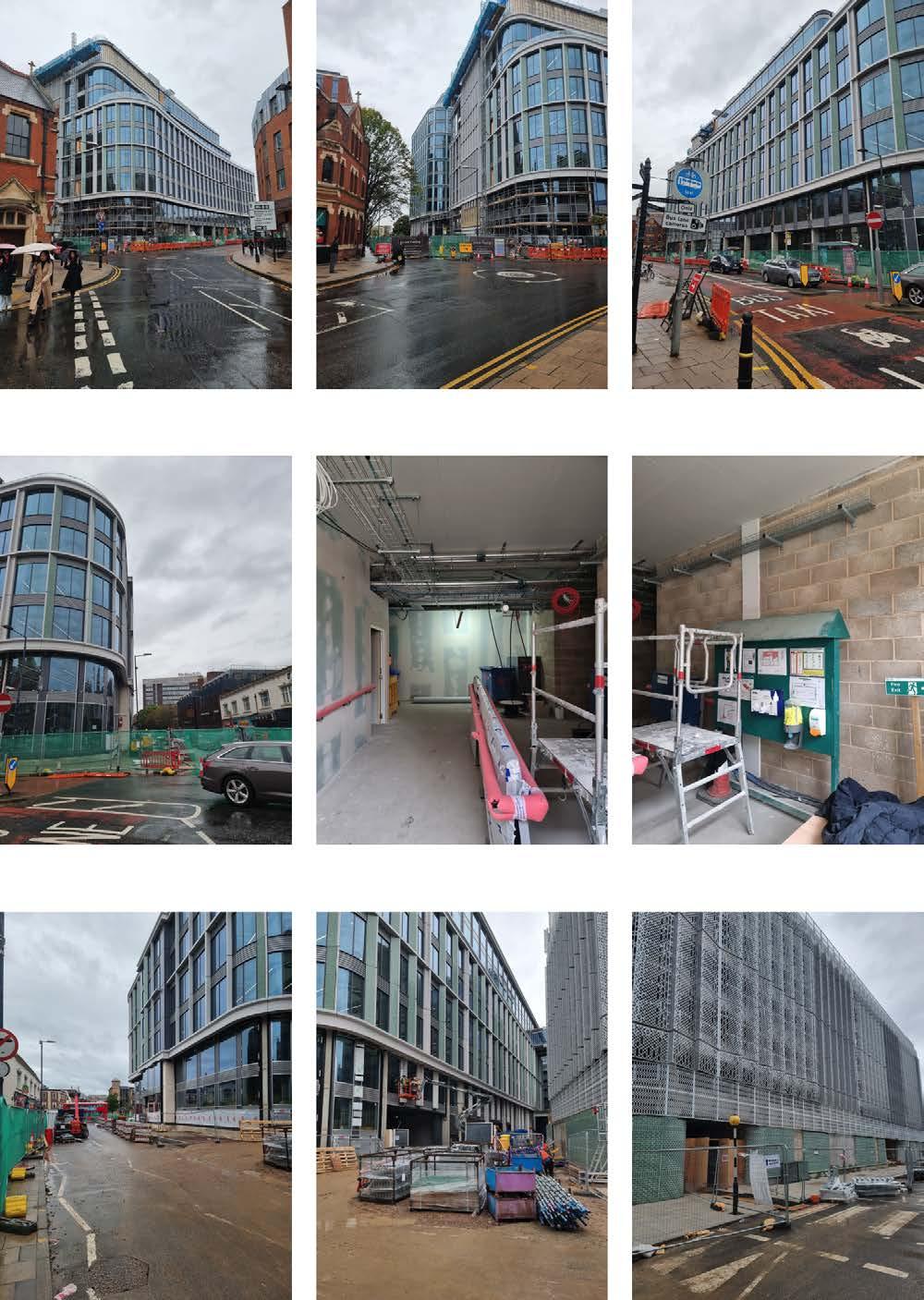

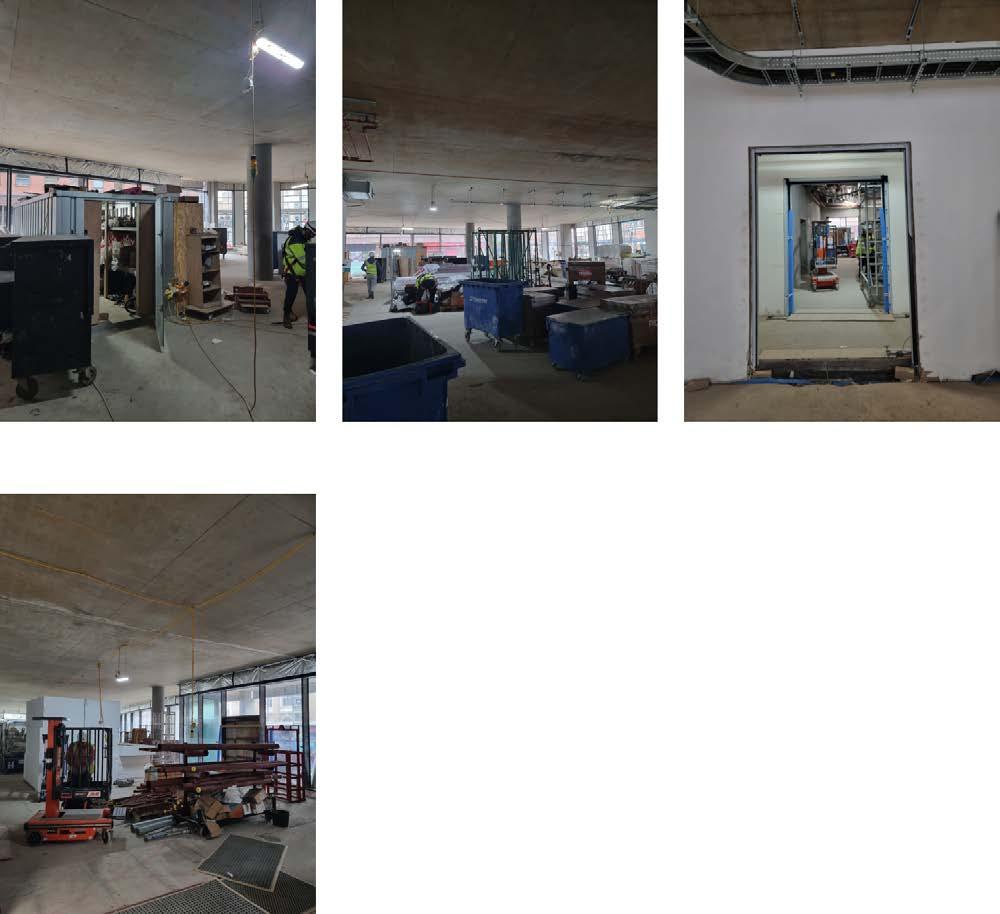

Progress Photos
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
Report 29 - 26.09.24
Progress Report 29 - 26.09.24
Progress Report 29 - 26.09.24
Please
Training,
Monitoring
principal contractor. The principal contractor analyses these items.
Draft letter template under review with McL&H - please sign and send back
Early stage site activity: CLOCS and CCS accreditation being sought by McL&H certificate of compliance and 1st CCS repor issued, performance on track.
Draft letter template under review with
McL&H has registered the site with SMARTWaste - this is the confirmed method for monitoring and reporting energy and water consumption
PLEASE CONTINUE TO PROVIDE MONTHLY UPDATES AND AN UPDATED REPORT ON COMPLETION OF PROJECT
Draft
Transport impacts must be monitored. This information must be recorded in SMARTWaste (or similar) for credit to be targeted.
PLEASE ENSURE THIS IS MONITORED AND PROVIDE MONTHLY UPDATES AND AN UPDATED REPORT ON COMPLETION OF PROJECT
A copy of the architectural acoustic and BS reports confirm that the requirements are being targeted.
SQA has provided confirmation proposed design is expected to achieve indoor ambient noise levels that comply with the design ranges given in Section 7 of BS 8233:2014.
McLH - confirmation has been provided SQA is appointed to provide this post-completion review. McLH to provide written confirmation as per letter template.
Marked-up
McL&H
Proposed plan to be discussed:
Dedicated and safe cycle paths are provided from the site entrance to any cycle storage, and connect to offsite cycle paths where applicable.
Adequate external lighting in accordance with BS 5489-1:2013 Lighting of roads and public amenity areas.
2. Appropriate sized, designed and constructed. The following publications offer guidance on how to demonstrate this:
a. Local transport Note 2/08 Cycle infrastructure design, Department of Transport, 2008. b. Sustrans design guidance (www.sustrans.org.uk), specifically the Sustrans design manual handbookfor cyclefriendly design
Dedicated and safe footpaths are provided on and around the site providing suitable links for the following:
a The site entrance to the building entrance
b Car parks (where present) to the building entrance
c The building to outdoor space
d Connecting to off-site paths where applicable.
Pedestrian drop-off areas are designed off, or adjoining to, the access road and should provide direct access to other footpaths.
Where vehicle delivery access and drop-off areas form part of the assessed development, the following apply: Delivery areas are not accessed through general parking areas and do not cross or share the following: a pedestrian and cyclist paths b outside amenity areas accessible to building users and general public.
There is a dedicated parking or waiting area for goods vehicles with appropriate separation from the manoeuvring area and staff and visitor car parking.
Parking and turning areas are designed for simple manoeuvring according to the type of delivery vehicle likely to access the site, avoiding the need for repeated shunting.
Specifications
Watt AND All external light fittings are automatically controlled for prevention of operation during daylight hours and presence detection in areas of intermittent pedestrian traffic.
The above requirements include decorative & floodlighting.'
Emergency light fittings, including security lighting, that are also used for normal operation are assessed for this issue - please confirm if this will be the case.
External lighting drawings still to be provided confirming compliance with requirements.
Please obtain appropriate confrimation and spec and drawings from external lighting designer.
LZCT feasibility study has been
Specified local LZC technologies for the building have been shown in line with the feasibility study recommendation.
The reduced regulated carbon dioxide (CO ₂ -eq) emissions have been reported.
Copies of Part L received. energy specialist - Patel Jayesh, CIBSE reg.
3
2
1
Schenatics
Water
1.a
supply and the buildings under assessment.
2 The leak detection system is:
2.a A permanent automated water leak detection system that alerts the building occupants to the leak OR an inbuilt automated diagnostic procedure for detecting leaks
2.b Activated when the flow of water passing through the water meter or data logger is at
2.c
high or low level, over set time periods. Although high and low level leakage rates are not specified, the leak detection equipment installed must have the flexibility to distinguish between different flow rates to enable it to be programmed to suit the building type and owner's or occupier's usage patterns.
2.d Programmable to suit the owner's or occupier's water consumption criteria
2.e Where applicable, designed to avoid false alarms caused by normal operation of large water consuming plant such as chillers.
Where there is physically no space for a leak detection system between the utilities water meter and the building, alternative solutions can be used, provided that a major leak can still be detected.
Schematics have been provided confirming presence.
Leak detection - Page 334 clause M1-7 - Please provide additional specifications details: 1.a On the utilities water supply within the buildings, to detect any major leaks within the buildings AND
1.b Between the buildings and the utilities water supply, to detect any major leaks between the utilities
2 The leak detection system is:
2.a A permanent automated water leak detection system that alerts the building occupants to the leak OR an inbuilt automated diagnostic procedure for detecting leaks - PLEASE CONFIRM
2.b Activated when the flow of water passing through the water meter or data logger is at a flow rate above a pre ‐set maximum for a pre ‐set period of time. It does not necessarily require a system that directly detects water leakage along part or the whole length of the water supply system
2.c Able to identify different flow and therefore leakage rates, e.g. continuous, high or low level, over set time periods. Although high and low level leakage rates are not specified, the leak detection equipment installed must have the flexibility to distinguish between different flow rates to enable it to be programmed to suit the building type and owner's or occupier's usage patterns.
2.d Programmable to suit the owner's or occupier's water consumption criteria
2.e Where applicable, designed to avoid false alarms caused by normal operation of large water consuming plant such as chillers.
Template
Certs being
Calculation is underway.
DAA has
review and assessment additional narrative has been provided in addition to the drawings issued.
Confirmation design provides adequate protection for exposed parts of the building from material degradation.
Drawings and strategy confirm and demonstrate i) there is convenient access to the roof and façade for costeffective cleaning, replacement and repair in the building's design and ii) the roof and façade has been designed to prevent water damage, ingress and detrimental ponding
Progess is on-going. - report has been updated to include Technical Design Stage. consider methods that have been adopted that aim to optimise the use of materials to cover all of the following stages:
a. Preparation and Brief (e.g. re-use, adaption and expansion of existing building / services, need for flexibility and adaptability etc.)
b.
Please
This
of overheating
- Ene 01 approach, Maximise energy efficiency to tackle energy demand
- Ene 04 approach, passive design - Maximise opportunities to avoid unnecessary carbon emissions
- Mat 05 approach - durability and resilience - Avoid increased risks of deterioration and higher maintenance demands
- Pol 03 - Minimise the risks of increased flood risk and surface water run-off affecting the site or others Conduct
Ecological value of site
Site survey:
A Suitably Qualified Ecologist (SQE) carries out a survey and evaluation for the site early enough to influence site preparation works, layout and, where necessary, strategic planning decisions (typically Preparation and brief stage) .
The SQE’s survey and evaluation determines the site’s ecological baseline, including:
a Current and potential ecological value and condition of the site and related areas within the Zone of Influence.
b Direct and indirect risks to current ecological value from the project.
c Capacity and feasibility for enhancement of the site's ecological value and, where relevant, areas within the Zone of Influence.
Recommendations and data collected from the survey and evaluation are shared with appropriate project team members to influence decisions made for activities during site preparation, design and construction works, which can support ecological features.
Determining ecological outcomes:
The project team liaise and collaborate with representative stakeholders early enough to influence key planning decisions (typically Concept Design stage), to:
a Identify the optimal ecological outcomes for the site.
b Identify, appraise and select measures to meet the optimal ecological outcomes for the site, in line with the mitigation hierarchy of action, according to the route being used:
1. Avoidance
2. Protection
3. Reduction or limitation of negative impacts
4. On site compensation and 5. Enhancement, considering the capacity and feasibility within the site, or where viable, offsite. 2
LE 02's 'Survey and evaluation and Determining ecological outcomes’ criteria have been achieved.
1 credit: Further planning to avoid and manage negative ecological impacts on-site is carried out early enough to influence the concept design and design brief as well as site preparation planning (typically Concept Design stage). On-site measures for managing negative ecological impacts during site preparation and construction are implemented inpractice.
The above is based on input from the project team in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02 Ecological risks and opportunities
1 or 2 credits: Achieve 1st credit.
Negative impacts from site preparation and construction works are managed according to the mitigation hierarchy: No overall loss of ecological value has occurred (two credits).
OR The loss of ecological value has been minimised (Minimising Loss) (one credit)
where this is not feasible, b Off site within the Zone of Influence.
Data collated are analysed and where potentially valuable, provided to the local environmental records centres nearest to, or relevant for, the site 1 1 Feb-23
A copy of the ecology report has been provided and confirms site is of low ecological value.
Written confirmation required from Landscpae architect: - that the ecologist report was received at an early enough stage to help inform the landscaping and ecological enhancement strategy
- that the project team liaised and collaborated with representative stakeholders early enough to influence key planning decisions (typically Concept Design stage), to:
a Identify the optimal ecological outcomes for the site.
b Identify, appraise and select measures to meet the optimal ecological outcomes for the site, in line with the mitigation hierarchy of action:
1. Avoidance
2. Protection
3. Reduction or limitation of negative impacts
4. On site compensation and 5. Enhancement, considering the capacity and feasibility within the site, or where viable, offsite.
Ecologist has visited site and confirms compliance is being met.
McL&H to sign and return letter template, confirming below
One credit – Planning and measures on-site
Further planning is required to be carried out for activities during site clearance and construction. McLH to confirm mitigation strategy - requirement for On-site measures for managing negative ecological impacts during site preparation and construction are implemented in-practice (e.g. mitigation measures to protect existing ecological features), as per ecologist recommendations.
Two credits Managing negative impacts the following hierarchy must be followed when managing negative impacts of the site preparation and construction works:
– Avoidance of negative impacts on habitats and features of ecological value on the site.
– If it is not possible to avoid negative impacts completely; protect habitats and features of ecological value from damage during development works in accordance with best practice guidelines to minimise negative impacts.
- If it is not possible to achieve the above, fully reduce, limit or control negative impacts as far as possible
- Where it is not possible for avoidance, protection, limitation or control of the negative impacts on features of ecological value on site; compensation has taken place to ensure the existing ecological value is maintained during and after the project.
This builds on the measures agreed for delivering optimal ecological outcomes in LE 02 Ecological risks and opportunities.
Commit to ensuring measures are implemented that enhance ecological value, which are based on input from the project team and SQE in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02.
This issue intends to recognise enhancement measures that have been carried out in line with good practice recommended by an SQE, which build on mitigation measures taken in LE 03. enhancement measures must meaningfully enhance the site's ecological value - it would be benefical to discuss and agree this with input from the SQE.
McLH - please complete letter template - written confirmation compliance will be monitored against all relevant UK, EU or international legislation relating to the ecology of the site, as per SQE recommendation and that measures will be implemented as per SQE recommendations.
Landscape architect - please confirm final design. ecologist has deemed current proposals appropriate.
Three credits are to be targeted and will be awarded based on the change in ecological value occurring as a result of the project. This must be calculated in accordance with the process set out in GN36 - BREEAM, CEEQUAL and HQM Ecology Calculation Methodology – Route 2. Credits are awarded in line with the Reward Scale table in GN36 where there are no residual impacts on protected sites or irreplaceable habitats.
Biodiversity metric confirms significant net gain.
Pre-requisite
The client or contractor has confirmed that compliance is being monitored against all relevant UK, EU and international standards relating to the ecology of the site.
Comprehensive route (Route 2) - Criterion 8 in LE 03 has been achieved (Negative impacts from site preparation and construction works have been managed according to the mitigation hierarchy, in line with the SQE's recommendations) and at least one credit under LE04 for 'Change and Enhancement of Ecology' has been awarded.
Measures have been implemented to manage and maintain ecology throughout the project. These measures are based on input from the project team in collaboration with representative stakeholders and data collated as part of the ‘Determining ecological outcomes’ in LE 02 To ensure the optimal ecological outcomes agreed in LE 02 are met in-practice, these measures must monitor and review the effectiveness of the mitigation and enhancement measures in place for LE 03 & LE 04 to ensure they are implemented.
Management and maintenance throughout the project
- Contractor nominates biodiversity champion - Contractor trains the site workforce on how to protect site ecology during the project - Contractor records actions taken to protect biodiversity and monitor their effectiveness A new ecologically valuable habitat appropriate to the local area is created
- Where flora and/or fauna habitats exist on-site, the contractor programmes site works to minimise disturbance to wildlife
A section on Ecology and Biodiversity has been included as part of the tenant or building owner information supplied, to inform the owner or occupant of local ecological features, value and biodiversity on or near the site. This should include detailed management and maintenance plans as required by landscape and asset managers as well as relevant parts of the handover information for occupiers written in a format that encourages understanding and supportive behaviours 1 1
Contractor to confirm compliance will be monitored against all relevant UK, EU and international standards relating to the ecology of the site.
McLH to please confirm measures will be implemented to manage and maintain ecology throughout the project - as per letter template.
For brownfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) shows a 30% improvement for the developed site compared with the predeveloped site. This should comply at the 1-year and 100-year return period events.
For Greenfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) is no greater for the developed site than it was for the pre-development site. This should comply at the 1-year and 100-year return period events.
Relevant
Surface water run-off rate calcs have been provided for 1-year and 100-year.
Calculations appear to demonstrate that a 40% allowance for climate change has been provided.
Written summary confirmation has been provided demonstrating compliance can be met: Confirmation that surface water run-off design solutions are bespoke, i.e. they take account of the specific site requirements and natural or man-made environment of and surrounding the site. Please confirm the priority levels detailed in BREEAM have been followed, with justification given where water is allowed to leave the site. For brownfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) shows a 30% improvement for the developed site compared with the predeveloped site. This should comply at the 1-year and 100-year return period events. OR For Greenfield sites, drainage measures are specified so that the peak rate of run-off from the site to the watercourses (natural or municipal) is no greater for the developed site than it was for the pre-development site. This should comply at the 1-year and 100-year return period events.
Please confirm calculations and reports are for both buildings, noted Building A and Building B on the submitted drawings.
Please confirm maintenance agreements for the ownership, long term operation and maintenance of all specified Sustainable Drainage Systems (SuDS) are in place.
Calculations have been provided.
Calculations and reports are for both buildings, noted Building A and Building B on the submitted drawings.
Flooding of property will not occur in the event of local drainage system failure (caused either by extreme rainfall or a lack of maintenance); AND EITHER
Drainage design measures are specified so that the post-development run-off volume, over the development lifetime, is no greater than it would have been prior to the assessed site’s development. This must be for the 100year 6-hour event, including an allowance for climate change.
Any additional predicted volume of run-off for this event is prevented from leaving the site by using infiltration or other SuDS techniques.
OR (only where criteria above cannot be achieved):
Justification from the appropriate consultant indicating why the above criteria cannot be achieved, i.e. where infiltration or other SuDS techniques are not technically viable options.
Drainage design measures are specified so that the post-development peak rate of run-off is reduced to the limiting discharge. The limiting discharge is defined as the highest flow rate from the following options:
a.The pre-development one-year peak flow rate
b. The mean annual flow rate (Qbar)
c. 2L/s/ha.
For the one-year peak flow rate, the one-year return period event criterion applies.
For either option, above calculations must include an allowance for climate change; this should be made in accordance with current best practice planning guidance.
Please also confirm relevant maintenance agreements for the ownership, long term operation and maintenance of all specified SuDS are in place.
To: FrancisHunter – Luke Nurser
CC: meeting distribution
Report up to 26/09/2024
1. Key Actions in Month
1.1 Follow up on responses on power on & HV/LV switchrooms comments
1.2 Site visit continues.
1.3 Commissioning report meetings
1.4 Benchmark inspections as part of Site Visit Report.
2. Status of Document Submittals
AECOM Sunley House 4 Bedford Park Croydon CR0 2AP, UK T +44(0)203 043 9200 aecom.com
Project name: Project Honey - Kingston Project ref: 60627560
By : D Emerson
Date: 26/09/24
2.1 Schedule of o/s comment received - Comments issued on submittals as per MCLH notes of review.
3. Any key issues / comments / quality issues related to site/Test activities
3.1 Snags collated on MCLH list.
3.2 Comments raised on power on & HV/LV rooms – copy of relevant supporting documents awaited.
4. Key actions for next month
4.1 Review of o/s package comments to be submitted as per MCLH list
4.2 Continue schedule of visits.
4.3 Agreement on close out process
4.4 Comments on paperwork re HV/LV switchrooms
5. Key decisions required / variations
5.1 Commissioning / demo and completion programme.
6. Any CDM issues
6.1 n/a
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
No. of CMR site visits to date: 20
MNP last attended site on 13th August 2024.
• This report covers a period of two months from July to September 2024.
• We have attended site at the request of FHPM to review again the car park snagging matters and find that issues raised in previous site reports are still live At the time of inspection (13th Aug), water ingress and seepage were still live issues and car park remediation items picked up in earlier reports remain unresolved. We do not issue a stie report – but instead refer to previous reports. Sample photos are presented in this report for information.
• We have requested clarification on the design responsibility of parties involved in the car park design and the accepted car park product so we can clearly differentiate between snagging matters and subjection matters relating the product quality. It is important to focus on resolving snagging matters and to clearly define the level of finishes and quality of the car park structure.
• A proposed remediation to corroding Steel Delta Beams in the car park has been proposed by McL&H. The solution involves sealing the steel. We have not accepted this as it will trap in water in the current state. We have accepted the information presented to confirm the embedded beam is protected by concrete. The water issue must be resolved before the remediation design can be accepted, and there needs to be acceptance by all that period maintenance may be required if this is part of the proposal.
• We have been active in reviewing and closing the matter of low concrete cube test results in Office Blocks A and B. We have now reached agreement with the RBG and McL&H position that the ERs have been met and the concrete is of the required quality. The final part of the close out was to receive confirmation that the PT designer had checked punching shear with a lower grade of concrete, and we now have confirmation that this is the case.
Site Photographs 13th August 2024
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26 26th September 2024

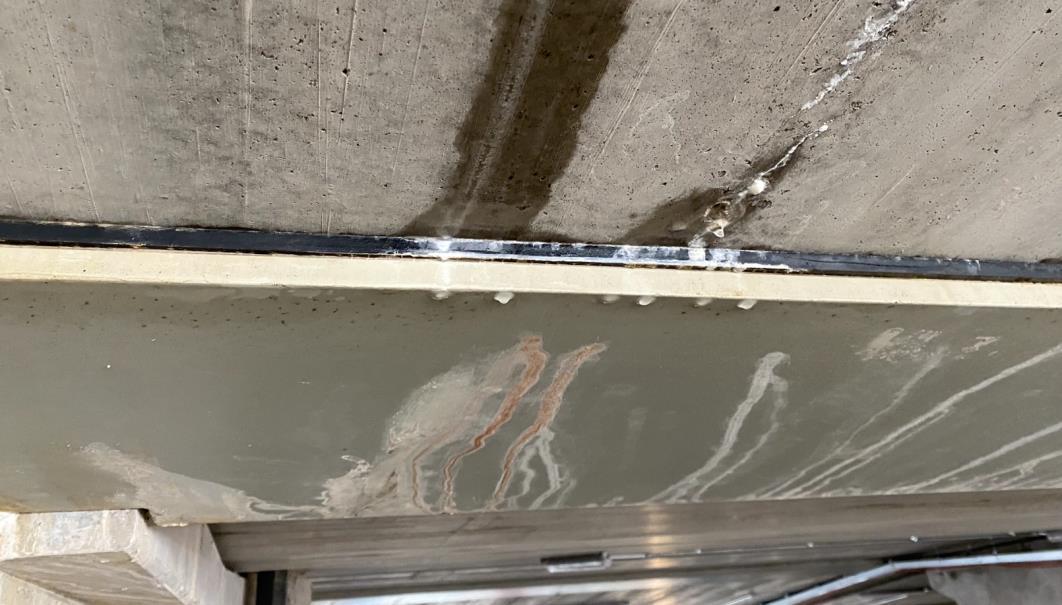

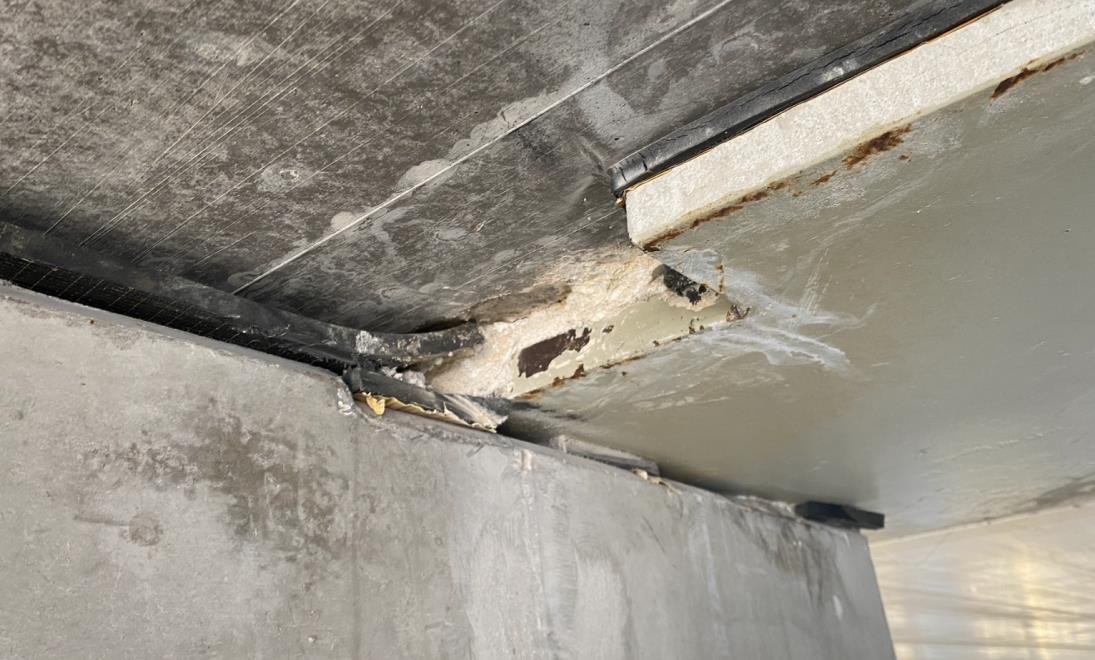

Repair to be reinstated
Grout required under ramp post
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26 26th September 2024
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
The following packages have been reviewed, blue items within this period. Refer to Appendix B: Technical Submission Tracker.
• Attenuation product data sheet (ahead of final design information)
• Piling Specification – RBG
• Piling Package – Van Elle
• RBG Loading Plans
• RBG Building A Superstructure GAs (design still in progress)
• RBG Building B Superstructure GAs (design still in progress)
• RBG Building C Substructure (in progress)
• RBG Drainage
• RBG Building A and B Pile-caps
• RBG Building C Piling
• RBG Block B revised loading plans
• RBG Block B Foundation Revision
• RBG Block B L10 Revision
• McL&H Benchmark Columns
• RBG Block A Core Plans
• RBG Block B Core Plans
• RBG Block C Drainage
• RBG Block A Townhall Steelwork
• RBG Block C Drainage
• RBG Blocks B and C Cores
• RBG Block A L06 amendment
• RBG Block A,B,C concrete cube report
•
Implementation of the Contractor’s Quality Control Systems in relation to ERs and Building Contract We can confirm that the design development and/or construction work carried out to date has been regularly inspected/reviewed by the Contractor in this period of reporting
We list any suspected defective work and recommend procedures for remedial action including, where necessary, a regime of testing or exposure. Refer to Appendix A: Site observations tracker.
Report on current status of local authority and other statutory approvals relating to Civil and Structural Engineering. Discharge of reserved planning matters or conditions. We report in reference to Eden Campus Conditions Matrix (Chartplan) tracker dated 23/08/2023 Refer to Appendix C: Planning conditions tracker. There has been no change to status of conditions since this date.
Approval of Building Regulations submissions and discharge of any conditions hereto.
• All building control approvals are recorded in the McL&H monthly contractor’s report.
Comment on satisfaction of Building Inspector’s routine inspections.
• No Building Regulation Inspection Reports are known to have been submitted.
MNP has not become aware in carrying out its duties under the Appointment and/or this deed that any of the materials or substances referred to in clause 6 of this agreement (Prohibited Materials) are being or has been used in the Development.
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
1 22.07.22
Demolition of the NCP car park is approaching the shared foundation with Lever House. Discussions with the demolition contractor on site indicated that the presence of the shared foundation may not be well understood
2 24.08.22 Demolition of the NCP car park is approaching the shared foundation with Lever House. McL&H and RGB attending site to monitor demo works in vicinity of shared foundation.
The demolition contractor is to demonstrate by RAMS how the works in the vicinity of the shared foundations are to be controlled and the main contractor team is to put in place controls to ensure that the Lever House foundation is protected.
3 20.10.22 No additional comments to make No additional comments to make
4 28.11.22
Rebar cage in Block B central core pile has displaced
5 28.11.22 Rebar to top of Block A pile cap appears to be set lower than the cover zone.
6 11.01.23
Excavation close to Brook St bus stops. MNP discuss temporary stability of berm on site with McL&H who confirm temporary stability has been discussed with RBG and earth is stable
7 11.01.23 MNP / McL&H review Field View Quality system in site office.
8 21.02.23 Column rebar arrangement in a Block A column. Lower start bars set inboard of cranked bar..
9 24.02.23

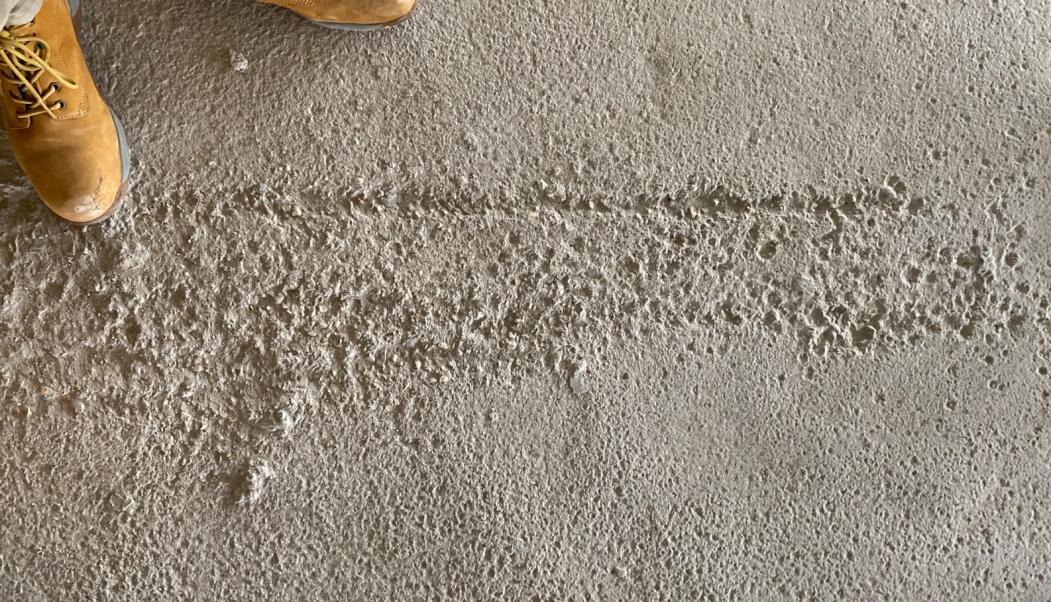

Block A L01 slab soffit – rebar marking and grout leakage at day joints.
10 24.02.23 Block A L01,L02 slab soffit – Most of the soffit is very good but some areas of poorer finish are emerging.
Check the cover on the pile is as required to ensure durability meets the ERs. (Reviewed May 2024) - McL&H and Van Elle to comment.
Check the cover over the rebar cage is as expected and that it complies with the design intent, and controls cracking.
No additional comments to make
Good QA/QC systems in place. No additional comments to make.
McL&H asked to check rebar arrangement is as required and log via field view.
McL&H to check rebar pattern is not associated with low cover (it looks like staining only from rebar stored on the shutter). McL&H to comment as to whether the staining will be removed and to review shutter cleaning near rebar stock pile locations. (Reviewed May 2024) - McL&H to comment.
McL&H to comment on how marking can be avoided by the subcontractor in the future. Check ply liners are not damaged and are cleaned. 11 24.02.23 Block A L02 Column – Grout leakage from slab at head and blow holes require repair.
To be addressed prior to offering for inspection. Agree repair with client by establishing benchmark for repaired column. We recommend grout at head of column is removed by slab follow up team after shutters are removed to limit staining potential.
Block A L02 lift lobby. Grout
To be addressed prior to offering for inspection. Recommend establishing a benchmark area at an earlier stage to set expectations for exposed concrete finish.
To be reviewed and discussed with concrete contractor to ensure quality of finishes can be achieved by the follow up team
McL&H to please confirm this sequence is as used in the temporary loading calculations and long-term creep calcs. (Reviewed on site May 2024) - McL&H / CCL to comment.
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
19 30.08.23
20 30.08.23
21 03.10.23
22 03.10.23
23 03.10.23
24 03.10.23
25 03.10.23
26 23.10.23
Plywood closures have been fitted to the flood void entry points to prevent vermin entering the voids. The flood void is therefore closed.
Block C Ramp Tie pars have been cold worked and do not align with topping / tie slots in PCC
Block C – Overspill concrete in flood void to be removed
Block C – Use of PT tendon as tie bar through Delta Beams
Block C – Damage to PCC elements to be repairs prior to handover to McL&H for snagging
Block B – L09 slab construction joint – remove laitance form shutter prior to pour
Block B – Core door enlargement – cover protection to be added
Block A – Steel beams in Town Hall are propped with two floors of RC cast above
27 23.10.23 Block A – L6 slab soffit appears to be very wet so looks highly variable
Does this affect the flood performance of the site during the works? Could there be adverse comment from the EA?
Post 3/10/23 visit – suggest McL&H simply have a policy to remove covers in the case that the site is shut down through a flood event.
McL&H to review and advise how the tie bars will be resolved. (Reviewed on site May 2024) - McL&H to comment.
McL&H confirmed this has been completed (May 2024) –SV meeting on site.
McL&H to review and confirm this is as the required tie detail. (Reviewed on site May 2024) - McL&H to comment.
McL&H confirmed on site that this will happen. Snagging will on be when the PCC formally offers the system. (Reviewed on site May 2024) - McL&H to comment.
McL&H confirmed on site that this in on their snagging schedule
McL&H confirmed on site that this in on their snagging schedule. (Reviewed on site May 2024) - McL&H to comment.
McL&H to confirm TW release strategy to avoid ‘shocking’ the concrete structure above when steel deflects.
Assumed to be storm related – MNP to inspect when dry
have
and
A roof slab soffit – very poor finish
have
to confirm if this is to be treated. (Reviewed on site May 2024) - McL&H
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
43 15.05.24 Block C – Widespread construction defects to be made good as part of final follow up snagging / clearing operations including;
• Water staining to concrete (laitance / stains)
• Damaged PCC with exposed rebar
• Misaligned PCC units
• Untidy concrete repairs
• Making good to joints required
• Steel delta beams corroded and wet
• Steel ledger angled to L08 roof paint required update – rust appearing
• Permanent edge protection to be installed
• Debris in PCC joints
• Voiding in cored concrete to be made good
• Exposed rebar in top of L00 ramp slab
• Block work pointing incomplete
• Temporary bunds to lifts to be removed
• Uneven surface in fire escapes
McL&H to resolve all to final snagged state prior to final inspection. There is work to do.
44 15.05.24 Damaged masonry walls – vehicle strikes. Rebuilt damaged walls. McL&H to arrange rebuilt of damaged walls.
Client Monitoring Report Civil & Structural Engineering Monthly Progress Report – Report 26 26th September 2024
Client Monitoring Report Civil & Structural Engineering
Monthly Progress Report – Report 26
26th September 2024
Pending release of final tracker by FHPM/DAA
8. All works on site shall take place in accordance with…details which shall have…been submitted…in the form of a Demolition and Construction Environmental Management Plan.
9. The levels of buildings, roads, parking areas and pathways within the site shall… have previously been submitted to and approved in writing by the LPA before development is commenced.
10. Prior to the commencement… a Site Waste Management Plan/Circular Economy Statement shall be submitted…and approved in writing by the LPA.
14. Hard surfaces … shall be made of porous materials and … retained thereafter to direct run-off water … to a permeable or porous area or surface within the curtilage of the property.
19. The development shall be carried out in accordance with the details approved on 25.02.2022 Reference 21/04117/CLC (Written Scheme of Investigation WSI - Archaeology).
23. The development … shall not be commenced until a detailed Ecological Management Plan has been submitted …and agreed in writing by the LPA.
34. Should remedial works be required in relation to contaminated land, the remedial strategy shall be submitted to and agreed in writing by the LPA, prior to the commencement of the development works and remedial works. On completion of the agreed remedial works, a closure report and certificate of compliance endorsed by the interested party/parties, shall be submitted to and agreed in writing by the LPA, prior to occupation.
35. If during implementation, contamination is encountered, it shall be fully assessed and a contaminated land assessment and remedial strategy shall be agreed by the LPA before the additional remediation works are carried out. The strategy shall be implemented prior to completion of the development.
36. Prior to commencement of groundworks (excluding SI and demo), a final detailed drainage design, including drawings, calculations, SuDS Statement and Drainage Assessment Form shall be submitted to and approved by the LPA. A detailed management plan must also be submitted for the lifetime of the development.
37. No building shall be occupied until evidence is submitted to demonstrate that the SuDS scheme has been completed in accordance with the submitted details. The SuDS scheme shall be managed and maintained in accordance with the agreed management and maintenance plan
41 The development shall be carried out in accordance with the submitted FRA by Cole Easdon (ref: 7378, issue no.5; dated November 2020) and the following mitigation measures:
FFL no lower than 8.8mAOD for more vulnerable residential uses
FFL no lower than 8.4mAOD for less vulnerable commercial uses
FFL no lower than 7.9mAOD for the commercial reception area
Flood storage mitigation shall be provided Flood voids shall be installed
42 The development shall be carried out in accordance with the submitted Interim Flood Storage Scheme detailed within the letter from MNP to the Environment Agency (SV/ib/220051-04; dated 15 February 2021). The car park ramp tank will be implemented at the trigger points specified and remain in perpetuity until the demolition of Lever House is complete.
43 Prior to occupation, a maintenance plan to manage the flood voids and grilles over the lifetime of the development will be submitted to, and approved in writing by, the LPA in consultation with the EA.
44 Prior to occupation, a scheme detailing the flood resistance measures must be submitted to, and approved in writing by, the LPA with guidance from the EA. The scheme should include passive flood barriers up to 8.31 mAOD to protect the shared reception of the Hive and Honey Buildings and the car park basement access ramp, stairwell and lift lobbies.
45 Surface water draining from areas of car park hardstanding shall be passed through an oil separator or series of oil separators, prior to being discharged into any watercourse, soakaway or surface water sewer.
53 The development shall be implemented in accordance with the details approved on 07.03.2022 under reference 22/00292/CLC (Water re-use/harvesting).
59 No piling shall take place until a piling method statement (detailing the depth and type of piling to be undertaken and the methodology by which such piling will be carried out, including measures to prevent and minimise the potential for damage to subsurface water infrastructure, and the programme for the works) has been submitted to and approved in writing by the LPA in consultation with TW.
64 Prior to the occupation of each building the post-construction tab of the GLA’s whole life carbon assessment template should be completed accurately and in its entirety in line with the GLA’s Whole Life Carbon Assessment Guidance.
No
No No
Yes Yes
Yes Yes
No No
ORSA monthly CDM report
Job Number 2800 Job Eden Campus
Document Title Site Inspection File Reference SI1 ORSA_H&S Site Inspection February 2024.docx
Document Information
Revision Issue Date Filename 2800_Eden Campus_ORSA Site Inspection_FJMK270924
A 29/09/24 Description Site Inspection
Prepared By Checked By Approved By Name Francis J M Kenny James Bucknall James Bucknall
Signature Date 27/09/24 29/09/24 29/09/24
Revision Issue Date Filename Description
Name
Signature
Prepared By Checked By Approved By
Date dd/mm/yy dd/mm/yy dd/mm/yy
Revision Issue Date Filename
dd/mm/yy Description
Name
Prepared By Checked By Approved By
Signature Date dd/mm/yy dd/mm/yy dd/mm/yy
Client Globe Kingston Ltd
Site Eden Campus, Eden Street, Kingston Upon Thames KT1 1ER.
Principal Contractor McLaughlin & Harvey Ltd
Inspected by Francis J M Kenny
Date 27 September 2024
Programme Completion due October 2024
A site inspection of the Eden Campus Project was undertaken on the 27th September 2024 in the company of Connor Casey, Assistant Site Manager for Principal Contractor McLaughlin & Harvey Ltd.
The Project comprises the erection of 3 blocks. An 11-storey office block, a 9-storey office and retail block and a multi storey car park with 354 spaces.
The car park will contain ground floor changing area with showers and lockers. The office block will be occupied by Unilever when completed.
The purpose of the site inspection was to highlight any Health, Safety and Environmental observations and undertake a review of the on-site documentation in relation to the work activities that were being carried out.
§ Landscaping
§ Raised floor
§ Cleaning.
§ Cladding.
§ Painting.
§ M&E
§ Waste removal.
§ Traffic management
§ Deliveries.
The current average daily site attendance is approximately 100 including operatives and site management.
It was confirmed by Connor Casey that there have been no recorded accidents, incidents or near misses or Enforcing Authority visits since our last inspection.
Concluding this visit there were no issues or actions raised, and all issues or actions raised last month have been addressed by McLaughlin & Harvey Ltd.
I conducted a thorough safety inspection of the project site to evaluate its overall safety performance and ensure full compliance with health and safety standards.
The inspection aimed to highlight both strengths and areas for potential improvement.
The findings revealed that operatives consistently adhered to safety protocols under close supervision, reflecting a strong safety culture on-site.
Security is bolstered by the use of sign in areas, restricting access to authorised personnel only.
The perimeter is well-protected with regularly inspected hoarding and fencing.
Health and safety noticeboards are strategically placed to keep workers informed of relevant regulations and requirements.
Additionally, daily hazard and briefing boards effectively communicate safety updates, raising awareness of potential risks and necessary precautions.
Operatives were observed wearing the required PPE, ensuring they were protected during various tasks.
Manual handling practices were also commendable, with the appropriate training and equipment in place.
While the work areas, walkways, and routes were orderly and well-maintained, dust management needs improvement to maintain optimal safety standards.
The site is equipped with certified portable fire extinguishers and clearly marked fire exits, ensuring preparedness for emergencies.
Barriers and signage clearly define exclusion zones, minimizing risks by restricting access to hazardous areas.
Method statements and risk assessments were comprehensive, adequately addressing the health and safety risks associated with the project.
First aid resources were easily accessible, with trained first aiders on hand to provide immediate assistance if required.
The site offers sufficient welfare facilities, including clean toilets, washing stations, drinking water, and a well-maintained canteen.
Additionally, dedicated areas for changing and storing clothing and PPE contribute to operatives' comfort and well-being, fostering a safe and productive working environment.
Documents observed while on site included:
§ Safety posters
§ Safety notice and hazard boards.
McLaughlin & Harvey Ltd. has established a robust system to ensure that any temporary works installed on-site are appropriately designed and approved by competent engineers.
This measure is crucial to mitigate potential risks associated with temporary structures and ensure their stability throughout their intended use.
A comprehensive temporary works register is in place on the project. The register provides detailed information about all temporary works on-site, including their design specifications, installation dates, responsible personnel, and approval status, and the register is updated regularly to reflect any changes or new installations.
Andy Finnigan has been formally appointed as the responsible person for overseeing temporary works at the project site.
This appointment demonstrates a clear commitment to ensuring that temporary works are managed by a competent individual with the necessary expertise to assess and oversee their design, installation, and maintenance.
In line with best practices, McLaughlin & Harvey Ltd. has ensured that engineers responsible for designing and approving temporary works possess the required competencies and qualifications. This approach guarantees that temporary structures are designed and executed by individuals with the appropriate expertise.
The scoring criteria adopted for our site inspection is given as
Observation
Project H&S Organisation
Project Arrangements
Project Risk Register
Project Methodology Statements
Inductions
Register/Notices/Forms
Permits to Work
Construction Phase Health & Safety Plan
Information
Communications/Consultation/Training
Site Establishment
Welfare-General
Canteen
Rest/Drying/Changing Room
First Aid
Sanitary/Washing Facilities
Walkways/safe routes
Fire escape routes
Access and Egress on site
Offices
Storage
Segregation of substances
Access / Egress
Site Boundary
Hoarding/Fence/Other
Security
Signage
Traffic Management
Status Comments
Acceptable Contained within the CPP. - -
Acceptable Project risk register available.
Acceptable In place for live works. - -
Acceptable Inductions carried out and recorded. - -
Acceptable Displayed.
Acceptable Issued and controlled.
Acceptable In place.
Acceptable Displayed on notice boards. - -
Acceptable Briefings undertaken daily. - -
Acceptable Good standard, clean and tidy. - -
Acceptable Good standard, clean and tidy.
Acceptable Good standard, clean and tidy.
Acceptable First aid equipment available on site.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Access and egress sufficient and not obstructed.
Acceptable Weil controlled
Acceptable Clean and tidy.
Acceptable Stored in line with COSHH assessment. - -
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Good standard and well maintained
Acceptable No issues identified.
Acceptable Good signage in place.
Acceptable Managed well.
Observation
One Way System?
Site internal turning
Banks man supervision
Vehicle/Pedestrian Segregation
Wheel wash
Site Access-General
Operations - Safety Management – Planning
Risk Assessment-General
Method Statement-General
Roles and Responsibilities-General
Acceptable Site has two gates, and a one-way system is used as required.
Acceptable Traffic marshals in place.
Acceptable In place.
Acceptable Good segregation is in place.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable RAMS are in place.
Acceptable Suitable and sufficient.
Acceptable In place and listed within CPP.
Scaffold/Register Not Applicable Not Applicable.
Plant/Register
False work
Temporary Works Design Brief
Temporary Works Appointments
Temporary Works Register
Operations - Safe Methods of Work
Compliance with method statement
Method Statement-General
Signature/Documentation
Risk Assessments
Permit system responsible person
Internal site safety tours
Documentation Acceptable
Considerate Constructors Registered
Water Management Plan
Emergency Fire evacuation Plan
Use of Scaff-inspection tags
Slips/`Trips /Falls
RPE - Face Fit testing
Acceptable Completed.
Acceptable. No issues raised.
Acceptable In place.

Acceptable In place for Andy Finnigan
Acceptable In place and up to date.
Acceptable No issues raised.
Acceptable Suitable and sufficient.
Acceptable In place within the site files.
Acceptable In place.
Acceptable In place and up to date.
Acceptable Regular tours undertaken.
Acceptable In place and relevant.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable In place.
Acceptable In place.
Acceptable No issues raised.
Acceptable No issues raised.
Observation
Asbestos Register and Awareness Training
Good Practice - Safe Working
Work areas tidy
Walkways/safe routes clear of obstruction
Tools & Equipment suitable for the task
Safe manual handling
Signage
Storage of materials
Compliance with method statement
Personnel Protective Equipment PPE
Operations - Activity Set Up
Resources
Operatives Certification
Plant Certification
PUWER Register
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable In place and sufficient.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Clear and un-obstructed.
Acceptable Suitable for current activities.
Acceptable No issues raised.
Acceptable Plant registers maintained
Acceptable Records in place and up to date.
Hoist Register Not Applicable Not Applicable.
Crane Register Not Applicable Not Applicable.
Lifting Equipment Register Not Applicable Not Applicable.
Induction Register
Tool box talks
Contractor's team briefings
Operations - Activities -Safe Working
Site tidiness-Housekeeping
Fire Precautions
Fire safety route
Fire Fighting Equipment [Site]
Fire Signage
Fire Escape route
Fire Assembly
Acceptable In place and signed by site operatives.
Acceptable No issues raised.
Acceptable In place and completed.
Acceptable Good standard
Acceptable No issues raised.
Acceptable Clear and unobstructed.
Acceptable Suitable and sufficient.
Acceptable Displayed.
Acceptable Clear and unobstructed.
Acceptable In place.
Observation Status Comments
Fire register [Site]
COSHH
Safe Storage
Hazardous Substance Register
MSDS Sheets Documented
Hand Tools/Plant/Transport
Hand Tools [PAT]
Plant
Transport Equipment
Excavation
Electricity
Acceptable In place.
Acceptable Assessments in place.
Acceptable No issues raised.
Acceptable In place and sufficient.
Acceptable Attached to assessments.
Acceptable No defects noted.
Acceptable PAT tested and in date.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Good practice
Acceptable No issues raised.
Overhead Power Lines Not Applicable Not Applicable.
Underground Services
Acceptable No issues raised.
HV Electrical installation Not Applicable Not Applicable.
Working at Height
Ladders
Step Ladders
Mobile Scaffold Towers
Roof work
Mobile Elevated Working Platforms [MEWP]
Hoists
Mechanical Lifting
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable Clear and unobstructed.
Confined Space Not Applicable. Not Applicable.
Permit
Floor openings
Edge Protection
Signage
Safe working practices
Protective clothing /equipment
PPE-General
Acceptable No issues raised.
Acceptable No issues raised.
Acceptable in place where required.
Acceptable Relevant safety signage is in place.
Acceptable No issues raised.
Acceptable 5 points of PPE as per site rules.
Acceptable No issues raised.
Observation Status
Manual handling
Environmental
Air Pollution
Water Pollution
Land Pollution
Noise Pollution
Dust Pollution
Acceptable No issues raised. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable No activities causing concern. - -
Acceptable Dust management throughout the project has improved, but will still need to be monitored carefully
& Harvey Ltd Ongoing
Working over /adjacent to water Not Applicable. Not Applicable. - -
Roadwork's Not Applicable. Not Applicable. - -
Working over/adjacent to railways Not applicable Not Applicable. - -
Project Project Honey, Kingston Created By Alexander Cook
Job No 19064
Date 24/09/2024
Revision 01
Date 24/09/2024
Approved By Alastair Roberts
Date 24/09/2024
DAA continue to develop & coordinate the Stage 5 detailed design of buildings A + B + C with McLH in line with the construction programme.
DAA continue the s nagging process to in line with the McLH Program - Refer to the McLH Snagging Tracker for further details.
All remaining pre-commencement conditions have all been submitted. Cond 43 “Flood Resistance” & Condition 44 ‘Flood Maintenance’ have since been re-submitted post futher coordination with McLH + civils specialists at RBG Refer to the McLH + FH Conditions Tracker for further details.
DAA are developing the remaining TVRs & are actively developing all variations relating to External Works, CCTV, GF Service notch to Link + Ceiling Bulkheads.
DAA continue to a ttend project DTM’s with McLH & the design team as well as organising specific design workshops with M+E, Facades, Building Control, Fire & BREEAM when required
A s lead design DAA continue the coordination of BIM models & have begun circulat ing our Revit models & following all BIM protocol to ensure the design team is fully informed & coordinated
DAA issued architectural information that targets all pre-above ground planning conditions & continue to work with both McLH + FH to unlock the conditions.
DAA are attending detailed design workshops on the proposed External Works, landscaping, Internal walls , external f acades to ensure further coordination between consultants, the occupier team & funders.
DAA continue to manage & present finishes / samples to the Unilever design team for formal sign off. The design team are continuing to develop the façade detailed proposals with Clarkes & McLH through dedicated façade workshops & a re actively responding to RFI’s to ensure the façades retains the original design intent + quality.
DAA have attended site meetings + visits + snagging when required to review benchmark works on site, samples & detailed coordination issues.
Instruction required on all occupier variations + associated DAA fees on the following: - Signage planning application.
Any Additional Occupier Variations
Full understanding of any other new UL variations which could potentially affect the construction design programme is critical for avoiding redundant work.
DAA have issued design sketches + Updated Stage 5 Design Packs for the following :

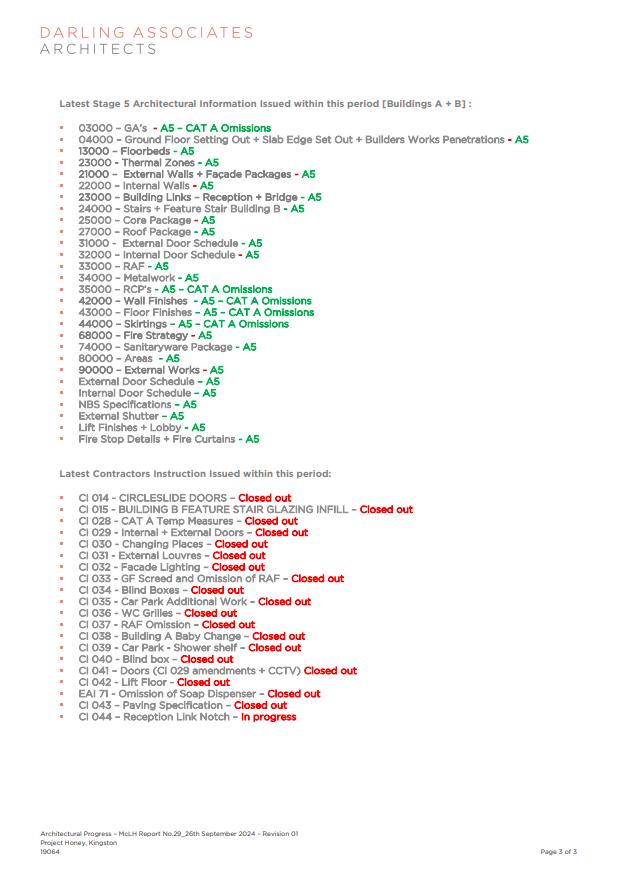

90 Series – External Works – Paving / Levels / Ramp set out
Re-Submission of Condition 43 + 44
Reception Link – 3D Model following Clark’s C01 drawings
Building A and B – Level 01 cut outs – coordination with Struct Eng. Fire Eng. Fire Stopping Specialist and Client. Explored various options and feasibility studies.
Responding to Contractor’s various queries on ceilings, walls, roller shutter, façade and MEP
04, 05 and 32 Series updates showing the agreed door type to Building A – Corridor 00 -032
03 Series Links updates
Closing Building Control outstanding items, coordination with MEP and Struct.Eng.
CCTV Building A and B Coordination with Façade engineers and requested updates
CCTV Building C Coordination and submission of agreed C01 revision
35 Series revised due to requested additional hatches by MEP Eng.
74 Series updates due to requested additional SVP cutout to Mezzanine Building A by MEP Eng. Coordination with Struct Eng.
Snagging + Benchmarks :
- Snagging completed according to MCLH schedule
- Recent Snagging includes : Building A – Level 2, 3 & 4 Offices
DAA have fully updated their Architectural folder on Viewpoint + associated TIDP which now contains all issued drawings / specifications / reports / design options / sketches
DAA have continued to attend BIM clash detection workshops when required & have always ensured that design development of Revit models are frequently issued following coordination workshops & key design changes/variations.
DAA have responded to all required RFI’s & provided comments via Viewpoint on all consultant drawings & design information.
Latest Stage 5 Car Park Architectural Information Issued within this period [Buildings C] :
13000 – Floorbeds - A5
21000 – External Walls + Façade Packages - A5
22000 – Internal Walls – A5
24000 – Stairs - A5
25000 – Cores - A5
2 7 000 – Roof Package - A5
30000 – GA Drawings - A5
34000 – Metalwork - A5
35000 – RCPs - A5
42000 – Wall Finishes - A5
43000 – Floor Finishes - A5
68000 – Fire Strategy - A5
44000 – Skirtings - A5
74000 – Sanitaryware Package - A5
Outline Finishes Specification
External Door Schedule - A5
Internal Door Schedule - A5
NBS Specifications - A5
External Roller Shutter Proposal - A5
Floor beds + Gullies Changing village - A5
Latest Stage 5 Architectural Information Issued within this period [Buildings A + B] :
03000 – GA’s - A5 – CAT A Omissions
04000 – Ground Floor Setting Out + Slab Edge Set Out + Builders Works Penetrations - A5
13000 – Floorbeds - A5
23000 - Thermal Zones - A5
21000 – External Walls + Façade Packages - A5
22000 – Internal Walls - A5
23000 – Building Links – Reception + Bridge - A5
24000 – Stairs + Feature Stair Building B - A5
25000 – Core Package - A5
27000 – Roof Package - A5
31000 - External Door Schedule - A5
32000 – Internal Door Schedule - A5
33000 – RAF - A5
34000 – Metalwork - A5
35000 – RCP’s - A5 – CAT A Omissions
42000 – Wall Finishes - A5 – CAT A Omissions
43000 – Floor Finishes – A5 – CAT A Omissions
44000 – Skirtings – A5 – CAT A Omissions
68000 – Fire Strategy - A5
74000 – Sanitaryware Package - A5
80000 – Areas - A5
90000 – External Works - A5
External Door Schedule – A5
Internal Door Schedule – A5
NBS Specifications – A5
External Shutter – A5
Lift Finishes + Lobby - A5
Fire Stop Details + Fire Curtains - A5
Latest Contractors Instruction Issued within this period:
CI 014 - CIRCLESLIDE DOORS – Closed out
CI 015 - BUILDING B FEATURE STAIR GLAZING INFILL – Closed out
CI 028 - CAT A Temp Measures – Closed out
CI 029 - Internal + External Doors – Closed out
CI 030 - Changing Places – Closed out
CI 031 - External Louvres – Closed out
CI 032 - Facade Lighting – Closed out
CI 033 - GF Screed and Omission of RAF – Closed out
CI 034 - Blind Boxes – Closed out
CI 035 - Car Park Additional Work – Closed out
CI 036 - WC Grilles – Closed out
CI 037 - RAF Omission – Closed out
CI 038 - Building A Baby Change – Closed out
CI 039 - Car Park - Shower shelf – Closed out
CI 040 - Blind box – Closed out
CI 041 – Doors ( CI 029 amendment s + CCTV ) Closed out
CI 042 - Lift Floor - Closed out
EAI 71 - Omission of Soap Dispenser – Closed out
CI 043 – Paving Specification – Closed out
CI 044 – Reception Link Notch – In progress
McLH procurement schedule
Contract:
Lautus progress report
This report is based on the construction programme Rev 17. (Last month revision 16) rather than the contract programme. This includes an updated M & E programme.
Contract Dates
Running a Monte Carlo risk analysis the likely end date at present is the 15 November 24.
Progress
Building A - on site
Comment
Building A likely completion is 15/11/24. The critical path is shown running through
Link Bridge / Roof / M & E / Finishes / BMS and commissioning.
Envelope
Construction programme May24 Rev 12
Equitone Cladding
RescheduledConstruction programme June 24Rev 14 completion date
RescheduledConstruction programme August24 Rev 16completion date
RescheduledConstruction programme September24 Rev16 completiondate +/June to Sept
These panels now due to be complete mid September resulting in the projected removal of the mast climbers W/E 29/9/24. This has had an knock on effect on the external works and the 278 works.
Brick faced GRC
The brick faced GRC is projected now to complete 7 October this has an adverse affected on external works progress. It was reported that there are no manufacture / delivery issues.
Link Bridge
Waterproofing to level 6 only 40% complete. Cladding to the link bridge soffit at level 6 yet to commence. The mechanical plant that will be required to carry out these works with hinder the external works programme. There is no allowance shown on the programme for this.
Stick System
The curtain walling ground and first floor now projected complete late September -14W late (programme Rev 12).
Roof
Construction programme
May 24 Rev 12
RescheduledConstruction programme June 24Rev 14
RescheduledConstruction programme August 24 Rev 16
RescheduledConstruction programme September 24 Rev 17 + /June to July
Level 9 2/9/24 2/9/24 Complete Complete 0
Level 8
Terrace 13/6/24 16/7/24 1/11/24 6/11/24 -16W1d
Level 6
Similar to June report, roof terrace finishes still to be carried out. Level 8 and level 6 terrace are being used to store materials thereby delaying the roof insulation, roof finishes and handrails etc. The current programme shows works to roof terraces commencing, though they are still being used for storage of materials.
The instruction to install perimeter blind boxes has been included in the revised construction programme. These are complete on the 2nd, 3rd 4th and 5th floor. 90% on first floor. Curved grilles are being fixed to blind boxes. It has been reported that there are no delivery issues.
Lift installation
Lift 01 05, and 07 100% complete. L02 L03, L04 & L06 underway. Last month projected completion was the end of August. Likely completion end date for all lifts is the 30 September 24. A further delay of 10 days. To achieve the 30 September, work will need to progress on all four lifts.
Lift L07 and L01 are being used as a means of vertical transportation of materials and labour. The external hoist has been de commissioned.
Work to risers
Work to risers complete except for the smoke ventilation risers, which has a projected completion of the 24 September. Last month projected completion was the 27 August 24 a further delay of 21 days.
Cores
Works to the lobbies are further in delay than the WC.
Lobby completion dates:
Ground21 Oct 24
Level 1 & 2 11 Oct 24
Level 37 Oct 24
Level 4 7 Oct 24
Level 510 Oct 24
Level 615 Oct 24
Level 717 Oct 24
Level 821 Oct 24
To achieve these dates, all cores will require to be worked on with a noticeable increase of labour being needed. Progress appears to have slowed probably due to lack of labour as this has been diverted to complete Building B.
Finishes Construction programme May24 Rev 12
RescheduledConstruction programme June 24Rev 14
Rescheduled Constrution programme August 24 Rev 16
Rescheduled Constrution programme September24 Rev 16 + /Aug to Sept
Commissioning
Reported as approximately 50 % complete. The progress indicates that there is a need to increase mechanical resource.
Building B- on site
Work nearing completion.
Lifts to be tested and commissioned shown as 2 weeks.
Work to plant areas and commissioning shown as two weeks work.
Approximately two weeks work shown outstanding on the eighth and ground floor.
Building C- on site
Roof landscaping reported as complete.
Work progressing with fit out on the ground floor, a critical area, which is now projected to complete 31 October 24. Last month the 5 November 24. To maintain this end date the fit out works on the ground floor have been split into three zones. Progress has slipped. Both lifts are being installed together with completion targeted at 16 October 24. This is now an area that is running on the critical path. There is a high risk that the reported completion date will not be met.
External works is a complex construction in a restricted area. With a delay to the removal of the mast climber and Tower Crane this puts greater pressure on achieving the completion date. Projected completion 25 October. Last month reported 4 October 24. The programme does not reflect the complex nature of the work.
◌ྕ
The late removal of the tower crane and mast climbers will adversely effect logistics and site progress.
◌ྕ The brick faced GRC installation at the base of the building has now commenced. This delay will adversely affect the external works programme.
◌ྕ Fit out of the ground floor in building C now on the critical path is an area that is likely to over run.
◌ྕ Labour diverted from Building A to Building B due to a general lack of labour. This has had affected on progress on Building A.
◌ྕ External works is complex, in a restricted area. The remaining time available puts greater pressure on achieving the completion date.
◌ྕ Cladding to the link bridge soffit at level 6 yet to commence. The mechanical plant that will be required to carry out these works with hinder the external works programme. There is no allowance shown on the programme for this.
◌ྕ The current programme shows works to roof terraces commencing though they are still being used for storage of materials.
◌ྕ
◌ྕ
To meet the revised completion date for lift installation on Block A & C all lifts are shown being worked on. Concern that this is unlikely with the labour available.
To achieve completion of all core lobby areas labour will be required to work on all floors, again concern that this is unlikely with the labour available.
Buildzone tracker/report
BuildzoneRef Number: BZ9084931
Address: ProjectHoney
27 (Twentyseven)
19 of 27
29.08.2024

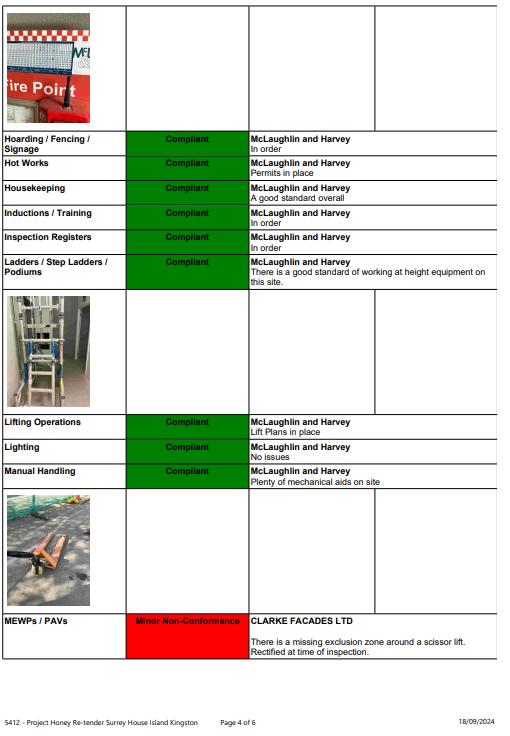

Surveyor: Ahmet Ozcagli Key:
Client is advised to provide belowinformation for works before site visit:
•Provide images of works before visitincluding pile caps,foundations before concrete pour, floor slab before concrete pour,Core twin wall installations.
•Provide pile integritytests certificates.
•Provide pre-pour QAinspection records for foundations,slabs,columns and core wall installations.
Provide structural engineer’s solution or approval for the low concrete coverage for steel over precastslab at Block A ground floor.
Provide structural engineer’s solution or approval for the low concrete coverage for steel over precastslab at Block B ground floor.
Provide structural engineer’s solution or approval for the low concrete coverage for steel over precastslab at Block C ground floor.
For Block B,provide structural engineer’s written approval of fire door opening core wall cutting works.
Provide repair method statementand images of repairs at Block C precast elements.
Client is advised to provide repair methodologyand images of repair applications to floor concrete at Block C roof level.
Client is advised to provide repair methodologyand images of repair applications to floor concrete at Block C 1st level.
Block A level 8 moisture damaged plasterboard observed.Clientis advised to provide images of changed plasterboards.
2.03 Full RIBA Stage 5 Architectural Drawings
2.04 Full RIBA Stage 5 Structural Drawings and Calcs
2.05 Pile integritytest results
2.06 Cube testresults
2.07 Heat soak and impacttestglass specifications
2.08 Terrace and flat roof IBG
2.09 List of full cladding materials proposed
2.10 Windows & external door manufacture guarantees
2.11 Provide QA records for precast elements from manufacturer
3.01 Provide all statutoryand certification documentation at projectcompletion
inline with technical reporting
Pre-pour inspection records from site engineer
Building Control site inspection reports
Fire consultant QA records
Basementwaterproofing QA records
Pile integritytest certs
Bolt checking QA records
Weld testcerts
Cube testcerts
Static load testcerts
Terrace and Flat roof IBG
BBA certification for anyrainscreen cladding or brick slips
Glazing / curtain walling heat soak and impacttesting certs
Building Control Completion Cert(s)
EPC
As built SAPS
Mechanical Ventilation certification
Chlorination certs
Gas/water/elec certs
Fire door compliance commissioning
Fire suppression,alarm commissioning
Sound tests
Air tests
Lift Commissioning
Drainage pressure testing (written confirmation from AI) & or CCTV
q
commissioning meeting notes
Document No. Revision
Date/Time 01/10/24
Place Microsoft Teams / Project Office
Prepared / Chaired by Ian Goodwin
Date of Issue 10/01/24
Ian Goodwin AACM (IG)
Giuseppe Vaccaro Unilever (GV)
Luke Nurser Francis Hunter (LN)
Allen Nash MCLH (AN)
Mark Day (MD) Sodexo
Kelvin Howland (KH) Sodexo
Attendees
Apologies
Jon Giffin (JG) Banyards
Feran Olanrewaju Mace (FO)
Phil Lewins AECOM (PL)
Sam Jeffries AACM (SJ)
Gary Gee Hoarelea(GG)
Jeremy Pollard Unilever (JP)
Andrew Finnegan (AF) MCLH
Joanna Harris (Sodexo)
Gavin Toman MCLH (GT)
David Lunt Francis Hunter (DL)
Talent Ncube Mecserve (TN)
David Stephens Francis Hunter (DS)
Joanna Swidzinska Mecserve (JS)
Piyush Patel Inhabit Group (PP)
Purpose of meeting is to align client and delivery teams expectations of commissioning and integration requirements, delivery strategies and confirm roles and responsibilities across all stakeholders
As agreed, minutes condensed from last meetings
1.2 Query Schedule Inhabit / Mecserve
- Halsion have stated that their designers cannot make tomorrow’s meeting - To be pushed bac to follow this meeting next week - IG to update invite
Documentation
- Master document run through – summary below
- CTP / CTPE located with shared client commissioning folder
- All Documents on V4P
- Dates ref on CTPs will be correct in CTPE (PP)
- Biweekly reports located within client shared folder
Ext lighting to be general
ATS await generator
Lighting control 02/10/24
BMS 9 X CTPE issue date TBC
Domestic await chlorination
FCU tech statement needed from ability – several FCU at augmented operating voltage to achieve 100%
Water treatment to issue 02/10/24 – do not need to include trends
1.3
Client WLA
- Halsion up revving their current WLA
- To be issued end of the week
- Will be run through in next weeks meeting
CAS run through issued with minutes
Meetings / Workshops
- Client meeting agreed to go weekly predominantly will be held over teams
- IST for Building B
o Document issued no comment to date
o Building B primary isolation only as no generator
- IST document run through Note, Generator will not be available for Building B.
- IG discussed whether it is best now to have one IST for the whole project as we approaching PC. LN to advise
Client Training
- GV requested that Client Training is programmed for Tuesdays and Wednesdays to match Sodexo site attendance.
- GV to issue preferred dates to commence earliest 01/10/24. AACM to advise if these dates are achievable within the programme and ongoing commissioning activities.
- Revised dates to be issued with WLA 05/10/24AOB
Client training to be booked on Tuesdays and Wednesdays. Target dates 01/10/24 earliest.
Aecom to attend site to witness commissioning. List of systems to be forwarded. (LN)
AACM to issue Mecserve Schedule. PMN emailed 17/09 14.10.
Unilever have appointed Banyards (JG) as Commissioning Managers. Ongoing Look-aheads to be forwarded so they can attend future witnessing. (AACM)
OMM draft issued with designation errors GV querie final delivery date AN confirms OMM will be issued and accepted prior to PC though will chase through for early reviews
NEXT MEETING
24/09/24 13.00
AREA MEASUREMENT REPORT
(RICS Code of Measuring Practice)
EDEN CAMPUS
(Buildings A, B & Building Link)
St James's Road
KINGSTON-UPON- THAMES
KT1
Project Number
45323-005 Contents
Report Issue Status
Survey Report
Summary of Areas
Reference Plans
Floors
Building A
(Buildings A, B & Building Link) St James's Road
KINGSTON-UPON- THAMES KT1
ACC1 06 June 2024 FOR REVIEW ISSUED FOR COMMENTS
ACC2 12 June 2024 FOR REVIEW 4TH, 3RD & 2ND FLOOR AREAS AMENDED
ACC3 10 July 2024 FOR REVIEW BUILING A 2ND & BUILDING B 1ST,5TH, 6TH ADDED
ACC4 22 July 2024 FOR REVIEW BUILDING B AREAS AMENDED
ACC5 22 August 2024 FOR REVIEW BUILDING A 3RD , 4TH , 5TH & BUILDING A 10th -7th & 1st -G ADDED & 2nd FLOOR AMENDED
ACC6 28 August 2024 FOR REVIEW CLIENT AMENDMENTS TO ALL FLOORS
ACC7 29 August 2024 FOR REVIEW CLIENT AMENDMENTS TO ALL FLOORS
ACC8 13 September 2024 FOR REVIEW REMAINING FLOORS ADDED
ACC9 17 September 2024 FOR REVIEW
ACC10 17 September 2024 FOR REVIEW
This Area Measurement Survey was undertaken by Plowman Craven between June and October 2024, in accordance with the guidelines as described in the Sixth Edition (September 2007) of the Code of Measuring Practice and the Globally applicable 6th Edition (May 2015), published by the Royal Institution of Chartered Surveyors (RICS).
The measurement was undertaken by Plowman Craven’s representative at the date of survey, under site conditions at that time and in line with Plowman Craven's standard conditions of contract.
In preparing this measurement report, Plowman Craven has relied upon supplied information. The areas to be measured were defined by the instructing client through floor or lease plans with appropriate areas outlined, and/or as instructed on site by the client or client’s representative.
Any undefined areas were measured as found on site in accordance with the Sixth Edition (September 2007) of the Code of Measuring Practice and the Globally applicable 6th Edition (May 2015).
Measurements were taken to the internal face of perimeter walls and to the face of walls enclosing toilets, stairs and other core areas.
Areas and wall lines with limited access at the time of survey are denoted on drawings by dashed lines. Any areas that were not accessible, due to either building construction, tenant imposed restrictions or wall lines obscured by fixtures and fittings, have required professional estimations based upon similar layouts on adjacent floors and on information derived from supplied drawings.
A 3D Laser scanner was used to observe the geometrical framework of the area surveyed. The point cloud data was downloaded and stored onto a laptop, and later downloaded directly to office servers. Dimensions were taken of overall distances and, where necessary, diagonals and check measurements, using a “Leica Disto” laser device. These were recorded on to a laptop running relevant software.
Site survey work and corresponding accuracy levels are constrained by the methods adopted to capture relevant site data given the nature of access afforded and the time allocated to complete the work. The accuracy of the area figures reported is commensurate with the measurement methodology applied.
All site observations and dimensions were checked and any discrepancies exceeding the required tolerance were, if necessary, verified on site.
Computer-Aided Design (CAD) software has been used to construct accurate area drawings from the information collected. The area values derived have been calculated using commands and routines built into the CAD software.
The drawings have been retained as digital CAD files comprising accurate data of area extents and configurations and have been produced in compliance with the measurement reporting standard of the RICS Code of Measuring Practice. All areas have been calculated in square metres and converted into square feet using a conversion factor of 1 sq. m = 10.7639 sq. ft. Caution should be used when working with hard copy paper prints generated from digital data files. These drawings have been produced for area referencing purposes and must not be used for any architectural or construction/engineering purposes or for any other purpose other than that for which they were originally intended.
The drawings contained within the report reflect the site configuration at the time of survey. As such Plowman Craven cannot be held responsible for any changes made to the site, that may affect the area, after the date of the original survey.
This report includes copies of:
- Property Photographs - illustrating the condition of site at the time of survey
- A Summary of Areas
- Area Plans - showing the extent of the area measured, identifying specific areas of inclusion/exclusion and quoting area values in square metres and square feet.
Should this report be distributed to other parties it should be done so in it’s entirety. The “Summary of Areas” and the “Area Plans” should be read in conjunction with each other and should not be separated from this report.
All figures and drawings are checked as part of our standard works procedures in accordance with the company's certification to BS EN ISO 9001:2015.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. Dashedlinedenotesassumedwalllineunderconstructionatthetimeofsurvey. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. LossofAreaispre-agreedandhavenotbeenmeasuredonsite.Thisareahasbeenreportedunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllineinaccessibleatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat.
LossofAreasarepre-agreedwithUnileverandhavenotbeenmeasuredonsite.Theseareashavebeenderivedformsupplieddrawingsunderclientinstruction. Dashedlinedenotesassumedwalllinenotinsituatthetimeofsurvey.
ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
EDEN CAMPUS, St James's Road, KINGSTON-UPON- THAMES, KT1
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
September2024
ThisdrawingcomplieswiththeRICSCodeofMeasuringPractice,6thedition(September2007)andtheGloballyapplicable6thEdition(May2015).Itindicatestheextentoftheareasquoted,producedtoan accuracycommensuratewithstandardpresentationscales.ItisheldinascaleddigitalCADformat. ThebackgrounddatashowningreyhasbeenproducedbyaThird-Partyandisshownforreferencepurposesonly.Thisdatamaynotcoincidewiththeextentsoftheon-sitemeasurements.
September2024
extension of time 05
issued by: Francis Hunter Project Management
115 Southwark Street
London SE1 0JF
employer: Globe Kingston Ltd
Tiddington Road
Stratford-Upon Avon
United Kingdom
CV37 7BJ
contractor: McLaughlin & Harvey
15 Trench Road
Mallusk
Newton Abbey
Belfast
BT36 4TY
project: Surrey House – Project Honey (10372)
issue ref: 10372-7
issue date: 05 September 2024
contract: JCT D&B 2016 with schedule of amendments
In line with clause 2.25 we hereby fix the new Completion of Section dates as:
- Section 1 (Building B) – 21 October 2024 (6 weeks E0T)
- Section 2 (Building A and C) – 21 October 2024 (no change)
Early Access confirmed as no longer required for either section 1 or 2.
In fixing the above adjustment to the completion date, we have taken in to account the following relevant event:
- Notice of Relevant Event/ Matter 006 (clause 2.24) issued on 27th August 2024 related to late Thames Water connection
- Notice of Relevant Event/ Matter 006 (clause 2.24) issued on 27th August 2024 related to late UKPN connection
The two Notices of Relevant Event are still under review with regard to their impact on Section 2, and any further impact on Section 1.
In issuing the decision, the Contractor is reminded of their duties under Clause 2.25 6 to use best endeavours to prevent delay /further delay beyond the relevant completion date.
signed by: _ Francis
Hunter Project Management (Employer’s Agent
)
distribution:
issued by: Francis Hunter Project Management
115 Southwark Street
London SE1 0JF
employer: Globe Kingston Ltd
Tiddington Road
Stratford-Upon Avon
United Kingdom
CV37 7BJ
contractor: McLaughlin & Harvey
15 Trench Road
Mallusk
Newton Abbey
Belfast
BT36 4TY
project: Surrey House – Project Honey (10372)
issue ref: 10372-8
issue date: 04 October 2024
contract: JCT D&B 2016 with schedule of amendments
In line with clause 2.25 we hereby fix the new Completion of Section dates as:
- Section 1 (Building B) – 11 November 2024 (3 weeks E0T)
- Section 2 (Building A and C) – 11 November 2024 (3 weeks EOT)
In fixing the above adjustment to the completion date, we have taken in to account the following relevant event:
- Notice of Relevant Event/ Matter 006 (clause 2.24) issued on 27th August 2024 related to late Thames Water connection
- Notice of Relevant Event/ Matter 006 (clause 2.24) issued on 27th August 2024 related to late UKPN connection
This Extension of Time is issued following further review of the two Notices of Relevant Events referred to above.
In issuing the decision, the Contractor is reminded of their duties under Clause 2.25.6 to use best endeavours to prevent delay /further delay beyond the relevant completion date.
Harvey
Project:ProjectHoney NoticeRef:006
ProjectRef:5412 Date:27/08/2024
RelevantEventReference:
ThisisanoticeprovidedinaccordancewithClause2.24oftheJCTDesignandBuildContract2016(“theContract”),thatithasbecome apparentthattheprogressoftheWorksislikelytobedelayedduetotheoccurrenceofaRelevantEventlistedinClause2.26ofthe Contract.
To:
DavidLunt
7ACCourt,HighStreet, Thames Ditton, Surrey, England, KT7 0SR
Particulars:
Copiesto:
Employer
Employer’s Agent
ThisdelayhasbeencausedbythelateconnectionofthePermanentWater,byThamesWater.
Following on from Early Warning 005, issued on the 12/06/2024, and the ongoing emails and correspondence that followed, the deferment of the Permanent Thames Water Connection, until the 1st July 2024, due to reasons unknown to Thames Water, has critically impactedMCLH’s ability tocompleteourContractWorks.This has impacted,more specifically,flushingactivities and has cause delays to theassociatedcommissioningworks.
ThisissueiscriticallydelayingtheoverallprogressoftheConstructionWorksandwillaffecttheoverallcompletionoftheWorksandthis isdemonstratedbelow.
Section1–10weeks
Section2–4weeks
RelevantEventclausepertainingtoabovecircumstances:2.26.6,2.26.7,2.26.13
ExpecteddelaytoDateforCompletion
Asnotedabove,weanticipatethattherewillbea10-WeekdelaytoSection1(BuildingB)anda4-WeekdelaytoSection2(BuildingA,C &Externals).TheparticularsofthesedelayswillbeissuedinthecomingdaysbutthecompletiondatesfortherelevantSectionsare notedbelow-
Section1–18th November2024
Section2–18th November2024
IsthisEventalsoaRelevantMatter:
IfYes,underwhichRelevantMatterclause:4.21.5
Signedby: MichaelMcCann Date:27/08/24
CommercialManager
AgreedandClosedby: AndrewDoherty Date:27/08/24
OperationsManager:
Project:ProjectHoney NoticeRef:007
ProjectRef:5412
RelevantEventReference:
Date:27/08/2024
ThisisanoticeprovidedinaccordancewithClause2.24oftheJCTDesignandBuildContract2016(“theContract”),thatithasbecome apparentthattheprogressoftheWorksislikelytobedelayedduetotheoccurrenceofaRelevantEventlistedinClause2.26ofthe Contract.
To:
DavidLunt
7ACCourt,HighStreet, Thames Ditton, Surrey, England, KT7 0SR
Particulars:
Copiesto:
Employer
Employer’s Agent
ThisdelayhasbeencausedbythelatecompletionoftheWayleaveAgreementsbetweenUKPNandourClient.
Following on from Early Warning 003, issued on the 19/03/2024, and the ongoing emails and correspondence that followed, the deferment of the Wayleave Agreements until the 20th May 2024, due to reasons unknown, has critically impacted MCLH’s ability to completeourContractWorks.
This issue is critically delaying the overall progress of the Construction Works and will affect the overall completion of the Works and this isdemonstratedbelow.
Section1–10weeks
Section2–4weeks
RelevantEventclausepertainingtoabovecircumstances:2.26.6,2.26.7,2.26.13
ExpecteddelaytoDateforCompletion
Asnotedabove,weanticipatethattherewillbea10-WeekdelaytoSection1(BuildingB)anda4-WeekdelaytoSection2(BuildingA,C &Externals).TheparticularsofthesedelayswillbeissuedinthecomingdaysbutthecompletiondatesfortherelevantSectionsare notedbelow-
Section1–18thNovember2024
Section2–18thNovember2024
IsthisEventalsoaRelevantMatter:
IfYes,underwhichRelevantMatterclause:4.21.5
Signedby: MichaelMcCann Date:27/08/24
CommercialManager
AgreedandClosedby: AndrewDoherty Date:27/08/24
OperationsManager:
