![]()

The Five-Year Capital Improvement Program (CIP) provides a comprehensive summary of the City’s plans, priorities, and projections for capital projects. As the community continues to grow, it is important to plan for the infrastructure, facilities, and maintenance needed to support and enhance the services the City provides to residents. The Five-Year CIP and annual Budget, together, tell the story of how the City is investing taxpayer money in order to promote fiscal responsibility and transparency.
The Five-Year CIP is comprised of the capital projects the City anticipates initiating in each of the next five fiscal years (2026 through 2030), as well as the funding sources for those projects. A capital project is a large, long-term project that acquires, builds, adds to, or prolongs the life of an asset. These projects generally take one or more years to complete, require a significant investment of money, and are useful for many years. Some examples of capital projects are roads, library buildings, recreation centers, water distribution lines, water tanks and towers, stormwater collection pipes, building renovations, and more. Many of these projects also require investments in personnel and other operating expenses, which are planned in the City’s annual operating budget.
The primary drivers for the Five-Year CIP are:
• Celina is one of the fastest growing cities in America;
• Meeting today’s needs while planning for the future; and
• Fiscal responsibility.
Celina is one of the fastest growing cities in America. The City’s population is projected to increase by 12,597 from 54,635 to 67,232 in FY 2026. The City estimates to issue 2,400 single family home permits for FY 2026, down from 2,643 in the prior year. With this growth, there is an increasing demand for services and infrastructure.
The City also seeks to both meet today’s needs and plan for future needs. To accomplish this, both the budget and FiveYear CIP have been prepared using the guiding principles established in the City’s Strategic Plan, Comprehensive Plan, and Core Values. Additionally, the five-year projection timeline is used to help us see how this years’ decisions impact the City’s ability to meet future needs. This combined short-term and long-term approach will help the City to adapt to the changing needs of our residents throughout the growth cycle.
Transparency and fiscal responsibility are cornerstones of our approach. We are committed to ensuring that
today’s decisions promote long-term sustainability. This document highlights the efforts to manage the City’s finances prudently while addressing the immediate and long-term needs of the growing population.
In addition to the primary budget drivers, the Five-Year CIP specifically addresses resident feedback and input. Residents are encouraged to be involved in the Capital Improvement Program process through the resident survey, which is conducted every other year with the most recent survey having been completed in 2024.
These surveys are used to gauge the level of residents’ satisfaction with City services and identify areas for improvement. They play a crucial role in the development of the strategic plan, budget priorities, and the capital project priorities. The areas identified for greatest improvement related to the Capital Improvement Program in the 2024 survey were streets, sidewalks, streetlighting, and utility infrastructure, as well as parks and recreation opportunities. These surveys ensure that the Capital Improvement Program reflects the community’s needs and aspirations.

To develop a five-year forecast of available funds for capital projects, the City performed an extensive financial forecast. Much of this forecast was created in conjunction with the five-year operating budget projections within the annual budget process. The City conservatively projects revenues to minimize spikes and account for the impact of cycles in the larger economy.
The Five-Year CIP is divided between General Government and Enterprise projects and has two primary funding sources: bonds (debt) and non-bond sources (cash). The primary drivers in estimating revenues are residential and commercial growth, as well as economic conditions. In the last several years, the City has enjoyed a relatively stable upward revenue trend. This trend has been caused by growth in population, property values, sales tax revenue, and the development of residential communities. The City anticipates continued growth during the next several years.
The City has experienced rapid population growth over the last several years. Based on already approved housing construction plans, the City projects this population growth to continue. The population chart below shows the rapid growth in the last seven years and the continued growth that is anticipated over the next nine years.
Directly tied to the population growth, Chart 2 shows the single-family home building permits issued and projected. Celina’s growth is expected to remain strong.
In addition to residential growth, the City anticipates commercial growth to begin in the next five years, particularly related to retail. The population of Celina is reaching the point where larger-scale retail can be sustained, and the City has been approached by several big-box retailers about building in Celina.
This growth in residential population and commercial development drives growth in revenues for the Five-Year CIP.

Population growth and single-family building permits have a significant impact on revenues for General Government projects. First and foremost, this growth has resulted in and is projected to continue to cause significant increases to taxable values of property within the City. There are two components to this growth. The first comes from new properties being added to the tax rolls due to residential development. The second comes from rapidly rising home values, which is being experienced across the Dallas-Fort Worth Metroplex. In FY 2026, the City’s property tax value increased by 28.26% or $2.27 billion. Of this increase $1.49 billion is attributable to new taxable values added to the tax roll. The remaining $786 million is attributable to the growth in value of existing properties.
Chart 3 shows the projected growth in taxable values over the next five years, which we anticipate remaining strong.
$16,000,000,000
$14,000,000,000
$12,000,000,000
$10,000,000,000
$8,000,000,000
$6,000,000,000
$4,000,000,000
$2,000,000,000
When applied to the tax rate, this taxable value generates property tax revenues for the General Fund and Debt Service Fund. The City’s tax rate is divided into two components, Maintenance & Operations and Interest & Sinking. The Interest & Sinking portion of the tax rate is dedicated to the Debt Service Fund and is used to repay the debt that funds general government projects.
For Fiscal Year 2026, the City has adopted a total tax rate of $0.576401. Of that, $0.264928 (45.96%) is dedicated to the General Fund for operational expenses, and $0.311473 (54.04%) is dedicated to the Debt Service Fund to pay for the City’s debt. The forecast for the Five-Year CIP maintains the Interest & Sinking rate of $0.311473 for all five years. This projected rate will fund the issuance of the Certificates of Obligation proposed within the Program.
The City anticipates that there will be an opportunity to increase the Interest & Sinking rate without raising the overall tax rate, as the 3.5% cap on the Maintenance & Operation rate is projected to result in a 1 cent or more tax rate reduction per year. Any increase of the Interest
& Sinking rate above $0.311473 in any future year would allow the City to increase forecasted bond issuances, pay off existing debt earlier, or accelerate the principal amortization of future debt. Additional analysis of the City’s debt is provided in the Debt Outlook section below.
In addition to debt revenues, the City also anticipates growth in the non-bond sources of funding for General Government Capital Projects. As the City experiences residential and commercial development, the City will receive significant non-bond revenues related to impact fees, capital recovery fees, park fees, and technology fees that will be available to invest in capital projects. The purpose of these fees is for new developments to pay for their impact on infrastructure and City services. The City has projected each non-bond revenue source independently based on trends, existing development agreements, and approved future development plans. Many of these revenue sources are restricted to specific uses, while others can be broadly invested in capital projects.
The same population, residential, and commercial growth trends are also driving enterprise project (water, wastewater, and stormwater drainage) revenue growth. The City contracted with Willdan Financial Services to perform a financial forecast for the water and wastewater utilities, which was approved by City Council on May 14, 2024. A detailed analysis of revenues is available in the 2024 Water and Wastewater Rate Study and Financial plan. An update for 2026 is currently in development and will be presented to City Council in March of 2026.

Expenditures for the Five-Year CIP are projected based on the type, size, scope, and best practices for each project type. Chart 4 summarizes the total expenditures for all projects in the CIP.
General Government Projects
Enterprise Projects
Total by Year
Costs for future capital projects are particularly difficult to predict. In the last several years, construction inflation and increasing land values have significantly increased the costs for capital projects across the CIP.
Staff has developed cost inflationary projections by project based on prior trends, design firm estimates, and other estimates based on industry best practices. We anticipate some projects to come in under cost and others over cost. We also anticipate the need to move projects between years to continually balance the CIP each year based on community needs and inflationary pressures.
Revenues:
CO Bonds
CDC Bonds
Integrity Fund
Park Fees
Street Construction
Roadway Capital Fees
Roadway Impact Fees
Technology Fund
TIRZ #11
Total Revenue
Expenses:
Facilities
Information Technology
Parks
Public Safety
Roadway
Operating Expenses
Unallocated
Total Expenditures
Projected Available Balance
$75,000,000
$1,740,000
$4,438,731
$4,215,000
$3,600,000
$2,850,000
$990,000
$2,098,620
$94,932,351
$7,500,000
$3,700,000
$18,200,000
$3,500,000
$68,051,943
$1,037,885
$2,913,920
$104,903,748
$22,996,383
$75,000,000
$20,000,000
$490,000
$4,350,000
$2,550,000
$3,600,000
$2,850,000
$850,000
$2,434,122
$112,124,122
$5,500,000
$3,600,000
$23,050,000
$27,125,000
$49,320,566
$500,000
$8,029,679
$117,125,245
$17,995,260
$60,000,000
$16,700,000
$490,000
$4,350,000
$2,540,000
$3,600,000
$2,850,000
$850,000
$2,770,990
$94,150,990
$500,000
$7,002,000
$18,250,000
$16,425,000
$41,366,266
$500,000
$10,832,724
$94,875,990
$17,270,260
$75,000,000
$490,000
$4,350,000
$2,715,000
$3,600,000
$2,850,000
$850,000
$3,028,589
$92,883,589
$500,000
$2,950,000
$12,000,000
$15,025,000
$59,986,100
$500,000
$12,462,489
$103,423,589
$6,730,260
$75,000,000
$490,000
$4,350,000
$2,715,000
$3,600,000
$2,850,000
$850,000
$3,308,948
$93,163,948
$2,000,000
$1,850,000
$18,125,000
$55,050,000
$500,000
$12,898,948 $90,423,948
$9,470,260

Revenues: CO Bonds Developer Contributions Drainage Fees Utility Impact Fees Water/Sewer Capital Recovery Fees
Expenses: Stormwater Water
Wastewater
Operating Expenses
Unallocated
Total Expenditures
Projected Available Balance
$65,500,000
$2,775,000
$4,700,000
$3,500,000
$76,475,000
$1,750,000
$59,101,405
$27,746,562
$2,697,815
$906,227
$92,202,009
$31,122,891
$71,150,000
$2,018,750
$4,700,000
$6,200,000
$84,068,750
$1,750,000
$41,350,000
$41,061,000
$1,151,103
$7,800,000
$93,112,103
$22,079,538
$68,850,000
$10,200,000
$2,243,000
$4,700,000
$6,200,000
$92,193,000
$1,750,000
$69,800,000
$23,126,000
$1,187,906
$7,800,000
$103,663,906
$10,608,632
$53,750,000
$2,452,300
$4,700,000
$6,200,000 $67,102,300
$1,750,000 $34,000,000 $22,750,000
$1,222,958
$7,800,000 $67,522,958
$10,187,974
$56,800,000
$2,660,000
$4,700,000
$6,200,000 $70,360,000
$1,750,000
$35,150,000
$30,100,000 $1,171,500 $5,450,000 $73,621,500
$6,926,474
The City issues debt annually to fund capital projects. Similar to a mortgage on a home, the City issues debt for capital projects because they require a large sum of money and last for many years (longer than the debt repayment period). Additionally, because a portion of the principal and interest are paid each year, it allows the residents who receive the benefit of the project to contribute to the cost. If the City issues 25-year debt for a new library, a resident who moves to the City in 18 years and uses the same library will contribute to the repayment of the debt for that project.
For the purposes of the Five-Year CIP, the City’s debt is divided into general, component unit, and enterprise debt.
The City’s general debt is one of the most significant components of funding for capital projects, paying for projects for all governmental activities (not utilities or component units). These are the major services that residents typically think of when they think about what a city does. General debt is supported by the Interest & Sinking Property Tax Rate.
The City annually issues Certificate of Obligation bonds to pay for core infrastructure projects. These capital projects provide critical infrastructure to address the physical growth of the City and enhancements to core City services. General debt pays for Infrastructure and Capital Projects for Roadway, Facilities, Public Safety, Parks, and Information Technology.
The Five-Year CIP proposes the issuance of $360 million in general debt across all five years. The chart below lists the amounts by year. The corresponding graph shows projected revenue in the Debt Service Fund (red), the principal and interest payments for existing debt (blue), and the principal and interest payments for the proposed general debt in (yellow). The graph shows that the Debt Fund can adequately meet the obligations of the debt proposed in the Five-Year CIP.
FY 2026: $75M FY 2027: $75M
$60M
The debt issuance projection has been developed using the FY 2026 Interest & Sinking Tax Rate of $0.311473 across all five years. The Interest & Sinking Tax Rate is the portion of the Property Tax Rate that is specifically used for the repayment of debt from bond issuances.
As stated in the Revenue Projection and Assumptions section above, the City anticipates that there will be an opportunity to increase the Interest & Sinking Rate without raising the overall tax rate, as the 3.5% cap on the Maintenance & Operation Rate is projected to result in a 1 cent or more tax rate reduction per year. Any increase of the Interest & Sinking Rate above $0.311473 in any future year would allow the City to increase forecasted bond issuances, pay off existing debt earlier, or accelerate the principal amortization of future debt.
The Celina Community Development Corporation (CCDC) is a component unit of the City. It is funded with a dedication of the sales tax rate (0.5%) and its expenditures are restricted by state law. The CCDC is projected to issue $36.7 million in bonds and support the repayment of this debt through their dedicated sales tax revenue. It is anticipated that the CCDC will issue $20 million in 2027 and $16.7 million in 2028. This debt will fund projects related to the scope of the CCDC.
The City’s enterprise debt is another significant component of funding for capital projects, paying for projects for the City’s water, wastewater (sewer), and stormwater drainage utilities. These utilities are considered independent enterprises that are solely funded through charges for service to customers. Therefore, any enterprise debt issued is repaid through water and wastewater charges for service or stormwater drainage fees.
The City annually issues enterprise Certificate of Obligation bonds to pay for core infrastructure projects. These capital
projects provide critical infrastructure to address the physical growth of the City and maintain the high-quality utility services that our residents expect. Enterprise debt pays for water lines, ground storage tanks, water towers, sewer lines, sewer treatment facilities, pumps, lift stations, drainage channel improvements, and much more.
The City conducted a Water and Wastewater Rate study in 2024 that was approved by City Council on May 14, 2024. An updated rate study is going to City Council in March 2026 and will include all updated CIP information. The rate study and long-term financial plan prepared by Wildan Financial Services included a total of $430.1 million in debt issuances from FY 2026 through FY 2030. The chart below lists the issuances by year. The corresponding graph shows projected revenue for debt in the Water/Wastewater Fund (red), the principal and interest payments for existing debt (blue), and the principal and interest payments for the proposed enterprise debt in (yellow). The graph shows that there are sufficient revenues in the Water/Wastewater Fund to support the proposed enterprise debt issuances in the Five-Year CIP.
FY 2026: $65.5M
FY 2027: $71.15M
FY 2028: $68.85M
FY 2029: $53.75M
FY 2030: $56.8M
The timing of repayment for water and wastewater debt is adjusted with each issuance with the goal of the customers being served by the capital projects having moved-in when the interest payments for the debt begin.
The Stormwater Drainage Fund does not typically issue much debt. It can issue debt and use revenues from the stormwater drainage fee to repay the debt. Generally, stormwater drainage fee revenues are used to pay cash for small-scale drainage projects.
City staff has developed a five-year financial forecast for the budget and CIP to ensure that the planned expenditures and projects are fiscally responsible. The City anticipates continued population growth, residential development, commercial development, and growth in property values over the next five years. This growth will sustain the projects within the FiveYear CIP, as presented in the next section.

CAPITAL IMPROVEMENT PROJECTS 2026-2030
FACILITIES
PARKS
SAFETY
INFORMATION TECHNOLOGY
ROADWAY

This project includes the land acquisition of approximately five acres of property for the construction of the future and final City Hall building parking garage.

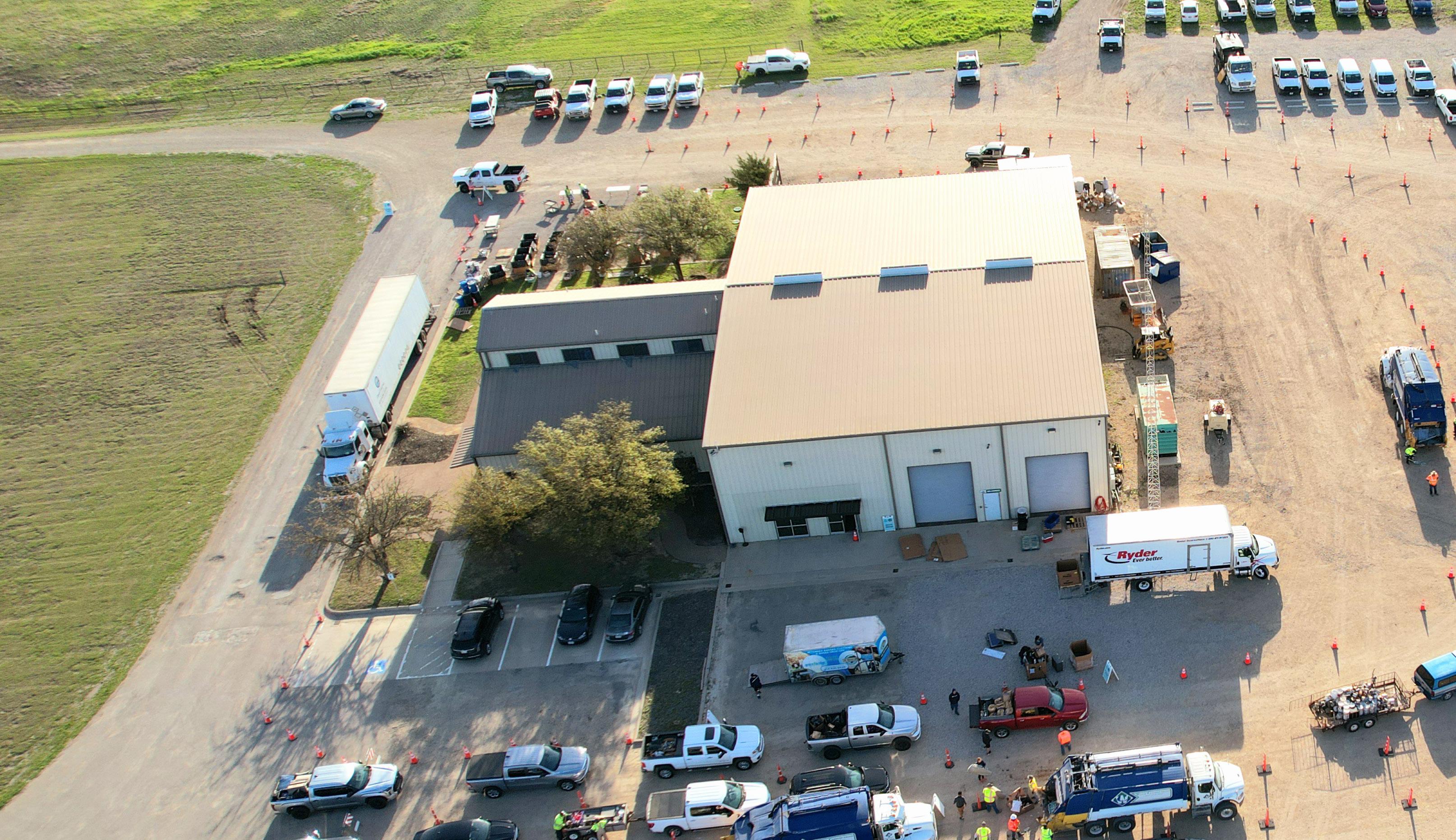

This project will be for the continued expansion of the Public Works service area. Currently, the Public Works Administration offices are housed in a home that the city purchased due to lack of space in the original public works building. The existing public works structure houses storage, a break room, and limited meeting space. This project will construct Phase 1 of the permanent Public Works Administration offices. The ultimate building is expected to be approximately 100,000 square feet and will be phased over multiple years. Phase 1 of the construction will provide meeting and locker space for approximately 200 employees, a break room, storage, and other necessary equipment. This project will be constructed in coordination with the construction of Carl Darnell Parkway from Preston Road to the Public Works property.
($1,500,000)

This project represents the continued expansion of the Public Works parking area as outlined in Phase II. This phase will include the development of a site for a fuel station and car wash dedicated to City vehicles. The addition of this facility will significantly improve the maintenance and upkeep of the City’s fleet while helping to reduce long-term fuel costs.
($3,000,000)
This project represents the continued expansion of the Public Works parking area. Phase II will include the installation of approximately 100 additional concrete parking spaces, along with a 2,000-foot fire lane that will surround the existing Public Works facility. The expanded parking capacity will accommodate staff and members of the public, while also providing the necessary space to support Public Works events and future community clean-up days.
($4,000,000)
This project represents the continued expansion of the Public Works parking area as outlined in Phase II. Phase III will include the installation of approximately 100 additional concrete parking spaces and will complete the parking area surrounding the existing Public Works building. In addition, this phase will provide connectivity between the existing Public Works facility and the temporary Public Works Administration offices located at 10317 County Road 106.

The City has identified the need to develop an independent dispatch center. The project will include the development of an interagency dispatch facility. The City is evaluating the need to step away from its current participation with the Collin County Sheriff’s Office (CCSO) dispatch center and develop a team of dedicated communications staff that will support a standalone public safety answering point (PSAP) providing call-taking and dispatching for police, fire, and emergency medical services (EMS) agencies in Celina and others that may join in the future. This project will be constructed in multiple phases.
The City will install emergency sirens in select locations throughout the City of Celina and are designed to be heard outdoors only. Emergency sirens are used to notify the public of significant weather events. Sirens are installed to provide a two-mile radius, and the final location of the sirens is dependent upon engineering design and necessity. This project includes the design and installation of approximately four emergency sirens.
The proposed facility would be located on the northwest corner of Legacy Drive and J Fred Smith Parkway. The approximately 20,000 square foot Fire Station #5 facility will be a one-story building, designed to host eleven (11) bedrooms, and have three, 80-foot fire engine bays.
Purchase an ambulance vehicle and supplies for Emergency Response services in Fire District #5. This purchase of this ambulance will be completed in coordination with the construction of Fire Station #5.
Purchase a fire truck and supplies needed for Emergency Response services in Fire District #5. The purchase of this fire truck will be completed in coordination with the construction of Fire Station #5.
The proposed remodel of the existing Fire Station #2 will allow the facility to be repurposed as an operations center for the Fire Department. The approximately 7,000-square-foot building will support department-wide functions and training activities serving multiple stations. The facility will also provide centralized storage for materials and equipment distributed to all fire stations. In addition, the existing apparatus bays will be utilized to house surplus apparatus and equipment.
Secure a secondary fire truck and the necessary supplies to provide Ladder-tiller needs required for Emergency Response services in Fire District #2.
The City of Celina constructed Fire Station #2 at Light Farms as a single-company, temporary facility intended to serve as a placeholder until the permanent station could be built. The new Fire Station #2 will be a double-company station designed to respond to incidents along the North Dallas Tollway and will be located immediately south of the existing station. The new facility will total approximately 22,000 square feet and will include five apparatus bays, sleeping quarters for sixteen firefighters, accommodations for a station officer and a battalion chief, and secure on-site parking. Upon completion of the new station, the existing Fire Station #2 will be repurposed as an operations and logistics center for the Fire Department.
($14,800,000)
The proposed police weapons range is approximately 23,000 square feet. It will be designed as a single-story building to be housed on the law enforcement campus located at Coit Road and Punk Carter Parkway. The building will house approximately twelve (12) firing lanes, a large training classroom, ammo storage area, a range master office, and a weapons cleaning room. The facility will not be open to the public and will be used by the police to meet mandatory training and testing requirements.
($2,000,000)
Purchase of secondary fire truck at Fire Station #1. This purchase will help maintain service levels and response times in Fire District #1.

($100,000)
Koch Park is located along Choate Parkway between Coit Road and Roseland Parkway. The 90-acre park is located east of Wilson Creek Estates and west of Mustang Lakes. The land will be located immediately west of a future Celina ISD Elementary campus. This project will master plan this park for future development.
($6,000,000)
The south baseball complex at Old Celina Park currently consists of natural grass fields. This project will convert the existing grass fields to artificial turf to match the north baseball complex. The upgrades will be implemented in phases, with one field completed annually until all four fields have been converted.
($24,700,000)
This project will construct the remainder of Ousley Park. This phase will include a splash pad, large entry fountain feature, structured and natural playgrounds, open-air pavilion, pedestrian bridges, memorial walk, dog parks, pickleball courts, and parking. This project is being developed as part of the approved Ousley Park Master Plan.
($22,000,000)
The City of Celina Parks Master Plan has identified the need for approximately 1,400 acres of public parkland. The City of Celina will look for opportunities to increase available park land for public use.
($18,700,000)
Wilson Creek Park Phase II will develop an additional 20 acres of the park. Phase II park amenities will include two open multi-sports fields, lighted baseball fields, restroom and concession buildings, and field lighting. This project development will follow the approved Wilson Creek Park Master Plan.

($7,500,000)
As Celina expands its critical infrastructure, the requirement for reliable communications to water, wastewater, and public safety facilities is becoming a critical component. This project will continue with regular expansions of the City’s fiber network to connect fire stations, city facilities, water, and wastewater.
Audio/Visual Refresh ($920,000)
Audio/Visual Refresh Project will replace end of life and end of support Audio/Visual and conferencing equipment used throughout the City. Each facility utilizes Audio/Visual systems to host meetings both physically and virtually for efficient collaboration and training. This project will include the procurement and installation of various Audio/Visual systems throughout the City.
This project allows the City to replace and retire end-of-life security cameras at various City facilities. This will enable the city to consolidate multiple disparate security systems into a single unified platform. This upgrade will enhance the ability for first responders to have access to city cameras during critical events.
As technology is becoming more prevalent, the use of electronics in criminal activity is increasing drastically. This project will replace and expand the storage used by police for digital evidence collected during investigations. By replacing the end of life / end of support hardware, the city will protect its ability to retain critical digital evidence.
The downtown WIFI expansion will extend coverage beyond the square to include additional areas of Celina’s Life Connected free public Wi-Fi within downtown Celina. This expansion will allow more residents and visitors to enjoy access and connection to high-speed internet while downtown.
($1,200,000)
The core infrastructure within the Information Technologies framework requires replacement and upgrades over time. The facilities upgrades and replacements are specific purchases for network switches, Audio/Visual equipment, access control, network equipment and cameras.
The network switch and firewall refresh project will replace end of life / end of support for networking equipment used throughout the City. Each facility utilizes network switches to connect computers, phones, wireless access points, cameras, and numerous other devices to each other. This project will include the procurement and installation of network switches and firewalls that are the core of technology communications within the City.
The city is replacing its current cloud-based Voice over Internet Protocol (VoIP) phone system with a comprehensive unified communications solution using Microsoft Teams. This initiative is aimed at modernizing the city’s communication infrastructure, enhancing system reliability, and consolidating various communication tools into a single, streamlined platform.
($1,500,000)
Maintaining and extending the City’s operational capacity to deliver services to its residents. This project will replace and refresh end of life / end of support servers and networking equipment used at the City’s primary datacenter. This project will include the procurement and installation of new servers, storage, and network switches.
($1,500,000)
The City of Celina maintains a Secondary Data Center that houses a backup of the city’s primary servers and communications. As technology evolves, existing equipment will need to be replaced accordingly at the end of support lifecycles. The city has all server equipment on a five-year replacement schedule.
($2,000,000)
This project will focus on conducting an inventory and condition assessment of existing traffic signals, developing citywide traffic signal standards and upgrading signal cabinets and controller equipment. The program will also include the installation of intelligent transportation system technologies such as traffic cameras, expand fiber network and install advanced signal operations software. It will also include safety enhancements such as accessible pedestrian signals and intersection lighting.
($412,000)
The wireless network refresh project will replace end of life / end of support for wireless networking equipment used throughout the City. Each facility utilizes wireless access points to provide wireless connectivity to City staff and visitors. This project will include the procurement and installation of wireless access points across all City facilities.

CAREY ROAD - SMILEY TO LEGACY
CARL DARNELL PARKWAY - PRESTON TO PUBLIC WORKS
CHOATE PARKWAY - KINSHIP TO ROSELAND
COIT ROAD - CHOATE TO OUTER LOOP
COIT ROAD - FRONTIER TO 1400 FEET NORTH OF FRONTIER
COIT ROAD - J FRED SMITH TO GA MOORE
DALLAS NORTH TOLLWAY (DNT) INTERSECTION

The Annual Street Maintenance (ASM) project provides for annual allowance for on-going maintenance of existing roadways. Each year, the ASM will include crack sealing, concrete panel replacements, spot repairs to various asphalt roadways, sidewalk repairs, striping, and concrete panel lifting with foam injection that are determined annually. The ASM improvements may include full-depth reclamation (FDR) and pavement overlay for streets. These streets are listed below by year:
The 2026 ASM project consists of repairs to the following streets: ($6,000,000)
• S. Louisiana (Walnut to end of GD Property (FDR +Culvert Repair),
• Ash Street from Oklahoma to BNSF Railroad (FDR)
• E. Walnut from N. Arkansas to S. Louisiana Drive (FDR)
• W. Ash from Utah to W of S. Alabama tie into Concrete (FDR)
• S. Colorado from W. Walnut to 519 S. Colorado (FDR)
• Lynn Stambaugh from Preston to Coit (Mill and Overlay + FDR)
The 2027 ASM project consists of repairs to the following streets: ($6,000,000)
• Phase 1 of North Preston Lakes (FDR)
• S. Arizona from Walnut to W. Elm (FDR)
• S. Illinois from Walnut to W. Elm (FDR)
The 2028 ASM project consists of repairs to the following streets: ($6,000,000)
• CR 101 from FM 455 to CR 97 (Joint Ownership Sections) (FDR)
• Phase 2 of North Preston Lakes (FDR)
• CR 58 - Celina Parkway to Marilee Road
• CR 8 - FM 455 to DNT
The 2029 ASM project consists of repairs to the following streets: ($6,000,000)
• Celina Road from FM 428 to Smiley Road (Convert existing gravel to Asphalt)
• N. Illinois from W. Walnut to N. End (FDR)
• S. Illinois from W. Walnut to W. Elm (FDR)
• S. Ohio from W. Walnut to S. End (FDR)
• CR 58 - Celina Parkway to Marilee Road
• CR 8 - FM 455 to DNT
The 2030 ASM project consists of repairs to the following streets: ($6,000,000)
• CR 131 from Prop ID 2871719 to CR 133 (Joint Ownership Sections) (FDR)
• CR 133 from CR 131 to Prop ID 2674280 (Joint Ownership Sections) (FDR)
• Marilee from CR 58 to DNT (FDR)
• CR 106 from Preston to CR 132 (Joint Ownership Sections) (Surface Treatment - PressurePave)
• Lake Dr from CR 128 to end (Surface Treatment - PressurePave)
• CR 134 from Preston to CR 132 (Joint Ownership Sections) (FDR)
• CR 970 (DNT to Private Road 5155)
This project consists of the reconstruction of the existing gravel road to a 37-foot concrete street. Concrete paving, drainage, signage, and pavement markings will be included in the project. Sidewalks, lighting and landscaping will not be included in the project. This project is a shared construction project with the adjacent developers.
($3,412,922)
This project consists of the construction of a new primary arterial. This project will construct the first two lanes within the ultimate right-of-way of a six-lane divided arterial. Concrete paving, drainage, signage, and pavement markings will be included in the project. Sidewalks, lighting and landscaping will not be included in the project.
($1,417,000)
This project consists of the reconstruction of the existing two-lane asphalt roadway to a two-lane divided arterial within the right-of-way of an ultimate six-lane divided arterial. Concrete paving, drainage, signage, and pavement markings will be included in the project. Sidewalks, lighting and landscaping will not be included in the project.
($1,942,560)
This project consists of the reconstruction of the existing two-lane asphalt roadway road as a four-lane divided primary arterial within the ultimate right-of-way of a six-lane divided arterial. The project will include paving, drainage, signage, lighting, landscape, and pavement markings. Sidewalks will be constructed on the west side of the roadway.
($1,300,000)
This project consists of the reconstruction of the existing two-lane asphalt roadway to a four-lane divided arterial within the right-of-way of an ultimate six-lane divided arterial. Concrete paving, drainage, signage, and pavement markings will be included in the project. Sidewalks, lighting and landscaping will not be included in the project. This project will be completed in conjunction with the Town of Prosper and the construction of Coit Rd from Frontier Pkwy south within the Town of Prosper.
($2,000,000)
This project consists of the reconstruction of the existing road as a two-lane asphalt roadway as a four-lane divided arterial within the ultimate ROW of a six-lane divided arterial. Concrete paving, drainage, signage, lighting, landscaping, and pavement markings will be a part of this project. Sidewalks will be included adjacent to developed areas. This project is a shared construction project with the adjacent developers.
($16,418,232)
This project includes traffic signal design and installation along the North Dallas Parkway at Light Farms Way and Punk Carter. Collin County Outer Loop traffic signal will be constructed as part of the westbound frontage road project through Collin County. The traffic signal at FM 428 will be constructed by the Texas Department of Transportation. This project also includes the construction of U-turn lanes at each bridge intersection and additional pavement width not within the scope of the North Texas Toll Authority (NTTA) DNT project.
This project consists of the construction of a new primary arterial. This project will construct the first two lanes within the ultimate right-of-way of a six-lane divided arterial. Sidewalks, lighting and landscaping will not be included in this project. This project is a shared construction project with the adjacent developers.
The downtown street project is a dedicated funding source for downtown streets. Each project will include the conversion of the existing asphalt street to a 29-foot concrete residential street. The construction will include paving, drainage, water, sewer, and sidewalks. Streetlights will be updated to match current subdivision standards. The capital improvement program is designed to fund a series of streets in a single comprehensive project that will allow multiple streets to be designed and constructed together. In 2026, the City Council set a policy to convert all downtown streets within a 10 – 15year timeframe. The streets listed in the proposed projects below begin the process of meeting the City Council’s policy directive.
The 2026 Downtown Streets consists of the following streets: ($17,850,000)
• S. Ohio & S Louisiana - Ash to south end (construction)
• N. Illinois – Pecan to Walnut (design and construction)
• S. Alabama – Sunset to W Oak (design)
• S. Louisiana (design)
• S. Louisiana – Main to Ash
• W. Elm St – BNSF to Louisiana
• W. Ash St – BNSF to Louisiana
• Cherrywood - Oklahoma to E End (design)
• Ousley Park Streets (design)
• S. Arkansas - Ash to Pecan
• E. Elm St - Preston to Texas
• E. Oak St - Arkansas to Texas
• S. Texas - Ash to Elm
• Downtown Square Streets (design)
• W. Pecan - Louisiana to Colorado
• N. Ohio - Walnut to Pecan
• S. Ohio - Walnut to N of Beech
• S. Ohio Streets (design)
• S. Ohio Drive - Ash to Main
• W. Elm St - Louisiana to S Ohio
• W. Oak St - S Louisiana to Ohio
• W. Ash St - S Louisiana to Ohio
• S. Colorado Streets (design)
• S. Colorado - Ash to Elm
• W. Ash - Ohio to Colorado
• W. Oak St - Ohio to Colorado
• W. Elm St - Ohio to Colorado
The 2027 Downtown Streets consists of the following streets: ($15,720,000)
• S. Alabama – Sunset to W Oak (construction)
• S. Louisiana (construction)
• S. Louisiana – Main to Ash
• W. Elm St – BNSF to Louisiana
• W. Ash St – BNSF to Louisiana
The 2028 Downtown Streets consists of the following streets: ($24,300,000)
• Cherrywood - Oklahoma to E End (construction)
• Ousley Park Streets (construction)
• S. Arkansas - Ash to Pecan
• E. Elm St - Preston to Texas
• E. Oak St - Arkansas to Texas
• S. Texas - Ash to Elm
• Downtown Square Streets (construction)
• W. Pecan - Louisiana to Colorado
• N. Ohio - Walnut to Pecan
• S. Ohio - Walnut to N of Beech
The 2029 Downtown Streets consists of the following streets: ($13,254,000)
• S. Ohio Streets (construction)
• S. Ohio Drive - Ash to Main
• W. Elm St - Louisiana to S Ohio
• W. Oak St - S Louisiana to Ohio
• W. Ash St - S Louisiana to Ohio
• E. Malone - Preston to Louisiana (construction)
The 2030 Downtown Streets consists of the following streets: ($15,500,000)
• S. Colorado Streets (construction)
• S. Colorado - Ash to Elm
• W. Ash - Ohio to Colorado
• W. Oak St - Ohio to Colorado
• W. Elm St - Ohio to Colorado
• Lakeview Way East (design)
• W. Oak - S. Colorado to Alabama
• Alabama - W. Oak Street to Walnut
• S. Arizona Dr - Ash to W. Oak
• W Main Streets (design)
• W. Main Street – S. Louisiana
• S. Illinois - W. Walnut to W Elm
• S. Arizona Dr - W. Walnut to W Elm
• S. Colorado - W. Walnut to W Elm
• S. Ohio - W. Walnut to W Main
• S. Louisiana - W. Walnut to W Main
Glendenning Parkway – FM 428 to Preston ($1,000,000)
This project will include full depth reclamation of the existing asphalt street and will include pavement markings. Drainage, sidewalks, lighting, and landscaping are not part of this project. Improvements to the railroad crossing will also be completed as part of this project.
Fred Smith Pkwy – Lakeway to Coit ($4,620,536)
This project consists of the construction of the first two lanes within the ultimate ROW of a six-lane divided arterial. The project will construct two lanes of concrete paving, drainage, signage and pavement marking improvements will be part of this project. Sidewalks will be constructed adjacent to developed areas. No lighting and landscaping will be included in this project. This project is a shared construction project with the adjacent developers
Kristina Court ($2,300,000)
This project will include the reconstruction of the existing two-lane asphalt road with signage and pavement marking improvements. No drainage, lighting or landscaping will be included in this project.
Legacy Drive – Carey Road to Punk Carter ($14,746,000)
This project consists of the reconstruction of the existing two-lane gravel road as a two-lane concrete primary arterial within the ultimate ROW of a six-lane divided arterial. This project includes the construction of a bridge over Doe Branch creek. Drainage, signage, and paving marking improvements will be a part of this project. Lighting and landscaping will not be included in this project.
This project consists of the construction of a new primary arterial. This project will construct the first two lanes within the ultimate right-of-way of a six-lane divided arterial. Sidewalks, lighting and landscaping will not be included in this project. This project is a shared construction project with the adjacent developers.
This project consists of the reconstruction of the existing two-lane gravel road as a two-lane concrete primary arterial within the ultimate ROW of a six-lane divided arterial. This project includes the construction of a bridge over Doe Branch creek. Drainage, signage, and paving marking improvements will be a part of this project. Lighting and landscaping will not be included in this project.
This project consists of the reconstruction of the existing two-lane asphalt road as a two-lane concrete primary arterial within the ultimate ROW of a six-lane divided arterial. Drainage, signage, and paving marking improvements will be a part of this project. Lighting and landscaping will not be included in this project.
This project consists of the full-deep reclamation of the existing asphalt roadway on CR 94 from Preston to Coit Road. Drainage, sidewalks, lighting and landscaping will not be included in this project.
This project will be constructed in two phases.
•
Phase 1 will be the reconstruction of the existing asphalt roadway as a four-lane concrete roadway within the ultimate right-of-way of a six-lane divided arterial from Preston Road to 800 feet west of Preston. Phase 1 improvements will include concrete paving, drainage, lighting, signage, and pavement markings. Sidewalks will not be included in this phase. Railroad improvements will be included in this construction project through coordination with BNSF Railroad. This project is a shared construction project with the adjacent developers. (R84)
•
Phase 2 will include asphalt improvements to the existing asphalt road from west of E Cashion Circle to DNT within the city limits. Phase 2 includes asphalt paving, signage, and pavement markings, but does not include drainage, lighting, or sidewalks.
This project consists of the design and construction of median design on divided arterial roadways. No specific projects have been identified, but projects will be identified over the next five years as four-lane divided roadways are completed.
($7,849,710)
This project will construct the third and fourth lanes within the ultimate right-of-way of a six-lane divided arterial. This project includes paving, drainage, signage, lighting, landscaping, and pavement markings. Sidewalks may be included in this project adjacent to developed areas.
This project consists of the reconstruction of the existing two-lane asphalt road as a four-lane divided primary arterial within the ultimate right-of-way of a six-lane divided arterial. This project includes paving, drainage, lighting, landscaping, signage, and pavement markings. Sidewalks will be constructed adjacent to developed areas. This project is a shared construction project with Denton County, and the Town of Prosper.
($2,993,644)
The Preston Road right turn lanes will be an annual implementation of funding for the construction of needed right turn lanes along Preston Road between Frontier Parkway and Legacy Drive.
• 2026 – NB Preston at Punk Carter
• 2027 – NB Preston at Lynn Stambaugh
• 2028 – NB Preston at CVS Driveway
• 2029 – SB Preston at Elm Street
• 2030 – NB Preston at Carter Ranch Retail Driveway
This project consists of the construction of multiple arterial and collector roads within the Ramble subdivision. Concrete paving, drainage, signage, lighting, and pavement markings will be included in the project. Landscaping will not be included in the project. This project will be a shared project between the City and the adjacent subdivision developer.
This project will construct the four lanes of Roseland Parkway from Sunset to the Big Bend Lane and four lanes of Sunset Boulevard from Roseland Parkway to Wilson Creek within the ultimate right-of-way of a six-lane divided arterial. This project is being completed in coordination with the construction of Wilson Creek Park. Sidewalks, lighting and landscaping will be included in this project. This project is a shared construction project with the adjacent developers.
($500,000)
This project will provide an annual allocation of funding to install reduced speed zone and additional school traffic control for the projected 2-3 new schools within the City of Celina. These projects will serve both Prosper ISD and Celina ISD and will be developed in coordination with the school districts.
This project consists of the reconstruction of the existing asphalt roadway as a concrete roadway. This project will construct the first two lanes within the ultimate right-of-way of a six-lane divided arterial. Paving, drainage, sidewalks, signage and pavement marking improvements will be part of this project. Lighting and landscaping will not be included in the project.
This project consists of the construction of a new primary arterial. This project will construct the first two lanes within the ultimate right-of-way of a six-lane divided arterial. Concrete paving, drainage, signage, and pavement markings will be included in the project. Lighting and landscaping will not be included in the project.
($12,833,000)
This project will provide funding for additional roadway projects with the city of Celina. These projects could result from an unexpected issue that arises through the year or could be a partnership between the city of Celina and a developer to facilitate a new roadway construction or possible reconstruction.
This project will be annual funding to construct two traffic signals within the City of Celina. The funding will include the full construction of the traffic signal. If TxDOT constructs the traffic signal, the city will be responsible for the cost of powder coating, illuminated name blades, and Opticom. The final location of the traffic signals will be determined based on traffic demands.

CAPITAL IMPROVEMENT PROJECTS 2026-2030
WATER/WASTEWATER
STORMWATER

WATER LINE ALONG DALLAS NORTH TOLLWAY (DNT) FROM PUNK CARTER TO AVILLA
12” Water Line Along Dallas North Tollway (DNT) from Punk Carter to Avilla ($2,700,000)
This project includes the construction of a 12-inch water line along the NB DNT from Punk Carter Parkway to connect to the existing 12” line along DNT located south of Doe Branch. The proposed project will provide additional capacity to serve future growth in the southern area of the low-pressure plane and provide additional supply to the Light Farms EST. The 2025 Impact Fee Study identified this as Project 6.
18” Water line on Doe Branch Boulevard from Clear Creek to Dallas Parkway ($500,000)
This project is for the installation of an 18-inch waterline along Doe Branch Boulevard from Clear Creek Parkway to Dallas Parkway. This project will serve the low-pressure plane west of Preston Road and will be a shared project between the City and the adjacent subdivision developer. The 2025 Impact Fee Study identified these as Projects 11 and 12.
24” Water Line on GA Moore from Coit to Custer ($5,692,940)
This project will include the installation of a 24-inch water line along GA Moore Parkway from Coit to Custer. This project will serve the high-pressure plane east of Preston Road. This project will be a shared project between the City and the adjacent subdivision developer.
24” Water Line on J Fred Smith from Preston to Coit ($4,207,060)
This project includes the installation of a 24-inch water line on J Fred Smith from Preston to Coit. This project will serve the high-pressure plane east of Preston Road. This project will be a shared project between the City and the adjacent subdivision developer. The 2025 Impact Fee Study identified this as Project 23.
3.0 MGD Low-Pressure Plane Elevated Storage Tank (Uptown) ($17,400,000)
This project includes the construction of a new 3.0-million-gallon elevated storage tank (EST) in the low-pressure plane. The proposed EST will be located near the intersection of FM 455 and J Fred Smtih Parkway within the Villages of Uptown Development. The proposed project will provide additional storage capacity to serve future growth in the low-pressure plane. The 2025 Impact Fee Study identified this as Project 1.
36” Water Line on Coit Rd (Glendenning to Sunset) ($5,400,000)
This project includes the installation of a 36-inch water line on Coit Road from Glendenning Parkway to Sunset Boulevard. This project will serve the high-pressure plane east of Preston Road. The 2025 Impact Fee Study identified this as Project 7.
54” Water Line on Dallas Parkway from Celina Road Pump Station to J Fred Smith Pkwy ($11,350,000)
This project includes the installation of a 42-inch water line on Dallas Parkway from Celina Road Pump Station to J Fred Smith Parkway. This project will serve the low-pressure plane west of Preston Road. The 2025 Impact Fee Study identified this as Project W.
54” Water Line on Glendenning Parkway from Celina Road Pump Station to DNT ($15,900,000)
This project is for the installation of a 54-inch waterline along Glendenning Parkway from Celina Road Pump Station to Dallas Parkway. This project will serve the high-pressure plane east of Preston Road. The 2025 Impact Fee Study identified this as Project 2.
($8,000,000)
This project will fund the acquisition of remainder of CCN from Mustang/Marilee through interlocal agreement for $18,000,000 to fund over 11 years.
($18,150,000)
This project will fund the construction of two ground water wells that will be used to supplement the water supply from Upper Trinity Regional Water District. One well will be located at Celina Road Pump Station. The second well will be constructed at the Southeast Pump Station. Each well is projected to have a capacity of 750,000 gallons per day. The 2025 Impact Fee Study identified this as Project 55.
This project includes the construction of an additional 6 MG Ground Storage Tank at Celina Road Pump Station. The proposed project will provide additional storage capacity to serve future growth in both the low-pressure plane and highpressure plane. The 2025 Impact Fee Study identified this as Project D.
This project includes a new 20 MGD firm capacity pump station at the Celina Road Pump Station Site. The proposed project will provide additional pumping capacity to serve future growth in the low-pressure plane and supply the Sunset Pump Station and Ground Storage Tank. The 2025 Impact Fee Study identified this as Project 27.
($1,254,000)
This project is for the installation of a 12-inch waterline along Choate Parkway from Kinship Parkway to Roseland. This project will serve the high-pressure plane east of Preston Road. The 2025 Impact Fee Study identified this as Project U.
($1,000,000)
This project includes the decommissioning of the Downtown Pump Station. The construction of Southeast Pump Station and associated projects will supply the high-pressure plane and replace the Downtown Pump Station. The 2025 Impact Fee Study identified this as Project 3.
This project includes an annual allocation for improvements to the Downtown water system. Projects could include installation of new water lines, replacement of old water lines, or a combination of both. The projects are identified annually based on needed repairs, ancillary projects, or system improvements.
($3,016,125)
This project is for the installation of a 12-inch waterline along Frontier Parkway from Preston Hills Circle to Coit Road. This project will serve the high-pressure plane east of Preston Road.
($16,000,000)
This project will fund the construction of a 54-inch water line on Glendenning Parkway from FM 428 to the Southeast Pump Station. This project is being completed in coordination with the construction of the Southeast Pump Station and Ground storage tank. This project will serve the high-pressure plane east of Preston Road. The 2025 Impact Fee Study identified this as Project Y.
($106,280)
This project provides funding to increase the proposed 8-inch water line to be constructed as part of the Hillside Village subdivision to a 18-inch water line. This project will serve the high-pressure plane east of Preston Road and will be a shared project between the City and the adjacent subdivision developer. The 2025 Impact Fee Study identified this as Project Q.
($350,000)
This project consists of the payment for the oversize of multiple water lines within the Rainwater subdivision beyond the requirements for the subdivision. This project will serve the high-pressure plane east of Preston Road and will be a shared project between the City and the adjacent subdivision developer. The 2025 Impact Fee Study identified these as Projects 36 and 37.
Ramble Water Oversize ($6,000,000)
This project consists of the payment for the oversize of multiple water lines within the Ramble subdivision beyond the requirements for the subdivision. This project will serve the high-pressure plane east of Preston Road and will be a shared project between the City and the adjacent subdivision developer. The 2025 Impact Fee Study identified these as Projects 34,35,37, 38, and 39.
Relocation of 12-inch and 36-inch Waterlines along FM 428 – DNT to Preston ($10,200,000)
This project funds the relocation of two waterlines on FM 428 between DNT and Preston Road. This relocation is necessitated by the realignment of Glendenning Parkway from DNT to Preston Road.
This project will fund the construction of an 8-million-gallon ground storage tank and a new 25 million gallon per day pump station to serve the high-pressure plane east of Preston Road. The 2025 Impact Fee Study identified this as Project X.
This project funds the review of the current subdivision and engineering design standards for water conservation measures.
This project will upsize the existing 8-inch (8”) gravity sewer line to a 12-inch (12”) along Preston Road from south of E Sunset Boulevard to Oklahoma (B 289). The 2025 Impact Fee Study identified this as Project 3.
This project constructed the water and wastewater infrastructure associated with the development of Cambridge Crossing through a development agreement executed in 2017. This project funds the final two of eight payments to the developer.
This project will fund the upsizing of 1,670 linear feet the existing eight-inch (8”) gravity sewer to a twelve-inch (12”) gravity sewer. The 2025 Impact Fee Study identified this as Project 2.
($4,000,000)
The Downtown Sewer Project will upsize a series of undersized gravity sewer lines in the Downtown area beginning at Preston Rd and extending west toward the Downtown Treatment Plant. The project includes 1,390 feet of 18” line, 7,740 feet of 24” line, 1,520 feet of 30-inch line, and 30-feet of 36” line. The 2025 Impact Fee Study identified this as Project 4.
($4,000,000)
The Downtown Sewer Upgrades – Permanent City Hall will upsize sewer lines adjacent to the future permanent City Hall.
The existing Downtown Water Reclamation Plant can serve a treatment capacity of 0.95 MGD. This project will expand the existing treatment capacity from 0.95 MGD to 3.0 MGD. The 2025 Impact Fee Study identified this as Project 1A.
($4,500,000)
This project will upgrade the existing lift station with an additional 4.6 MGD, making the firm capacity of this lift station 13.8 MGD. This project will also install 890 linear feet of 24-inch force main. The 2025 Impact Fee Study identified this as Project 17.
($40,000,000)
The existing Legacy Hills Water Reclamation Plant can serve a treatment capacity of 0.95 MGD. This project will expand the existing treatment capacity from 0.95 MGD to 2.0 MGD. The 2025 Impact Fee Study identified this as Project 77A.
($2,000,000)
The parallel Doe Branch interceptor will install 14,670 linear feet of 48-inch gravity sewer pipe between Legacy and Dallas Parkway. The 2025 Impact Fee Study identified this as Project 15B.
($22,500,000)
The parallel Doe Branch interceptor will install 3,570 linear feet of 42-inch gravity sewer pipe and another 9,560 linear feet of 48-inch sewer pipe. The project also consists of the installation of 1,710 linear feet of 42-inch gravity sewer between Dallas Parkway and Field View Court. The 2025 Impact Fee Study identified this as Projects 15A and 15A(2).
The project will construct the 18” water line through the Parks at Wilson Creek from Outer Loop to Sunset Boulevard and will be a shared project between the City and the adjacent subdivision developer. The project will also construct a 24” wastewater line south of Sunset Parkway to connect to the existing Wilson Creek wastewater line.
($1,000,000)
This project will upsize 1,670 linear feet of existing eight-inch (8“) sewer line to twelve-inch (12”) gravity sewer line, expand capacity of existing lift station to 1.5 MGD and upsize the existing 6-inch (6”) force main to an 8-inch (8”) force main. The 2025 Impact Fee Study identified this as Project 7.
($6,325,000)
This project will install 8,840 feet linear feet of gravity sewer line from BNSF railroad to Wilson Creek. This project will be completed in cooperation with the developers of Ramble and Rainwater as part of the development of their subdivision. The 2025 Impact Fee Study identified this project as Projects 33B, 33C, and 33D.
($2,026,562)
This project will upsize the proposed 8” sewer line to a 30” sewer line extending from the Rasor Water Reclamation Plant to the Serenade development. This project will be completed in cooperation with the developers of the Serenade subdivision. The 2025 Impact Fee Study identified this project as Projects 78 and 88.
($1,570,000)
The project includes an allocation of funding for the installation of oversize utility projects within the City of Celina that have been identified in the capital improvement master plan. Oversizing projects are coordinated with the development of adjacent property.

($3,750,000)
This project includes a $750,000 annual allocation for improvements to the drainage system throughout the city. Projects could include regrading existing drainage channels, the installation of new drainage pipes, the replacement of existing drainage culverts, or a combination of these projects. The projects are identified annually based on needed repairs, ancillary projects, or system improvements.
2026 Annual Drainage Projects ($750,000)
• BNSF - Elm to Beech (Regrade and elevation adjustments)
• Old Celina Park (Drainage and outfall adjustments/reestablishment)
• Redbud Street & Missouri (Regrading and culvert replacements)
2027 Annual Drainage Projects ($750,000)
• North Preston Lakes Dr (Phase 1)
• Preston Hills Circle
• Laughlin Ln (add inlet and regrade) – design & construction
• 712 W. Main St (road flooding solution) – design & construction
• Sunset to Winn Rd Regrading (Lykins Elementary) - design
• Heritage Drainage (culvert replacements) - design
• Smiley Drainage Improvements - design
2028 Annual Drainage Projects ($750,000)
• North Preston Lakes Dr (Phase 2) - construction
• Sunset to Winn Rd Regrading (Lykins Elementary) - construction
• Heritage Drainage (culvert replacements) - construction
• Smiley Drainage Improvements - construction
• Ohio/Walnut Trench Drain (EDC) - design
• NW corner of Louisiana and Ash - design
• S. Ohio (Walnut to W. Elm) - design
• NE Corner of W. Elm and S. Arizona - design
2029 Annual Drainage Projects ($750,000)
• North Preston Lakes Dr (Phase 3)
• Ohio/Walnut Trench Drain (EDC) – construction
• NW corner of Louisiana and Ash – construction
• S. Ohio (Walnut to W Elm) – construction
• NE Corner of W Elm and S Arizona – construction
• Kentucky Swell Regrading – design
• South End of Ohio Regrading - design
2030 Annual Drainage Projects ($750,000)
• Kentucky Swell Regrading – construction
• South End of Ohio Regrading – construction
• Alabama/Bois D’Arc Intersection - design
Drainage ($5,000,000)
This project includes an annual allocation for improvements to the Downtown drainage system. Projects could include the installation of new drainage pipes, replacement of old culverts, or a combination of both. The projects are identified annually based on needed repairs, ancillary projects, or system improvements.
