Hanseatic Energy Hub GmbH (HEH) has commissioned a consortium led by global EPC specialist, Técnicas Reunidas S.A., to develop the land-based terminal for liquefied gases, subject to HEH´s final investment decision (FID). Further consortium partners are the FCC Group and Entrade GmbH. The privately-organised terminal project is intended to help secure Germany's supply of LNG and green gases from 2027 and, at the same time, prepare for the market ramp-up of hydrogen. The infrastructure and commercial marketing of the hub are designed in such a way that a move to ammonia can take place in a future-flexible manner.
Técnicas Reunidas has designed and developed more than 1000 infrastructure and industrial facilities worldwide. Among them are numerous projects along the value chains for LNG and hydrogen. The company, which is headquartered in Madrid, Spain, will take over the planning and management of the construction phase and will undertake all the equipment and materials supply work for the project. The FCC Group, also from Spain, will carry out all the site preparation work at the Stade industrial park, as well as the construction of the terminal. FCC can draw on extensive experience in the construction of liquid gas tanks. In Spain alone, the company has already built and commissioned eight LNG storage plants. Entrade, a subsidiary of the Turkish ENKA Group, will be responsible for the electromechanical assembly. The engineering and construction company is already active near Stade today.
A FID will be taken in summer 2023. The projected investment volume for the terminal is around €1 billion.
The Hanseatic Energy Hub is a future-flexible modular system for the energy transition that maximises the diverse opportunities offered by the Stade energy region. In a first expansion stage, LNG, as well as green energy sources such as bio-LNG and synthetic natural gas, can be imported via the emission-free terminal from 2027. The planned regasification capacity is 13.3 billion m3/y.
The President of the Republic of the Congo, Denis Sassou Nguesso, and the CEO of Eni, Claudio Descalzi, has laid the foundation stone of Congo LNG, the country's first natural gas liquefaction project and one of Eni's core supply diversification initiatives. The project is expected to reach an overall LNG production capacity of 3 million tpy (approximately 4.5 billion m3/y) from 2025.
Congo LNG will exploit the huge gas resources of Marine XII, fulfilling the country’s power generation needs while also fuelling LNG exports, supplying new volumes of gas to international markets focusing on Europe.
The project, made though an accelerated development schedule and a zero-flaring approach, will see the installation of two floating LNG (FLNG) plants at the Nenè and Litchendjili fields – already in production – and at the fields yet to be developed. The first FLNG plant, currently under conversion and with a capacity of 0.6 million tpy, will begin production in 2023. The second FLNG plant – already under construction – will become operative in 2025, with a capacity of 2.4 million tpy.
Chart’s LNG power generation solutions provide natural gas to hundreds of thousands of homes. This is one way Chart facilitates LNG as a safe, clean-burning fuel for energy, transportation and industry.
Gas will play an increasingly important role in the energy transition from fossil fuels to renewables, and for long-term sustainability. The Ukraine crisis has placed increasing pressure on the sourcing of gas, particularly for European countries.
As a result, there has been a significant increase in orders over the last year for floating LNG (FLNG) and FSRUs, aimed at improving independence and resilience in gas supplies for those countries re-sourcing their energy.
Continuity of supply through those floating assets will be critical, particularly avoiding down time for surveys and repairs.
FSRUs are complex, high value assets and are being deployed more widely. Reliability and continuity of supply is essential. They remain on station for extended periods, either alongside, nearshore, or offshore, but mostly in shallow water. Turbid waters, high currents, and terminal operator restrictions make in-water inspections difficult, particularly for divers.
FLNG units are also high value and complex, with the different function of exploiting gas fields where little infrastructure exists or where the gas fields are ‘stranded’.
Both asset types have the normal marine integrity requirements driven by regulations and class rules, but they also have LNG tanks whose integrity must be assured with minimal operational disruption.
But is this situation exceptional, or does it need a radical change to asset integrity methodology? Drawing on a depth of experience in the floating energy production sector, particularly offshore oil and gas assets, EM&I believes that it does not need radical change from many of the strategies and methods recently developed and used.
Building on the work of industry collaboration forums, such as the hull inspection techniques and strategy joint industry project (HITS JIP), with contributors from across the value chain – energy majors, operators, class, inspection companies, and academic institutions
Danny Constantinis, EM&I Group, Malta, provides insight into new asset integrity management challenges following a rapid increase in the deployment of FSRUs and floating LNG units.
– many lessons are applicable to the growing number of floating gas assets and the maintenance of their operational continuity.
These include minimising the requirement for diver intervention, the remote inspection of confined spaces, managing marine pressure system, and ex equipment integrity.
The advantage of using modern methods is the reduction in risk and cost including, of course, the safety risk of physical human intervention, both equally applicable.
Indeed, a new JIP – the FloGas JIP – with a similar broad range of participants, is drawing on those lessons to understand how best to manage integrity, particularly routine inspection for class and other regulatory requirement, whilst minimising the impact on operations.
For floating gas assets, it remains that the routine drydocking is neither practicable nor cost-effective. FSRUs that are near shore, or wharf moored, present unique challenges with current, water turbidity, and proximity to conurbations.
FLNG units are often much further away from shore and pose similar challenges to the FPSO sector.
In a recently published article on the risk of fatalities in commercial diving, with emphasis on the floating offshore energy production sector, Professor Andy Woods stated “…if the risk of a fatality per year is one in 1 million to the general public, then the [UK] HSE deems that this is broadly acceptable. According to the data, commercial diving is one of the most dangerous professions, and the data presented above from historical incidents suggest the risk levels have in the past been close to the intolerable threshold of one in 1000.” 1
Professor Woods has come to similar conclusions on the risks involved for personnel entering confined spaces such as cargo, ballast, or void spaces.
It is incumbent on all involved in the sector to mitigate this risk, and therefore diverless alternatives to the underwater inspection and maintenance tasks must be sought.
Floating gas assets can therefore also benefit from safety risk [threat] mitigation of placing personnel in dangerous environments – particularly divers; enhanced data gathered with technology; reduced operational down time for inspection and related activities; and for offshore, immediate and through-life efficiencies and savings.

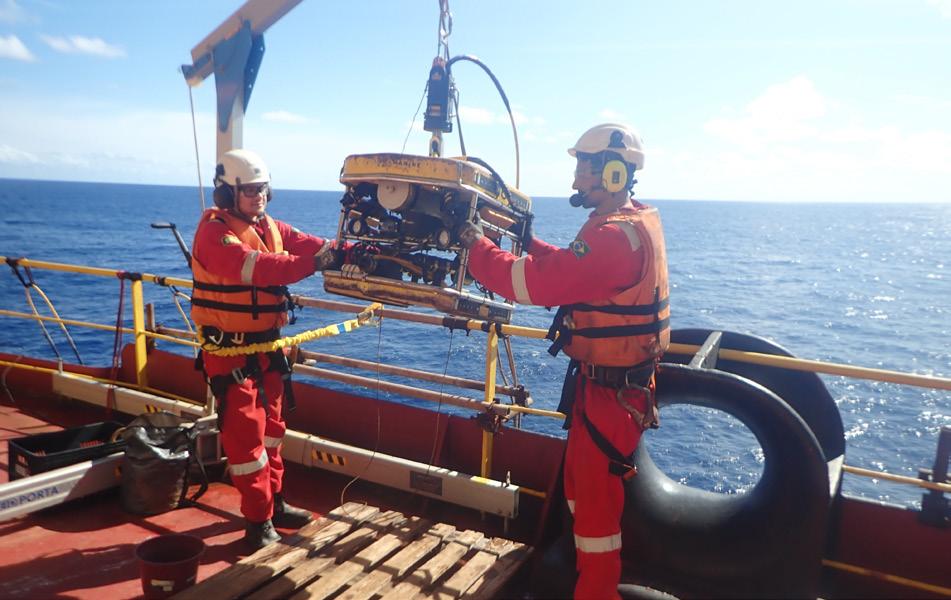

Measures include remotely operated vehicle (ROV) inspection by a team of three compared to dive spread of 15 – 20, or the expense of a diving support vessel (DSV); the ROV is also less weather dependent, ensuring optimal operating envelopes. Overall, the carbon footprint is reduced through the removal of unnecessary POB, DSV, mobilisations, helicopter, and crew support vessel traffic.
Another inspection requirement common across floating production units is of water ballast tanks (WBT). The HITS JIP has supported the development of inspection by mini-ROV in flooded WBT, again removing the risk to life and of serious injury from physical entry into the confined space. General and close visual inspection, and thickness measurement of steel, all of which are necessary to assure class, owners, and operators.
As the technology of both ROV and cameras improves, the capability is going well beyond the equivalence of visual inspection by the attending surveyor. A second significant benefit is that the FSRU can continue to operate unhindered while the inspection is conducted.
The work carried out by the HITS JIP, and the development of these capabilities, caused EM&I to think more broadly about the risk of entry in to confined spaces and working in there at height.
In a second report commissioned by EM&I, the same author reviewed the threats posed to personnel working in confined spaces, and at height, demonstrating the nexus between the risk [threat] to human safety, and the commercial impact of a fatality: “In 2020, HM Treasury in the United Kingdom assessed that the cost of an incident resulting in a fatality might be in the order of £2 million (~US$2.75 million). The ALARP principle, and regulatory guidance suggests that reasonable expenditure to mitigate the risk should be in ‘gross disproportion’ to the cost of an incident.”2
The paper goes on to consider how stakeholders can calculate the expenditure reasonably required to eliminate or mitigate the risk of fatalities, including application of technology.
Consideration was given as to what that meant for floating gas.
Developing the outcome of the HITS JIP work, attention turned to minimising the down time for the gas containment inspection. Achieving the data required, while reducing operational impact, mitigating human safety risk, and reducing cost were again the drivers.

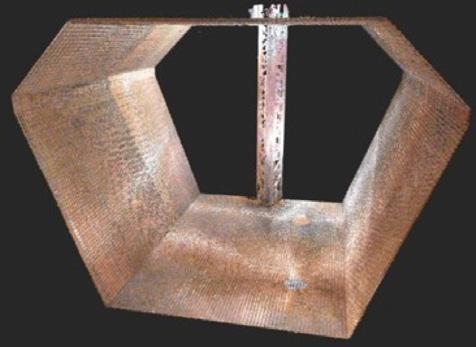

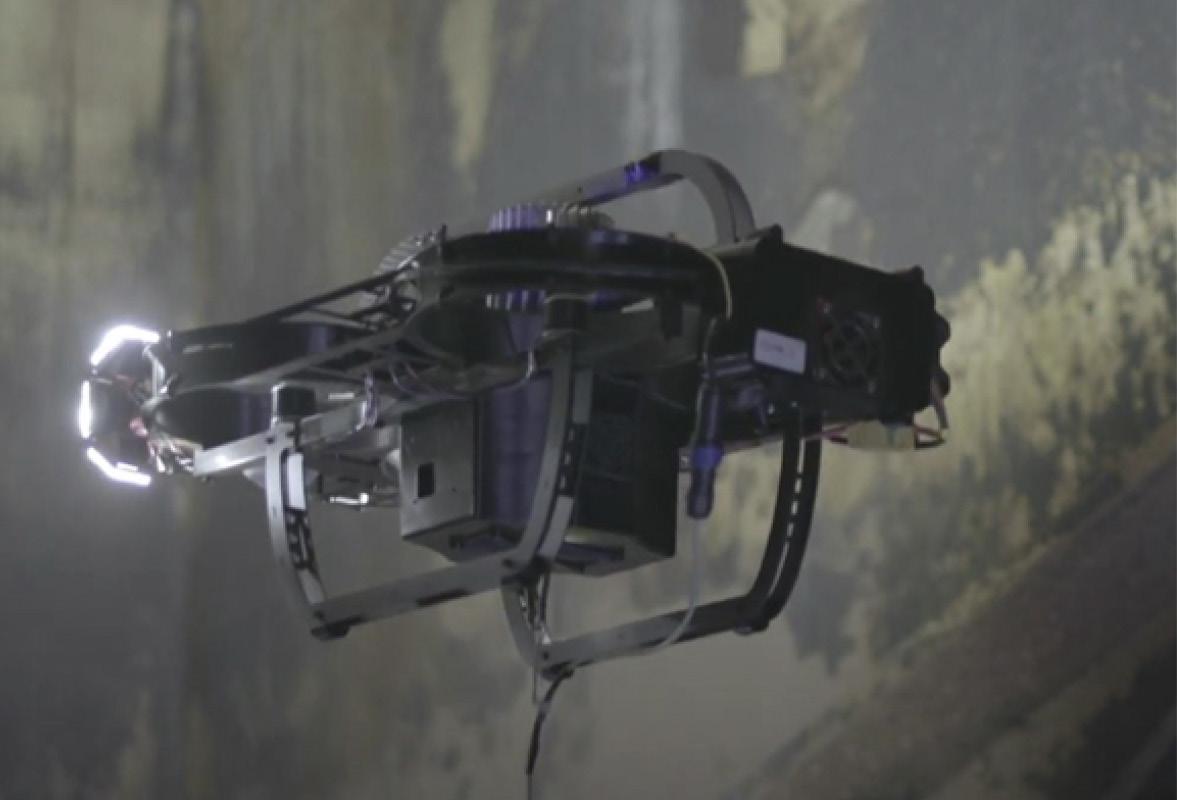

As part of the NoMan Plus® capability, EM&I has incorporated laser scanning for remote inspection. This technique develops 3D models, allowing bending and buckling from cargo sloshing and other causes to be identified and measured, as well as creating a ‘baseline’ data set which can be compared against for future inspection to identify change.
The laser scanner is deployed remotely into the tank and, following the inspection plan developed by skilled engineers to maximise the coverage, a number of scans are completed. The output is combined, and the 3D models are generated, enabling manipulation, review, and close inspection to identify anomalies.
The initial element of the NoMan Plus inspection involves insertion of high-grade optical cameras, mounted either on structures remotely deployed to the bottom of the tank for stability, or telescopic poles from upper entry points. With significant zoom capability, this enables an initial visual inspection to meet the equivalence requirement of arms-length inspection.
The next development of the NoMan Plus capability is remote inspection by tethered UAV, which is now entering service, again to mitigate the risks.
The most important benefit of NoMan Plus, optical inspection, laser scanning and the UAV is safety. There are no tank entries and no working at height, meaning the dangerous combination of working at height while being in a confined space is avoided.
There are cost savings as the number of people on board is reduced, with the maximum number of people permitted on board an operational restraint. As fewer people are required on board for tank inspection, there are fewer emissions by travel (if offshore), and more people for other vital tasks are allowed on board.
It is acknowledged that class is generally willing to extend inspection intervals on gas containment tanks in FSRUs located nearshore where sloshing loads are minimal. EM&I is looking
at leak detection techniques from the void spaces around the LNG containment as an intermediate inspection method during these longer intervals.
EM&I was given access to an operational FSRU which was temporarily alongside for maintenance and embarked on a pilot project to validate the capabilities of the NoMan Plus system for remote optical and laser scanning inspections of cargo tanks.

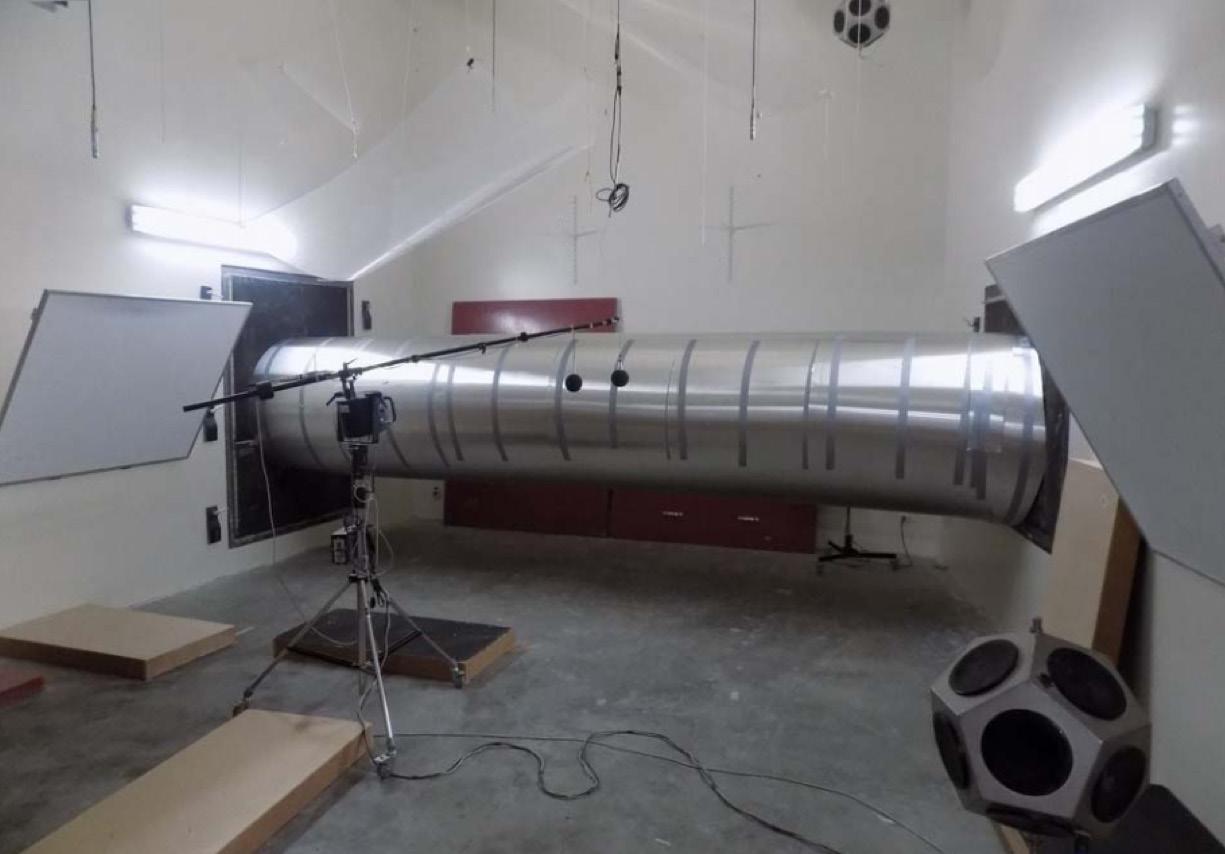

The trial was deemed a success by the operator of the FSRU, as well as by the attending surveyor who judged that the output would meet and exceed class requirement.
The benefits were summarised as the optical and laser systems were able to confirm that the tank was in good condition, with no evidence of significant anomalies.
Deployment and access points for the cameras and scanners need to be clearly identified and incorporated in the inspection plan, and to optimise coverage. This requires development from the original usage which is through deck openings into cargo oil tanks on FPSOs.
The trial showed NoMan Plus inspections, including full coverage general and close visual inspection, and laser survey, could be completed in one to two days, dependent on size of the tank.
As shown in onshore trials, highly reflective surface causes ‘phantom’ and ‘dead’ points, whereas corrugations in membrane create shadow areas and blind spots; both issues are overcome through taking multiple scans from various locations and utilising software tools to manipulate the data and ensure full coverage.
An issue not considered prior to the trial was a drop out in the Wi-Fi connection required to operate the laser scanner remotely. The tank acted like Faraday cage and nullified the Wi-Fi signal. Work around was achieved, and now as part of the continuous improvement and technical development process, EM&I is working with the scanner manufacturer to develop alternative communication methods.
The rapid increase in deployment of FSRUs and FLNG units brings new asset integrity management challenges. The work completed in adjacent sectors and on other energy production and storage facilities offshore provides valuable lessons and should be incorporated to meet regulatory requirements.
The development of techniques and technology that enhance the data available from inspection, mitigate safety risk, reduce impact on operations, assist with the reduction in emissions, and save owners and operators costs are being developed through collaboration and investment.
EM&I is excited to be at the forefront of some of these developments and deliver capability enhancements to its clients globally, including for FSRUs wherever they operate.
1. WOODS, A. ‘A Report on Fatalities in Commercial Diving’, Institute of Energy and Environmental Flows, University of Cambridge, (December 2022).
2. WOODS, A. ‘Confined Space Working Study; Safety in Confined Spaces with reference to Floating, Production, Storage and Offloading (FPSO) units and other marine vessels’, Institute of Energy and Environmental Flows, University of Cambridge, (February 2023).
Economies recognise the need to migrate from traditional but dirtier fuels to cleaner and more economical energy alternatives. However, this transition is not easy given the intricacies, innate capabilities, and limitations associated with adopting sustainable technologies, such as hydrogen or a fully renewable energy platform, for each geography.
There is a need to identify pioneering solutions that address the existing challenges and inefficiencies of attaining a sustainable, cleaner, and affordable energy source as a bridging mechanism towards fully adopting renewables that enable an integrated LNG infrastructure to support the full value chain ecosystem. Many countries have started to look at LNG as a viable fuel alternative that promotes a decarbonised journey towards the energy transition by helping reduce greenhouse gas (GHG) emissions, reaffirming energy security and mobility from fuel sources – it remains a practical solution for a cleaner and less expensive fuel.
Karthik Sathyamoorthy, President of AG&P’s LNG Terminals & Logistics, UAE, describes the company’s approach to LNG terminal development, from the planning stage to executing a hybrid onshore and offshore model that caters to the requirements of the market while having the capability to function despite extreme weather conditions.
AG&P’s flexible, scalable, and modular regasification technology has made it possible for diverse markets to seriously consider LNG despite topographical and climate difficulties, or challenges of small and fragmented pockets of energy requirements. The company’s clean energy networks are affordable, scalable, nimble, and sustainable. Armed with innovative solutions and world-class partners, AG&P develops complete LNG ecosystems comprising of project development, delivery, and commissioning, including LNG supply sourcing. Its expertise helps
realise terminals and downstream networks become faster, more economic, and with proven solutions.
Global LNG investments are reaching US$42 billion by 2024, a 50% increase from 2022 spending. New supply is also expected to raise LNG availability in the market from 2025/2026 onwards. Russian supply diversion from Europe to China will rebalance the market in the coming years and additional new supply will meet demand in other markets (gas equivalent of 40 million tpy in new pipeline capacity between Russia and China coming online within two years). Upcoming LNG liquefaction trains in the Middle East, the US, and other regions are expected to have a material impact in market rebalancing. Clearly, the world is heading towards a new cycle of oversupply that will push LNG suppliers to look for new demand creation and for an ever-increasing LNG import terminals and downstream infrastructure capacity. Headquartered in Singapore, AG&P is rolling out multiple LNG import terminals and linked city gas operations to bring LNG/natural gas to important, unserved, or underserved demand centres in South and Southeast Asia and beyond. As an owner, developer and operator of LNG terminals and downstream distribution network that is run on its proprietary regasification technology, the company is positioned to roll out clean energy networks across diverse markets and accelerate adoption of LNG/natural gas demand infrastructure. The company’s proprietary LNG/natural gas solutions unlock markets and addresses the demand capacity infrastructure gap through:
z Developing tailored LNG terminals and downstream infrastructure built at significantly lower cost, higher speed, and efficiency, with the ability to adapt to demand as markets grow.
z Acquiring an initial anchor customer in each market, often with a market-leading partner.
z Linking LNG suppliers to its networks to end-customers.
For example, in India, AG&P is one of the largest private city gas distribution (CDG) companies developing 12 CGD networks, or concessions, under the brand name AG&P Pratham, across 280 000 km2, covering 8% of India, an area approximately the size of Italy. In its 12 concessions, in the Indian states of Rajasthan, Andhra Pradesh, Tamil Nadu, Karnataka, and Kerala, AG&P Pratham is responsible for developing and operating compressed natural gas (CNG) stations for vehicles, piped natural gas to homes, and the distribution of LNG to industrial and

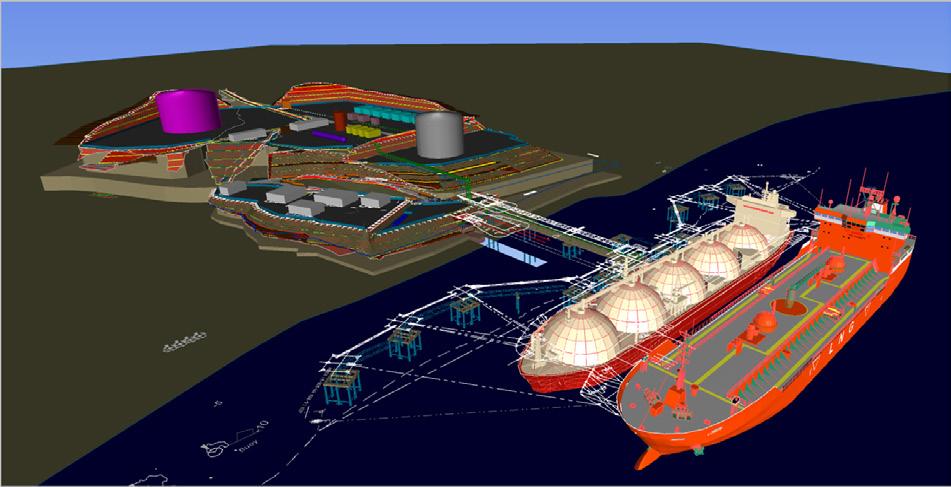

Storage
Phase 1
- Total storage capacity of approximately 197 000 m3
~ 137 000 m3 floating storage (primary).
~ 60 000 m3 onshore storage (buffer) approximately efegsix months later.
- Sufficient storage capacity to take full LNG cargo loads.
Phase 2
- Expanded storage capacity of approximately 377 000 m3
~ Additional 180 000 m3 onshore storage (primary).
~ 137 000 m3 floating storage (secondary).
~ 60 000 m3 storage (buffer).
Regasification capacity
- 420 million ft3/d through Gas Entec’s propietary regasification modules.
- Sufficient for approximately 3 million tpy of regasified LNG.
- Expandable through the addition of regasification modules to meet and increased send-out requirements.
- Sufficient for approximately 6.9 million tpy of regasified LNG by adding up to 330 million ft3/d of regasified modules when required.
commercial customers. AG&P is also the first private company to supply compressed biogas to customer. As of this year, AG&P Pratham has installed over 240 CNG stations, over 1700 km of pipeline, growing at 8 km/d and is connecting approximately 900 new homes daily.
The company actively develops efficient, right-sized LNG import terminals as gateways to new markets and makes LNG/natural gas available across diverse geographies, while serving as a dependable partner for building energy security and resiliency in the countries we operate.

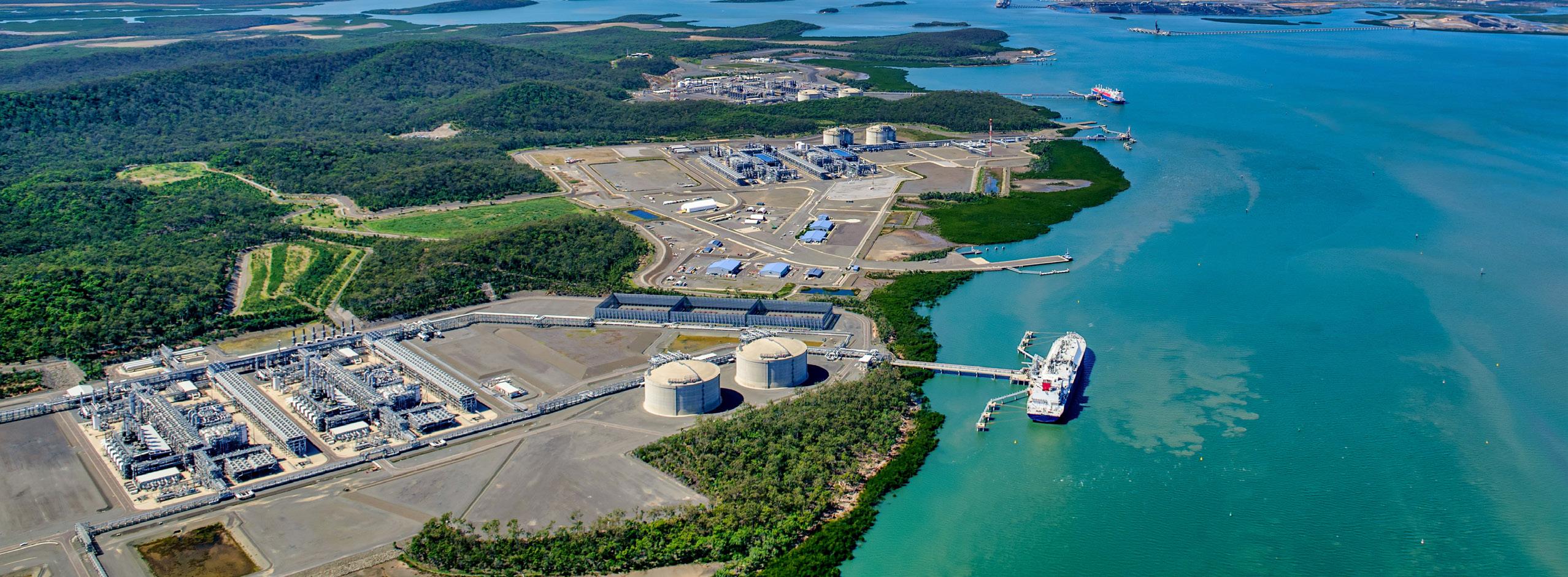

The Philippines market has huge potential for developing LNG/natural gas infrastructure. The depletion of local gas field (Malampaya) has led to supply scarcity. 10 GW of coal-based planned power capacity is under threat due to current moratorium on coal power plants. With the moratorium on coal power plants and increasing renewable power capacity that depends on natural gas for solving its inherent volatility issues, natural gas-fired power plants will come online. In addition, there is a strong impetus by the government to promote gas usage for power with a possibility of a roll-out of gas concessions in the future. This is because the present 3.2 GW of gas-based power plant capacity in the country will increase to 4.5 GW by 2024, and is projected grow to 12 GW by 2032.
The Philippines’ Department of Energy (DOE) awarded AG&P the notice to proceed (NTP) for the development of its LNG import and regasification terminal in Batangas Bay on the main island of Luzon, called the Philippines LNG (PHLNG) Import Terminal. Ready to be commissioned in 2Q23, AG&P’s PHLNG, the first LNG import terminal in the country and the first modular terminal in the world, will play a critical role in addressing the country’s looming energy crisis.
PHLNG will have the initial capacity to deliver up to 3 million tpy of regasified LNG, with additional capacity for liquid distribution. On day one, PHLNG will have scalable onshore regasification capacity expandable to 5 million tpy. The world’s first hybrid-designed PHLNG import terminal, using modular Regastainers (AG&P’s proprietary regasification plug-and-play technology developed to scale terminal capacity), will be commissioned in two phases. The first phase will be commissioned with the FSU storage in 2Q23, and the two
additional onshore storage tanks will be integrated by the end of the second phase in 2024. Then, PHLNG will have scalable onshore regasification capacity of 504 million ft3/d and 257 000 m3 of storage that will ensure high availability and reliability of natural gas for its customers. The terminal will also act as a gateway in providing breakbulk LNG supply to various islands across the country. PHLNG will supply gas to one of the largest power producers in the country – SMC Global Power (SMCGP). The terminal will be primarily used to service SMCGP’s baseload/mid-merit gas-fired power plants, having a total capacity of 2.05 GW with a provision to expand its installed gas-fired capacity to 3 GW in the next 5 – 7 years.
SMCGP is the power arm of the San Miguel Corp., a prestigious Philippine-based conglomerate. SMGCP is one of the largest power producers in the Philippines, with a portfolio of over 2900 MW of installed capacity using coal, natural gas, and renewable energy. SMCGP is the operator of the Ilijan Power Plant, a 1200 MW gas-fired power plant located in Batangas. This power plant had relied on domestic gas to support its operations; however, with the domestic gas field (Malampaya) expected to be depleted in the next few years, SMCGP is looking for alternative solutions to extend the life of its current gas allocation. In addition, SMCGP has a robust pipeline of power development projects, such as the second gas-fired power plant with an installed capacity of 850 MW within the same vicinity and an additional ~1000 MW worth of gas-fired power plants in their power development pipeline.
The planning stage is the most crucial phase of any terminal development project wherein it entails a thorough analysis on critical parameters affecting the technical concept, viability of the project, customer preferences, project engineering, resources that need to be in place, local government, and the regulatory framework. AG&P’s terminal design minimises redundancies and fully utilises an optimal fit-for-purpose methodology, working around the constraints to come up with the best executable solution. AG&P employed reputable contractors and experienced professionals to construct the terminal and jetty with the highest HSSE standards, quality assurance and quality control processes at the shortest possible timeline that is aligned with the critical path execution strategy. The modularised concept not only led to reduced cost of the overall terminal, but also needed lesser maintenance and reduced manpower requirements at the project site.

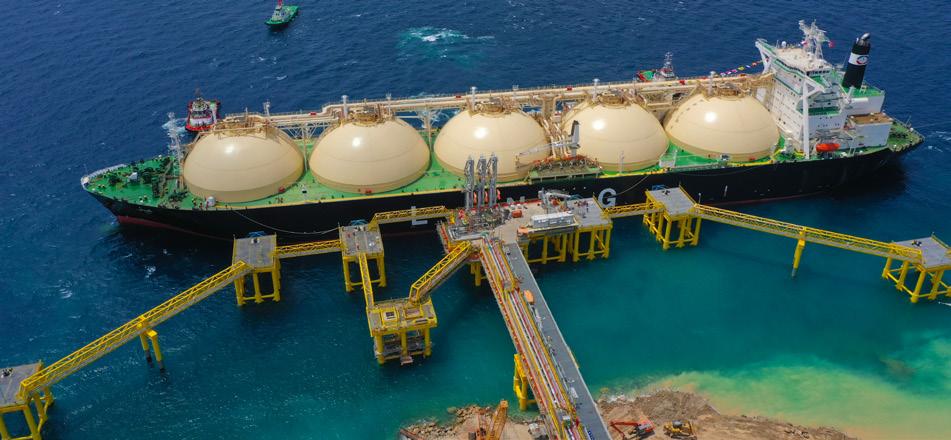

The terminal is capable of receiving various LNG carrier sizes, such as Q-Max, Q-Flex and small scale feeder vessels with varying laytime allocation based upon cargo capacity.
The discharge from LNG carrier to the FSU follows a strict security and administration protocol.
The LNG terminal can operate throughout the year irrespective of weather conditions. This is only possible because of its hybrid offshore FSU and onshore regasification design. The FSU located at Batangas Bay at AG&P’s PHLNG facility on the main island of Luzon has been chartered for 15-years from ADNOC L&S. AG&P’s subsidiary, Gas Entec, converted ADNOC L&S’s Japan-built, Moss-type LNC carrier into a FSU in five months. The FSU is part of the combined offshore/onshore terminal that will have an initial capacity of 5 million tpy and provide its customers with resiliency of supply, even in storms. In addition, the rigorous berthing, mooring analysis, and technical recommendations from experts are a part of the terminal design to protect it from extreme changes in weather.
Aside from the anchor powerplant customer, the LNG terminal is also capable of loading LNG in ISO tanks and road tankers for local distribution across the geographic envelop.
The concept of utilising FSU as the primary storage and having onshore regasification system prevents any expensive vessel modification and promotes longer utilisation of the terminal given its flexibility in terms of buffer storage.
AG&P utilised GAS Entec’s RegasTainer® technology as a custom-designed feature to accommodate the hybrid solution requirement by optimising the overall design that is cost effective and easily scalable.
The construction of the terminal was envisaged in two phases. Phase 1 is designed to utilise onshore regasification, buffer storage, utilities, balance of plant, and supplemented with an FSU. Meanwhile, Phase 2 is designed to increase the terminal’s onshore storage and regasification capacity as demand for energy rises. The design has provisions for utilities including flaring, gas detection, seawater intake and outfall system design, boil-off gas handling system, and truck loading bays.

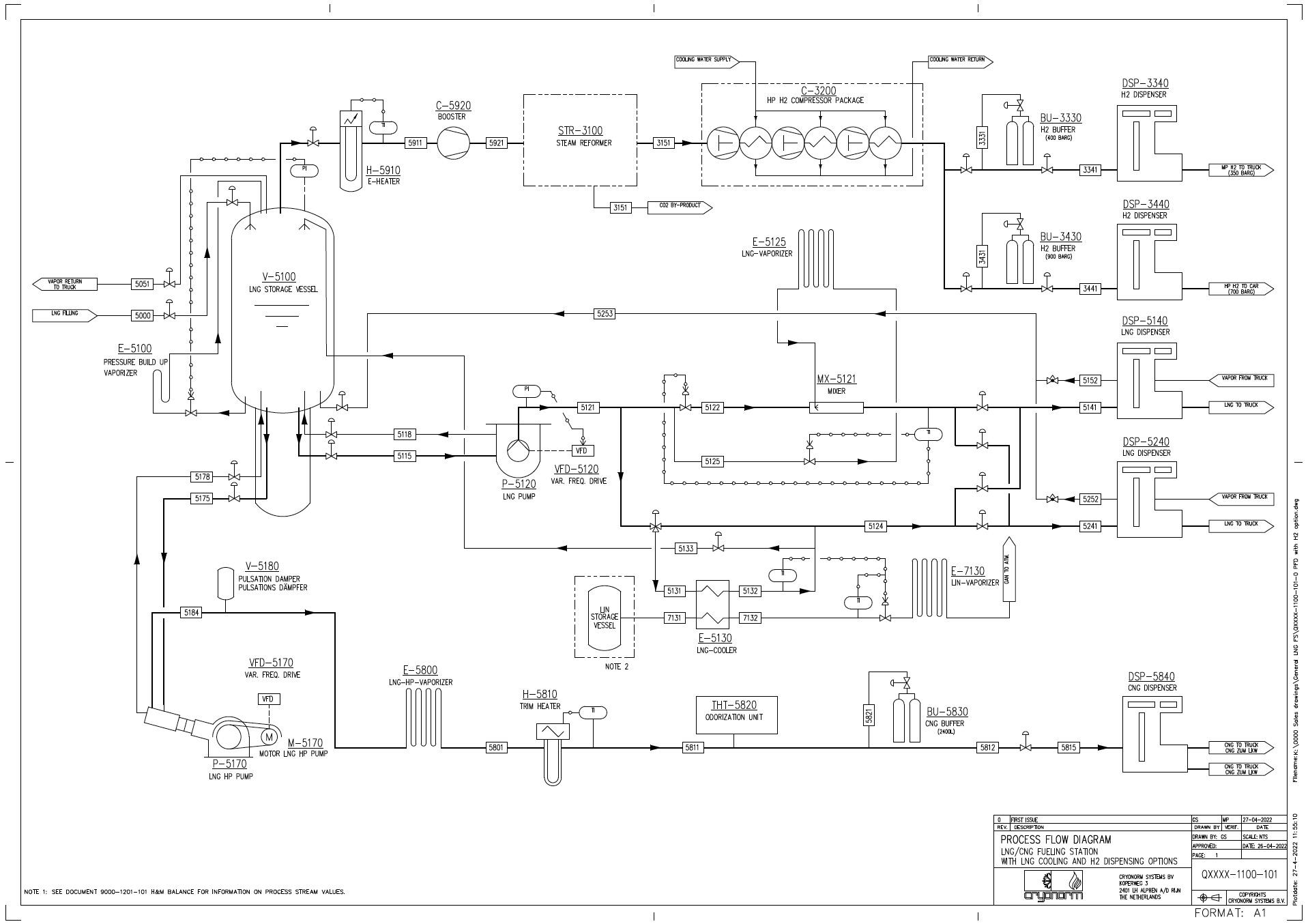

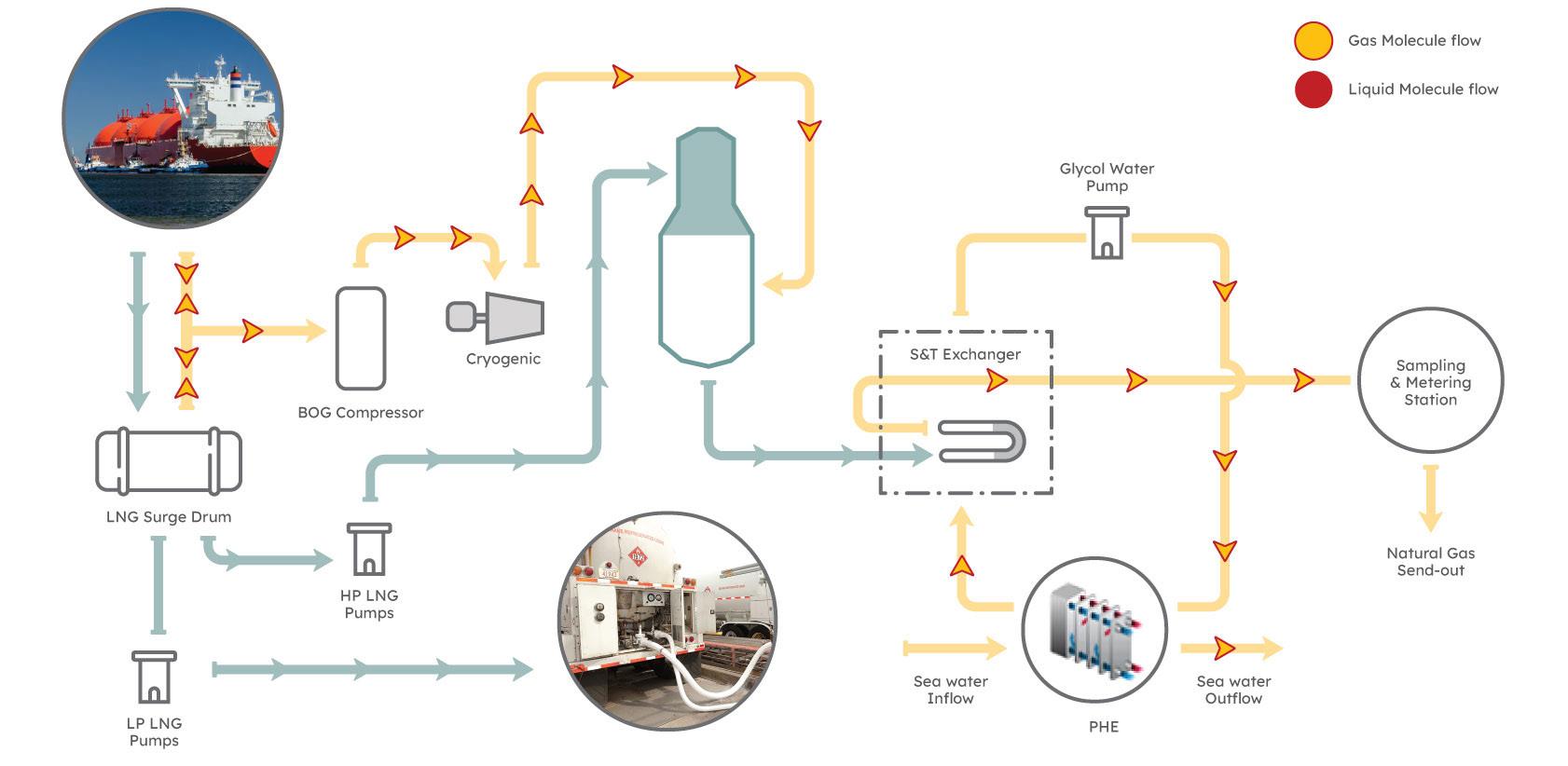

AG&P established a process block flow diagram to schematically ensure a seamless flow of liquid and gas molecules from the LNG carrier to the customer premises.
The diagram shows the terminal’s capability to transfer LNG through a series of molecule flow towards the high-pressure pumps and the boil-off gas compressor that are regasified in the shell and tube heat exchanger against glycol water to eventually
pass through the sampling and metering station at the customer premises. Another stream of LNG is transferred from the FSU through low pressure pumps which are dedicated for LNG ISO tanks and road tankers.
The jetty, FSU, and the associated mooring facility are designed to be compatible to take LNG from any visiting LNG carrier (of up to 170 000 m3) through ship-to-ship transfers. The jetty and mooring design has four berthing dolphins, six mooring dolphins, and LNG unloading arms.

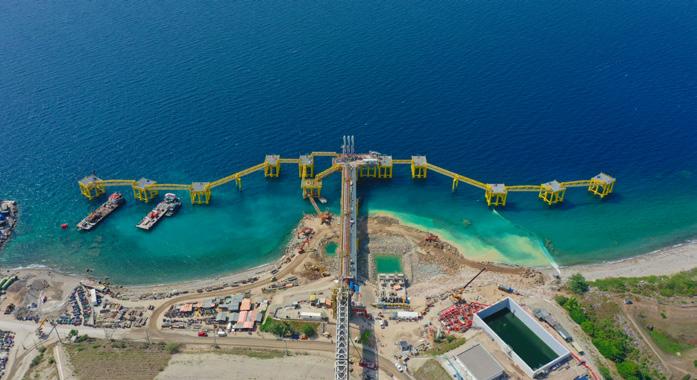

The terminal is scheduled for commissioning between April-end and early May, in time for LNG supply to the 1200 MW Ilijan combined cycle power plant to address Luzon’s power supply deficit and stabilise power.

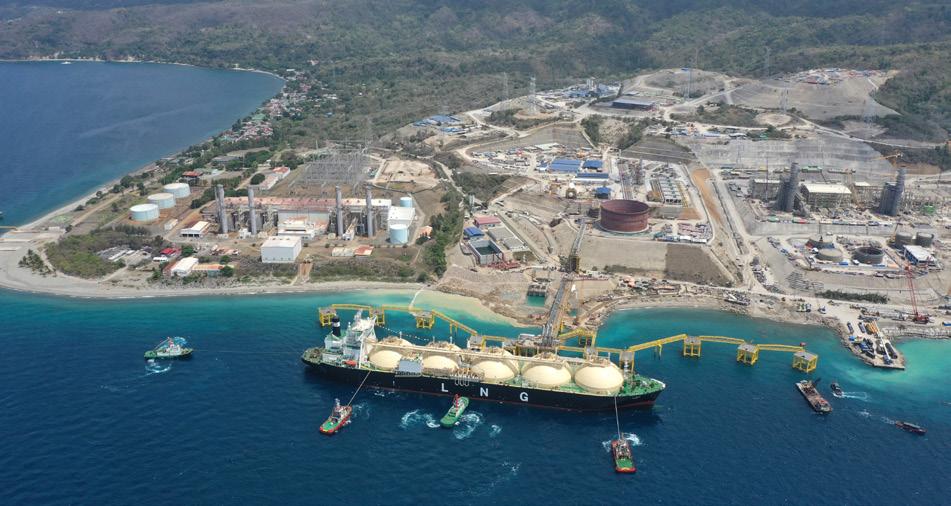

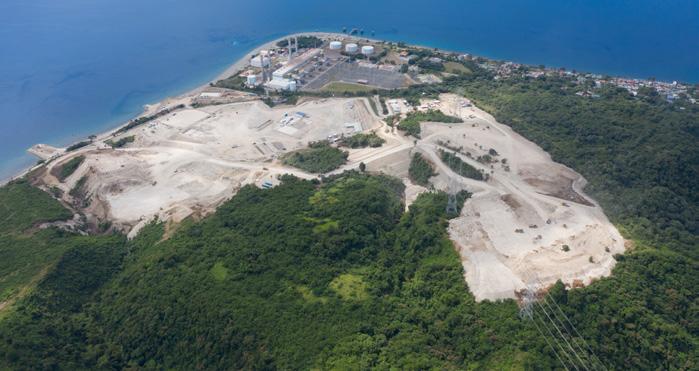

As of writing, the full ship-to-ship (STS) LNG transfer from Golar Glacier LNG carrier to the 137 500 m3 ISH FSU has been completed.

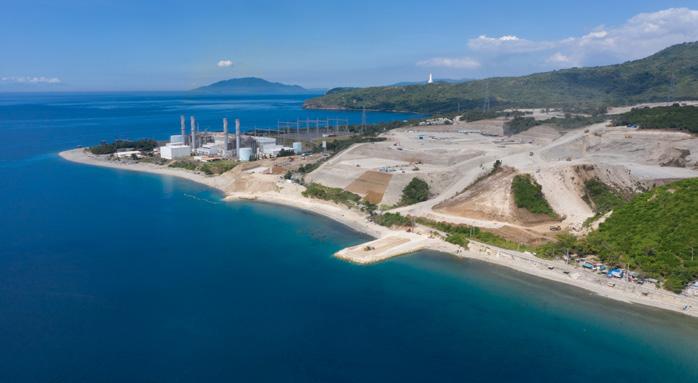

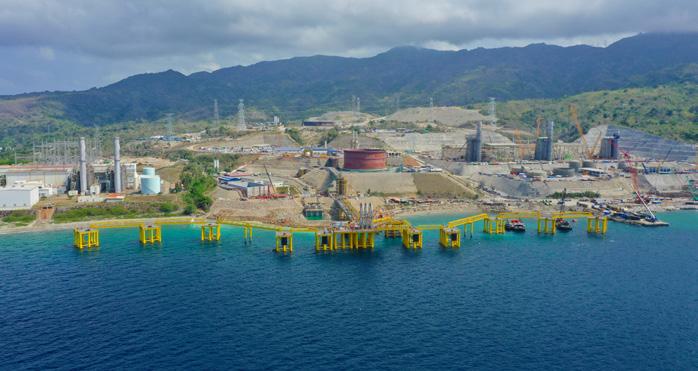

The ISH FSU is berthed at AG&P’s PHLNG Import Terminal in Batangas Bay, the first LNG terminal in the country and the first modular LNG terminal in the world.
The company complements the development stage by following through with operating and maintaining the terminal and continuously render services to improve operational efficiency, productivity, and safety of the project while reducing its downtime.
AG&P is keen to unlock the downstream market in the Philippines and is prepared to deploy substantial resources into developing downstream infrastructure in various practicable modalities to serve the energy needs of customers as a one-stop shop LNG value chain project EPC, financing, development and downstream solutions provider.
The energy industry is at a revolutionary point to ensure efficient mobility of resources and energy security despite the fact that every economy is at their own respective pace of transition towards net-zero emissions and improving quality of life. The challenge is always to bring the most innovative yet practical solution palatable to counterparties at the quickest turnaround time.
LNG is a promising alternative for a future-state norm in the industry while the technological evolution of renewable energy, hydrogen and other forms of cleaner energy materialises. AG&P has taken efforts to own, develop, and build LNG import terminals using proprietary technical solutions that address gaps in the natural gas value chain. These gaps prevent access to end-users in nascent and growing markets around the world which the company has addressed by making natural gas accessible, unlocking markets and accelerating its adoption globally, country by country.
CryoMac® 4 LNG Fueling Nozzle
Maximum safety for LNG fuel technology
The most cost-effective way to transfer cryogenic liquids
SAFE
“Safety Stop” for added safety and operator protection.
these
Praveen Lawrence and Briain O’Dowd, Royal HaskoningDHV, UK, detail how predictive simulation can aid with managing LNG terminal demand.
The war in Ukraine created an urgent need to replace Russian natural gas, with LNG representing the best alternative. To meet the spike in LNG demand, Europe is aggressively ramping up its regasification capacity by bringing FSRUs online and expanding land-based facilities. Europe has so far been able to manage its gas requirements thanks to the mild 2022 winter, but it is not out of the woods yet. Countries are facing many uncertainties with how to deal with the 2023 winter and beyond, especially when:
� The war in Ukraine is ongoing without signs of de-escalation.
� Europe still relies on Russia for 25% of its gas imports.1
� Europe needs to further reduce gas consumption to improve its energy security.2
To meet the growing need for LNG processing, Europe is investing hundreds of millions of euros in building new, and expanding existing, regasification terminals. For projects of this scale, there is usually intense scrutiny of operational contingencies, technical assumptions, and commercial risks to ensure that investment is appropriately channelled. However, the geopolitical situation means the industry is now working under tight timescales to deliver these projects of national significance. As a result, scrutiny processes must be expedited – with stakeholders needing a reliable way to de-risk projects.
Business logistics simulation software and verification services play essential roles in delivering that speed and risk reduction. This article will look at the role of predictive simulation in LNG terminal logistical performance and planning, along with two use cases.
LNG terminal operations involve complex and interdependent supply chains, as well as dynamic uncertainties such as the knock-on effects of seasonal gas demand nomination, tides, and large weather disruptions (Figure 1). While scheduling tools are appropriate for short-term and tactical decision-making applications, they fall short when dealing with long-term planning and annual demand plan (ADP) assessments accounting for real-world risk factors. Business logistics predictive simulation software helps operators address these complexities, inter-dependencies, and uncertainties. It is therefore a vital tool for testing and verifying terminals’ logistical performance as part of long-term planning.
Historically, due diligence and verification exercises have been kept for later stages of design. However, when large strategic projects are delivered to very tight deadlines, there is not much leeway for delay. Using predictive simulation to verify plans as early as feasibility and pre-FEED stages helps to pick up unforeseen issues and minimise the risk of schedule slippage/asset under-performance.
Another important benefit of predictive simulation in LNG terminal planning relates to project management and co-ordination. Projects involve multiple stakeholders, ranging from marine and terminals to commercial, marketing, and legal. Predictive simulation enables commercial analysts, operation professionals, and designers to bring together all information in one environment and creates a single source of truth for all these stakeholders – helping avoid the risks associated with information silos.
Supply chain stress-testing is another valuable use case. Verification studies using high-fidelity dynamic business logistics simulations provide accurate insight to pinpoint supply chain inadequacies, find alternatives to mitigate risks,
exploit any resilience in the system, and thoroughly test terminal design and shipper contracts.
The role LNG regasification terminals play is rapidly evolving. As global LNG trade patterns change, the supply of LNG to terminals has become more flexible, with shippers mixing both long-term contract and spot market cargos to meet their demands. Moreover, terminals have become gas hubs that serve multiple shippers, including gas customers, LNG trucking and rail transfer, as well as providing bunkering. The flexibility and ability to serve multiple customers brings operational complexity and more contractual uncertainty. Therefore, those crafting and verifying terminal use and shipper contracts need to analyse the greater marketing and commercial options when balancing the needs of multiple shippers. Predictive simulation can handle this dynamic push/pull of many-to-many shipper/buyer combinations to generate, test, and optimise advantage parts solutions.
Twinn LNG Logistic Simulator (previously under the Lanner brand) has been trusted by many of the world’s leading LNG terminal operators – both liquefaction and regasification – for nearly 20 years. Powered by Twinn predictive simulation software, large European facilities, such as Fluxys Zeebrugge LNG and other new regasification terminals, use it for long-term horizon planning and verification assessments, either utilising in-house resources or, if an independent verification is required, using Twinn LNG expert services. Here are a couple of examples of how the Twinn approach to LNG logistics simulation benefits operators in practice.
A major LNG terminal operator was looking to capitalise on market conditions to diversify and expand. It needed to take a risk-based approach to this expansion – ensuring asset optimisation and a high standard of service for all traffic coming in and out of the terminal. The company therefore needed to understand what was operationally feasible and commercially viable.
Stakeholders from operations and business development were tasked with exploring what was possible given all the moving parts involved in terminal operation – from ship sizes and traffic patterns to tides, weather events, and port operator delays. This formed part of the due diligence process that would set the framework for the engineering, procurement, and construction phases to follow.
The stakeholders did a base level of static analysis internally, but as the variables
became increasingly complex, the limitations of their in-house tools became apparent. Having worked with Twinn experts in the past and benefited from their predictive simulation expertise, the Twinn experts were to help define the operating boundaries for this expansion project. Not only would the LNG Logistics Simulator facilitate more informed decision-making, but the independent validation would give stakeholders more confidence in the due diligence.
Importantly, the operations and business development stakeholders were working to a tight project timeline – they needed to present their findings to senior management within four weeks.
The terminal operator had loose boundaries they wanted to investigate based on their static analysis, so the Twinn team started by refining these to define the scope of the parametric study. The first step was to define the finish line – the key questions stakeholders needed answering using the LNG Logistics Simulator. Following discussions with stakeholders, two key areas were identified:
� Berth occupancy and utilisation – and whether there was a business case for investing in another berth.
� Risk of delays associated with different traffic levels – including which customers would be affected and what the impact would be on ship movements, storage capacity, and demurrage.

Then the Twinn team looked at a matrix of variables, including factoring in seasonal probabilities based on external data around weather, wind, and visibility. Other variables related to the terminal operating rules and the number of berths and ships.
Then, using the LNG Logistics Simulator, the terminal operator stress-tested different demand levels across several operational scenarios. By factoring in current import ship contracts and forthcoming partnerships, they experimented with different small scale traffic levels, docking and mooring patterns, ship loading times, and storage tank capacities. This enabled the team to identify sensitivities at the upper and lower limits, home in on the tipping point for an additional berth, and frame the operational boundaries for future contractual arrangements regarding delays and demurrage.
Within four weeks, the terminal operator had a precise and complete analysis to present internally. Importantly, there was validation behind each figure, helping stakeholders understand the story behind the data and make decisions with confidence. This creates deep knowledge of the constraints and the trade-offs involved in strategic expansion, with quantifiable solutions to uncertainties and challenges. The company also has a wealth of operational and commercial data to inform the investment case for an additional berth and storage tanks. Key strategic questions such as, ‘Under what circumstances would delays be incurred that are contractually and operationally destabilising?’ are now easy to answer, and the terminal operator can take proactive measures to avoid these situations and optimise services as it grows.
The data can also be used in commercial discussions as part of the sales and relationship-building process, demonstrating the business case for why their terminal is an LNG terminal of choice. The terminal operator is now in a
stronger position to capitalise on demand, develop a competitive advantage, and forge mutually beneficial partnerships.
In the current environment, operators must deliver robustly tested ADPs to ensure energy security and keep to their committed targets. This use case illustrates the key role that predictive simulation plays in this process.
A large LNG operator was experiencing serious market interest in booking its capacity. To meet this additional demand, the operator needed to undertake significant expansion across storage, send-out, and conversion.
During negotiations, shippers expressed concerns over the guarantee of their individual access in a multi-shipper environment. Most of the terminal’s equipment blocks needed to be expanded, and failing to create the right capacity at every point would cause a range of problems including insufficient storage space, inability to discharge tankers at the right time, not delivering the required send-out rate, and lower-quality gas reaching networks.
The operator chose Twinn LNG Logistics Simulator to model the expanded facility and inform ADP planning. The model incorporated each prospective supplier’s shipping activities and accommodated dynamic delivery scheduling to coincide with available slots, tidal and weather behaviour at the port, as well as the terminal’s operational constraints and processes.
The model of the proposed facility allowed the company to experiment with and fine-tune the planned extension while proving the viability of its plans to meet suppliers’ needs. In fact, the modelling even demonstrated that there would be capacity above initial projections, allowing the operator to set contracts for 6% more.
Additionally, because the team ran scenarios for different capacity expansion opportunities, the terminal operator could determine which design would deliver the best return on investment. This helped them direct US$165 million of capital investment in the most effective way – with the simulated terminal of the future providing certainty and confidence.
With European LNG terminals rapidly being brought online to ensure energy security, it is essential that all the moving parts within the LNG terminal supply chain work together to meet its dynamically changing logical performance requirements. As most of the terminals involve brownfield expansions, re-purposed FSRUs, and/or use of existing ports, business logistics simulation studies are vital to ensure terminals are built without delays and provide the energy security Europe needs.
1. ‘Infographic – Where does the EU’s gas come from?’, Council of the European Union, (7 February 2023), www.consilium.europa.eu/en/infographics/eu-gas-supply/
2. MASTERSON, V., ‘How the European Union can avoid gas shortages in 2023’, World Economic Forum, (12 January 2023), www.weforum.org/agenda/2023/01/iea-europe-gasshortages-2023/
Executing LNG capital projects has proven to be high risk, with results not meeting the facility owner’s business objectives. The resulting impact on the industry is that shareholders and management are under increased scrutiny to perform. As a result, they have developed a high-risk aversion when making go/no go decisions on projects. Using the same methodology as past projects opens the project up to repeating past mistakes. The approach to these projects requires new ways to address these concerns and innovative methodologies that increase the chance of success. According to EY’s survey conducted in 2019 on 500 oil and gas mega projects, the results found that 60% of projects experienced schedule delays and 38% of projects experienced cost overruns. 1
LNG projects are complex and therefore frequently experience an increase in cost and time to deliver. The performance from these cost and schedule overruns results in the owner not achieving the minimum internal rate of return (IRR) necessary to be profitable. In most cases, the expected compound annual rate of return that will be earned on a project needs to be a minimum of 15%, with a
minimum net present value (NPV) of 0 for an agreed discount rate of investment.
LNG facilities are mega downstream projects, which contributes to the uncertainty of achieving the desired performance objectives based on past mega project performance. Some of the complexity of an LNG facility include:
� Very large mechanical packages (i.e., compressors, exchangers).
� Very large plant input flows leading to challenging flaring designs.
� Novel large HIPPS valves.
� Complex safety studies.
� Limited flaring capacity due to limited site availability.
� Cryogenic service.
Importantly, lean engineering and design methods have provided more certainty to achieve the business objectives allowing for projects to be funded as well as be successful. Lean engineering and design methods have been implemented by facility owners, as well as EPC companies in several industries.
Traditional project executions tend to execute the project without understanding the overall business drivers and objectives, and the projects facility designs result in not aligning with the business objectives. Therefore, the project does not pass through the funding gate or meet the facility owner’s business requirements without reworking the design late in the project.
There are lean engineering and design methods that the automation and controls groups can use to help improve the projects IRR and maximise the facility owner’s overall project value. This article will discuss lean methods that can be used by the automation and controls group, including implementing new digital technologies, aligning the class of plant with business needs, performing necessary lifecycle cost analysis, utilising productisation, and optimising design margins. Managing the automation interfaces and execution with the other project disciplines are also crucial to maintain the project cost and schedule.
Incorporating these methods into a project will successfully reduce the projects’ overall lifecycle cost and help it meet the projects’ IRR requirements.
Lean thinking is a business methodology that aims to provide a new way to think about how to organise human activities in order to deliver more benefits to society and value to individuals while eliminating waste.
Lean engineering and design utilise methodologies that develop a facility design to maximise the facility owners value proposition, minimise waste, and, ultimately, meet the facility owner’s needs. Lean methods involve reviewing the ‘needs and wants’ of a particular design with all stakeholders, and only incorporating the needs into the design to ensure the design meets the required business objectives. Currently, projects are incorporating both the needs and wants into designs, increasing the cost and schedule unnecessarily. Lean design seeks to define the necessary needs of a facility early in the project
in order to minimise rework and maximise the efficiency of the work effort. This means getting automation and process controls disciplines involved much earlier and in more facets of the project requirements phase than what is traditionally done. There are tools that can be utilised to ensure a lean design is being incorporated into the automation and controls of a project.
In order to have the right mindset on a project, operators will need to ensure the automation and controls team, along with the project team, are aligned with the project business objectives, and embrace a lean thinking mindset. These methods are meant to be completed during the early stages (DBM/front-end planning [FEL2]) of the project lifecycle. A traditional approach with automation and process control is more reactive – there is little opportunity to influence the business case and process design from an automation perspective. The lean approach can also improve the effectiveness of the design with earlier automation discipline input. Novel solutions can be incorporated into the design, which would otherwise not be cost effective if done later in the project. The value of the opportunity when implemented early in a project is greater than when implemented later in the project, as indicated in Figure 1. This is due to the increased risk of change later in the project lifecycle.
LNG facility owners may implement several value improving practices and lean execution methods in the early front-end stages of a project’s lifecycle. For example, DyCat Solutions can apply 15 lean design and execution methods on projects to maximise the facility owner value. This article will focus on seven different lean engineering and design methodologies – including the business case alignment, new digital technology, class of plant, lifecycle cost analysis, productisation, optimising design margins in automation utilities, and project governance – that can be used by automation and controls teams on LNG projects to provide the most cost-effective design and provide the maximum value for the facility owner.
As part of a programme or project execution, there should be an alignment process to assure all stakeholders understand and agree on the business drivers for engineering and design. Historical reviews of projects have indicated that facility owners’ organisations are not internally aligned on the business case and key success factors which promote a successful business outcome. In addition, internal organisations have conflicting objectives to the overall business objectives. The Construction Industry Institute 2 (CII) and Lean Construction Institute 3 (LCI) recommends that alignment between the business and the project is critical to the success of the project. The business case alignment methodology is a structured approach for all stakeholders to align on the business case and drivers which should dictate the engineering and design strategies.
The automation and controls group need to be part of this alignment in order to assure an optimal design
which supports the business objectives is developed. They will need to understand and assist with the level of automation and controls that is required for the project based on the business objectives and drivers. Traditional projects will typically include the highest level of automation and control required without understanding the actual business requirements. They will also be involved in assisting to determine the project expandability, reliability, and availability requirements based on the business case. Historically, these factors are not aligned early on in the project and the project then has overdesign built in, which is not required and adds unnecessary costs. The business case alignment tool addresses: general requirements, mandatory constraints, facility design capacity, facility operational flexibility, facility expandability, facility controls and automation philosophy, and facility operations and maintenance (O&M) philosophy.
The application of automation and controls of industrial projects, such as LNG projects, has made great strides with improvements in technology through the industrial revolutions. Progress from the first industrial revolution Industry 1.0 to the future of Industry 4.0 is illustrated in Figure 2.
The LNG industry is currently implementing at an Industry 3.0 stage:
� Traditional automation is utilised: Automated control systems which apply remote I/0 connected to fibre optic back to control panels, systems, and rooms.
� Traditional smart instruments are utilised: Smart configured instruments which can direct operational data back to control displays, asset management systems, and historian/business systems.
� Wireless instrumentation: Delivers smart data remotely via the internet back to the controllers, which is at its early stages of implementation in the heavy industrial sector.
� Digital asset management systems.
� Data historian/business systems interfaces.
The automation and controls technologies have made further advancements which may not be effectively deployed on industrial projects, such as LNG liquefactions and regasification projects, and can be considered lean in application. These advancements are considered the next stage as Industry 4.0 with the application of:
� Industrial Internet of Things (IIoT): An evolution of a distributed control system (DCS) that allows for a higher degree of automation by using cloud computing to refine and optimise the process controls. It includes interconnected sensors, instruments, and other devices networked together with industrial applications and allows for data collection, exchange, and analysis to facilitate productivity and efficiency improvements.
� Big data and analytics: The obtaining of digital data and then the method to process, clean, and analyse the data for the purpose of predictive analytics and machine learning.
� Cloud computing: The on-demand availability of computer system resources, such as data storage and computing power. It allows for the use of virtual configuration and programming on remote servers, without the need to procure specialist automation hardware. It has the advantage of the latest configuration being available at multiple locations/sites. MOC and data backup is also more securely accomplished.
� Digital twin: A virtual representation of an intended or actual real-world physical product, system, or process. For LNG facilities, a digital twin would be the 3D model representation of the actual facility in real time.
� Augmented reality: An interactive virtual experience of a real-world environment where the objects that reside in the real world are enhanced by computer-generated perceptual information, sometimes across multiple sensory modalities, including visual, audio, touch, and smell.
The effective application of these tools should improve the project productivity and efficiency, leading to reduced lifecycle costs and improve the project’s IRR.
Most owners have developed a design package in the DBM (FEL2) phase to support the FEED (FEL3) phase development. The design package normally includes the facility owners’ set of specifications and standards, which have been developed based on historical input from past project experience, operational and maintenance experience, the owner’s technical team input, and recognised international technical organisations. Over time, these specifications and standards have included not only the ‘needs’ of the project or facilities, but also the ‘wants’ or ‘nice to haves’. Applying all these requirements may not meet the business objectives and could result in the project not meeting the project IRR requirements.
The class of plant is a tool that aligns business objectives with the appropriate plant class that provides the baseline for the engineering and design team. This tool also ensures that the requirements are
incorporated into the design earlier rather than having to rework the design later in the project. The first step is to establish the class of plant which supports the business objectives. Often what is enlightening to the stakeholders is the difference in the class of plant which the established specifications, standards, and code requirements compared to the class of plant that the business objectives support. Plants are specified based on various classes from a Class 1 to a Class 3 plus, with the capital cost increasing per class. The class of plant has a direct impact on the facilities’ return on investment (ROI).
The class of plant is categorised into six categories – capacity, flexibility, expandability, reliability (including loss prevention), process controls, and O&M – which measures the design requirements.
All categories identified will have an impact on the automation and controls group in developing the optimum design. Collaboration is required between all engineering and design disciplines when establishing the class which meets the specified business objectives. After the class of plant is determined, the automation and controls team can establish a lean design basis and update the project specifications or standards.
An example is provided from the process control checklist for identifying the class of plant for the category of reliability and impact of the UPS/backup power system is indicated in Table 1.
As is demonstrated by aligning all stakeholders on the class of plant, the automation and controls team has a basis for development of the optimum lean plant design specification.
Lifecycle analysis is a decision-making methodology that evaluates both the CAPEX and OPEX associated with a specific design and identifies the IRR and NPV for two or more alternative designs. Most facility owners and EPC companies struggle with developing quick lifecycle analysis for making decisions on adding or deleting capital scope to their projects. Lifecycle analysis is a tool which provides fast assessments on scope changes to determine the value the change brings to the programme or project, and whether it supports the business case. Key factors to consider when calculating the lifecycle cost for a facility include comparing the product revenue against the capital costs, O&M costs, and feedstock costs.
For example, during detailed engineering, the owner’s O&M team want to add additional platforms to access some instruments which are low frequency
Description Cost impact
Class 1
- Redundancy of power supplies is limited to safety critical systems.
Class 2
Class 3
UPS/back-up power Medium
- Plant up-time requirements do not warrant extensive redundancy.
- Power back-up is via UPS for safety critical systems.
- All controls and SIS power supplies are dual redundant or N:1 redundant and powered through a dual UPS/emergency diesel generator feed.
- No special distribution arrangements are made (i.e., standard instrument power supplies feed via a UPS distribution board).
- All controls and SIS supplies are dual redundant.
- The main UPS shall be provided via a dual (100% redundant) UPS.
- The UPS system would have multiple AC feeds, including the emergency diesels.
- The power distribution would be designed to avoid common mode failure and would include dual feeds to all control and safety systems.
maintenance items. The changes at this stage of design could add significant capital cost and delay the project. Justification by the project team to accept or reject the change could be established by performing a quick lifecycle cost analysis for current design vs change to design.
Productisation can be defined as “the process of analyzing a need, defining, and combining suitable elements, into a product-like object, which is standardized, repeatable, and comprehendible.” 4 Industrial productisation is the future of heavy industrial constructed projects, such as LNG facilities. Productisation combines both modularisation and standardisation methods for repeatable components, units, trains, or facilities. This design build method addresses most owner’s strategies of the future:
� Owners of industrial facilities are looking at innovative methods to improve the projects ROI.
� Owners of industrial facilities are looking for contributions to their environment, sustainability, and governance strategies.
Modular design is considered a section or block from a facility that is fabricated and assembled in an off-site
location from its installed position. The module can contain equipment, piping, instruments, electrical and controls cabling, and local electrical and/or instrument rooms within a structure. An example of a module is depicted in Figure 3.
Most LNG facilities are now applying a modular execution and design. Automation and controls technologies (Industry 4.0) are well suited to support modular designs but may require adjustments or deviations to the owner’s current specifications and standards.
A standardised design consists of a process envelope which is engineered and authenticated once, and executed many times. Facility standardisation is the development and use of consistent designs and standards for repeatable projects within a programme. CII recognises the value with effective application of facility standardisation and has conducted research on what is required to standardise facilities. There is a varying level of standardisation that can be applied to a facility (Figure 4).
The more standardisation that is applied to a programme, the more benefits will be realised. Standardisation is directly related to proven-in-use designs (i.e., not re-inventing the wheel each time). This approach greatly improves reliability both in project execution and operations.
For LNG facilities, there exists an opportunity to apply productisation with standardised modular process trains and standard pre-assemblies. Pre-assemblies are when materials, prefabricated components, and/or equipment are joined together by different crafts at an off-site location for subsequent installation as a sub-unit, and can consist of only one or two components.
Pre-assembly standardised examples which can be applied to LNG facilities include:
� Manifolds.
� Cabinets.
� Sample stations.
� Lighting panel or fixture.
� Utility stations.
� Instrument or cabinet support systems.
� Instrument rooms.
Automation and controls will include margins to their design calculations. The amount of margin applied can often be very conservative and create overdesigns which do not provide real value.
Design margins often become accumulative where other disciplines and vendors add additional margins based on their guarantees, warrantees, and perceived risk. It is easy to see how overdesign can create loss of value to the facility owner without careful management.
An example of how design margins can impact the value is described in the UPS design. Design margins are normally applied to:
� UPS loading.
� Conversion from DC loads.
� Redundancy.
� Segregation.
� Backup time.
These design margins then add up and cause the UPS to be greatly oversized. A solution would be when reviewing these categories, the automation and control team needs to collaborate with other disciplines, such as process and electrical. They will need to review the following to establish the realistic requirements and appropriate design margins for:
� More careful definition of spare capacity with the end-user.
� Actual expected load vs cabinet nameplate capacity.
� Realistic plant expansion.
� Realistic design margins.
� UPS standard model size vs battery capacity.
� Unrealistic battery run times.
Once the requirements have been established and aligned with, a more practical and cost-effective UPS design can be developed.
It is important to provide the necessary governance on the project to ensure the project team implements the required lean engineering and design methods and tools that are set out in order to meet the business objectives. Governance is the continuous monitoring to ensure the effective implementation of the lean design and execution methods and tools. It is typically performed by a third-party reviewer or organisation, and has been very difficult to complete on industrial projects since third-party/independent reviewers are often not deployed to perform the reviews. The process begins when a validated project concept has been identified during the business planning process and ends when the project has been completed and ready for start-up.
Utilising lean methods early on in an LNG project can set the project and automation and controls team up for success.
By incorporating the methods discussed in this article (including implementing new digital technologies, aligning the class of plant with business needs, performing a lifecycle cost analysis, implementing productisation, and optimising design margins), the project’s overall lifecycle cost will be successfully reduced, and the project’s IRR requirements will be met; therefore, maximising the facility owner and overall shareholder value. Projects will meet the business objectives and be able to pass through the funding gate without any rework to the design, improving the project’s execution productivity and efficiency.
1. FANE, M., ‘How to unlock value in oil and gas capital projects in any environment’, EY, (30 September 2020), www.ey.com/en_gl/oil-gas-digital-skills-survey/howto-unlock-value-in-oil-and-gas-capital-projects-in-anyenvironment
2. Construction Industry Institute, www.construction-institute.org
3. Lean Enterprise Institute, www.lean.org
4. HARKONEN, J., HAAPASALO, H., and HANNINEN, K., ‘Productisation: A review and research agenda’, International Journal of Production Economics, Vol. 164, (June 2015), pp.65 – 82, https://doi.org/10.1016/j.ijpe.2015.02.024
There are several dire takeaways from the United Nations Intergovernmental Panel on Climate Change (IPCC)’s latest report on climate change. One that stands out in particular is the projected future carbon dioxide (CO2) emissions: “Projected cumulative future CO2 emissions over the lifetime of existing fossil fuel infrastructure without additional abatement exceed the total cumulative net CO2 emissions in pathways that limit warming to 1.5˚C (>50%) with no or limited overshoot.”1
In other words, existing technologies that can reduce carbon emissions, and all greenhouse gas (GHG) emissions, from existing fossil fuel infrastructure post-haste need to be operationalised. One area of focus has been in shifting fossil fuel consumption to natural gas. Natural gas, while still a fossil fuel, offers a
significantly more environmentally-sustainable energy source than oil or coal. The US, in particular, has come to rely on natural gas more than any other country in the world.2 According to the US Department of Energy, natural gas generates nearly 40% of the electricity consumed in the US.3 Natural gas is critical to the reliability of the US’ integrated energy grid today, and, truth be told, is likely to continue to play a significant role in the future.
While opportunities exist to reduce emissions throughout the natural gas supply chain, one interesting area to focus on is the midstream sector. While the midstream contributes an overall
Midstream natural gas presents an opportunity to achieve lasting emissions gains, starting today, says Freddie Sarhan, CEO, Sapphire Technologies, USA.
low percentage of emissions in the natural gas supply chain, it has important implications for transitioning to cleaner energy, both today and in the future. Focusing on the midstream – i.e. the transport of energy from producers to downstream users – presents the opportunity to future-proof any emissions gains because it is unlikely the US will fully overhaul its vast energy infrastructure anytime soon. Existing midstream infrastructure is likely to play a role even while transitioning to new energy sources. A secure, reliable, and efficient midstream sector will be key to enabling the clean energy transition.
For midstream operators, there are immediate opportunities to reduce emissions – among them, shifting to renewable energy consumption, modernising infrastructure, and preventing worst-case scenarios.
One area where midstream operators can make meaningful impact on reducing emissions in the short-midterm is by ‘cleaning up’ combustion, for example by converting compressors to electric. In fact, Energy Transfer, a midstream provider that in 2018 contributed to the highest midstream emissions of the top 10 US midstream operators according to a University of Amherst Political Economy Research Institute index, won the Environmental Excellence Award from the GPA Midstream Association in 2021 for their ‘Dual Drive’ natural gas compression system.4 The company estimates that their system reduced CO2 emissions by more than 630 000 t in 2020.5
Another area where midstream operators can reduce emissions is by leveraging existing technology that is already on the market to shift electricity consumption to renewable electricity. For example, Sapphire’s FreeSpin® In-line Turboexpander (FIT) technology converts energy wasted in pressure reduction processes in natural gas pipelines into clean electric power. This same technology is as applicable today as it will be in a future where the same infrastructure can be utilised to move alternative fuels (e.g. hydrogen) or renewable fossil fuels. Each FreeSpin system generates up to 2.6 GWh/y of clean electricity, offsetting 2000 t CO2-e. With 300 000 natural gas pressure let down stations globally, this turboexpander, which has a low total cost of ownership, has the potential to offset 600 million t of CO2-e immediately.
According to the International Energy Agency (IEA), reducing methane emissions from oil and gas operations is one of the most cost-effective ways to fight climate change.6 In fact, one of
the worst climate disasters in 2022 occurred from a single methane leak from a natural gas well in Pennsylvania that negated the positive emissions impact of half the electric vehicles sold in the US in 2022.7 Policymakers are already on top of this specific problem, thanks in part to a decades-long push from the Environmental Defense Fund (EDF) to research and document the scale and impact of methane emissions. A specific methane fee is included in the Inflation Reduction Act, signed into law in August 2022. Technology already exists to prevent and mitigate the damage of methane emissions across sectors. A 2021 EDF report stated that by pursuing all currently available methane emission mitigation measures “could slow the global-mean rate of near-term decadal warming by around 30%” and “avoid one-quarter of a degree centigrade of additional global-mean warming by mid-century.”8
There are myriad technologies that exist today to help reduce emissions in midstream natural gas, an important sector that plays a critical role in both the current and future energy systems. The goal is not to enumerate all of the technologies on the market or to support one over another, but to suggest that more must be done to operationalise all existing technologies while continuing to invest in research and development to explore new ones.
Transitioning to clean energy is a monumental task, and it must be acknowledged that fossil fuel companies have their hands full in planning a path toward a cleaner future that does not completely disrupt life and industry as it is known today. Cleantech solution providers must play their part as subject matter experts and educate fossil fuel energy providers on not only the short-term benefits of our technologies, but also how these technologies will play a role in the long-term evolution of energy supply chains.
1. ‘IPCC AR6 Synthesis Report: Climate Change 2023’, Intergovernmental Panel on Climate Change, (March 2023), p.24, https://report.ipcc.ch/ar6syr/pdf/IPCC_AR6_SYR_LongerReport. pdf
2. ‘Natural gas by country 2023’, World Population Review, https://worldpopulationreview.com/country-rankings/naturalgas-by-country
3. ‘U.S. Oil and Natural Gas: Providing Energy Security and Supporting Our Quality of Life’, U.S. Department of Energy: Office of Oil & Natural Gas, (October 2020), www.energy.gov/ sites/prod/files/2020/10/f79/Natural%20Gas%20Benefits%20 Report.pdf
4. ‘Greenhouse 100 Polluters Index (2020 Report, Based on 2018 Data)’, University of Amherst, https://peri.umass.edu/greenhouse100-polluters-index-current?id=127
5. ‘Energy Transfer’s dual drive technologies receives environmental excellence award’, Energy Transfer, (29 September 2021), https://ir.energytransfer.com/news-releases/news-release-details/ energy-transfers-dual-drive-technologies-receives-environmental
6. ‘Driving Down Methane Leaks from the Oil and Gas Indsutry’, International Energy Agency, (January 2021), www.iea.org/reports/driving-down-methane-leaks-from-the-oiland-gas-industry
7. CLARK, A., ‘Giant Methane Leak Tops List of Worst US Climate Disasters in 2022’, Bloomberg, (13 December 2022), www.bloomberg.com/news/articles/2022-12-13/us-gas-leak-atequitrans-well-in-pennsylvania-adds-climate-pressure#xj4y7vzkg
8. OCKO, I. B., et al, ‘Acting rapidly to deploy readily available methane mitigation measures by sector can immediately slow global warming’, Environmental Research Letters, Vol. 16, No.5, (2021), https://iopscience.iop.org/article/10.1088/1748-9326/ abf9c8?addl_info=2021%0AThe%20fastest%20way%20to%20 slow%20warming
he transportation industry is looking towards a fundamental change. With the world facing global climate change, all industries have a responsibility to find the most efficient and clean solution for everyone’s sake – this also includes the transportation industry. Luckily, the technology is already available, and so is the know-how, to make a significant change to secure a clean and reliable energy source for refuelling – both on land and on water. The solution is simple: LNG/liquefied biogas (bio-LNG).
According to the International Council on Clean Transportation (ICCT), the global demand for LNG will increase to 36.2 million t or 1738 PJ by 2030 –approximately three times higher than the demand in 2019. Additionally, it is estimated that the growth of alternative fuel uptake by number of ships will rise from 662 in 2022 upwards to 1067 in 2028.1 Currently, only 0.41% of vessels are fuelled by alternative sources, with LNG being the most popular at 0.34%. However, as the availability to cleaner energy sources is increasing, it is expected that alternative fuel will supply 20.84% of the fleets, with LNG as the market leader with 14.94% in 2023.1
Not only is the world looking towards more LNG-fuelled
marine vessels, but the heavy transportation industry is also facing a change. In 2020, there were 12 000 LNG-powered vehicles on the roads in Europe. As the industry is making a shift into alternative and greener fuel solutions, it is expected that LNG trucks in Europe will increase to 280 000 by 2030.2
Since bio-LNG is chemically identical to LNG, it can be used as a carbon-neutral alternative without requiring new technology. Bio-LNG is also applicable to shipping, with 50% of large container vessel orders being LNG-fuelled or ready for conversion. Heavy industry that is not connected to a gas grid could also benefit from replacing fossil fuel tanks with bio-LNG to achieve a cleaner profile and reduce reliance on fossil fuels. By using a combination of LNG and bio-LNG, reductions in emissions will become significant. For instance, a large ship running on 20% bio-LNG can achieve a 34% reduction in carbon dioxide (CO2) impact, while an LNG truck with 40% bio-LNG can cut its CO2 emissions to less than half. At 80% bio-LNG, the vehicle can effectively become carbon neutral.
One of the key elements in securing a green solution for transportation is availability. There has been a steep increase of 380% in the development of LNG/bio-LNG refuelling stations in Europe, from 125 refuelling stations in 2Q18, to 600 in 4Q222 – by securing stable and reliable fuelling solutions, the future is looking green.
As developers behind the technology for liquefaction of biogas solutions, MAKEEN Energy is experiencing an increased demand for facilities, especially in Denmark, with the capability up to 12 000 m3/h of raw natural gas. However, in Central and Southern Europe, it is the opposite situation, where customers are focusing on smaller scale solutions with a capacity of 5 – 10 tpd.
Frej Olsen, MAKEEN Energy, Denmark, considers how liquefied biogas and LNG could be the solution to creating a cleaner transportation sector.
This underlines the importance of a broad portfolio, where the demands of the different markets must be considered, not only focusing on Denmark, where the company is based. Common for these markets is the demand for a turnkey solution, where the process is driven from A – Z, providing customers with a finished solution.
The invasion of Ukraine sent Europe into an energy crisis, which especially affected the gas industry. As prices on the vast majority of energy sources skyrocketed, so did the prices for gas, which was largely imported from Russia to Europe prior to the invasion.
The crisis caused several challenges for the overall supply chain of LNG solutions: longer delivery times from suppliers, increasing prices, etc. This has resulted in a restructuring of MAKEEN Energy’s projects, as the delivery time on certain components increased from 12 weeks to 52 weeks – even still to this day. With the supply chain challenges, the price for LNG skyrocketed to upwards of €340/MWh. This meant a setback, especially for LNG-fuelled trucks, as a lot of these switched to the cheaper and easily available alternative, diesel fuel.
However, the energy crisis underlined the importance of reliable and local energy sources, in addition to an increased demand for alternative energy sources – especially biogas. This has also resulted in a significant strengthening of the infrastructure for a biogas supply. In Germany, this shift has been significant and independence from Russian gas became a priority. This resulted in exponential growth and improvement of LNG infrastructure, with solutions such as import terminals, and FSRUs. Due to Germany’s geographical position, it has been possible to utilise this alternative with ships as storage units, docking at the Western shore of Germany. The flexibility in the solution is a step closer to independence from Russian gas, and opening for shipping LNG from Norway and the US, for example.
Since the peak of the energy crisis, the price for LNG has stabilised and is competitive to diesel once again. LNG is a premium product because of its very low CO2 emissions; however, the market demand confirms that it is worth investing in cleaner energy sources, rather than the traditional, emission-heavy fuel. The level of utilisation of LNG is yet to reach the same level as before the crisis, but MAKEEN Energy are confident that the demand for green solutions is soon to peak once again.
One of the green alternatives that has been a focal point of discussion following the energy crisis is biomethane, and for good reason.
In 2021, the European biogas industry was at a record high, with more than 1023 production facilities. Denmark is one of the countries with the highest number of biogas production plants, with a total of 51 plants at the end of 2021. According to the European Biogas Association (EBA), it is estimated that 87% of the biogas plants are connected to the gas grid.
Currently, anaerobic digestion takes the biggest share of the biomethane potential in 2030, with up to 38 billion m3/y of natural gas. Germany, France, Italy, and Spain in particular are frontrunners in terms of technology for biomethane and carry the biggest market potentials.
Biomethane is a promising green alternative for energy production. With ongoing developments and investments in technology, biomethane has the potential to play a key role in the transition to a more sustainable and cleaner future for energy.
The production of bio-LNG faces a challenge in the supply chain, particularly in the production process. To produce bio-LNG, biogas must be cooled to -162˚C (-260˚F) at a liquefaction facility, which requires different infrastructure compared to the imported LNG that is broken down into bulk or transported to end-users by truck, rail, or ship. However, due to the lower production quantities of bio-LNG, large scale projects are currently
not feasible. To overcome this challenge, local production is a viable solution. By constructing multiple liquefaction facilities closer to critical transportation junctions and harbours, the supply chain can be shortened significantly and costs can be lowered. In Denmark, for instance, this approach is already in the works, with a partnership between Nature Energy, one of Europe’s biggest biogas producers, and MAKEEN Energy, with the construction of one of the country’s first plants for liquefaction of natural gas and biogas – Nordic Liquefaction (NORDLIQ).
Located at the Port of Frederikshavn, Northern Denmark, NORDLIQ will provide a clean energy alternative for the heavy road and maritime industries, establishing Frederikshavn as a sustainable energy hub for Northern Europe. In November 2022, the construction of the plant was initiated with a ceremony with participating parties from MAKEEN Energy, Nature Energy, and Frederikshavn Municipality.
With an annual capacity of 20 000 tpy of bio-LNG or LNG, and the potential to increase to 120 000 tpy, the NORDLIQ plant is expected to make a significant impact on Denmark’s energy grid, where biogas is projected to comprise 100% of all gas by 2040. Liquid biogas offers a solution for the shipping and heavy
industry’s shift towards clean energy. The plant will solidify the Port of Frederikshavn’s position as a green centre and highlight its strategic location between the Baltic Sea shipping route and the highway network.
As mentioned, lack of infrastructure and therefore lack of availability is one of the biggest challenges in making the final step towards a greener transportation industry. There is evidently
Roads and ports are becoming increasingly busy as the global population grows and more people choose to live in cities. A range of vehicles and fuels, including LNG, will be needed to meet increasing demand for transport while at the same time the world seeks to reduce emissions.
Cryonorm believes that LNG and the latest development, bio-LNG, could form a bigger part of the transport energy mix as a lower-carbon fuel, alongside developments in vehicle efficiency, biofuels, hydrogen, and electric mobility.
Used in trucks delivering goods, LNG and bio-LNG have the potential to offer fuel cost savings when compared to conventional diesel. They can also reduce sulfur emissions, particulates, and nitrogen oxides, and help reduce greenhouse gas (GHG) emissions from production to use.
Burning LNG/bio-LNG in truck engines is quieter than burning diesel in combustion engines. It means LNG-fuelled
trucks can operate longer under noise restrictions, for example when delivering to supermarkets in residential areas.
Cryonorm’s focus is building cryogenic infrastructure, as the growing market potential for gas-fuelled vehicles is the company’s main driver to develop and market a standard range of liquefied compressed natural gas (L-CNG) filling stations.
Cryonorm has built over 70 LNG/bio-LNG fuelling stations in Europe, daily fuelling trucks with LNG, and cars with CNG successfully.
The energy crisis in Europe following the war in Ukraine saw LNG fuel prices go through the roof,
resulting in the transport sector being forced to look for energy alternatives.
LNG turned out to be too expensive and truck owners selected different types of vehicles, with a return to diesel in most cases.
Due to the decreasing LNG sale on the retail stations, many stations had boil-off gas (BOG) problems. Additionally, the sometimes warm bio-LNG had a negative impact on the LNG/bio-LNG holding time in the station storage tank.
On request of the company’s customers, the station owners, Cryonorm has developed systems to prevent or handle BOG.
The solution to prevent BOG is to sub-cool LNG with liquid nitrogen: downstream the LNG pump, a two-stream heat
exchanger is installed. One stream is the warm LNG from the bottom of the LNG storage tank, while the other stream is cold liquid nitrogen subcooling the LNG in counterflow.
The subcooled LNG will be automatically sprayed back into the tank top-fill connection, cooling the LNG and reducing the pressure in the tank.
This system has the following advantages:
z Low consumption of liquid nitrogen.
z Automatically cooling the LNG tank inventory to the required set pressure.
z Recondensing vapour phase to LNG.
z Low investment costs.
Jos Glorie, Cryonorm, the Netherlands, explains how LNG can be utilised as an alternative fuel, outlining how this transition could help to reduce greenhouse gas emissions when compared to conventional fuels.
z Can be installed on all existing stations.
carbon dioxide
Today’s discussions about the fuel of the future always points to hydrogen. Cryonorm cannot ignore these signals. Looking for efficient hydrogen (H 2) as a fuel on existing LNG stations, Cryonorm invented BOG reforming technology. Over recent years, its proprietary reforming technology has been used to generate hydrogen from natural gas (BOG).
From the BOG connection on the LNG tank, Cryonorm will first install a BOG electrical heater, to warm up the BOG to 10˚C. After the e-heater, a natural gas booster compressor will be installed, increasing the BOG from 4 – 8 to 11 barg.
The 11 barg natural gas will be converted to CO2 and H 2 using steam methane reforming technology.
Steam is added to the natural gas and led into the reformer. The heat and catalytic properties of the reformer cause the following reaction: CH4 + H2O –> 3H2 + CO.
The remaining carbon monoxide is then converted in the water gas shift assembly to produce more hydrogen: CO + H2O –> CO2 + H2. This gas enters the PSA-unit where hydrogen is separated from other gaseous species under elevated pressure using differences in adsorption properties. The cleaned hydrogen is then stored in the low-pressure buffer vessel and can be used for further compression to be used as vehicle fuel at 400 and 700 barg.
From the 11 barg low pressure H2 storage, the hydrogen is compressed and stored to medium pressure 400 barg for fuelling trucks and compressed and stored to 900 barg to fuel cars.
The unique advantages of local H2 production and fuelling is:
z Saving compressed H2 logistics.
z Producing H2 where it is needed: i.e., at a fuelling station.
z On L-CNG fuelling stations, trucks and vehicles are already being refuelled, meaning that road infrastructure is already in place.
z Solve BOG problems on LNG stations with declining customers.
z Multi-gas station H2, LNG, and CNG.
The company was asked to work on an existing LNG fuelling station in Germany, with the aim of converting 90 Nm3/hr of natural gas into hydrogen using a steam reformer CNS150. The natural gas source which needed to be converted to hydrogen is 90 Nm3/hr BOG or vaporised natural gas from a 70 m3 LNG storage tank. This gas is heated to 11˚C and compressed to 11 barg before feeding it into the steam reformer. The steam reformer produces 141 Nm3/hr hydrogen gas at a purity of 99.5% (2.5) at 7 barg or 126 Nm3/hr at a purity of 99.999% (5) at 7 barg, depending on client requirements.
The steam reforming system uses two technologies: the highly integrated steam reforming technology (HISR) and the quality cycle vacuum pressure swing adsorber technology (Qcycle-VPSA).
These two technologies are the base of the Cryonorm hydrogen generation systems. The CNS150 is a standalone operating system that can easily be installed on any site. Multiple systems can be installed in cascade when a higher capacity is required.
The CNS150 consists of six main modules:
z Fuel preparation module (FPM).
z Hydrogen generation module (HGM).
z Reformate cooling module (RCM).
z Hydrogen clean-up module (HCM).
z Hydrogen buffer module (HBM): 6 x 150 l at 7 barg.
z System control module (SCM).
The hydrogen delivery pressure has a maximum of 7 barg; however, this is not sufficient for fuelling vehicles. In this case, a medium- and high-pressure compressor system will be installed after the 7 barg buffer module, increasing the pressure to 450 and 900 barg.
Medium- and high-pressure hydrogen buffering will be installed downstream compression before dispensing the hydrogen into the vehicles. Sizing of final buffering depends on the client business case: type of vehicles and quantity of vehicles fuelled daily.
Hydrogen generation module CNS150 contains three generation modules for optimal turndown and redundancy of the system. In the generation module, the natural gas/steam mixture is converted into a hydrogen rich stream by means of steam reforming. The required steam is generated with an integrated steam generator and the mixture is preheated by an internal recuperative heat exchanger. The necessary heat
is brought into the system using an integrated burner that combusts the off-gas coming from the VPSA through the off-gas section. The reforming process operates at 8.5 bar(g) at temperatures approximately 800˚C.
Producing hydrogen where it is needed, i.e., at the LNG-fuelling station, has several main advantages, including:
z Saving expensive hydrogen logistics and on-site hydrogen storage.
z Small extension on existing fuel station.
z No need for expensive tube trailer offloading and hydrogen receiving buffer storage system.
z LNG fuelling stations already have truck and vehicle fuelling infrastructure, so the hydrogen add-on is a small extension.
Currently, green hydrogen produced by electrolysis has limited availability due to shortage of electrical power and availability of electrolysers, therefore >80% of current hydrogen is already grey and produced from f.e. methane (natural gas).
Almost no liquid hydrogen is available yet, due to limited liquefaction capacity.
For the coming decade, producing hydrogen using steam reforming at the location where it is needed is the most viable solution.
On the list of potential hazards in many industrial manufacturing and processing facilities, elevated noise levels rank near the top. The US National Institute for Occupational Safety and Health (NIOSH) estimates that more than 22 million workers in the US alone are exposed to harmful noise levels on an annual basis. 1
LNG terminals contribute to this statistic with their wide range of inherently noisy equipment that includes air-cooled heat exchangers, piping systems, compressors, and pumps. The noise generated by this equipment typically exceeds NIOSH’s recommended exposure limit (REL) of 85 dB (as an eight-hour time-weighted average).
Plant personnel exposed to noise above the REL face serious physical and psychological problems, including tinnitus, permanent hearing loss, hypertension, and depression. High noise levels also raise the risk of accidents and can put the plant at odds with neighbouring communities by exceeding local noise ordinances and threatening the welfare and safety of nearby wildlife.
Given these threats to an LNG plant’s performance and safety, operators continue looking for reliable, cost-effective noise-reduction solutions. This article reviews a solution advanced by ROCKWOOL Technical Insulation – ProRox MA-960 ® with WR-Tech TM – which leverages stone wool’s unique properties to reduce noise from pipes, vessels, and other plant equipment in LNG facilities. Not only does this new insulation reduce noise levels to below REL, but it also counters the pervasive problem of corrosion under insulation (CUI) by incorporating an advanced water-repelling technology.
The turbulent flow of liquids moving through an LNG plant’s piping network and other equipment is a major cause of excessive noise levels of 100 dB or more. Stone wool insulation excels as a noise suppressant by dampening the vibrations generated by this turbulent fluid flow.
For more than 80 years, stone wool insulation materials have leveraged the natural power of stone to provide effective thermal and sound resistance in industrial applications. These materials are manufactured by melting natural rock, spinning it into long fibre strands, and then weaving the strands into high-density mats or forms that can be easily affixed to the outside of piping systems and other LNG equipment.
On the ‘hierarchy of controls’ developed by NIOSH (Figure 1), 2 the application of sound-suppressing insulation to control the noise hazard from piping and other plant equipment generally has mid-range effectiveness (more effective than PPE, less effective than eliminating the
Abraham Sebastian, ROCKWOOL Technical Insulation, USA, outlines how insulation advances can mitigate noise and corrosion under insulation in LNG plants.
noise altogether). However, advances in stone wool design and construction have made this insulation a cost-effective option. And when combined with other measures, such as PPE and exposure time limits, noise threats to workers are dramatically reduced.
ROCKWOOL tests its stone wool insulation materials to ensure that they meet certain industry standards prior to application in a plant. One widely accepted standard, ISO 15665, was developed by the International Organization for Standardization (ISO) to guide the selection and design of acoustic insulation for pipes, valves, and flanges.
ISO 15665, which has been adopted by major oil and gas operators, refineries, and LNG plants, defines different classes of sound control (Classes A, B, C, and D). The Class D specification was adopted by Shell and has become the predominant sound control class for LNG plants around the world. These four classes are further broken down into three subsets based on pipe diameters (small, medium, and large).
The standard sets requirements for minimum insertion loss, which is a measure of the minimum noise reduction in dB for each class when acoustic insulation is applied to a pipe system. Insertion loss testing is conducted in a sound room with a single steel pipe running the length of
the room (Figure 2). Noise is introduced at one end of the pipe via a loudspeaker and terminated at the other end by dampening materials that do not allow any noise to escape. A microphone is used to measure the noise before and after the installation of insulation to determine the total insertion loss.
The stone wool insulation effectively met the ISO 15665 standards for recommended insertion loss levels for Classes A, B, C, and D materials in this testing.
ROCKWOOL conducted extensive testing and drew upon its widespread application experience to develop ProRox MA-960 with WR-Tech with design features that would ensure cost-effective installation and reliable performance in an LNG plant.
The stone wool insulation effectively meets ISO 15665 standards for acoustic insulation performance — at half the required maximum thickness of a conventional insulation material. Less thickness translates to lower installation costs, more effective use of installation crews, less storage space required for inventory, and lower transportation costs.
After being subjected to pre-heat stress tests of 482˚F (250˚C) for 24 hours, the insulation stays well within industry-standard boundaries for effective acoustics suppression and water repellence.
Only one insulation product and one heavy mass layer are necessary to provide the required acoustics insulation performance. This solution eliminates the need to glue individual layers and avoids the use of specialised PPE or other special safety requirements during installation. An easier, faster install also translates to less downtime.
In many plant operations, the ingress of water through the insulation and onto the metal surfaces of pipes and other equipment can cause aggressive CUI. The severity of the CUI is related to the temperature of the pipe or equipment: higher temperatures translate to more aggressive and higher corrosion rates. While most insulation requirements in an LNG plant are for low-temperature applications, there are some critical areas in the plant that operate at elevated temperatures where CUI will pose a higher risk.
For these applications, ROCKWOOL’s WR-Tech gives the insulation improved water-repellent properties that mitigate against CUI. This binder technology coats each individual fibre of the stone wool insulation with an inorganic, hydrophobic additive during the manufacturing process. This ensures that the stone wool maintains superior water repellence, even at elevated
operating temperatures, while preserving the insulation’s thermal and acoustics performance as well.
The water-repellent additive dramatically lowers CUI and extends the piping network’s operating life in several ways.
The treated insulation has five times lower water absorption than the next-closest insulation material tested by the EN 13472 standard (the European standard for determining short-term water absorption in pipe insulation). The treated insulation maintains this water repellence, even after heating and ageing.
Insulation treated with WR-Tech contains less than 10 ppm water-soluble chloride content, making it compliant with strict industry standards such as ASTM C795 and EN 13468 and ensuring its safe application over steel.
The insulation’s vapour-open structure ensures that water can evaporate freely if it should reach the pipe surface and provides short dry-out times according to ASTM C1763.
The new acoustic insulation material with WR-Tech is delivered as a mat (wrap) product to provide effective
CUI protection while insulating large-diameter pipework, vessels, columns, or applications requiring design flexibility.
This flexibility of design is important to LNG liquefaction facilities along the Gulf Coast region of the US. Many of these facilities are located in close proximity to areas with a wide diversity of fresh and saltwater wildlife, hundreds of species of birds, and local communities. As part of their ongoing commitment to safeguarding the environments in which they operate, a growing number of LNG facilities are selecting ROCKWOOL’s MA-960 Mat (Wrap) with WR-Tech to provide long-term acoustics and thermal insulation while protecting against CUI.
The global demand for LNG is expected to rise in the coming years, which brings with it a ramping up of new supply projects, particularly in the US. As existing LNG facilities expand and new projects are built to meet growing demand, LNG operators will need proven, cost-effective solutions that improve the safety and long-term productivity of their facilities. Material advances, such as ProRox stone wool insulation with WR-Tech, offer the promise of effective noise suppression and superior water repellence to keep personnel safer and plant equipment running longer.
1. ‘Occupational Health Watch: January 2022’, California Department of Public Health, (28 July 2022).
2. The National Institute for Occupational Safety and Health, ‘Reducing Noise Exposure: Noise Controls’, Centers for Disease Control and Prevention, (19 April 2018).
