November 2025 Kaufman County Transportation Report

Page 1

| PROJECT FUNDING SUMMARY

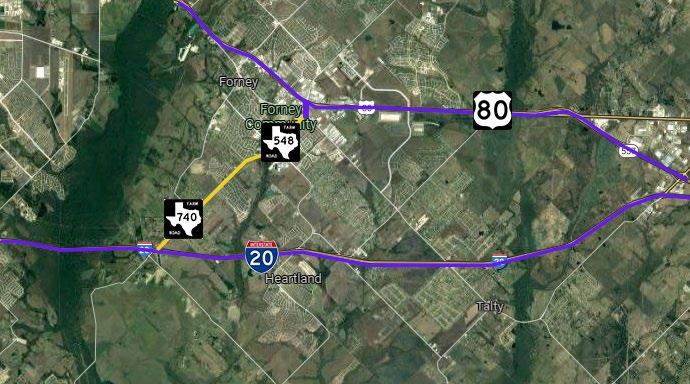

FM 548

CSJ: 1091-02-025; 2588-01-025

Limits: from IH 20 to FM 1641

Project Description:

reconstruct FM 740 and FM 548 to 4lane divided urban roadways; bridge widening at Mustang Creek crossing

Estimated Construction Cost: $91,709,562

Construction Funding: $0

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: Jacobs, Abe Bekele

Schematic Approval: September 5, 2025

Environmental Approval: October 2026

ROW Acquisition Complete: *

Utility Relocations Complete: *

100% Plans: *

Ready to Let Date:

Let Date:

TxDOT Project Manager: Jordan Mrayyan Start Date:

Current Activity:

• Schematic: Schematic approval received on September 5, 2025.

• ROW: TxDOT requested the removal of the proposed ROW along the proposed right-turn lane at southbound FM 548 at College Avenue. ITS suggested modifying design with a reduced 11-foot lane in this area to eliminate proposed ROW. Jacobs revised design with comments and returned for review.

• Environmental: Jacobs continued effort toward preparation of environmental reports and responding to TxDOT comments to same. Thirteen environmental reports have been approved to date. Jacobs is working on public hearing materials. TxDOT confirmed in a meeting on October 23, 2025, that the schematic must be reviewed by the District Engineer prior to the Public Hearing being held. As such, the Public Hearing will be held in early 2026, exact date to be determined.

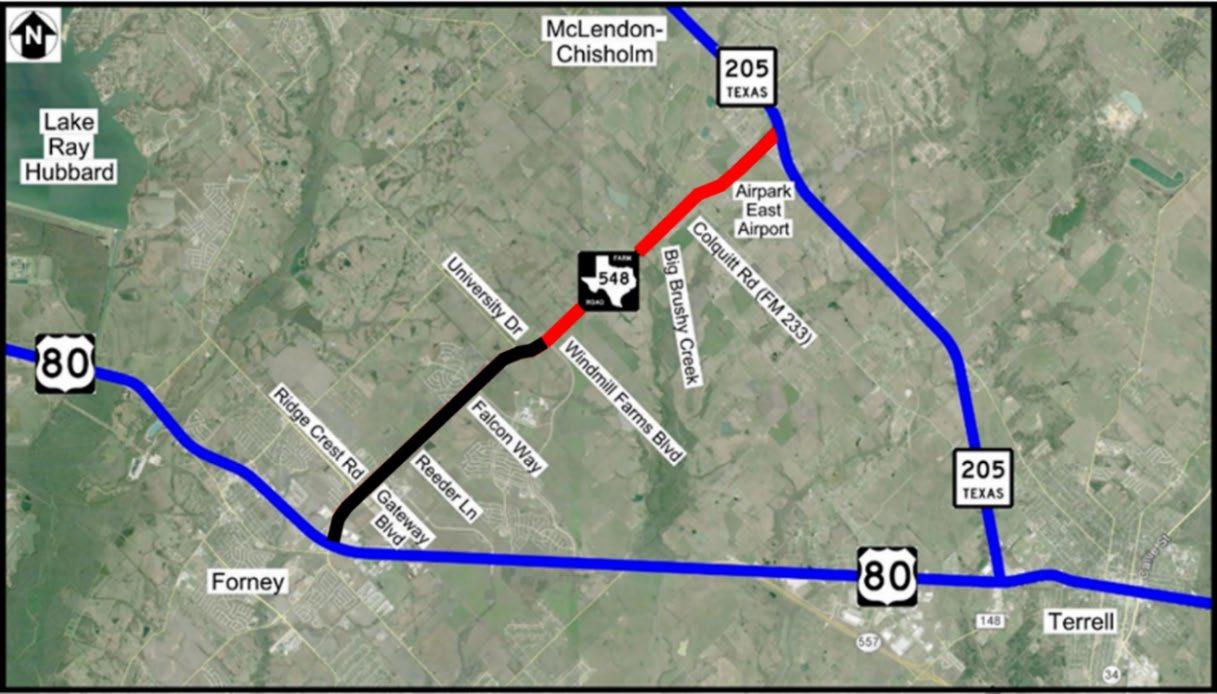

FM 548 North: Phase I

CSJ: 2588-01-022

Limits:

Construction Cost:

Construction Funding:

Project Description:

From north of US Highway 80 to Windmill Farms Blvd.

$80,359,417

$121,437,325

CAT 1: $6,192,282

CAT 2: $115,245,043

Widen existing 2-lane, undivided facility to a 4- to 6-lane, divided facility

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: Westwood, Mark Zoellner, Mark Schluter

TxDOT Project Manager: Lane Selman

Current Activity:

• Utilities: Utilities that are clear of construction: Farmers Electric CoOp, City of Forney, High Point WSC, NTMWD, Oncor, and People’s Telephone Co-Op. Status of utilities currently in conflict:

o AT&T: Anticipate clearance in December 2025.

Schematic Re-Approval: December 28, 2018

Environmental Clearance: July 3, 2019

ROW Acquisition Completed: January 2023

Utility Relocations Complete: December 2025

100% Plans: December 2024

Let Date: March 5, 2025

Construction Start: September 2025

Construction Completion: *

o Atmos: Relocations underway. Anticipate clearance in December 2025.

• Construction: Project let for construction on March 5, 2025. The apparent low bidder is Granite Construction Company with a low bid of $80,359,417 at 19.1% below the engineer’s estimate. There are 774 working days and 32 months of barricades. Pre-construction meeting held on September 3, 2025. Construction began on September 8, 2025 See attached TxDOT construction report.

TxDOT Monthly Project Report for Kaufman County

Date of report: November 20, 2025

Report prepared by: Cody Jolley, P.E.

Control: 2588-01-022

Limits: FM 548 North of US80 – Windmill Farms Blvd.

Project: 2588-1-22

Highway: FM 548

Contractor: Granite Construction Company

TxDOT Area Engineer: Nic Wadlington, P.E.

TxDOT Assistant Area Engineer: Cody Jolley, P.E.

Contractor’s Superintendent: Brad Tyrer

Date Work Began: September 8, 2025

Anticipated Completion Date: May 2028

Phone: (972) 962-3617

Phone: (972) 962-3617

Phone: (972) 358-3712

Current activities include: Excavation/Embankment. Culvert extensions. Drainage installation. Construct temporary pavement. Install concrete traffic barrier.

Narrative description of last month’s activities: Preparing ROW. Installing SW3P. Culvert extensions. Excavation/Embankment.

Narrative description of activities planned for next month: Excavation/Embankment. Culvert extensions. Drainage installation. Construct temporary pavement. Temporary traffic signal construction (Falcon Way).

Traffic issues: N/A

Plans for changes in traffic patterns: N/A

Item(s) of work currently controlling project completion: N/A

Other items of significance: N/A

CSJ:

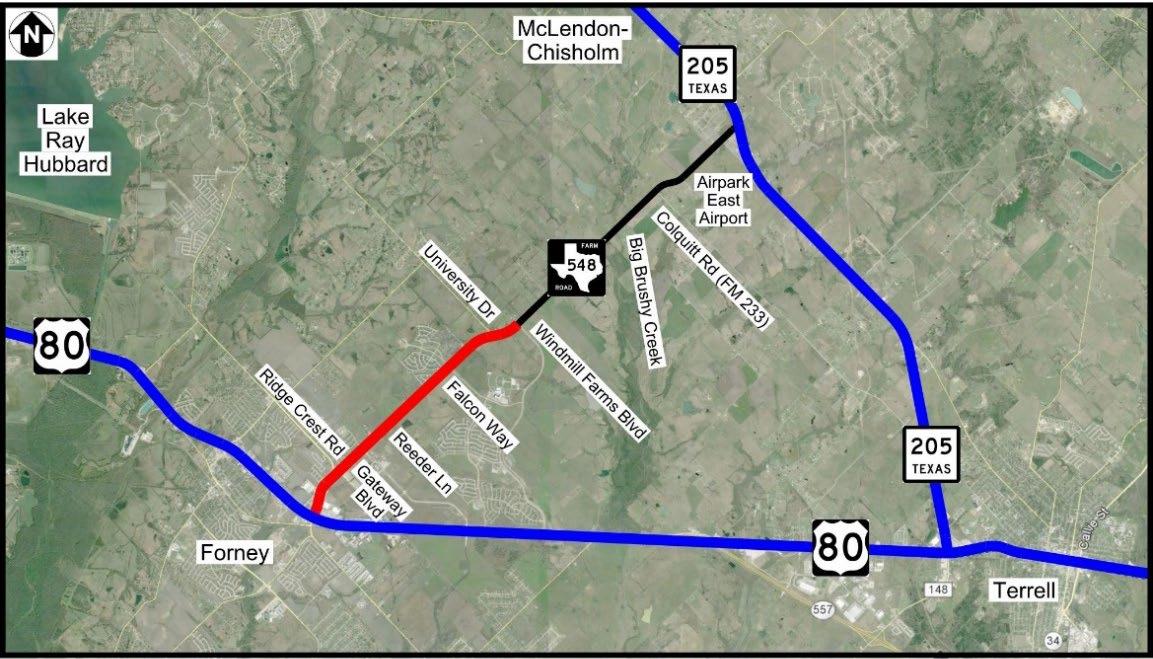

FM 548 North: Phase II

2588-01-017 (Kaufman County) 2588-02-008 (Rockwall County)

Limits: From Windmill Farms Blvd. to SH 205

Estimated Construction Cost:

$94,669,035

$77,233,537: Kaufman County segment

$17,435,498: Rockwall County segment

Construction Funding: $0

Project Description: Widen existing 2-lane, undivided facility to a 4 to 6-lane, divided facility

Commissioner: Skeet Phillips, Precinct 2

Schematic Re-Approval: December 28, 2018

Environmental Clearance: July 3, 2019

ROW Acquisition Completed: August 2022

Utility Relocations Complete: December 2026

100% Plans: March 2026

Ready to Let Date: December 2026

Engineer & Key Contact: Burns & McDonnell, Tony Schmitt Let Date: Pending Funding

TxDOT Project Manager: Gutema Gebrial

Construction Start: *

Current Activity:

• PS&E: Burns & McDonnell continues working toward completion of 100% plans and updating plans to 2024 TxDOT Specifications

• Utilities: Utilities that are clear: Atmos, City of Dallas Water, Optimum, and Sprint.

• The status of utilities in conflict is below:

o FEC: Relocations underway.

o High Point SUD: Currently focusing on SH 205 to complete relocations before focusing on FM 548.

o Spectrum: Plans approved. Pending FEC relocations.

o Suddenlink (Optimum): Plans approved. Pending FEC relocations.

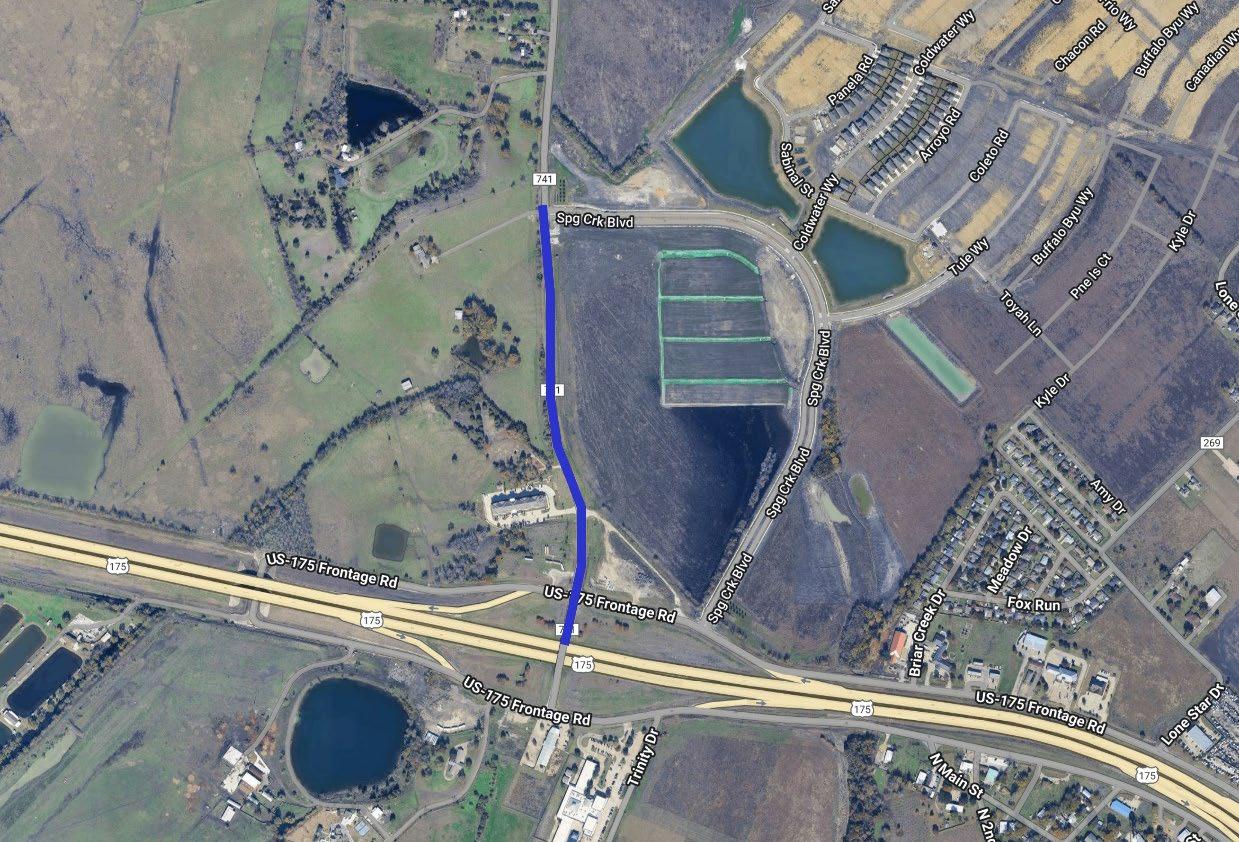

FM 148 Bypass

CSJ: 0751-05-001; 0197-03-078

Limits: From US 175 to south of FM 3039

Construction Cost:

$60,049,999

Construction Funding: $38,777,994

CAT 2: $33,777,994

CAT 3: $5,000,000

Project Description:

Construct new 2-lane undivided facility; add connection to proposed US 175 frontage road project

Schematic Approval: June 30, 2017

Environmental Clearance: April 26, 2019

ROW Acquisition Completed: November 2020

Utility Relocations Completed: February 2023

100% Plans: April 28, 2023

& Key Contact:

TxDOT Project Manager:

Current Activity:

• Utilities: With the exception of utilities that will complete relocations at the FM 148 Bypass/US 175 intersection, if necessary, during the US 175 South Frontage Road construction, utilities are clear of construction.

• Construction: The project was awarded to Granite Construction Company with a low bid of $60,049,998.99 at 3.74% above the engineer’s estimate. There are 35 months of barricades and 735 working days. See attached TxDOT construction report.

Construction Completion: March 2026

Commissioner: Tommy Moore, Precinct 4
Ready to Let Date: March 2023
Engineer
Halff Associates, David Burkett Let Date: June 27, 2023
Lane Selman

TxDOT Monthly Project Report for Kaufman County

Date of report: November 20, 2025

Report prepared by: Cody Jolley, P.E.

Control: 0197-03-078 Limits: 2.3 miles west of FM 148 Bypass to East of FM 148 Bypass Project: F 2023(704) Highway: FM 148

Contractor: Granite Construction Company

TxDOT Area Engineer: Nic Wadlington, P.E.

TxDOT Assist. Area Engineer: Cody Jolley, P.E.

TxDOT Project Manager: Jacob Self

Contractor’s Superintendent: Brad Tyrer

Date Work Began: October 2, 2023

Anticipated Completion Date: March 30, 2026

Phone: (972) 962-3617

Phone: (972) 962-3617

Phone: (972) 962-3617

Phone: (972) 358-3712

Current activities: Flexbase at FM 148 Construct retaining walls. Excavation/Embankment. Asphalt paving. Install signs. Stone rip rap.

Narrative description of last month’s activities: Flexbase at FM 148. Construct retaining walls. Excavation/Embankment. Asphalt paving. Install signs. Stone riprap.

Narrative description of activities planned for next month: Excavation/Embankment. Asphalt paving. Install signs. Install striping. Stone rip rap. Vegetation establishment.

Traffic issues: None

Plans for changes in traffic patterns: Eastbound main lane traffic shift date to be determined.

Item(s) of work currently controlling project completion: None

Other items of significance: None

FM 1641

CSJ: 1217-01-019; 2588-01-020

Limits: From FM 548 to FM 148

Estimated Const. Cost:

$109,172,259 -019: $105,555,131 -020: $3,617,128

Construction Funding: $0

Project Description: Widen to a 4-lane divided (6-lane ultimate) urban facility

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: LTRA, Massoud Manesh

TxDOT Project Manager: Chaikou Bah

Schematic Re-Approval: April 26, 2021

Environmental Clearance: August 31, 2021

ROW Acquisition Completed: October 2023

Utility Relocations Complete: December 2027

100% Plans: August 2025

Ready to Let Date: December 2027

Let Date: Pending Funding

Construction Start: *

Current Activity:

• PS&E: LTRA submitted the final plan set for review on August 12, 2025. Plans have been shelved until letting.

• Utilities: Utilities that are clear: Forney ISD, Gulf South Pipeline, Oncor, and Peoples Telephone

• Status of utilities in conflict is below.

o AT&T: Relocations are underway.

o Atmos: Relocations complete. Pending removals.

o City of Forney: Relocations pending funding and easement acquisition.

o Gastonia: Relocations pending easement acquisition.

o NTMWD: Working on relocation plans.

o Suddenlink (Optimum): Needs TVEC pole plans for relocation.

o Talty SUD: Working to acquire easements.

o TVEC: Relocations are underway.

CSJ: 1092-01-021

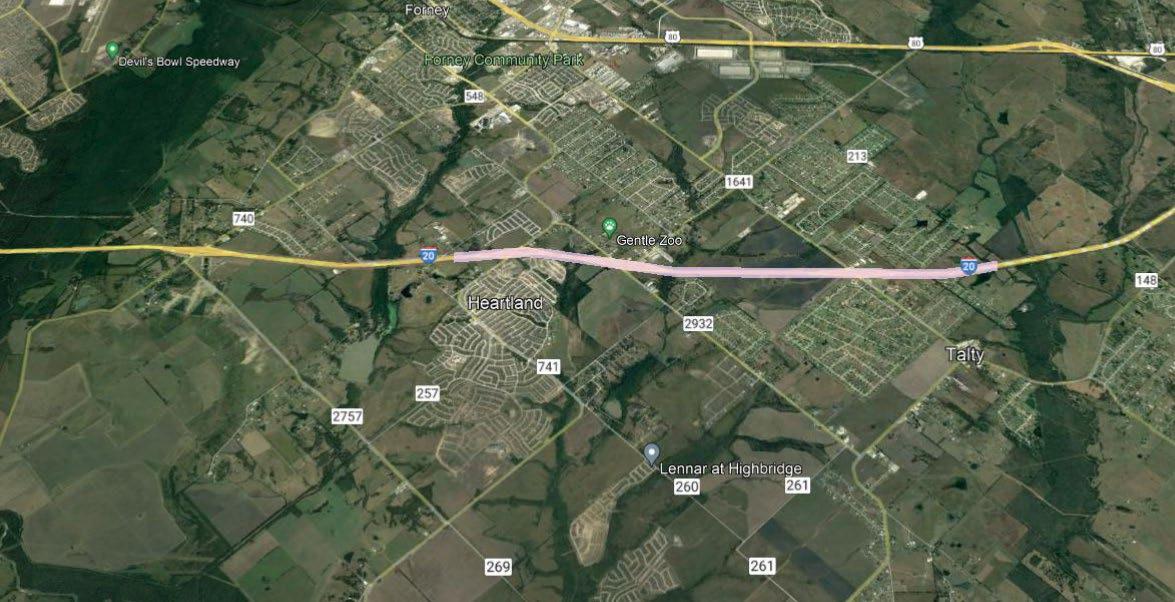

FM 741

Limits: from FM 548 to Spring Creek Blvd

Project Description: Widen and reconstruct from a 2-lane rural undivided to a 4/6-lane urban divided

Estimated Constr. Cost: $184,605,971

Schematic Approval: July 20, 2022

Environmental Clearance: March 28, 2023

Acquisition Complete: June 2029

Utility Relocations Complete: June 2031

Construction Funding: $0 100%

Commissioner: Skeet Phillips, Precinct 2 and Tommy Moore, Precinct 4

Engineer & Key Contact: HNTB, Kyle Riley

TxDOT Project Manager: Solomon Robelie

Current Activity:

• PS&E: HNTB submitted the 100% plan set. TxDOT has reviewed. Plans have been signed and sealed. Revisions to the plans required, and consultant to make those revisions.

• ROW: There are 124 parcels to acquire. There are: 1 parcel in appraisal, 1 parcel in negotiations, 25 parcels in ED, and 97 parcels in possession. ROW acquisition efforts continue to be on hold due to District budgetary constraints.

• Utilities: TxDOT is in the process of verifying utility conflicts.

Construction Completion: *

CSJ: 1092-01-026

FM 741 Breakout

Limits: from US 175 to Spring Creek Blvd

Project Description: Widen and reconstruct from a 2-lane rural undivided to a 4/6-lane urban divided

Estimated Constr. Cost: $10,000,000

Construction Funding: $10,000,000 CAT 7: -021

Commissioner: Tommy Moore, Precinct 4

Engineer & Key Contact: HNTB, Kyle Riley

TxDOT Project Manager: Solomon Robelie

Schematic Approval: July 20, 2022

Environmental Clearance: March 28, 2023

ROW Acquisition Complete: December 2025

Utility Relocations Complete: December 2026

100% Plans: June 2026

Ready to Let Date: December 2026

Let Date: *

Construction Completion: *

Current Activity:

• PS&E: HNTB submitted the 100% plan set. Plans have been signed and sealed. Revisions to the plans required, and consultant is making those revisions.

• Utilities: Utilities found to be not in conflict: NTMWD, City of Mesquite, and Oncor. Status of utilities in conflict is below.

o AT&T: Pending relocations.

o Atmos: Pending relocations.

o Optimum: Design is complete. Awaiting pole relocations.

o TVEC: Gathering easements and working on relocation plans.

o Zayo: Working on conflict analysis; working on preliminary design.

CSJ: *

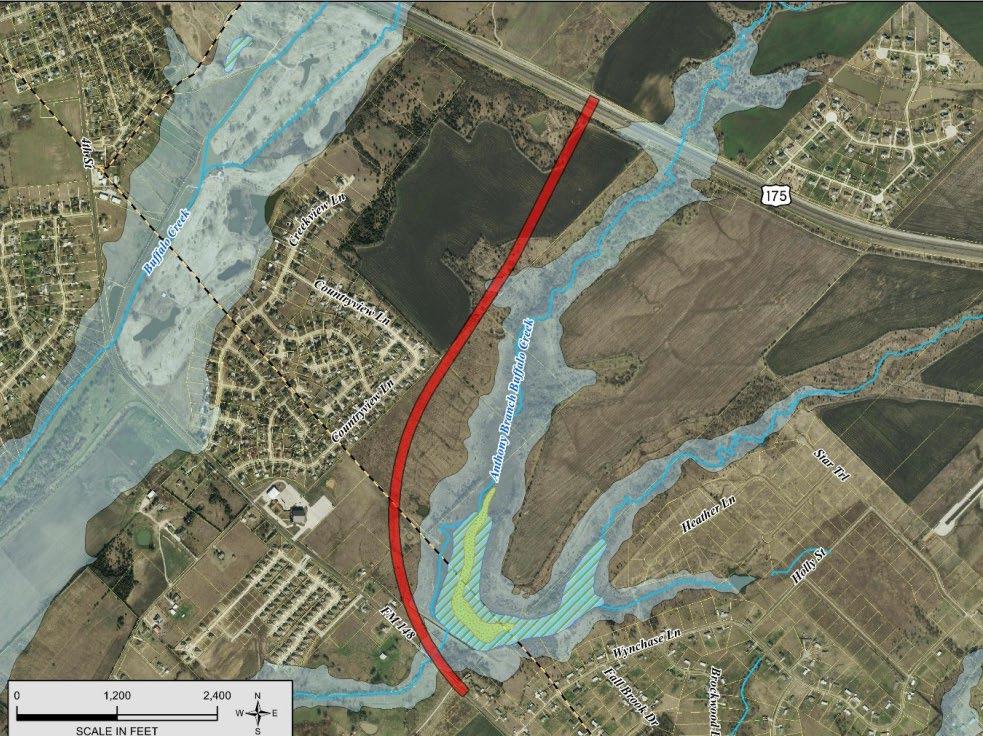

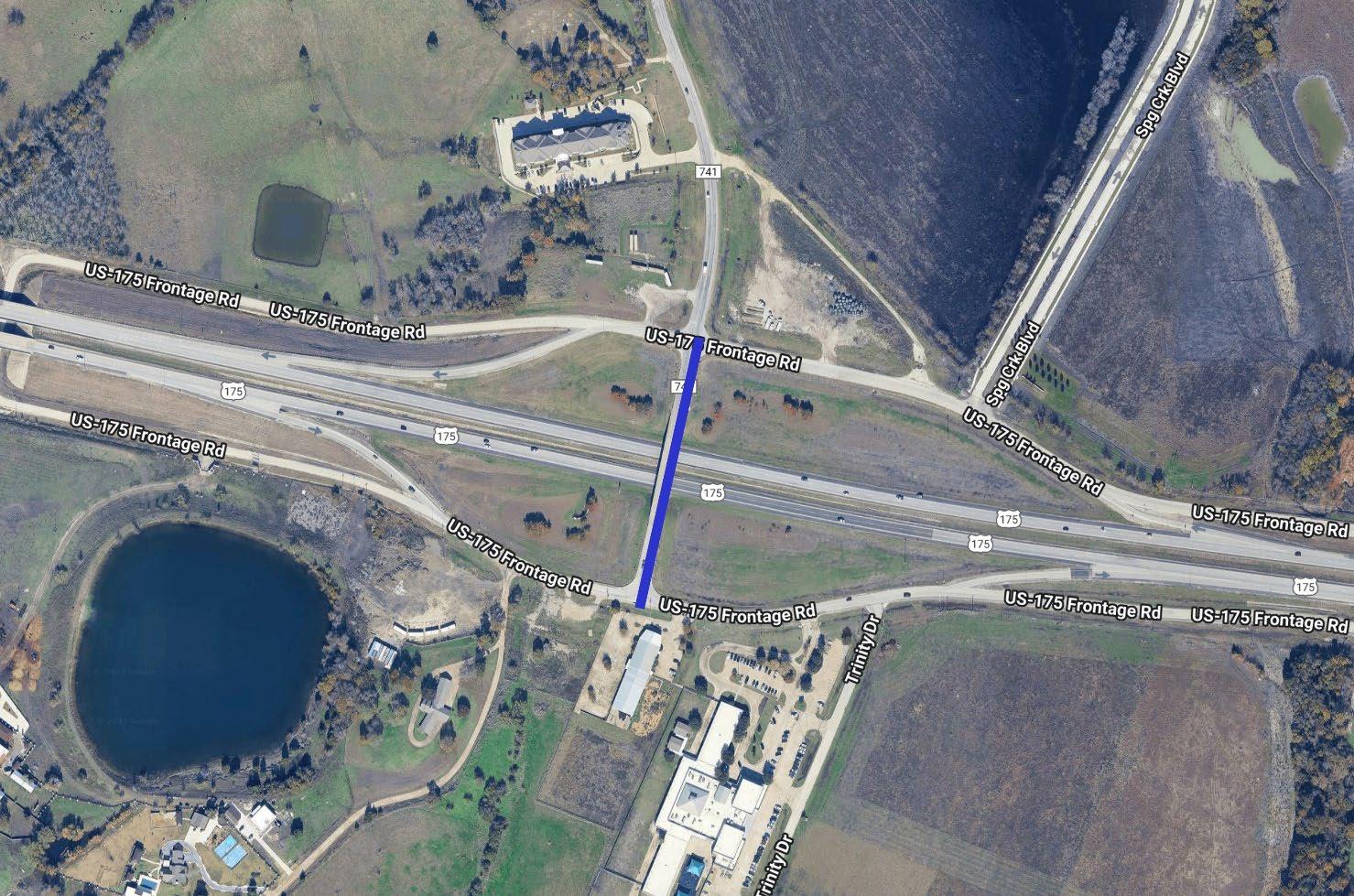

FM 741 at US 175

Limits: FM 741 at US 175 bridge

Project Description: *

Estimated Construction Cost: *

Construction Funding: $0

Commissioner: Tommy Moore, Precinct 4

Schematic Approval: *

Environmental Clearance: *

ROW Acquisition Complete: *

Utility Relocations Complete: *

100% Plans: *

Ready to Let Date: *

Engineer & Key Contact: HDR, Greg Kochersperger Let Date: *

TxDOT Project Manager: * Construction Start: *

Current Activity:

• PS&E: The county advertised a Request for Qualifications for the PS&E and environmental for the project. The evaluation committee recommended HDR as the most qualified firm, and the Kaufman County Commissioners Court approved HDR on September 30, 2025. ITS has completed negotiations with HDR for a Professional Services Agreement. Anticipate consideration of agreement at an upcoming commissioners court.

CSJ: *

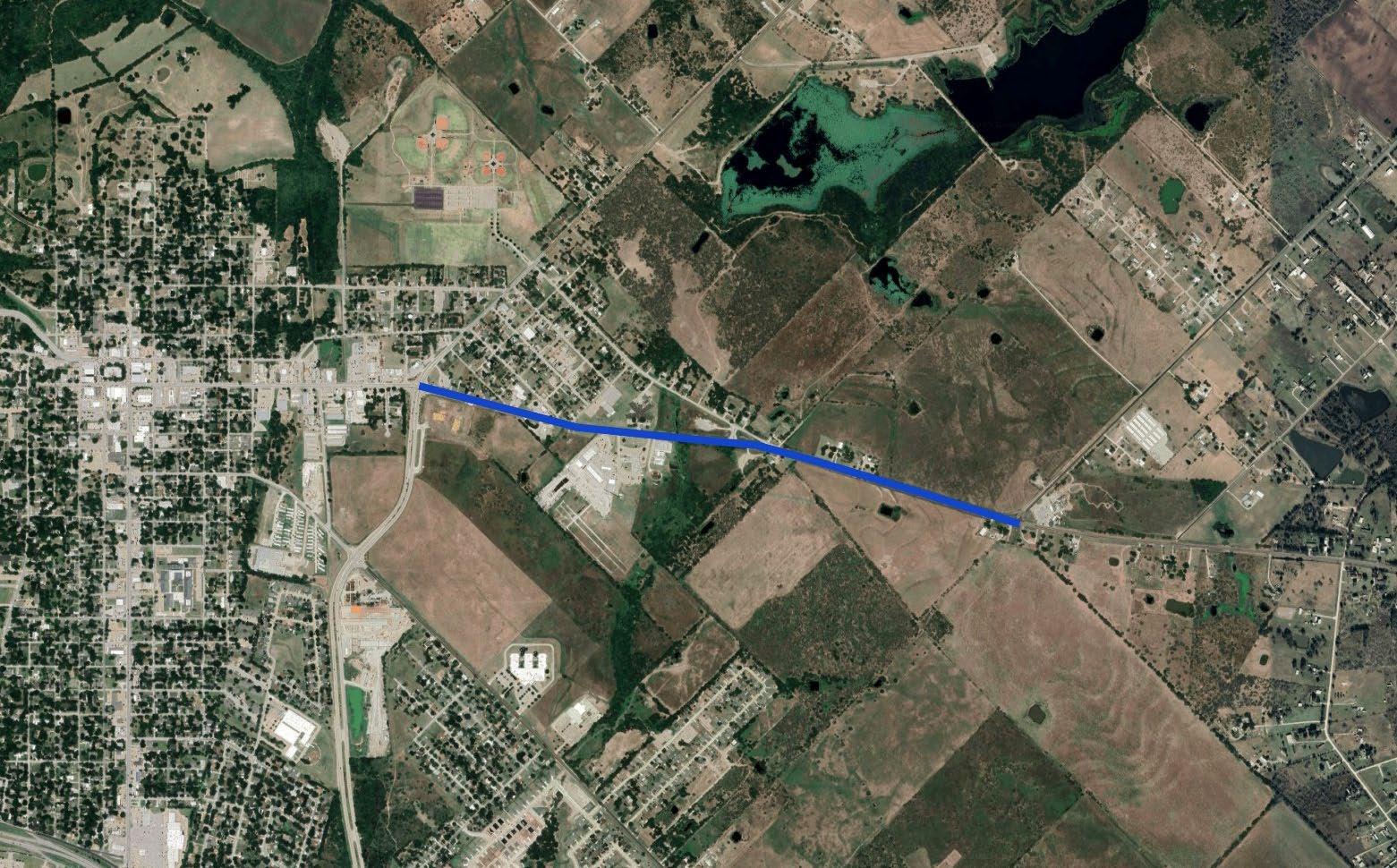

Limits: from IH 20 to US 80

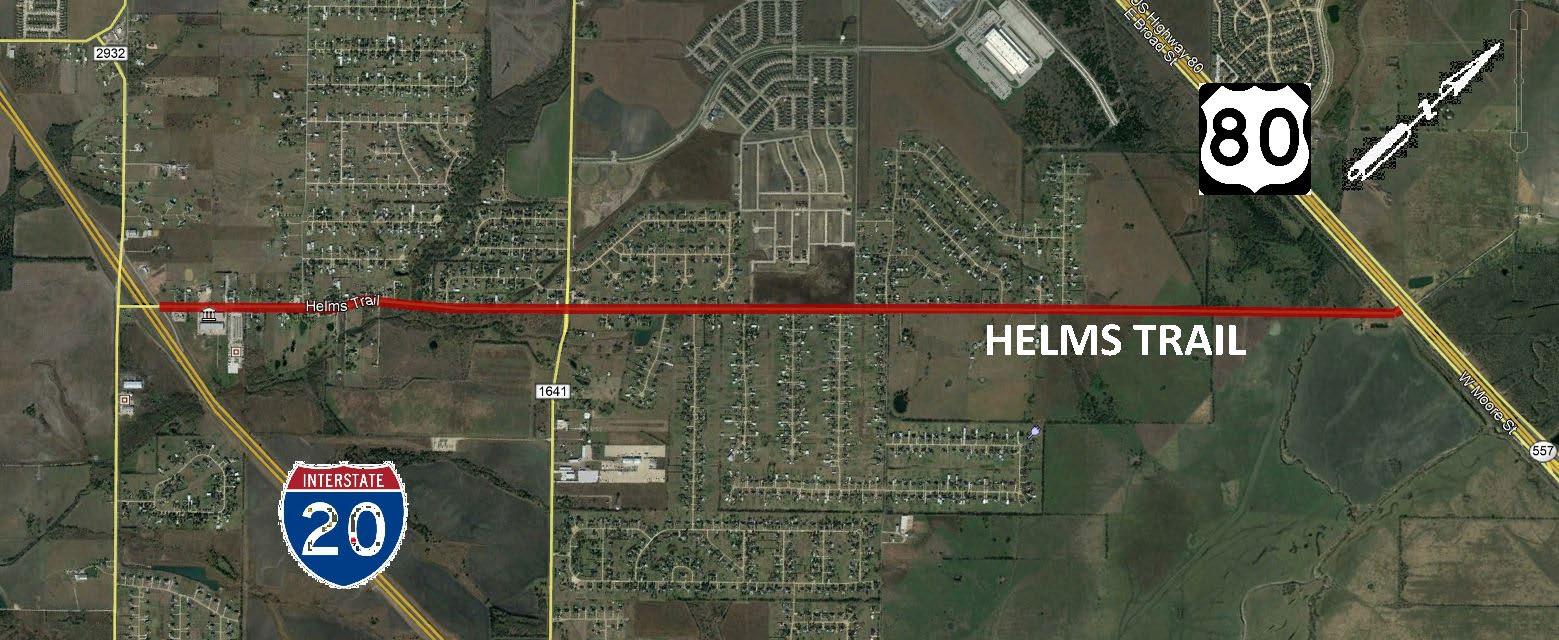

Helms Trail

Schematic Approval: March 2026

Environmental Clearance: September 2026

Project Description: widen from 2-lane rural to 4-lane divided urban

Construction

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: Gannett Fleming, Donald Stephanik

Current Activity:

• Design: Gannett Fleming revised vertical alignment, finalized both horizontal and vertical alignments, submitted layouts for internal QAQC, and began work to update ASED.

• Gannett Fleming continued refining horizontal and vertical alignments, developing cross sections for the corridor, and verifying street and driveway connections.

• Final schematic submitted for review on November 11, 2025.

• Monthly coordination meetings continue.

• SUE: Preliminary SUE efforts are complete.

• Environmental: Antiquities permit application was submitted on July 28, 2025, to the Texas Historical Commission.

• Environmental efforts paused pending alignment resolution.

CSJ:

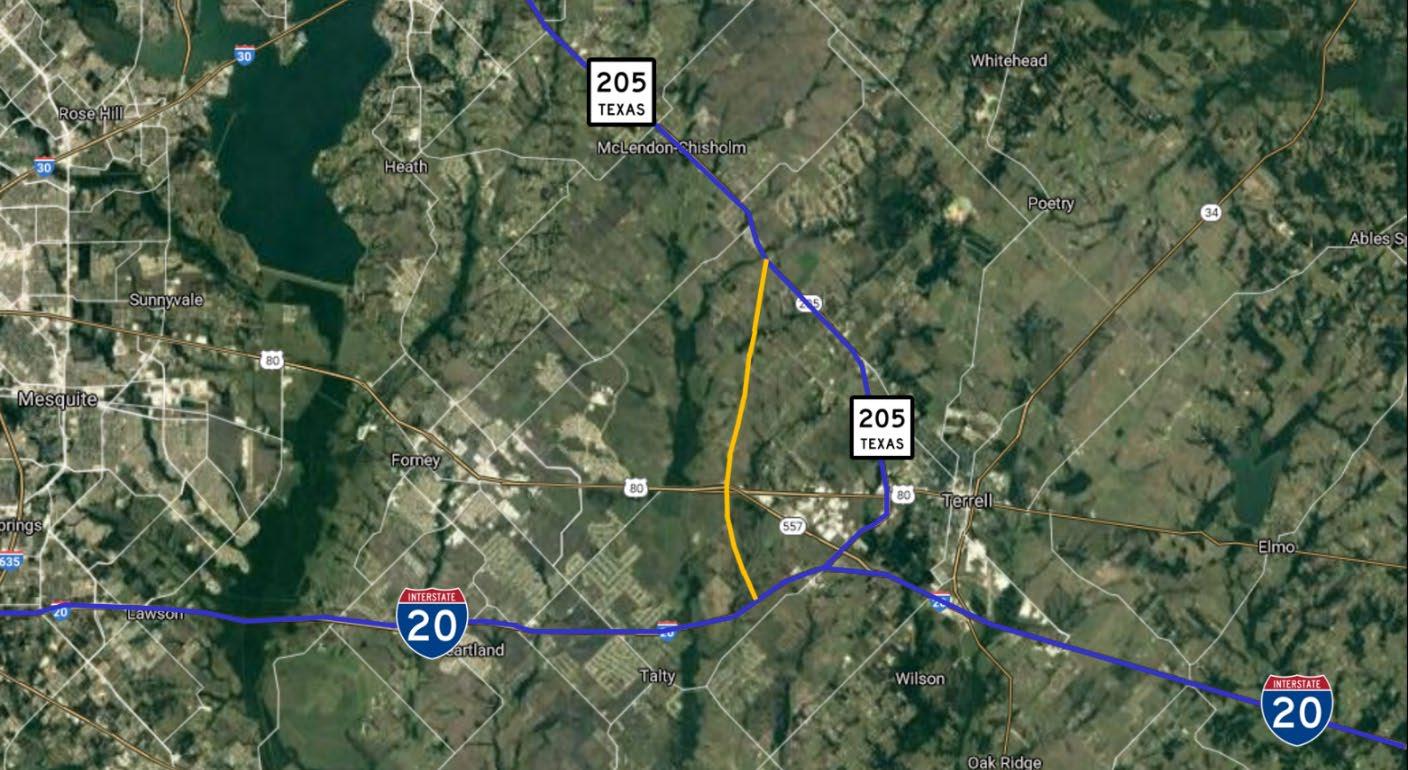

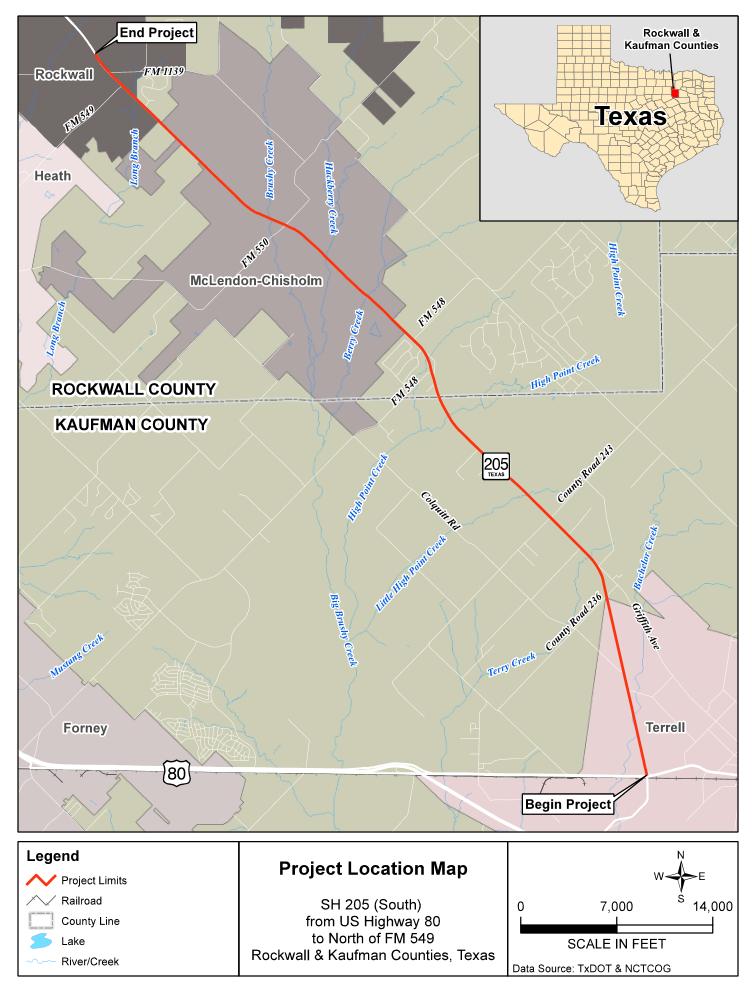

SH 205 South

0451-02-028 (Kaufman County) 0451-01-053 (Rockwall County)

Limits: From US 80 to north of FM 549

Project Description:

Estimated construction cost:

Construction Funding:

Widen from 2-lane rural to 4-lane urban divided with allowance for ultimate 6 lanes

$256,338,828 -028: $125,642,776 -053: $132,731,313

$258,374,089

$50,461,877: CAT 2

$201,139,432: CAT 4

$6,772,780: CAT 5

Schematic Approval: July 3, 2018 (-028) May 1, 2019 (-053)

Environmental Approval: Environmental Re-eval: April 12, 2019 December 22, 2021

ROW Acquisition Completed: July 2023

Utility Relocations Complete: 028: June 2027

053: January 2027

100% Plans: August 2024

Engineer: TxDOT Ready to Let Date: 028: June 2027 053: January 2027

TxDOT Contact: Suja Mathew Let Date: *

Current Activity:

• PS&E: TxDOT completed the 100% PS&E plan set, including the updates to the 2024 TxDOT Specifications, for the CSJ -028 (Kaufman County) segment.

• TxDOT completed the 100% PS&E plan set including the updates to the 2024 TxDOT Specifications, for the CSJ -053 (Rockwall County) segment

• Utilities: Utilities that are clear of construction: Atmos, Dallas Water Utilities, NTMWD, and Sprint.

• Status of -028 utilities in conflict:

o AT&T: Wreck-out of old facilities in process.

o FEC: Pending FAA permit. Relocations underway in one section

o High Point WSC: Pending relocations

o Oncor: Relocations underway.

o Optimum: Relocations underway.

o Terrell: Pending start of relocations.

o Zayo: Plans approved. Pending relocations.

I-20 Frontage Roads – Terrell

Current Activity:

• PS&E: LTRA completed and submitted the final plan set.

• Utilities: Utility coordination meetings are underway. Status of utilities in conflict below:

o AT&T: Plans approved. Pending relocations.

o Atmos: Pending relocations.

o Oncor: Working to prepare relocations plans.

o Oneok: Determined to be not in conflict.

o Optimum: Pending relocations.

o Rose Hill SUD: Consultant reviewing TxDOT plans and conflict matrix.

o City of Terrell: Reviewing TxDOT plans and conflict matrix.

o TVEC: Consultant sent preliminary plans to TxDOT.

o Zayo: Reviewing TxDOT plans and conflict matrix.

TxDOT Project Manager: Marlena Kelly

I-20 Frontage Roads – Kaufman

CSJ: 0095-14-036

Schematic Approval: January 31, 2019

Limits: From west of FM 741 to Big Brushy Creek Environmental Approval: April 10, 2020

Project Description: Add

Current Activity:

• PS&E: EST is working toward completion of the 95% plan set

• The final plans submittal date was changed to ensure IAJR conformity with PS&E.

• Utilities: Utilities that are clear of construction: OneOK. Status of utilities in conflict below:

o AT&T: Plans approved. Pending relocations.

o Enterprise: Pending relocations.

o NTMWD: Determined not to be in conflict.

o Oncor: Determined not to be in conflict.

o Rose Hill SUD: Reviewing TxDOT plans and conflict matrix.

o TVEC: Working on relocation plans.

TxDOT Project Manager: Gutema Gebriel

CSJ:

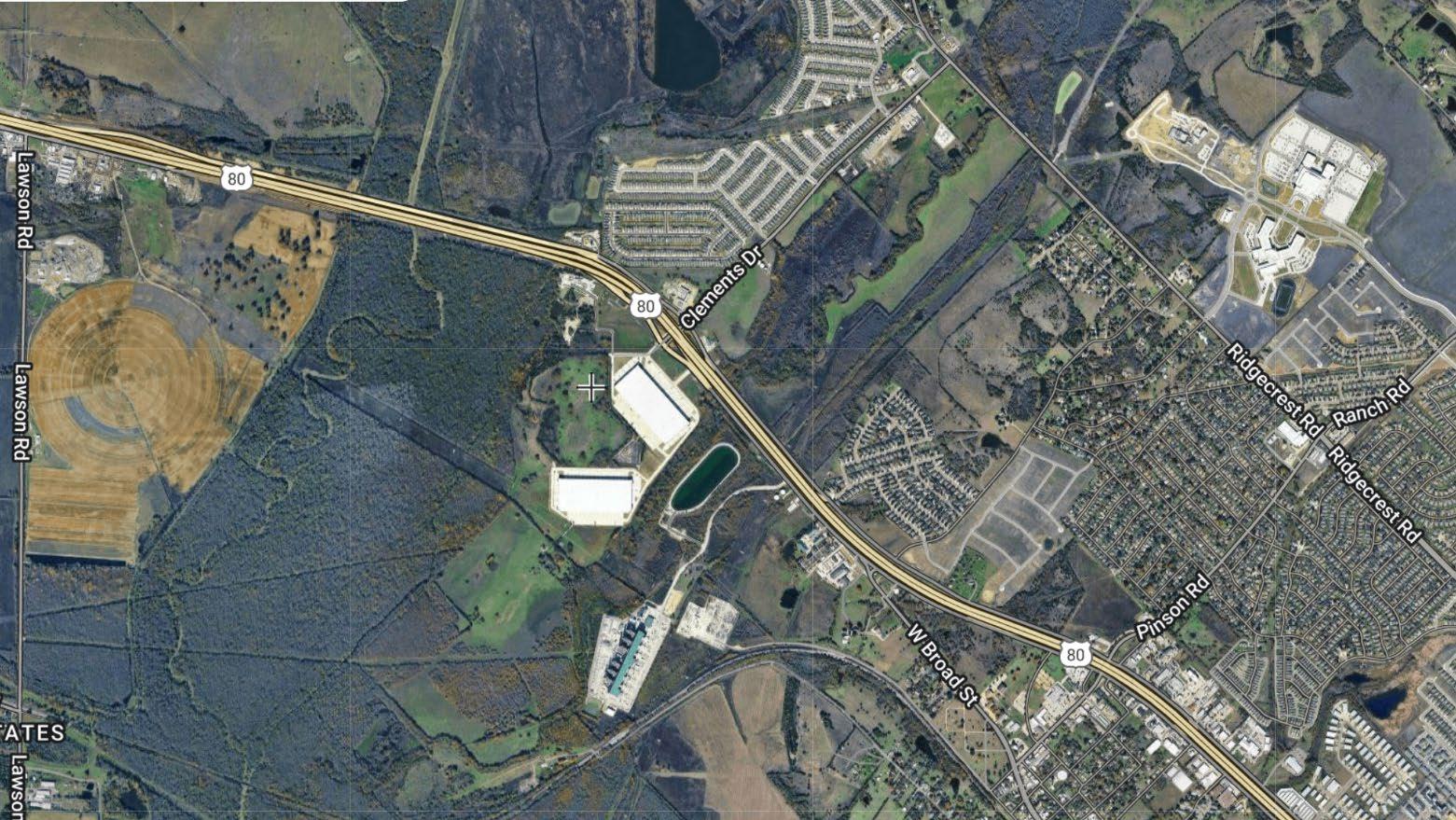

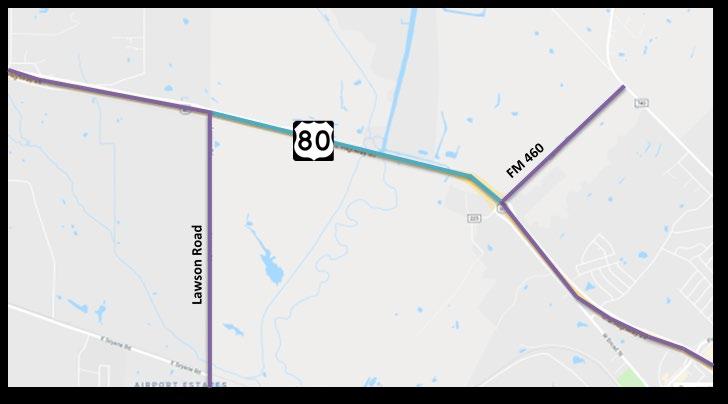

US 80 Widening

0095-03-080; -085

Limits: From Lawson Road to FM 460

Project Description:

Estimated Construction Cost:

Construction Funding:

Reconstruct and widen from 4 to 6 main lanes and reconstruct 2/4-lane discontinuous to 4/6-lane continuous frontage roads

$128,902,801

$146,274,571

$139,443,588: CAT 4; $1,882,263: CAT 6

$3,944,904: CAT 10; $1,003,816: CAT 11

Engineer & Key Contact: Halff Associates, Jeremy McGahan

TxDOT Project Manager: Lane Selman

Schematic Approval: August 24, 2018

Environmental Approval: April 13, 2020

ROW Acquisition Completed: February 2022

Utility Relocations Complete: June 2023

100% Plans: March 2022

Let Date: June 29, 2022

Construction Completion: September 2026

Current Activity:

• Construction: The project let on June 29, 2022. The project was awarded to Webber, LLC, with a low bid of $128,902,801.08, at 7.40% above engineer’s estimate. There are 42 months of barricades and 1,086 working days. See attached TxDOT construction report.

TxDOT Monthly Project Report for Kaufman County

Date of report: November 20, 2025

Report prepared by: Cody Jolley

Control: 0095-03-080 Limits Lawson Road to FM 460

Project: F 2022(793)

Highway: US 80

Contractor: Webber, LLC

TxDOT Project Manager: Chris Bruner

Contractor’s Superintendent: Robert Cox

Contractor’s Superintendent: Javier Zubillaga

Date Work Began: April 4, 2023

Anticipated Completion Date: September 30, 2026

Phone: (972) 962-3617

Phone: (214) 406-9600

Phone: (346) 224-6877

Current activities: Embankment. Flexbase. Lime. Westbound main lane bridge construction. Installing drainage. Concrete sidewalks (FM 460). Removal of existing asphalt.

Narrative description of last month’s activities: Ditch grade. Embankment. Flexbase. Lime. Westbound main lane bridge construction. Installing drainage.

Narrative description of activities planned for next month: Asphalt paving. Embankment. Flexbase. Lime. Westbound main lane bridge construction. Installing drainage. Overhead sign structures.

Traffic issues: None

Plans for changes in traffic patterns: None

Item(s) of work currently controlling project completion: None

Other items of significance: None

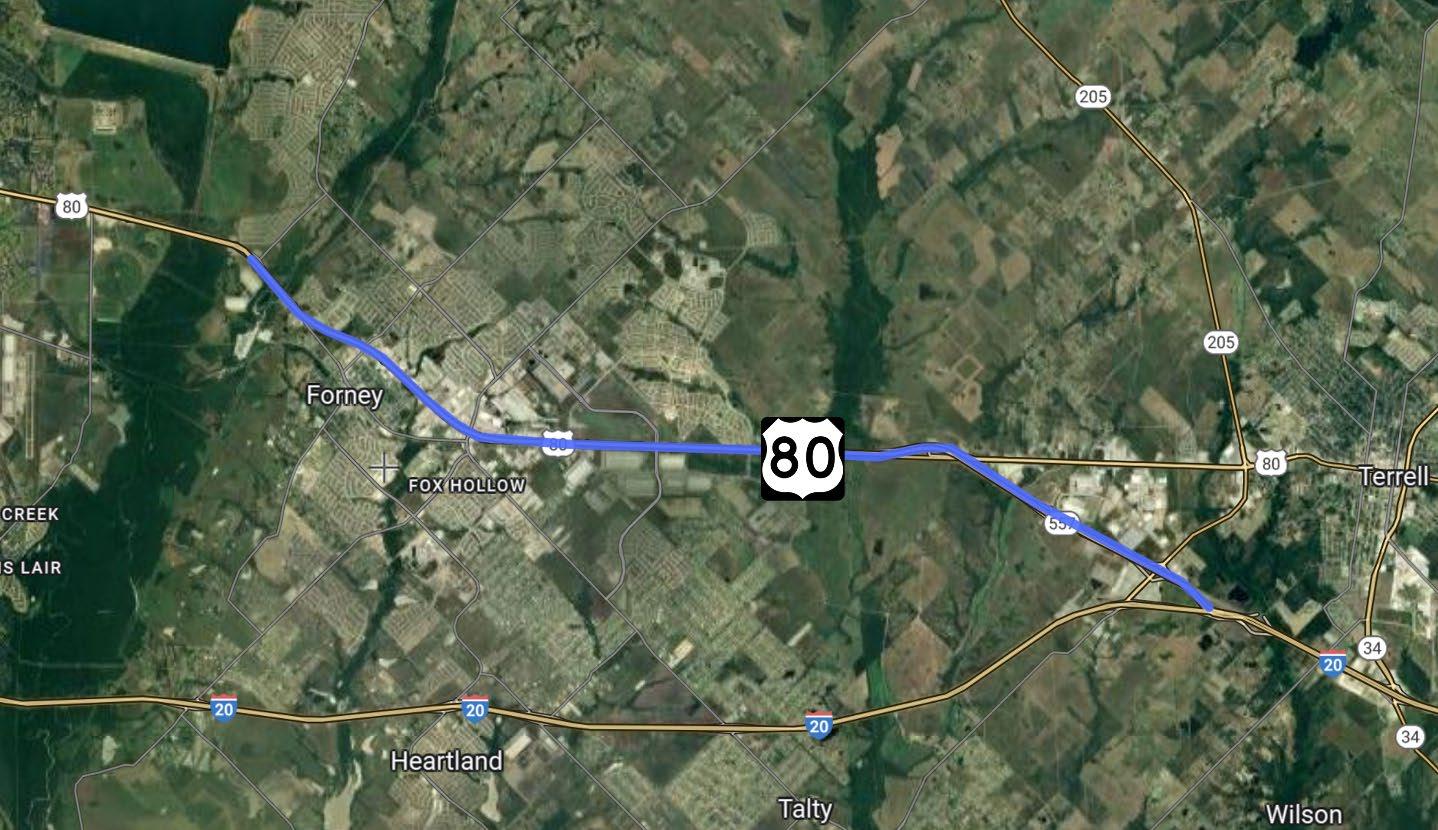

US 80/Spur 557 (FM 460 to IH 20)

CSJ: 0095-03-106; 0095-04-076; 0495-01-081

Limits: From FM 460 to IH 20

Project Description: Widen and add lanes

Schematic Approval: December 2023

Environmental Approval: April 3, 2024

ROW Acquisition Complete: March 2031

Estimated Construction Cost: $1,407,562,206 Utility Relocations Complete: June 2034

Construction

Engineer & Key Contact: *

Current Activity:

• Environmental: A public hearing was held on February 8, 2024, in Forney. Finding of No Significant Impact (FONSI) was issued on April 3, 2024.

• PS&E: Awaiting TxDOT determination of priorities and next steps to advance project to PS&E phase.

• IAJR: TxDOT is working to complete the IAJR review.

CSJ: 0918-11-109

Outer Loop

Limits: From SH 205 to FM 148

Schematic Approval: January 2026

Environmental Approval: March 2026

Project Description: 4-lane freeway with continuous 4- to 6-lane frontage roads ROW Acquisition Complete:

Estimated Construction Cost: $1,216,372,326

Construction Funding: $0

Engineer & Key Contact: HDR, Brian Swindell

TxDOT Project Manager: Liang Ding

Current Activity:

• Design: HDR continues coordination with project stakeholders. HDR also continues coordination with TxDOT, Halff Associates (Rockwall County Outer Loop project), NCTCOG, and ITS.

• HDR made 90% schematic resubmittal on November 17, 2025.

• HDR is working toward completion of the final schematic and anticipates submittal in December 2025.

• Draft IAJR documentation underway. M&A memo was updated and resubmitted per TxDOT comments.

• Ongoing UPRR coordination.

• Bi-weekly coordination meetings underway.

• Environmental: TxDOT has approved this project for an EA in lieu of an EIS. Efforts on the environmental technical reports continue. Draft EA was approved on November 6, 2025. Nine environmental technical reports have been approved to date; four reports are in progress. Public Hearing is expected to be held in the early part of 2026.

• ROW: ROW footprint approved on September 29, 2025.

• Utilities: Preliminary utility coordination meeting held on March 27, 2025.

• Other: Project website is available at: https://kaufmanouterloop.com.

FM 740

CSJ: 2249-01-009; 1091-01-023

Schematic Approval: December 2025

Limits: from Kaufman/Rockwall County Line to Ranch Road Environmental Approval: June 2026

Project Description:

reconstruct FM 460 and FM 740 to 4lane (6-lane ultimate) divided urban roadways

Estimated Construction Cost: $130,503,143

Construction Funding: $0

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: Atkins, Thomas Le

Current Activity:

• Design: Atkins submitted the final schematic to TxDOT on September 29, 2025. Atkins continues to respond to TxDOT on requests for revisions and updates.

• Coordination meetings with Atkins, TxDOT, and ITS are ongoing.

• Final drainage deliverables submitted on October 10, 2025.

• Revised traffic report under review by TxDOT.

• Second public meeting was held on June 12, 2025. Atkins prepared public meeting summary report and posted to KeepItMovingDallas.

• ROW: ROW footprint was approved on May 16, 2025.

• Environmental: TxDOT approved reclassification to CE from EA; this reclassification will save efforts and resources. Atkins continues efforts on environmental technical reports. Five reports have been approved to date.

• Utilities: Atkins developing Utility Conflict Matrix.

US 175 Grade Separations – Kemp

CSJ: 0197-05-063

Limits: from Business US 175 to FM 1895

Project Description: construct grade separations of US 175 over BUS 175 and FM 1895

Estimated Construction Cost: $94,294,483

Construction Funding: $0

Commissioner: Tommy Moore, Precinct 4

Schematic Approval: November 2023

Environmental Approval: November 26, 2024

ROW Acquisition Complete: NA

Utility Relocations Complete: *

100% Plans: September 2027

Ready to Let Date: *

Engineer & Key Contact: Halff, Melanie Cleavelin Let Date: *

TxDOT Project Manager: Marlena Kelly

Current Activity:

• PS&E: Halff continues preparing for preliminary bridge layout review in November 2025.

• Halff Associates continues efforts on the 30% PS&E plan set, expected in January 2026

• Halff is working on supplemental survey; anticipate completion by the end of November, depending on weather.

• Halff completed pavement borings, cores, and sign borings.

CSJ:

US 175 Safety Improvements – Kaufman

0197-04-086; 0196-04-087

Limits: from 0.5 miles south of SH 34 to Fair Road

Project Description: relocate existing crossovers, construct U-turns and deceleration lanes

Estimated Construction Cost: $8,911,637

Construction Funding:

$8,773,402

$2,788,596: CAT 8

$5,984,806: CAT 11

Schematic Approval: NA

Environmental Approval: December 2023

ROW Acquisition Complete: NA

Utility Relocations Complete: NA

Final Plans: May 2024

Commissioner: Terry Crow, Precinct 1 Ready to Let Date: August 2024

Engineer & Key Contact: Quiddity, David Unger

TxDOT Project Manager: Lane Selman

Current Activity:

• Construction: Project let for construction on August 2, 2024. The project was awarded to Granite Construction Company, with a low bid of $12,103,561.02, at 0.92% below engineer’s estimate. There are 150 working days and 10 months of barricades. Construction began on December 4, 2024. See attached TxDOT construction report.

Construction Completion: February 2026

TxDOT Monthly Project Report for Kaufman County

Date of report: November 20, 2025

Report prepared by: Cody Jolley

Control: 0197-04-086

Project: F 2B24 (336), ETC.

Limits: US 175 – west of SH 34 to south of FM 153

Highway: US 175

Contractor: Granite Construction Company

TxDOT Project Manager: Jason Hyde

Contractor’s Superintendent: Ben Simpson

Date Work Began: December 4, 2024

Anticipated Completion Date: February 2026

Current activities: Backfill. Striping. Sign installation.

Phone: (972) 962-3617

Phone: (214) 254-6503

Narrative description of last month’s activities: Excavation. Subgrade treatment. Flexbase. Drainage.

Narrative description of activities planned for next month: Sign installation. Striping. Project punch list.

Traffic issues: None

Plans for changes in traffic patterns: None

Item(s) of work currently controlling project completion: None

Other items of significance: None

US 175 Feasibility Study

CSJ/Project ID: A00190822

Limits:

Project Description:

Estimated Construction Cost:

From west of FM 1389 (Kaufman County line) to east of SH 198 (Henderson County line)

Feasibility study to investigate capacity improvements including main lanes expansion and addition of continuous frontage roads and new interchanges

Engineer & Key Contact: BGE, Hossein Hosseiny

Schematic Approval: *

Environmental Approval: *

ROW Acquisition Complete:

Current Activity:

• Design: BGE continued developing design with an urban typical section throughout the county to minimize ROW impacts.

• BGE is preparing and analyzing an urban section for the corridor and comparing impacts.

• BGE updated presentation to outline design concepts and impacts. BGE met with TxDOT on February 10, 2025, to present findings. TxDOT notified BGE to pause efforts effective February 11, 2025.

CSJ:

Limits:

FM 148

0751-01-053

From US 175 to Country Woods Road (CR 261)

Project Description: *

Construction Cost: *

Construction Funding: $0

Commissioner: Terry Crow, Precinct 1

Engineer & Key Contact: Westwood, Mark Zoellner

TxDOT Project Manager: Tamanna Ali

Schematic Approval: *

Environmental Approval: *

ROW Acquisition Complete: *

Utility Relocations Complete: *

100% Plans: *

Let Date: *

Construction Start: *

Construction Completion: *

Current Activity:

• Design: Westwood developed alignment alternatives per TxDOT request and submitted to TxDOT for review and comment. Westwood is compiling information required for Design Concept Conference meeting, as well as a preliminary ASED. Design Concept Conference was held on August 6, 2025. Additional discussion regarding potential for a new FM 148 at location of the new underpass required. Design work on hold until decision regarding alignment TxDOT would like to pursue is made. Additional meetings between City of Crandall, TxDOT, Westwood, and ITS held to determine extent of scope, limits, and which alignment will be studied. Most recent meeting was held on October 8, 2025, at the TxDOT Dallas District Office. Decision regarding project direction pending. Anticipate meeting to be held on December 1, 2025, to discuss direction.

• Survey: Aerial flight is complete and is being processed. Approximately 85% of the field work has been completed.

CSJ:

Limits:

0095-03-100

From FM 460 to east of Buffalo Creek bridges

Project Description: Widen and replace eight bridges

Construction Estimate:

Construction Funding:

$98,459,060

$98,459,060

CAT 4: $62,080,189

CAT 5: $978,871

CAT 6: $35,400,000

Commissioner: Skeet Phillips, Precinct 2

Engineer & Key Contact: TxDOT, Morgan Neill

TxDOT Project Manager: Amir Shammet

Schematic Approval: *

Environmental Approval: August 30, 2023

ROW Acquisition Complete: NA

Utility Relocations Complete: January 2025

100% Plans: January 2025

Let Date: September 2026

Construction Start: *

Construction Completion: *

Current Activity:

• Design: Plans are complete and shelved until letting.

• Construction: Anticipate letting in September 2026.

CSJ/Project ID: 0443-02-023

Limits: From US 175 to FM 3080

SH 198

Schematic Approval: *

Environmental Approval: April 10, 2024

Project Description: Widen roadway to add 2-way left-turn lane ROW Acquisition Complete: NA

Construction Cost: $5,180,451

Construction Funding: $4,926,222

Engineer & Key Contact: Jacobs, Abe Bekele

TxDOT Project Manager: Falon Renfroe

Utility Relocations Complete: NA

100% Plans: July 2025

Let Date: August 7, 2025

Construction Start: November 2025

Current Activity:

• Design: Plans are complete and shelved until letting.

• Construction: Project let for construction on August 7, 2025. The was awarded to A.L. Helmcamp, Inc. with a low bid of $5,180,451, at 5.4% above the engineer’s estimate. Pre-construction meeting was held on November 4, 2025. Contractor is mobilizing and preparing ROW.

SH 243 Safety Improvements

CSJ/Project ID: 0522-01-026

Limits: From SH 34 to FM 2727

Schematic Approval: *

Environmental Approval: April 10, 2024

Project Description: Add continuous left-tun lane on SH 243 ROW Acquisition Complete: NA

Construction Cost: $3,537,961

Construction Funding: *

Utility Relocations Complete: NA

100% Plans: June 2025

Engineer & Key Contact: Jacobs, Abe Bekele Let Date: August 8, 2025

Current Activity:

• Design: Plans are complete.

• Construction: Project let for construction on August 8, 2025 Project was awarded to A.L. Helmcamp with a low bid of $3,537,961 at 2.5% under the engineer’s estimate. Pre-construction meeting was held on November 4, 2025. Anticipate start of construction in December 2025.

Glossary of Acronyms

• AADT – Annual Average Daily Traffic

• AFA – Advanced Funding Agreement

• ARPA – Archeological Resources Protection Act

• ASED – Annual Scope & Estimate Documentation

• CE – Categorical Exclusion (environmental clearance process for projects that do not involve significant environmental impacts)

• CLOMR – (FEMA’s) Conditional Letter of Map Revision

• Conformity – Federal requirement in nonattainment areas to conduct air quality analysis on projects, programs, and policies identified in transportation plans, transportation improvement programs, federally funded projects, or projects requiring federal approval

• CSJ – (TxDOT’s) Control Section Job Number

• EA – Environmental Assessment

• ED – Eminent Domain

• EIS – Environmental Impact Statement

• EPIC – Environmental Permits, Issues, and Commitments

• FONSI – Finding of No Significant Impact

• IAJR – Interstate Access Justification Request

• ICA – Interlocal Cooperative Agreement

• IFP – Initial Financial Plan

• MAPO – Meeting with Affected Property Owners

• MPO – Metropolitan Planning Organization

• MTP – Metropolitan Transportation Plan

• NCTCOG – North Central Texas Council of Governments

• NEPA – National Environmental Policy Act

• NOPC – Notice of Proposed Construction

• NORA – Notice of Required Accommodation

• NTTA – North Texas Toll Authority

• PBLR – Preliminary Bridge Layout Review

• PS&E – Plans Specifications and Estimate

• PUA – Possession and Use Agreement

• ROW – Right-of-Way

• RTC – Regional Transportation Council

• RTL – Read to Let (date project is clear for construction but lacks funding for actual let)

• RTR – Regional Toll Revenue (funds resulting from certain toll/managed lane projects in DFW region)

• RULIS – Right-of-Way, Utilities, Leasing, and Information System

• STBG – Surface Transportation Block Grant

• STIP – Statewide Transportation Improvement Program

• SUE – Subsurface Utility Engineering

• SW3P – Storm Water Pollution Prevention Plan

• TIA – Time Impact Analysis

• TPP – Transportation Planning and Programming

• TPWD – Texas Parks & Wildlife Department

• TTC – Texas Transportation Commission

• TxDOT – Texas Department of Transportation

• UTP – Unified Transportation Program

• VE – Value Engineering

TxDOT Funding Categories

• CAT 1: Preventive Maintenance and Rehabilitation

• CAT 2: Metropolitan and Urban Area Corridor Projects / NCTCOG

• CAT 3: Non-Traditionally Funded Transportation Projects

• CAT 4: Statewide Connectivity Corridor Projects

• CAT 5: Congestion Mitigation and Air Quality Improvement / NCTCOG

• CAT 6: Structures Replacement and Rehabilitation (Bridge)

• CAT 7: Metropolitan Mobility and Rehabilitation / NCTCOG

• CAT 8: Safety Projects

• CAT 9: Transportation Alternatives

• CAT 10: Supplemental Transportation Projects

• CAT 11: District Discretionary

• CAT 12: Strategic Priority

Turn static files into dynamic content formats.

Create a flipbook
