City Manager's Quarterly Report (November 7, 2025)
City Manager’s Weekly Report
To: Mayor and City Council
From: Robert Ranc, City Manager
NOVEMBER 7, 2025
UPCOMING EVENTS
November 7: Friday Night Market (6:00 - 9:00 PM, Downtown Square)
November 8: Life Connected. Service Day (8:00 AM - 1:00 PM, Downtown Square)
November 11: PD Ruck March (8:30 AM, Old Celina Park)
November 11: City Council Meeting (5:00 PM, Council Chambers)
November 15: Troubadour Festival (12:00 - 11:00 PM, Old Celina Park)
November 19: Fire Station #4 Groundbreaking Ceremony (10:00 AM, TBD)
November 22: Fire Station #1 Open House (10:00 AM - 1:00 PM, Fire Station #1)
November 26: Coffee with the Contractors (9:00 AM, 112 N. Arizona Dr)
November 27: Celina Turkey Trot (7:45 AM, Downtown Square)
November 27: Thanksgiving (Administrative Offices Closed)
CITY UPDATES
CITY CELEBRATES RESIDENT VETERANS WITH DOWNTOWN DISPLAY
The City has created a special display of Veterans Day Banners to honor the resident heroes who have proudly served in our nation’s armed forces. These banners are prominently featured throughout the Downtown area, transforming the Square into a tribute to those who have dedicated their lives to protecting our freedom.
We invite everyone to take a few moments to stroll through Downtown and view the banners, each representing a local veteran whose service and sacrifice have helped shape our community. This initiative provides a meaningful way to honor these individuals as we approach Veterans Day. The Veterans Day Banners will remain displayed through the week of Thanksgiving, after which they will be replaced with the festive décor for the Christmas on the Square celebration. This thoughtful transition reflects our community’s continued spirit of appreciation and togetherness throughout the holiday season.
DOWNTOWN SQUARE HOSTS FINAL MARKET AND LIVE MUSIC EVENT
The City will host its final Friday Night Market of the 2025 calendar year on Friday, November 7, from 6:00 to 9:00 PM on the Downtown Square. The Friday Night Market has become one of the City’s most popular community events, offering residents and visitors the opportunity to enjoy local shopping, dining, and live entertainment while supporting small businesses and artisans from across the region. We are pleased to announce that the evening will feature a special musical performance by Justin Till, closing out the season with an energetic and engaging show for all attendees.
This year has marked one of the most successful Friday Night Market seasons to date, with an increase in vendor participation and record numbers of residents and visitors gathering in Downtown Celina to experience the community’s vibrant atmosphere. The City looks forward to building on this momentum in the upcoming year.
FIVE COMMUNITY PROJECTS PLANNED FOR SERVICE DAY INITIATIVE
The City will host its Life Connected. Service Day on Saturday, November 8, from 8:00 AM to 1:00 PM. This community-wide initiative is dedicated to supporting residents in need through volunteer service and acts of kindness. This year, five individual projects have been identified, serving senior citizens and families in need through referrals from several of the City’s nonprofit partners. These projects will focus primarily on landscaping and basic exterior maintenance to help improve the safety, appearance, and comfort of participating homes.
The Celina Youth Council will also take part in this year’s Service Day, contributing their time and energy to a dedicated project in the Downtown area. Beyond the physical improvements, Life Connected. Service Day represents the heart of Celina’s community values — neighbors coming together to lend a hand, build relationships, and strengthen the bonds that make Celina a truly special place to live.
DEVELOPMENT SERVICES UPDATE FOR OCTOBER 2025
The October 2025 Development Services report highlights our ongoing commitment to community enhancement and sustainable growth. This update includes key figures reflecting our progress, showcasing the number of permits issued, new construction projects, and new businesses to the community.
Number of Home Permits: 123
Valuation: $550,747 (Monthly Average)
Square Footage: 3,713 (Monthly Average)
Construction Inspections: 6,844
SINGLE-FAMILY RESIDENTIAL PERMITS
Legacy Hills (26)
Cross Creek Meadows (14)
Cambridge Crossing (13)
Mustang Lakes (12)
The Ranch at Uptown (10)
Lily Creek at Sutton Fields (6)
Mosaic (6)
Hillside Village (3)
Sutton Fields East (6) Edgewood Creek (2)
Ten Mile Creek (6)
Chalk Hill (4)
Lilyana (4)
North Sky (4)
La Terra (2)
Light Farms (2)
Wellspring Estates (2)
Green Meadows (1)
NEW CONSTRUCTION PROJECTS
AG Celina Medtail (4635 S. Preston Rd)
Ariana West (Phase 1)
Bojangles (3615 S. Preston Rd)
Chipotle (3520 S. Preston Rd)
Creekbend (Phase 1)
Mark Alexander (Phase 1)
Pacific Dental Services (3515 S. Preston Rd #110)
Picklemans (3515 S. Preston Rd #100)
Sports Clips (3515 S. Preston Rd #120)
Ten Mile Creek Amenity Center (2001 Ten Mile Creek Ct)
Thai Basil (590 W. Frontier Pkwy #160)
Torchy’s Taco (3505 S. Preston Rd #120)
NEW BUSINESSES
CISD ES Cambridge Crossing (2120 Coventry Dr)
Eye Level Learning Center of Prosper East (560 W. Frontier Pkwy #135)
Ho2 Systems LLC (560 W. Frontier Pwky #125)
Heirloom Health (560 W. Frontier Pkwy #120)
Hope on the Horizon Counseling (540 W. Frontier Pkwy #130)
Redimix (11852 CR 53)
The Goddard School Annex (340 W. Frontier Pkwy)
VLK Celina Design Lab (225 S. Preston Rd)
COMMUNITY INVITED TO PARTICIPATE IN VETERANS DAY RUCK MARCH
The Celina Police Department will host the 3rd Annual Veterans Day Ruck March on Tuesday, November 11, at 8:30 AM at Old Celina Park. This free, community-wide event invites residents, Veterans, and supporters to walk together in honor of the men and women who have proudly served our nation. Each step taken represents gratitude and solidarity - reminding our Veterans that Celina stands with them, always.
The Ruck March continues to grow as a meaningful City tradition that reflects Celina’s deep respect and appreciation for its military community. Participants are encouraged to bring a rucksack or backpack as a symbolic gesture of the load our service members carry in defense of our freedoms.
[ CLICK HERE TO REGISTER FOR THE VETERANS DAY RUCK MARCH ]

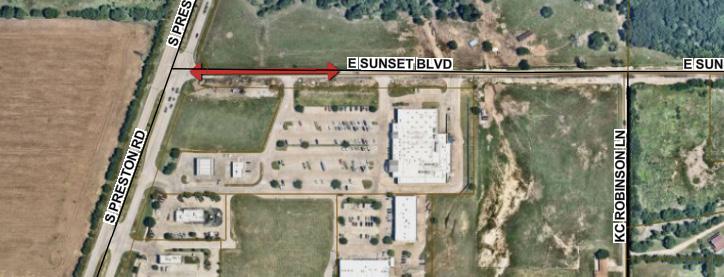

FINAL PHASE OF SUNSET BLVD PROJECT SET TO BEGIN ON NOVEMBER 10
As part of the ongoing roadway improvements on Sunset Blvd, the intersection at Preston Rd will be temporarily closed to complete the final phase of construction. This closure marks the last portion of roadway work associated with the current project.
During this period, traffic will not be permitted to access Sunset Blvd from Preston Rd. A detour route will be in place, directing motorists to Glendenning Pkwy, then to KC Robinson Ln, and onto Sunset Blvd. An additional detour option will guide drivers from FM 455 to Coit Rd, then back to Sunset Blvd.
Access to Brookshire’s and other nearby businesses will remain available from Preston Rd. The two easternmost driveways on Sunset Blvd entering Brookshire’s will stay open, while the westernmost driveway nearest Preston Rd will be temporarily closed.
SCHEDULE (Weather Permitting)
• Start Date: November 10, 2025
• Estimated End Date: December 1, 2025
TRAFFIC IMPACT
• Full intersection closure for approximately three weeks
• Contractor will actively manage traffic control and detour signage throughout the project duration
The City appreciates the public’s patience and understanding as these critical improvements are completed to enhance roadway safety and connectivity.
CITY CONTINUES INFRASTRUCTURE INVESTMENTS THROUGH ASM PROGRAM
As part of the City’s ongoing commitment to maintaining high-quality infrastructure, the Annual Street Maintenance (ASM) Program continues to address the repair and preservation of local roadways. This year’s ASM project includes concrete panel replacements in multiple areas to enhance roadway safety, functionality, and longevity.
CONCRETE PANEL REPLACEMENTS
• 2840 Saltwood Ct.
• 3000, 3004, 3202, 3203 Twin Lakes Dr.
SCHEDULE (Weather Permitting)
• Start Date: November 3, 2025
• Estimated End Date: November 24, 2025
TRAFFIC IMPACT
• Traffic will alternate through active construction areas.
• The contractor will manage traffic control throughout the project duration.
• Access to residences will remain available at all times.
Additionally, beginning Wednesday, November 5, 2025, County Road 58 will be closed in all directions from County Road 60 to Celina Parkway to allow for construction of the Rasor Interceptor (sewer line). This closure is expected to remain in effect for approximately one week, with the roadway anticipated to reopen on Wednesday, November 12, 2025.
We appreciate residents’ patience and cooperation as the City continues to invest in the improvement and preservation of Celina’s roadway network. These efforts represent an essential investment in the safety, reliability, and long-term performance of our community’s infrastructure.

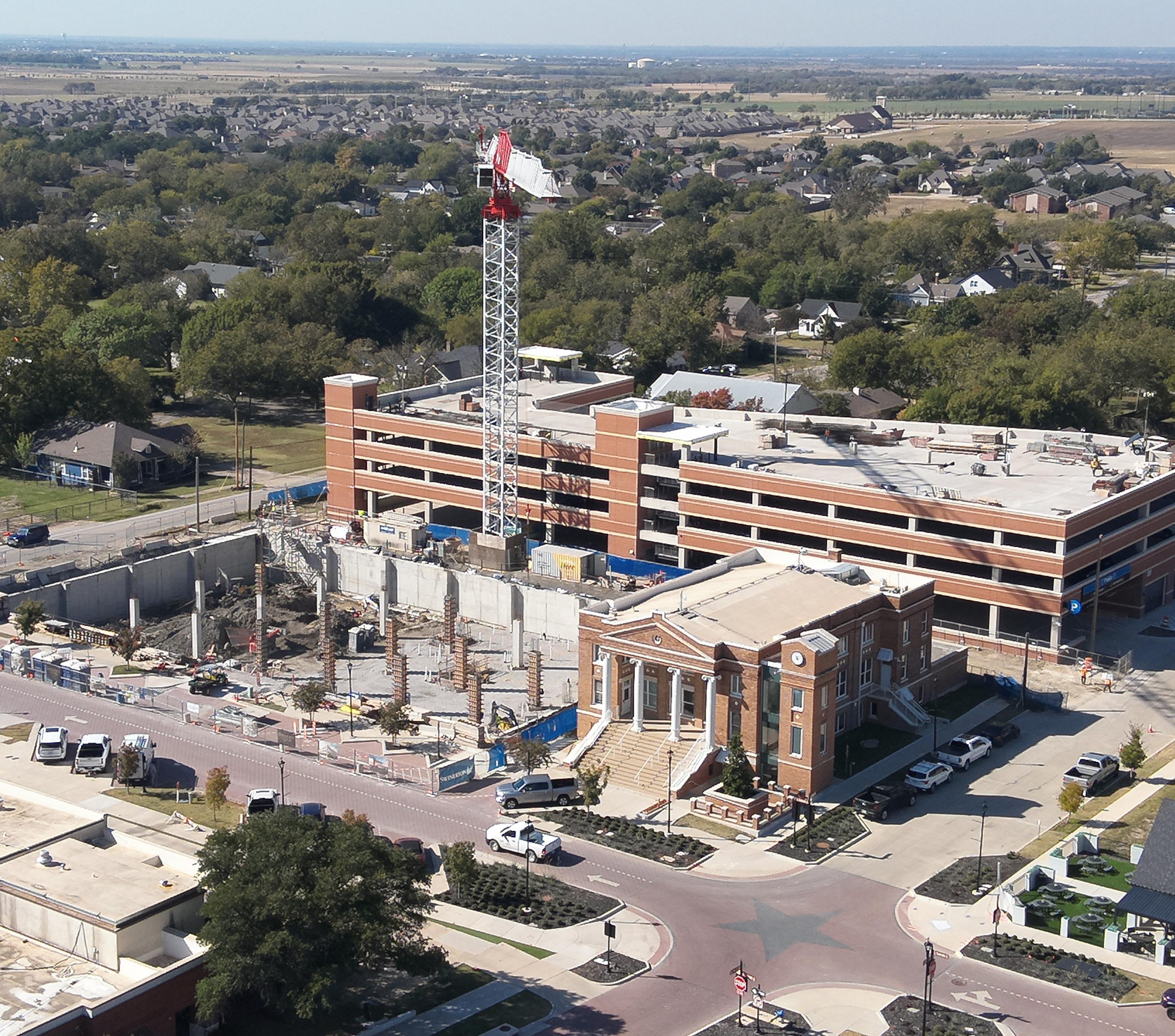

DOWNTOWN CENTER CONSTRUCTION CONTINUES TO PROGRESS
Swinerton, the City’s general contractor for the Downtown Center project, has provided an update on current construction progress. This week, crews have been actively installing underground plumbing in preparation for Slab-on-Grade (SOG) Pour 2, while also completing fine grading, vapor barrier installation, and rebar placement for SOG Pour 1. The project remains on schedule, with SOG Pour 1 anticipated for next week, marking another
important step forward in the development of this key community facility.
NEW EMPLOYEES JOIN CITY STAFF TO SUPPORT OPERATIONS
The City is pleased to announce several updates within its organization that reflect continued investment in staff development and operational excellence.The City welcomes two new employees in Adam Bilodeau and Robert Carter who bring valuable experience and skills that will further enhance the organization’s overall expertise and capacity. These additions will strengthen the City’s ability to deliver high-quality services and support the continued growth.
In addition, the City is proud to recognize one employee promotion (Drew Jenks) and two job title changes (Sean Cary and Trey Gutierrez) as part of the City’s Progression Plan, which is designed to support career development, recognize outstanding performance, and align roles with evolving organizational needs. These updates underscore the City’s commitment to cultivating talent and maintaining a high-performing team dedicated to serving the community effectively.

DALLAS NORTH TOLLWAY PHASE 4A PROJECT: LANE CLOSURE NOTIFICATION
As part of the continued progress on the DNT Phase 4A project, construction crews will soon implement targeted lane closures to support key project activities. These closures are necessary to facilitate the transport of topsoil, conduct mass haul operations, perform area cleanup, and set structural beams. It is important to note that full closure of the left lanes is not anticipated. Efforts will be made to ensure that lane closures are coordinated to prevent conflicts within overlapping work zones.
Monday, November 10, through Saturday, November 15:
• The northbound and southbound left lane of Dallas Pkwy from First St to FM 428 will be closed daily from 6:30 AM to 6:30 PM.
Adam Bilodeau Applications Manager
Robert Carter Volunteer & Community Engagement Coordinator
Sean Cary Senior Construction Inspector II
Trey Gutierrez Wastewater Treatment Crewman
Drew Jenks Promoted to Operations Superintendent
Tuesday, November 11, through Thursday, November 13:
• All lanes of eastbound and westbound Prosper Trl between northbound and southbound Dallas Pkwy will be closed nightly from 8:00 PM to 6:00 AM.
Tuesday, November 11:
• All lanes of eastbound and westbound Light Farms Way between northbound and southbound Dallas Pkwy will be closed from 4:00 AM to 3:00 PM.
Wednesday, November 12, through Saturday, November 15:
• All lanes of eastbound and westbound Frontier Pkwy between northbound and southbound Dallas Pkwy will be closed nightly from 8:00 PM to 6:00 AM.
ROAD CLOSURES RESIDENT MAP
The City ‘s Road Closures Resident Map serves as a crucial tool for residents to remain informed about ongoing projects and associated road closures within the city. This comprehensive resource empowers individuals to plan their travel routes effectively, minimizing disruptions caused by construction activities. By clicking on the map or accessing the link above, residents gain access to the full interactive map, ensuring easy navigation and timely updates on the evolving infrastructure projects throughout Celina.
[ CLICK HERE TO VIEW THE ROAD CLOSURES MAP ]
City Manager’s Quarterly Report
To: Mayor and City Council
From: Robert Ranc, City Manager
NOVEMBER 7, 2025
SECTION 1
FINANCIAL SUMMARY
GENERAL FUND
Revenues
General Fund revenues total $66,802,709 through September 30, 2025. This represents an increase of 8.4% from revenue earned in the preceding year. Revenue increases are due to growth in population and steady development activities.
The table below provides a summary of total General Fund revenues as of June 30th:
OTHER TAXES PROPERTY TAX
PERMITS & LICENSES FINES & FEES INTEREST GRANTS
The table below provides a comparison between FY 2024 and FY 2025 Activity:
TAX
Note that FY 2024-2025 activity does not include the September sales tax payment. These figures are unaudited and are subject to change pending completion of the annual audit.
GENERAL FUND
Expenditures for General Fund were $63,751,666 through September 30, 2025. This is an increase of $9,052,772 or 16.6%. The expenditures have increased due to new positions and services provided to meet the demands of the growing City unless noted below.
CITY MANAGER'S OFFICE*
CITY SECRETARY'S OFFICE FINANCE
HUMAN RESOURCES INFORMATION TECHNOLOGY
MUNICIPAL COURT
NON-DEPARTMENTAL GIS FACILITIES MAINTENANCE
ENGINEERING LIBRARY
*During FY 2025 the Administration Department was split into the City Manager's Office and Strategic Services Department, the Development Services Department was split into the Building Services, Planning, and Code Services Divisions, and a nondepartmental divison was added. These changes were made to allow better tracking of expenses in the City. These figures are unaudited and are subject to change pending completion of the annual audit. MARKETING PARKS
Water & Wastewater Fund
Revenues
Operating revenues for the Water & Wastewater Fund through September 30, 2025 were $59,373,354, which is an increase of $11,675,913 or 24.5%. The increase is due to new utility accounts added to the system.
The table below provides a summary of total Water/Wastewater revenues as of March 31st:
The table below provides a breakdown of Charges for Services:
These figures are unaudited and are subject to change pending completion of the annual audit.
Water/Wastewater Fund
Expenditures
Water and Wastewater expenditures through September 30, 2025 are $49,615,844 which is $5,862,716 or 13.4% more than FY 2024. The increase in expenditures is due to hightened service requirements from increased customer counts and expansions to the utility system funded through capital purchases and debt payments.
The table below provides a comparison of expenditures in FY 2024 and FY 2025:
These figures are unaudited and are subject to change pending completion of the annual audit.
General Fund - Schedule of Revenues Budget vs. Actuals
These figures are unaudited and are subject to change pending completion of the annual audit.
4th Quarter 2025
General Fund - Schedule of Expenditures Budget vs. Actuals
*During FY 2025 the Administration Department was split into the City Manager's Office and Strategic Services Department, the Development Services Department was split into the Building Services, Planning, and Code Services Divisions, and a non-departmental divison was added. These changes were made to allow better tracking of expenses in the City. These figures are unaudited and are subject to change pending completion of the annual audit.
Fund - Schedule of Revenues Budget vs. Actuals
*During FY 2025 the Wastewater Department was split into the Wastewater Collections and Wastewater Treatment Divisions. These changes were made to allow better tracking of expenses in the City. These figures are unaudited and are subject to change pending completion of the annual audit.
SECTION 2 CAPITAL IMPROVEMENT PROJECTS
Project ID: R86
Project Phase: Construction
Description:
This project will fund the design and reconstruction of Arizona St from Pecan St to Walnut St with subsurface utilities and concrete pavement. Drainage, sign, lighting, landscaping, and pavement marking improvements will also be included in the project.
Funding:
2024 Bond Funds, Road Capital Recovery
Status:
Construction substantially complete. Landscaping and lighting installation underway.
Contact: Dailyn Cruz 469-447-8952
DCruz@celina-tx.gov
Project ID: D56
Project Phase: Construction
Description:
Construction of a concrete curb and gutter street and sidewalks in Arizona and Colorado from Cedar to Ash.
Construction of new water main in Arizona from Cedar to Ash and will reconnect water services to new main. Construction of new gravity wastewater main in Arizona from Cedar to Ash, Colorado from the ditch in line with Cedar to Ash, and along the ditch between Arizona and Colorado, wastewater services in rear of lots will be reconnected to the new main in the in the street.
Funding:
2022 Bond Funds, 2023 Bond Funds, 2024 Bond Funds
Status:
The construction on Arizona is 90% complete. The construction on Colorado is 90% complete.
Contact:
Scott Harper
469-731-3996
SHarper@celina-tx.gov
$4,130,000
Project ID: R115
Project Phase: Design
Description:
Design of approximately 350LF of Ash St from the eastern limit of the BNSF railroad track to Oklahoma to align lanes with the ultimate eastern leg of Ash currently under construction. The project will include widening of the interesection with asphalt, drainage, signage and pavement markings to guide drivers.
Funding:
TBD
Status:
30% Plans to be submitted for review November 7, 2025
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$630,000
Project ID: R50
Project Phase: Design
Description:
Schematic design for Celina Parkway from FM 428 to the Collin County Outer Loop.
Funding:
Roadway Impact (Zone 3)
Status:
City is to coordinate with impacted property owners and Atmos gas company on the proposed alignment.
This project includes the construction of an additional six million gallons per day ground storage tank at Celina Rd Pump Station. The proposed project will provide additional storage capacity to serve future growth in the low-pressure plane and high-pressure plane. The project will be completed in coordination with the 54” water line along Glendenning Pkwy from Celina Rd Pump Station to Dallas Pkwy, the increased pumping capacity at Celina Rd Pump Station, and the new Upper Trinity Regional Water District delivery point.
Funding:
2027 Bond Funds
2028 Bond Funds
Status:
100% plans are completed.
Contact: Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
$15,575,000
Project ID: W80
Project Phase: Design
Description:
Design and construction of 2 Wells within the City of Celina.
Funding:
TBD
Status:
90% Plans due November 14, 2025 with Bid scheduled for December 12, 2025.
Contact: Robert White 972-382-2682
rwhite@celina-tx.gov
Project ID: R66
Project Phase: Construction
Description:
This project consists of the reconstruction of the existing road as a two-lane divided primary arterial within the ultimate right-of-way of a six-lane divided arterial. Drainage, signage, and pavement markings will be included in the project. Lighting and landscaping will not be included in the project. This project will be a shared project between the City and the adjacent subdivision developer.
Funding:
2023 Bond Funds, 2024 Bond Funds
Status:
The project is divided into two phases. 1st phase approximatly 0.55 mile from Coit Rd is under construction. The 2nd phase is delayed due to Utility relocation and ROW acquisition.
Contact:
Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
$10,440,000
Project ID: R105
Project Phase: Design
Description:
Signing and striping plans for a school zone at the new Willard Middle School located at the southwest corner of Coit Rd and Old Glendenning Rd.
Funding:
Road Capital Recovery Fund
Status:
100% design plans ready. They have been sent to Public Works to manage the construction phase.
Contact: Dailyn Cruz
469-447-8952
DCruz@celina-tx.gov
OLD GLENDENNING RD
VETIVER GLOW DR BLUE SAGE CT
VANILLA BIRCH LN
Project ID: R70
Project Phase: Design
Description:
This project consists of the expansion of the existing twolane roadway to a four-lane primary arterial divided within the ultimate right-of-way of a six-lane divided arterial. Drainage, signage, and pavement markings will be included in the project. Lighting and landscaping will not be included in the project. This project will be completed in conjunction with the Town of Prosper and the construction of Coit Rd from Frontier Pkwy south within the Town of Prosper.
Funding:
2023 Bond Funds
Status:
Plans will be added to Prosper's Coit (south of Frontier) plans for construction. Plans are 90% completed. There is an ILA between City of Celina and Town of Prosper for Prosper to undertake the construction of road. Plans are being revised to include the relocation of traffic signal at Frontier and Coit intersection.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
Project ID: R79
Project Phase: Design
Description:
This project includes an asphalt resurfacing of Coit Rd in three segments. These segments are County Road 100 from Preston Rd to County Road 97, County Road 90 from County Road 92 to County Road 98, and County Road 97 from Lynn Stambaugh Pkwy to County Road 134.
Funding:
Road Capital Recovery
Status:
100% plans ready for bidding. To be awarded at March 2026 Council. Contact:
Pkwy to Outer Loop)
Project ID: R67
Project Phase: Design
Description:
This project consists of the reconstruction of the existing two-lane asphalt roadway road as a four-lane divided primary arterial within the ultimate right-ofway of a six-lane divided arterial. Drainage, signage, and pavement markings will be included in the project. Lighting and landscaping are not included in this project.
Funding:
2023 Bond Funds, 2024 Bond Funds
Status:
100% Plans reviewed and comments returned to Halff. City is actively acquiring ROW. Utility relocations are on hold awaiting ROW acquisition.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
Project ID: R57
Project Phase: Design
Description:
This project will include the reconstruction of the existing two-lane asphalt road into a four-lane divided primary arterial within the ultimate ROW of a six-lane divided arterial. This project will include right-of-way acquisition, drainage, roundabouts, and sign and pavement markings. Lighting and landscaping will included as well. This project will be a shared project between the City and Collin County.
Funding:
2022 Bond Funds, 2023 Bond Funds, 2024 Bond Funds, Escrow Reimbursement
Status:
Contruction contract has been awarded to McMahon. Franchise utility relocation is actively in progress and contractor is waiting on majority of the poles to be removed to start active construction.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$14,340,000
Project 12 of 71
Project ID: R82
Project Phase: Construction
Description:
Full depth reclamation/replacement of the asphalt pavement from with HP pipe underground drainage system south to the Collin County Outer Loop (CCOL).
Funding:
2023 Bond Funds, 2024 Bond Funds
Status:
Project to be taken to Council December 2025. Construction to start at the beginning of 2026. Completion anticipated by June 2026. Disruption was do to insufficient funds to complete the intended project. $3.5M funds are avilable for the project, while the opinion of probable construction cost for the project cost came in at $7.0M. Scope had to be cut from the project. The project went form a 29' B-B curbed, concrete road to full depth reclamation and resurfacing of the existing asphalt road.
Contact: Richard Herrera
469-290-7346
RHerrera@celina-tx.gov
Project ID: R42
Project Phase: Design
Description:
The project entails widening and improving County Road 53 surface from gravel to concrete west of the BNSF railroad tracks to the edge of the floodplain along Doe Branch Creek.
Funding:
2021 Bond Funds, 2022 Bond Funds, Road Capital Recovery
Status:
100% plans completed. Construction scheduled for 2028 per the approved 2025 Five-Year CIP plan.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
$2,200,000
Project ID: R55
Project Phase: Design
Description:
The initial phase of this project includes traffic signal studies, as well as design and installation of traffic signals along the North Dallas Pkwy at Light Farms Way, Punk Carter Pkwy, Collin County Outer Loop, and FM 428. This project also includes the construction U-turn lanes at each intersection and additional pavement width not within the scope of the North Texas Toll Authority (NTTA) DNT project.
Funding:
2023 Bond Funds, Road Capital Recovery Roadway Impact (Zone 6)
Status:
Temporary signal design at outer loop 100% Completed. Permanent signal design at punk carter and at light farms are 90% complete. Awaiting for 100% plans for intersection improvements and signals. Doe Branch CLOMR is under review by FEMA.
Contact: Linda Majeed 972-382-7659
LMajeed@celina-tx.gov
$4,530,000
Dallas Pkwy 42" and 36” Water Line - Celina Rd Pump Station to J. Fred Smith Pkwy
Project ID: W50
Project Phase: Design
Description:
This project will fund right-of-way acquisition and construct a 54” water line on Dallas Pkwy from the Celina Rd Pump Station to J. Fred Smith Pkwy. This project will provide additional water supply to the northwest section of the City.
Funding:
2021 Bond Funds, 2023 Bond Funds
Status:
Construction to start in 2027.
$22,440,000
Project ID: B33
Project Phase: Construction
Description:
Construction of ~400 space parking garage on the east side of Arizona between Walnut (FM 455) and Pecan. Construction of ~115,000 square foot Downtown Center on the west side of Colorado between Walnut and Pecan.
Funding:
2023 Bond Funds, 2024 Bond Funds
Status:
Garage TCO granted on October 18, 2025 for 3 floors with top floor remaining closed for construction material lay-down space for CMAR. Building construction underway and currently on schedule.
Contact: Barbara Hoskins
940-453-7018
BHoskins@celina-tx.gov
$96,000,035
Project ID: R20
Project Phase: Construction
Description:
Roadway, drainage, water, and sewer improvements on Colorado, Beech, Ohio, and Pecan
Funding:
2017 Bond Funds, 2018 Bond Funds, 2021 Bond Funds, 2022 Bond Funds.
Status:
ATT have been permittted to complete the removal of overhead fiber lines along Ohio St. Remaining overhead poles to be removed to complete brick paving.
Contact: Andy Glasgow
469-813-4182
AGlasgow@celina-tx.gov
$7,390,000
Project ID: S41
Project Phase: Design
Description:
This project will upsize a series of undersized gravity sewer lines in the Downtown area beginning at Preston Rd and extending west toward the Downtown wastewater treatment plant (WWTP). The project includes two phases: Phase 1 from WWTP on Florida to Oklahoma and phase 2 from Oklahoma to east of Preston Rd (SH 289).
Funding:
2023 Bond Funds
Status:
100% plans completed. Construction to start in 2028.
Contact: Linda Majeed
972-382-7659
$10,300,000
Project ID: S25
Project Phase: Design
Description:
The existing Wastewater Treatment Plant (WTP) can serve a treatment capacity of 0.95 million gallons per day (MGD). This project will expand the existing treatment capacity from 0.95 MGD to 2.0 MGD. The impact fee study identifed an expansion of the Downtown treatment plant to 5.0 MGD by 2030. This project has been identifed as 1A. The remaining four expansions will be in 1.0 MGD increments and will be label 1B (3.0 MGD), 1C (4.0 MGD) and 1D (5.0 MGD)."
Funding:
Wastewater Impact Fees
Status:
100% design completed and will be presented at City Council for approval in January 2026.
Contact: Dailyn Cruz
469-447-8952
DCruz@celina-tx.gov
$124,782,000
Project ID: R46
Project Phase: Design
Description:
Design schematic for Elm St from Preston Rd to Texas Dr. Schematic to determine the ROW needs that would be required for a future street improvements and widening project.
Funding:
Roadway Capital Funds
Status:
Schematic design completed, and survey docs are being prepared.
Contact:
Scott Harper
469-731-3996
SHarper@celina-tx.gov
Project ID: F25
Project Phase: Design
Description:
Design and construction of four emergency sirens to be placed throughout the City.
Funding:
Integrity Fund
Status:
Originally the project was for two signals, and two additional signals for a total of four were requested by Fire. Requested design change order from engineer. Disruption was due to additional sirens being requested.
Contact: Richard Herrera
469-290-7346
rherrera@celina-tx.gov
Project ID: F23
Project Phase: Construction
Description:
Design and construction of three double bay Fire Station with storm shelter and fire training tower.
Funding:
R57-8502-624, FY 24 Bonds, 2023, 2024, 2025 Bonds
Status:
Plans approved with pre-construciton meeting on October 28, 2025 with construction to begin in November. Groundbreaking Ceremony is scheduled for November 19, 2025.
Contact: Barbara Hoskins
940-453-7018
BHoskins@celina-tx.gov
$11,133,125
PUNK CARTER PKWY
ROYAL LN
YELLOW PINE RD
Project ID: W71
Project Phase: Design
Description:
This project is for the relocation of two existing water lines on Glendenning Pkwy (FM 428) between DNT and Preston Rd. This relocation is necessitated by the realignment of Glendenning Pkwy (FM 428) from Dallas Pkwy to Preston Rd.
Funding:
Escrow Reimbursement
Status:
Plans ready. Awaiting funding.
Contact: Robert White
972-382-2682 rwhite@celina-tx.gov
Project ID: R102
Project Phase: Design
Description:
Signing and striping plans for a school zone for the new PISD middle school #8 located at the northeast corner of Frontier Pkwy and Mill Pond Dr
Funding:
Road Capital Recovery Fund
Status:
60% Plans were subimtted for review in October 2025.
Contact: Catherine Oduro 469-813-4095
COduro@celina-tx.gov
Project ID: R22
Project Phase: Design
Description:
Design of four lanes of concrete from FM 1385 to Dallas Pkwy.
Funding:
2019 Bond Funds, 2021 Bond Funds, Road Capital, Recovery, Escrow Reimbursement
Status:
Sixty percent (60%) design plans have been submitted and reviewed. Ninety percent (90%) design plans underway and property appraisals ongoing.
Contact: Andy Glasgow
469-813-4182 AGlasgow@celina-tx.gov
$84,748,000
Project ID: W16
Project Phase: Design
Description:
This project will replace the existing 6” water line with a 12” water line along Frontier Pkwy from east of Preston Rd to Coit Rd. This project is being completed due to the widening of Frontier Pkwy (FM 1461) from Preston Rd to Custer Rd by TxDOT.
Funding:
2021 Bond Funds, 2022 Bond Funds, Water Capital Recovery
Status:
100% plans submitted to the city. Construction is programmed to start January 2026. Contact: Catherine Oduro 469-813-4095 COduro@celina-tx.gov
Pump Station to Celina Pkwy 54" Water Line
Project ID: W83
Project Phase: Design
Description:
The project includes the proposed 54" Transmission Pipeline. The 54" Pipeline will connect to the 54" stub near the intersection of FM 428 and CR 55. The Pipeline generally follows the proposed FM 428 rightof-way west until reaching the Celina Rd Pump Station site. The approximate length of pipe is 11,000-linear feet.
Funding:
2025 Bond Funds
Status:
60% Design in progress.
Contact: Robert White
972-382-2682
rwhite@celina-tx.gov
$16,750,000
Project ID: R15
Project Phase: Design
Description:
This project will include the reconstruction of the existing two-lane asphalt road into a four-lane divided primary arterial within the ultimate row of a six-lane divided arterial. This project will include right-of-way acquisition, drainage, bridge, and sign and pavement markings. Lighting and landscaping will occur as part of a separate project. This project will be a shared project between the City and Texas Department of Transportation (TxDOT).
Funding:
Escrow Reimbursement
Status:
Schematic design and environmental analysis completed. TxDOT is actively acquiring ROW. TxDOT has placed a hold on design, specifications and estimate (PS and E) package.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
Project ID: R101
Project Phase: Design
Description:
Remove and Replace existing Hillside Dr pavement, water and wastewater infrastucture.
Funding:
2022 Bond Funds, 2024 Bond Funds, 2025 Bond Funds
Status:
First review has been completed and awaiting resubmittal.
Contact: Scott Harper 469-731-3996
SHarper@celina-tx.gov
Project ID: W67
Project Phase: Design
Description:
This project includes the construction of a 24” water line on J. Fred Smith Pkwy from Preston Rd to Coit Rd to provide additional redundancy to serve the highpressure plane located east of Preston Rd.
Funding:
2023 Bond Funds
Status:
100% plans completed. Construction to start in 2028.
JAMES
CARUTH
Project ID: R28
Project Phase: Construction
Description:
Construction of two-lane concrete roadway, including a bridge
Funding:
2021 Bond Funds, Road Capital Recovery
Status: 90% plans are on hold while awaiting construction funding.
Contact: Scott Harper 469-731-3996
SHarper@celina-tx.gov
$11,730,000
Full Intersection Schematic Design
Project ID: R112
Project Phase: Design
Description:
The projects includes the ultimate layout of the intersection of Legacy Dr at J. Fred Smith Pkwy, extending 500’ in each direction from the centerline intersection of each roadway. The layouts will include four-lane roundabout and a six-lane full intersection.
Funding:
Road Capital Recovery
Status:
Awaiting for the conceptual layouts.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
Project ID: R111
Project Phase: Design
Description:
Extension of 3700’ of Legacy Dr to connect Carthage Dr and Louisiana Dr. This project is associated with the Developer Agreement for Acadia in Legacy Hills.
Funding:
2023 Bonds Funds
Status:
Design is near 60% completed with submittal pending.
Contact: Robert White 972-382-2682
rwhite@celina-tx.gov
$2,720,000
Project ID: R96
Project Phase: Design
Description:
Design schematic for Legacy Dr from Carey Rd to Punk Carter Pkwy and intersection improvements for Legacy Dr at FM 428/Collin County Outer Loop. Analyze three options feasibility for construction and ROW/ Easement needs through the creek and floodplain parallel to the Thoroughfare Plan Alignment.
Funding:
Roadway Impact (Zone 6)
Status:
Design Option 1 was selected, and the final design scope is pending City Council approval that is scheduled for December 2025.
Contact:
Scott Harper
469-731-3996
SHarper@celina-tx.gov
Pkwy to Celina Rd Pump Station)
Project ID: W62
Project Phase: Design
Description:
This project includes the design and construction of a 24” and 36” water line along Legacy Dr from Punk Carter Pkwy to Celina Rd Pump Station.
Funding:
2023 Bond Funds
Status:
Design plans are 90% completed, and awaiting Legacy Dr schematic project (R96) results to resume design.
Contact: Dailyn Cruz 469-447-8952
DCruz@celina-tx.gov
Project ID: S59
Project Phase: Design
Description:
This project is the design and construction of an additional treatment capacity at the existing Legacy Hills WRF. The existing plant was constructed in 2024 and designed to serve 0.95 million gallons per day. Due to the continued growth of the Legacy Hills subdivision and the continued expansion of the Little Elm Creek and Honey Creek sewer basins, additional capacity is needed at the Legacy Hills WRF. This project will expand the treatment capacity from 0.95 MGD to 2.0 MGD.
Funding:
2026 Bond Funds, 2027 Bond Funds, 2028 Bond Funds
Status:
100% design plans reviewed. Awaiting construction funding.
Contact:
Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
$31,762,000
Project ID: W81
Project Phase: Design
Description:
This project includes the design and construction of a proposed 3.0 million gallon (MG) composite elevated storage tank (EST) for potable water that will be located on a 1.98 acre tract at the northwest corner of the proposed Ranch at Uptown Phase 1 subdivision.
Funding:
2025 Bond Funds, 2027 Bond Funds, 2028 Bond Funds, 2029 Bond Funds
Status:
Design plans are 60% completed with comments provided by consultant. Contact:
Project ID: R84
Project Phase: Design
Description:
This project consists of the full-depth reclamation of the existing asphalt roadway on Marilee Rd from Preston Rd to Dallas Pkwy. This project will be shared with the City of Gunter, Grayson County, Collin County, City of Celina, and the adjacent subdivision developers.
Funding:
Road Capital Recovery
Status:
Design team is working on the metes and bounds for the additional ROW needed for the project. Plans will be finalized once the additonal ROW is secured.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$8,700,000
Mustang Meter Conversion
Project ID: W78
Project Phase: Design
Description:
Converting Mustang water system/meters to the City of Celina water system. Meters are located west of Preston Rd.
Funding:
Utility Impact Fee Fund
Status:
Awaiting 100% submittal.
Project ID: W61
Project Phase: Design
Description:
Installation of a 12” water line along the east side of Preston Rd from FM 455 to First Celina Baptist Church
Funding:
2023 Bond Funds
Status: 100% plans submitted.
Contact: Dailyn Cruz
469-447-8952
DCruz@celina-tx.gov
$1,580,000
LYNN STAMBAUGH PKWY KINNEY
Project ID: S26
Project Phase: Design
Description:
Upsize of existing 8” sewer line along Preston Rd with an approximately 2000’ of 18” sewer line and 690’ of 12” line from CR 99 (G.A. Moore Pkwy) to CR 134.
Funding:
Wastewater Impact Fees
Status:
Construction on hold until funding available.
Contact: Dailyn Cruz
469-447-8952
DCruz@celina-tx.gov
$1,610,000
Project ID: R100
Project Phase: Design
Description:
Design and reconstruction of Ohio St and Louisiana Dr from Ash St to the south end.
Funding:
2023 Bonds Funds
Status:
60% design completed with 90% design anticipated in December 2025.
Contact: Richard Herrera
469-290-7346
RHerrera@celina-tx.gov
Total Cost
$5,712,000
Project ID: R63
Project Phase: Construction
Description:
This project will include the design and construction of Oklahoma Dr from Pecan St to Malone Dr. The project will replace the existing asphalt roadway construction with two concrete lanes and associated drainage, signage, and pavement marking improvements. Lighting and landscaping along Oklahoma Dr will be included in this project.
Funding:
2023 Bond Funds, Roadway Impact (Zone 6)
Status:
Waiting on utility relocations. Need to perform public meetings. Project planned to be taken to City Council in March 2026.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
Project ID: P32
Project Phase: Construction
Description:
Design and construction of modular restrooms and additional paved trails at the Old Celina Park.
Funding: Park Fees
Status:
Approved plans and bid documents to be sent to the Purchasing Department for soliciting of bids. Building will be prefabricated by Public Restroom Company and will be delivered on site in August 2026.
Contact: Catherine Oduro 469-813-4095
COduro@celina-tx.gov
$1,240,000
Project ID: P25
Project Phase: Design
Description:
Stream Restoration and Trail Design along Doe Branch Creek from Preston Rd to Ash St
Funding:
2023 Bond Funds
Status:
Plans are 90% completed. NWP 27 has been approved by U.S. Army Corps of Engineers. Utility coordination is in progress. City is waiting for utility relocation to advance to 90% completion prior to advertising project for bids.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$18,250,000
Ownsby Pkwy (Preston Rd
Rd) and CR 83 (Ownsby Pkwy to Quail Hollow)
Project ID: R58
Project Phase: Construction
Description:
Construction of four lanes of concrete road that includes drainage, signage, lights, sidewalks and landscape. The intersection of CR 83 and Quail Hollow is yet to be completed.
Funding:
2021 Bond Funds, 2022 Bond Funds, 2023 Bond Funds
Status:
Paving is 100% completed and traffic signal is operational. There are few outstanding punch list items that need to be completed for the final acceptance of the project by the City.
The parallel Doe Branch interceptor is a series of sewer lines that will begin at Parvin Rd and extend to the Frontier Pkwy lift station on the east side of town. The project is broken down into four phases Parvin Rd to Legacy Dr (15A), Legacy Dr to Preston Rd (15B), Preston Rd to Coit Rd (15C), and Coit Rd to Frontier lift station (15D). The total project will include the installation of 31,320 linear feet (LF) of wastewater lines between 36” and 48”. This project consists of the design and installation of approximately 1,500 LF 36”, 3,600 LF of 42” and 13,800 LF 48” gravity sewer associated interconnects. The FY 2025 project includes the design of the phase of the project from Parvin Rd to Legacy Dr in coordination with the development of the adjacent subdivision.
Funding:
2021 Bond Funds, 2023 Bond Funds
Status:
Waiting on 90% submittal. Construction is anticipated to start in 2027.
Contact: Richard Herrera
469-290-7346
RHerrera@celina-tx.gov
$8,300,000
Project ID: B36
Project Phase: Construction
Description:
Design and construction of 14,000-square-feet. Parks Administration facility of which 9,000-square-feet. are for public use and programming space. This building is a rehab of the old Celina ISD athletic offices.
Funding: 2023 Bond Funds
Status:
Construction is underway of interior remodel. Exterior firelane, landscaping and utilities are forthcoming with timing completed simultaneously with building opening.
Contact: Barbara Hoskins
940-453-7018
BHoskins@celina-tx.gov
Total Cost
$10,000,000
Project ID: S42
Project Phase: Construction
Description:
Improvements to the Parkside Lift Station including driveway, generator, and awning.
Funding:
2023 Bond Funds
Status: The project is nearing completion.
Contact: Scott Harper
469-731-3996
SHarper@celina-tx.gov
Facility (WRF) & Hydraulics and Hydrology
Project ID: S44
Project Phase: Design
Description:
This project will fund the required hydraulics and hydrology study associated with the construction of a possible water reclamation facility located near the intersection of Parvin Rd and Smiley Rd.
Funding:
Sewer Capital Recovery Fund
Status:
Data required for the TCEQ permit submission is being gathered.
Contact: Catherine Oduro 469-813-4095
COduro@celina-tx.gov
Pecan St (Arizona Dr to Florida Dr), Illinois St (Walnut St to Beech St), and Arizona Dr (Pecan St to Beech
Project ID: R86
Project Phase: Design
Description:
This project will fund the design and reconstruction of Pecan St from Arizona Dr to Florida Dr with subsurface utilities and concrete pavement. Drainage, sign, and pavement marking improvements will also be included in the project. This design also includes the full depth reclamation/replacement of the asphalt pavement of Arizona Dr from Pecan St to Beech St, and Illinois St from Walnut St to Beech St.
Improvements to the large culverts and headwalls crossing under Preston Lakes Road
Funding:
2024 Bond Funds, Drainage Funds
Status: Design is pending second submittal.
Contact: Scott Harper 469-731-3996
sharper@celina-tx.gov
$1,400,000
Project ID: P20
Project Phase: Construction
Description:
Replace planting material along Preston Rd within existing planting beds. Replace damaged irrigation.
Funding:
Park Fees, Escrow Reimbursement
Status:
Construction is completed. The project is under maintenance contract until July 2026.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
$1,200,000
(Legacy Dr to Grayson County Line)
Project ID: R24
Project Phase: Design
Description:
This project includes arterial street lighting installation along Preston Rd from Legacy Dr to the Grayson County line.
Funding:
2018 Bond Funds, Road Capital Recovery
Status: 100% plans completed. On hold until TXDOT's funding is available.
Contact: Linda Majeed 972-382-7659
LMajeed@celina-tx.gov
Project ID: W46
Project Phase: Design
Description:
Adjustments to intermediate pressure plane in Downtown
Funding:
Water Capital Recovery
Status:
This project will be included in the City's 2025 Downtown Water and Wastewater Improvements project.
Contact: Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
LAUGHLIN LN
Project ID: P35
Project Phase: Design
Description:
Evaluation of existing median trees. Design and construction for the replacement of diseased or damaged trees. Modification of existing irrigation system to provide tree bubblers.
Funding: Park Fees
Status:
The bid was rejected by City Council. Evaluating redesigning the plans to decrease the number of trees.
Contact: Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
Project ID: B34
Project Phase: Construction
Description:
The Public Works facility has gravel parking lots. Both City vehicles and personal vehicles are parked on gravel. When City vehicles are washed, they pull them onto a small concrete apron and then park the newly-cleaned vehicle back on gravel. This project will install 100 new concrete parking spaces, a 2,000-foot-long fire lane with two, new controlled access points. This car park will serve both staff and members of the public and will provide the spacing needed for all Public Works-related events and clean-up days in the future. The development of the Public Works facility will be broken up into multiple phases.
Funding:
2023 Bond Funds
Status:
Construction was awarded to Hawk Builders at the April 2025 City Council Meeting. 13 bids in total were received.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
Project ID: R73
Project Phase: Construction
Description:
The project includes an addition of a right turn lane for northbound traffic on Preston Rd on to Punk Carter Pkwy.
Funding:
Road Capital Recovery, Roadway Impact (Zone 7)
Status:
Construction started October 6, 2025.
Contact: Catherine Oduro 469-813-4095
COduro@celina-tx.gov
DARTMOORDR
APPALOOSA
Project ID: R118
Project Phase: Design
Description:
Signing and striping plans for a school zone at a new Junior High School.
Funding:
Road Capital Recovery Fund
Status: This project has begun and awaiting 30% plan submittal.
Contact: Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
Project ID: S37
Project Phase: Design
Description: This project includes the future wastewater reclamation facility in Rasor Ranch.
Funding:
2021 Bond Funds, 2022 Bond Funds, 2023 Bond Funds, Escrow Reimbursement
Status:
Received 100% plan submittal. Project delayed due to the high escalation in an Opinion of Probable Construction Cost (OPCC) due to converting the metal building to masonry, making a permanent concrete access road, upgrading the equipment, and adding a brick facade.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$67,099,000
Project ID: S43
Project Phase: Construction
Description:
Impact Fee Project 37 was the installation of a 1.0 MGD package treatment plant. After evaluating the options, staff determined that utilizing the existing surplus capacity in the Legacy Hills sewer lines was a better solution. This project will construct approximately 5,500' of 12” wastewater pipeline from the future location of the Rasor WFR to connect to the existing oversized sewer piping within the Legacy Hills subdivision. The new interceptor will allow the sewer flow that will ultimately be treated by the Rasor WRF to be temporarily transported to and treated by the Legacy Hills WRF until such time that the Rasor WRF is constructed.
Funding:
2023 Bond Funds
Status:
Reimbursement agreement was approved by City Council at the April 2025 meeting to include the construction of the sewer line with the Marilee subdivision public infrastructure.
Contact: Catherine Oduro
469-813-4095
COduro@celina-tx.gov
$1,780,000
Lynn Stambaugh Pkwy
Project ID: R106
Project Phase: Design
Description:
Construction of approximately 500’ of right turn lane from northbound Preston Rd to eastbound Lynn Stambaugh Pkwy.
Funding:
2026 Bond Funds
Status:
Design plans are 60% completed.
Contact:
Mina Zamanian
469-545-2403
MZamanian@Celina-tx.gov
$435,000
Project ID: W63
Project Phase: Construction
Description:
This project includes the construction of a new 8 million gallons per day (MGD) Ground Storage Tank on the proposed Southeast Pump Station site. This project is being completed in coordination with the Southeast Pump Station and 54” transmission line.
Funding: 2023 Bond Funds
Status:
The contractor is working on grading the site.
Contact: Linda Majeed 972-382-7659
LMajeed@celina-tx.gov
$13,370,000
Project ID: W58
Project Phase: Construction
Description:
This project consists of the construction of a new 25 million gallons per day (MGD) Pump Station on Glendenning Rd west of Coit Rd. This project includes design and construction. This project is being completed in coordination with the southeast ground storage tank and 54” transmission line. This project will also include the decommissioning of the existing Downtown Pump Station.
Funding:
2022 Bond Funds, 2023 Bond Funds, 2024 Bond Funds, 2025 Bond Funds
Status:
The contractor is working on grading the site.
Contact: Linda Majeed 972-382-7659
LMajeed@celina-tx.gov
$60,350,000
Project ID: W58
Project Phase: Design
Description:
This project consists of the construction of a new 54” transmission line. This project is being completed in coordination with the southeast ground storage tank and 54” transmission line.
Funding:
2022 Bond Funds, 2023 Bond Funds, 2024 Bond Funds, 2025 Bond Funds
Status:
Design is 100% complete. The construction contract is scheduled to be awarded in winter 2026, with work expected to begin in spring 2027 due to material lead time.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
Project ID: R81
Rd to Coit Rd)
Project Phase: Construction
Description:
The project includes full depth reclamation/ replacement of the asphalt pavement and the installation of sanitary sewer on Sunset Blvd.
Funding:
2021 Bond Funds, 2024 Bond Funds, Wastewater Capital Recovery
Status:
The contractor is currently working on Phase 2 subgrade between Brookshire’s and east of KC Robinson Ln following the intersection of Preston Rd and Sunset Blvd.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
Project ID: R113
Project Phase: Design
Description:
Schematic design for Sunset Blvd from Oklahoma Dr to FM 428
Funding:
Road Capital Recovery
Status:
Comments were sent to engineer in October 2025 with an anticipated final schematic design in December 2025.
Contact: Richard Herrera
469-290-7346
RHerrera@celina-tx.gov
Project ID: R116
Project Phase: Design
Description:
The project includes pavement widening of Tudor Pl to accommodate two 11’ lanes (additional 5’ of pavement width) at the westbound approach of the FM 1385 intersection of approximately 350 linear feet.
Funding:
2024 Bond Funds
Status:
Awaiting for the 60% design plans.
Contact: Linda Majeed
972-382-7659
LMajeed@celina-tx.gov
$370,000
Project ID: R41
Project Phase: Design
Description:
TxDOT will be reconstructing the existing asphalt roadway to four lanes of curbed concrete road with underground drainage system and sidewalks from Preston Rd to Custer Rd.
Funding:
Road Capital Recovery
Status:
60% Plans sent to TxDOT. City is waiting for 90% plans. TxDOT is waiting on funding to start construction. Utility locations are to be completed by April 2025. Construction is set to begin in 2027 contingent on funding.
Contact: Richard Herrera
469-290-7346
RHerrera@celina-tx.gov
Project ID: P31
Project Phase: Design
Description:
Wilson Creek Park is a 100-acre park located at the northwest corner of Sunset Blvd and Roseland Pkwy within the Parks of Wilson Creek subdivision. This park is currently undeveloped and will be constructed in multiple phases. Phase I of the project consists of the design and construction of approximately 30 acres of Wilson Creek Park to include two multi-use sports fields complexes, a pond, irrigation, and the first two lanes of the Wilson Creek Park driveway. This phase of the project also includes floodway reclamation and coordination with U.S. Army Corps of Engineers. This project development will follow the approved Wilson Creek Park Master Plan.
