Municipality of North Perth 2023 Draft Capital Budget
March 22, 2023 Budget Meeting
This document is available in alternate formats, upon request.
OF NORTH PERTH 2023 DRAFT CAPITAL BUDGET Index Page Number Combined Capital Budget a) Combined Projects - Department Summary 3 4 CAO Administration a) CAO Administration Capital Projects 5 6 Strategic Initiatives a) Strategic Administration Capital Projects b) Economic Development Administration Capital Projects 9 10 13 Programs a) Programs Administration Capital Projects 18 19 Corporate Services a) Finance Administration Capital Projects b) IT Administration Capital Projects 22 23 28 Development and Protective Services a) Fire Administration Capital Projects 37 38 Environmental Services a) Waste Water Administration Capital Projects b) Water Administration Capital Projects 41 42 51 Operations a) Roads Administration Capital Projects 63 64 Facilities a) Facilities Administration Capital Projects b) Facilities Parks Capital Projects c) Facilities Trails Capital Projects 142 143 195 223 Capital Projects by Department a) Capital Projects Details 226 227
MUNICIPALITY
Combined Captial Budget
Version Budget Year 1.Department Submission 2023 Municipality of North Perth Capital Projects - Department Summary Forecast Periods 2023 Project Type 16-Mar-2023 1:39:37 PM Expenditures Segregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Department 1,731,5001,661,50070,000 Facilities Administration 2,528,1001,583,100401,00044,000500,000 Park Operations Administration 119,556119,556 Trail Maintenance Adminstration 165,000165,000 Council/CAO Administration 20,00020,000 Strategic Administration 95,00070,00025,000 Finance Administration 279,400258,3005,60015,500 IT Administration 77,00077,000 Fire Administration 16,497,70015,386,150911,550200,000 Roads Administration 2,165,0002,165,000 Waste Water Administration 1,725,0001,700,00025,000 Water Administration 30,00030,000 Program Administration 226,470211,91514,055500 Economic Development 25,659,72623,250,9651,509,550183,211500500,000215,500 Page No. : 1
CAO Administration
Version Budget Year 1.Department Submission 2023
North Perth
Projects by Priority within Department Forecast Periods 2023
Department Council/CAO Administration Council/CAO Administration Department 15-Mar-2023 11:16:43 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 165,000165,000 5900CAO - West Development Plan 56 165,000165,000 Total Council/CAO Administration TotalMunicipality of North Perth 165,000165,000 Page No. : 1
Municipality of
Capital
Home
Project Department
Municipality of North Perth
Capital Projects
5900 CAO - West Development Plan (WDP)
1.Department Submission
VersionYear
Project Description
2023
Description
Council has directed staff to develop a plan for the municipally owned land west of the Steve Kerr Memorial Complex (North and South of Binning Street). The West Development Plan (WDP) will include future land use options along with a preliminary servicing plan. The overall purpose of the WDP is to guide the development of designated lands brought into the urban boundary through the County Official Plan process, as well as establish a servicing strategy for other lands within the broader study area.
Risk if Not Implemented
Supply for land for residential development could become critical.
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Project Department VersionYear 5900 CAO - West Development Plan (WDP) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 15 Environmental/ Economic Impact (0 to 15) 15 Total Weight 56 Budget 2023 Total Expenditures 165,000 165,000 Funding 165,000 165,000 Attributes Attribute Value Comment Attributes Department Council, CAO Year Proposed 2023 Project Type Growth Parent Location 5900 Project Rating 56 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Strategic Initiatives
Version Budget Year 1.Department Submission 2023
of North Perth Capital Projects by Department Ranking Forecast Periods 2023
Department Strategic Administration Strategic Administration Department 15-Mar-2023 11:01:31 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 20,00020,000 5081-23-002Strategic - Municipal Website 60 20,00020,000 Total Strategic Administration TotalMunicipality of North Perth 20,00020,000 Page No. : 1
Municipality
Home
Municipality of North Perth
Capital Projects
Project Department VersionYear
5081-23-002 Strategic - Municipal Website Update & Branding Strategic Administration
1.Department Submission
Project Descrtiption
2023
Description
The current format and CMS (Content Management System) of the North Perth website (www.northperth.ca) was launched in 2018. The municipal website is hosted by GHD Digital (formerly eSolutions Group). Staff recently met with the Municipality's Account Executive to discuss possible updates to the website to increase staff and user experience/funcitonality. As much of the design of the current website is hardcoded, updates can be costly. An opportunity to update North Perth's website to GHD's new Govstack CMS solution was presented. The Govstack CMS solution was developed based on feedback from GHD's current website client base (predominently municipal governments and other public sector clients). Govstack offers informative navigation tools, accessible web design and flexible layouts to benefit both public users and website management by staff. Flexible features include the ability to build micro-sites and landing pages to augment service delivery online, design themes and customized page layouts/templates, brand website to a higher level, and embed third-party code (i.e. Google Maps). At this time, GHD Digital is offering existing clients discounted pricing for migration to the new Govstack CMS solution of $15,000. Additionally, staff are proposing $5,000 be included in the project budget and allocated towards municipal branding updates that will be incorporate into the new website design.
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Risk If Not Implemented Asset Management Asset Estimated Useful Life
7
Page No. : 1
Project Department VersionYear 5081-23-002 Strategic - Municipal Website Update & Branding Strategic Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 0 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 10 Total Weight 60 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Growth Parent Location 5081 Project Rating 60 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Forecast Periods 2023
Municipality of North Perth
Capital Projects by Priority within Department
Home Department Economic Development Administration
Economic Development Administration
Version Budget Year
1.Department Submission 2023
Department 16-Mar-2023 10:10:32 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 179,620179,620 5008-23-002STRATEGIC - Downtown 51 46,85032,29514,055500 5008-23-001STRATEGIC Carryover - 26 226,470211,91514,055500 Total Economic Development Administration TotalMunicipality of North Perth 226,470211,91514,055500 Page No. : 1
Municipality of North Perth
Capital Projects
Description
Project Descrtiption
In May 2022, government funding was secured for a Downtown Parkette project to supply an outdoor dining, seating and landscape attraction in the downtown of Listowel. The project goal was to foster downtown revitalization plus stimulate economic recovery and growth by drawing visitors and residents to an outdoor and beautified public space within the downtown of Listowel. Public spaces in downtowns have been identified in recent plans and surveys to youth and general residents as a means to attract and retain youth in North Perth. The Streetscape Master Plan, approved by North Perth Council, included this project and is now updated to incorporate outdoor dining, landscaping and an art attraction to in response to post-pandemic needs and preferences plus increase attraction potential. In 2021, a pilot outdoor dining space at the Main Street East parking lot location was well used.The 2022 project had limited bidder interest and was significantly over budget due to a very tight timeline and competitive market. The grant was allocated to a completed eligible project and now re-allocation of the $49,620.00 to the current project is requested. An updated municipal contribution of $130,000.00 funded from Economic Development Reserves is proposed for a total project budget of $179,620.00. External partnerships to fund the project are being investigated.
Department VersionYear 5008-23-002 STRATEGIC - Downtown Listowel Parkette 1.Department Submission 2023
Project
If Not Implemented Asset Management Asset Estimated Useful Life 40 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 4491.00 Page No. : 1
Risk
Municipality of North Perth
Capital Projects Project Department VersionYear 5008-23-002 STRATEGIC - Downtown Listowel Parkette 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 10 Environmental/ Economic Impact (0 to 15) 15 Total Weight 51 Budget 2023 Total Expenditures 179,620 179,620 Funding 179,620 179,620 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5008 Project Rating 51 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Project
Municipality of North Perth
Capital Projects
5008-23-001 STRATEGIC Carryover - Monkton G2G Trailhead
VersionYear
Description
Project Descrtiption
In April 2022, funding was approved by OMAFRA Rural Economic Development (RED) Program, Strategic Economic Infrastructure Stream, for a Trailhead on the Monkton G2G Rail Trail. This RED stream grants 30% of project costs to enhance a cultural, heritage or tourism attaction. The purpose of the G2G Rail Trail Monkton Trailhead project is to install a visible and user-friendly Trailhead to the existing G2G Rail Trail at the Monkton, Ontario section head location. Partnering with G2G, the project includes the design and installation of trailhead amenities such as: signage, pathway access to parking, kiosk/bench, removable market stand, wifi access, bike repair charging station, etc. This will increase visibility and use of the trail by visitors and residents alike and promote outdoor active experiences and awaremeness of rural agriculture and heritage. Trails are an economic driver valued by Youth and new residents and this project would have economic benefits by increased use and visibility and draw to support businesses and North Perth trails closeby. The total project cost estimate is $46,850 with 30% grants of $14,055 from RED, $500 from G2G and the remaining financial support from the Municipality. G2G is supporting project implementation which has been extended to March 31, 2023. We request carryover of Municipal funding to complete the project.
Department
1.Department Submission 2023
Risk If Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 3123.00 Page No. : 1
Project Department VersionYear 5008-23-001 STRATEGIC Carryover
Trailhead 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 5 Environmental/ Economic Impact (0 to 15) 10 Total Weight 26 Budget 2023 Total Expenditures 46,850 46,850 Funding 46,850 46,850 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5008 Project Rating 26 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
- Monkton G2G
Programs
Version Budget Year 1.Department Submission 2023 Municipality of North Perth Capital Projects by Department Ranking Forecast Periods 2023 Home Department Program Administration Program Administration Department 15-Mar-2023 11:00:11 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 30,00030,000 5081-23-001Programs - Recreation/Daycare 47 30,00030,000 Total Program Administration TotalMunicipality of North Perth 30,00030,000 Page No. : 1
Project Department
Municipality of North Perth
Capital Projects
5081-23-001 Programs - Recreation/Daycare Software
Program Administration
1.Department Submission
VersionYear
Project Descrtiption
2023
Description
New program software system(s) can improve efficiencies in program registrations (recreation and child care) and accounts receivables as well as be more user friendly to our families and registrants. Improving these efficiencies will allow more staff time for program development and focus on quality of program services.
Previous attempts to include this into our modernization funding were not successful. Estimated cost $20,000 upfront with $4,000 annual licensing requirements. There will be staff time needed for data transfer and uploads, estimated at $10,000. The costs of purchasing a new software outweigh the benefits we will get back in efficiencies.
When reviewing recreation program software options, investigations will also including evaluating the benefits of including facility scheduling software.
Risk If Not Implemented
Low risk if not implemented, however ongoing administrative inefficiencies may affect staff retention if actions to improve these systems is not considered.
Asset Management Asset Estimated Useful Life N/A New Asset Approximate Annual Operating Costs (Impact to Operating Budget) $4,000 Future Depreciation Budget Costs (Approximate) N/A Page No. : 1
Municipality of North Perth
Capital
Project Department VersionYear 5081-23-001 Programs - Recreation/Daycare Software Program Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 7 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 15 Environmental/ Economic Impact (0 to 15) 10 Total Weight 47 Budget 2023 Total Expenditures 30,000 30,000 Funding 30,000 30,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Growth Parent Location 5081 Project Rating 47 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Projects
Corporate Services
Version Budget Year 1.Department Submission 2023
of North Perth
Projects by Priority within Department Forecast Periods 2023
Department Finance Administration Finance Administration Department 16-Mar-2023 9:09:49 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 70,00070,000 5080-23-004FINANCE - Asset Management 80 25,00025,000 5080-23-003FINANCE - Development 75 95,00070,00025,000 Total Finance Administration TotalMunicipality of North Perth 95,00070,00025,000 Page No. : 1
Municipality
Capital
Home
Project Department
Municipality of North Perth
Capital Projects
5080-23-004 FINANCE - Asset Management Plan - Next Steps
Finance Administration
1.Department Submission
VersionYear
Project Description
2023
Description
North Perth's Asset data base in constantly being improved and updated. As well, the overall Asset Management Plan is evolving and needs to be brought up to-date for our purposes and to meet legislative requirements as they are implemented by the province. A request for proposal will circulated in concert with the Development Charges Background Study Update.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth Capital Projects
Project Department VersionYear 5080-23-004 FINANCE - Asset Management Plan - Next Steps Finance Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 15 Total Weight 80 Budget 2023 Total Expenditures 70,000 70,000 Funding 70,000 70,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Legislative Requirement Parent Location 5080 Project Rating 85 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5080-23-003 FINANCE - Development Charges Review & Update
Finance Administration
1.Department Submission
VersionYear
Project Description
2023
Description
A Development Charges Background Study was completed and implemented in August of 2019. With the significant growth in North Perth and changes in legislation, consideration will be given to any potential amendments to address both matters and Bill 23 implications for capital funding. A request for proposal will be combined with the Asset Management plan work that need to be completed for 2024.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5080-23-003 FINANCE - Development Charges Review & Update Finance Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 15 Total Weight 75 Budget 2023 Total Expenditures 25,000 25,000 Funding 25,000 25,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Legislative Requirement Parent Location 5080 Project Rating 75 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Version Budget Year 1.Department Submission 2023
of North Perth Capital Projects by Priority within Department Forecast Periods 2023 Home Department IT Administration IT Administration Department 16-Mar-2023 10:07:11 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 69,40048,3005,60015,500 5082-23-001IT - Corporate Systems 92 30,00030,000 5082-23-003IT - Disaster Recover Site90 160,000160,000 5082-23-002IT - Governance Initiatives 40 20,00020,000 5082-23-004IT - Communication Building40 279,400258,3005,60015,500 Total IT Administration TotalMunicipality of North Perth 279,400258,3005,60015,500 Page No. : 1
Municipality
Project Department
Municipality of North Perth
Capital Projects
5082-23-001 IT - Corporate Systems Upgrades (Annual)
1.Department Submission
VersionYear
Project Description
2023
Description
1.Windows 11 Migration: To keep current and to limit our variations for operating systems maintenance, we will be migrating the remaining 140 personal computer units to Windows 11. The upgrade software is no additional cost and staff time will be added to IT operating hours.
2.Date Security: This has been an ongoing effort for the IT Department. Additional data protection and data loss systems will be deployed with an initial cost of $55,000 which will transfer to an annual operating licensing cost of $55,000/annum to maintain.
3.Firewall Upgrades- The firewall upgrades are critical to the security of our network and systems. Estimated cost is $4,000.00.
4 Wi-Fi Upgrades - Upgrades are required to meet current demand on the system's usage for an estimated cost of $16,000 to be funded by Set7.
5.Supervisory Control and Data Acquisition (SCADA) Audit and Upgrade - The connectivity for the SCADA System needs to be reviewed and upgraded as needed to ensure a reliable and secure data flow from the Wastewater Treatment Plant to the network servers. Estimated cost for hardware is $15,500.
6.Laptop Acquisition - Estimated cost of $45,000 for 28 replacement laptops and estimated 7 new laptops, as needed. Sale of old equipment is estimated to provided revenues of $5,600.
Risk If Not Implemented Asset Management Asset Estimated Useful Life 5 New Asset Approximate Annual Operating Costs (Impact to Operating budget) 55000.00 Future Depreciation Budget Costs (Approximate) 12100.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5082-23-001 IT - Corporate Systems Upgrades (Annual) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 15 Total Weight 92 Budget 2023 Total Expenditures 69,400 69,400 Funding 69,400 69,400 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Annual Program Parent Location 5082 Project Rating 92 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Municipality of North Perth
Description
Project Descrtiption
Disaster recovery (DR) relies upon the replication of data and computer processing in an off-premises location not affected by the disaster. When servers go down because of a natural disaster, equipment failure or cyber attack, the Municipality needs to recover lost data from a second location where the data is fully backed up. IT is working the Manager of Facilities to locate an appropriate and discreet DR Site. The DR Site will utilize re-purposed servers and Storage Area Network (SAN). It is expected that some physical renovation and HVAC equipment will be required. After the site is prepared, IT staff will secure connectivity, plan the topology and install the server/SAN equipment. The estimated cost is $30,000. This is a very reasonable cost for a business continuity solution for North Perth.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Department VersionYear 5082-23-003 IT - Disaster Recover Site 1.Department Submission 2023
Capital Projects Project
Page No. : 1
Capital Projects Project Department VersionYear 5082-23-003 IT - Disaster Recover Site 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 28 Environmental/ Economic Impact (0 to 15) 12 Total Weight 90 Budget 2023 Total Expenditures 30,000 30,000 Funding 30,000 30,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Repair and Replacement Parent Location 5082 Project Rating 90 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Department
Municipality of North Perth
Capital Projects
5082-23-002 IT - Governance Initiatives (Annual)
1.Department Submission
VersionYear
Project Descrtiption
2023
Description
The $160,000 is for IT project support funding and earmarked for the IT Governance Committee initiatives throughout the year. One of the projects identified is an online Programs Registration option which would be of significant benefit to both our customers and staff as per the Manager Programs' report. Other projects are expected to be recognized by the Committee throughout the year.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5082-23-002 IT - Governance Initiatives (Annual) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 2 Fits with The Strategic Plan (0 to 25) 23 Existing Assets/Condition/Capacity/Complaints (0 to 30) 10 Environmental/ Economic Impact (0 to 15) 5 Total Weight 40 Budget 2023 Total Expenditures 160,000 160,000 Funding 160,000 160,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Annual Program Parent Location 5082 Project Rating 40 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5082-23-004 IT - Communication Building
VersionYear
1.Department Submission
Project Descrtiption
2023
Description
The purpose of the building is to provide a cleaner, more spacious and secure area for communication equipment that is currently residing in the base of the water tower. The current situation needs remedy due to the poor environmental and safety factors as the room is getting crowded with equipment for both customers who rent space and our own gear. The budget is to fund engineering consultants for options and design.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5082-23-004 IT - Communication Building 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 2 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 5 Total Weight 40 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Growth Parent Location 5082 Project Rating 40 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Development and Protective Services
Version Budget Year 1.Department Submission 2023 Municipality of North Perth Capital Projects by Department Ranking Forecast Periods 2023 Home Department Fire Administration Fire Administration Department 15-Mar-2023 10:59:38 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 77,00077,000 5001-23-001FIRE - Fire Support Vehicle64 77,00077,000 Total Fire Administration TotalMunicipality of North Perth 77,00077,000 Page No. : 1
Project Department
Municipality of North Perth
Capital Projects
5001-23-001 FIRE - Fire Support Vehicle
Fire Administration
1.Department Submission
VersionYear
Project Description
2023
Description
The NPFD fleet currently includes a support vehicle at both the Listowel and Monkton stations. These vehicles are used to transport personnel and equipment to and from emergency scenes and to off site training sessions. A support vehicle is not currently assigned to the Atwood station. Without a support vehicle available, Atwood station personnel frequently use their personal vehicles to respond to emergencies, which can cause unnecessary congestion on scene and introduce contaminants into the firefighter's personal vehicle. Firefighters' use of personal vehicles for emergency purposes is not in keeping with industry best practices due to the potential health and safety and liability concerns. Pricing is for a hybrid vehicle, appropriately outfitted with an emergency response lights and sirens package.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 1000.00 Future Depreciation Budget Costs (Approximate) 5133.00 Page No. : 1
Municipality of North Perth Capital Projects
Project Department VersionYear 5001-23-001 FIRE - Fire Support Vehicle Fire Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 11 Total Weight 64 Budget 2023 Total Expenditures 77,000 77,000 Funding 77,000 77,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5001 Project Rating 64 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Environmental Services
Municipality
Version Budget Year
Submission 2023
1.Department
of North Perth
Projects by Priority within Department Forecast Periods 2023
Department Waste Water Administration Waste Water Administration Department 16-Mar-2023 9:27:16 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 2,020,0002,020,000 5802WW - SRS/Clarifier 60 100,000100,000 5801WW - WWTP Waste Station 55 45,00045,000 5005-23-001WW - RAS Pump Replacement45 2,165,0002,165,000 Total Waste Water Administration TotalMunicipality of North Perth 2,165,0002,165,000 Page No. : 1
Capital
Home
Project Description

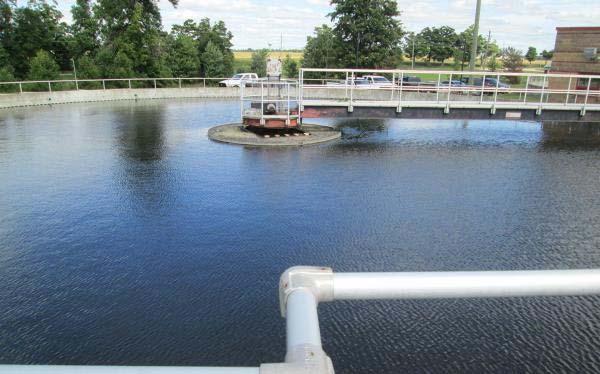

A project for upgrades at the Waste Water Treatment Plant (WWTP) is proposed that will span over 2023 and 2024. The first part of the proposed work is a complete refurbishment of the two existing secondary clarifiers, both of which are original from the construction of the plant in 1994. The work includes the following:
•Replacement of all internal equipment including the scrapping mechanism
•Replacement of all associated clarifier controls and equipment
•Addition of scum removal equipment
•Replacement/modification of existing valving and piping
The second part of the proposed work is a refurbishment/upgrade to the Septage Receiving Station (SRS) at the WWTP. The SRS entered service in 2006. In 2022, an condition assessment of the holding tank and equipment was completed by a consultant, and it was determined that several repairs and upgrades were required. The work includes the following:
•Addition of a grit separation tank to trap settleable solids prior to entering the holding tank
•Conversion of as existing mixing pump to a jet aerator pump to add oxygen to the tank contents
•Refurbishment of the existing biofilter unit for odour control
•Replacement of the auger for the solids handling equipment
•Re-coating the interior of the concrete tank to address pitting and minor structural issues, increasing the useful life of the holding tank.
•Odour Control system refurbishment
A single tender would be initiated for the proposed for the combined clarifier and Septage Receiving Station upgrades.
Project Department VersionYear 5802 WW - SRS/Clarifier Upgrades/Auger Replacement 1.Department Submission 2023 Description
Municipality of North Perth Capital Projects
Risk If Not Implemented Asset Management Asset Estimated Useful Life 40 New Asset Approximate Annual Operating Costs (Impact to Operating budget) Future Depreciation Budget Costs (Approximate) 50500 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5802 WW - SRS/Clarifier Upgrades/Auger Replacement 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 10 Total Weight 60 Budget 2023 Total Expenditures 2,020,000 2,020,000 Funding 2,020,000 2,020,000 Attributes Attribute Value Comment Attributes Department Wastewater Year Proposed 2023 Project Type Repair and Replacement Parent Location 5802 Project Rating 60 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5802 WW - SRS/Clarifier Upgrades/Auger Replacement 1.Department Submission 2023 Gallery C:\Users\mhackett\Pictures\Capital\Clarifier 1.png Page No. : 3
Municipality of North Perth Capital Projects Project Department VersionYear 5802 WW - SRS/Clarifier Upgrades/Auger Replacement 1.Department Submission 2023 Gallery C:\Users\mhackett\Pictures\Capital\SRS.png Page No. : 4
Municipality of North Perth
Capital Projects
Description
Project Description
The Waste Station is the on-site pumping station located at the WWTP. It's purpose is to pump all waste generated inside the building back to the head of the plant for treatment. This station is critical as it handles all of the filter backwash water. The station is original with the only minor repairs and upgrades taking place since the plan was opened. This upgrade will include replacement of pumps to a larger size to handle future loadings and associated piping along with electrical controls. This project is a carryover from the 2022 Capital Budget and was not able to be competed due to time for specifying proper pumping equipment by our consultant and product availability due to the Covid-19 pandemic.
5801
WWTP Waste Station
Project Department VersionYear
WW -
Upgrade 1.Department Submission 2023
Risk if Not Implemented Asset Management Asset Estimated Useful Life 30 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 3333 Page No. : 1
Capital
Project Department VersionYear 5801 WW - WWTP Waste Station Upgrade 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 5 Total Weight 55 Budget 2023 Total Expenditures 100,000 100,000 Funding 100,000 100,000 Attributes Attribute Value Comment Attributes Department Wastewater Year Proposed 2023 Project Type Repair and Replacement Parent Location 5801 Project Rating 55 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Projects
Municipality of North Perth
Capital
Project Description
A Return Activate Sludge Pump at the WWTP requires replacement. The pump that is being replaced is an original return activated sludge pump that was installed in 1993. Over the past two years we have replaced the other two original return activated sludge. This will complete the change out of all the original return activated sludge pumps.
Department VersionYear 5005-23-001 WW - RAS Pump Replacement
Projects Project
1.Department Submission 2023 Description
Risk if Not Implemented Asset Management Asset Estimated Useful Life 30 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1500 Page No. : 1
Capital Projects Project Department VersionYear 5005-23-001 WW - RAS Pump Replacement 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 5 Total Weight 45 Budget 2023 Total Expenditures 45,000 45,000 Funding 45,000 45,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5005 Project Rating 45 Strategic Strategic Plan Link Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Home
Version Budget Year
Submission 2023
1.Department
Periods 2023
Capital Projects by Priority within Department Forecast
Department Water Administration Water Administration Department 16-Mar-2023 9:27:40 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 1,550,0001,550,000 5800-23-001WATER- 2023 Water Meter 65 25,00025,000 5804WATER - Hydrogeological 65 50,00050,000 5004-23-001WATER - Water Tower Cleaning 50 100,000100,000 5806WATER - Bulk Water Station45 1,725,0001,700,00025,000 Total Water Administration TotalMunicipality of North Perth 1,725,0001,700,00025,000 Page No. : 1
Project Department
Municipality of North Perth
Capital Projects
5800-23-001 WATER- 2023 Water Meter Replacement
VersionYear
1.Department Submission 2023 Description
Project Description
The Municipality has over 4,500 water customers. Of these customers, more than 60% of the existing water meters have reached or have surpassed their useful life. As water meters age they become less accurate resulting in less revenue generation. Water meters were originally installed in existing homes and businesses in 2005 which means that in 2023, the original meters will be 18 years old.
Since 2005, water meter and remote reading technology has advanced, which improves both the accuracy of the reads and the ease at making the reads. Technology now exists that allows an advanced metering infrastructure (AMI) reading system to read multiple brands of water meters, allowing competitive pricing for water meters, which over time may result in substantial savings.
In 2022 the Request for Proposal (RFP) for an AMI system and Water Meter Replacement Program was awarded to Neptune Technology Group. In 2023 installation of the network equipment for the AMI system and water meter replacement program will commence. The AMI System will allow customers to receive a dashboard of information not previously available. One of these features will include the ability to receive real time alerts for a continuous leaks within your household. .
As water meters are used for billing of wastewater services as well as water services, the project cost is split between the Water and Wastewater Reserves.
Risk If Not Implemented Reason Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating budget) Future Depreciation Budget Costs (Approximate) 77500.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5800-23-001 WATER- 2023 Water Meter Replacement 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 10 Total Weight 65 Budget 2023 Total Expenditures 1,550,000 1,550,000 Funding 1,550,000 1,550,000 Attributes Attribute Value Comment Attributes Department Water Year Proposed 2023 Project Type Repair and Replacement Parent Location 5800 Project Rating 65 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5800-23-001 WATER- 2023 Water Meter Replacement 1.Department Submission 2023 Gallery C:\Users\mhackett\Pictures\Capital\AMIInfrastructure (1).png Page No. : 3
Municipality of North Perth
Capital Projects
Project Department VersionYear
5804 WATER - Hydrogeological Assessment - Atwood Water System
Project Description
Atwood has experienced significant growth in the past few years, and there is an expectation that this growth will continue in the future. Plans for providing water throughout all of Atwood, including the installation of fire hydrants are being developed. The Atwood Water System does not currently produce enough water to meet needs for hydrant based fire protection. The water system is bound by a Permit to Take Water, issued by the MECP. This permit details how much water we are able to take from the ground per day and at what rate. A Hydrogeological (Groundwater) Assessment will need to be undertaken as a first step in the process to have our permit re-evaluated in the future. A hydrogeological consultant will be retained to perform the required testing and analysis.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
1.Department Submission 2023 Description
Page No. : 1
Project Department VersionYear 5804 WATER - Hydrogeological Assessment - Atwood Water System 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 10 Total Weight 65 Budget 2023 Total Expenditures 25,000 25,000 Funding 25,000 25,000 Attributes Attribute Value Comment Attributes Department Water Year Proposed 2023 Project Type Growth Parent Location 5804 Project Rating 65 Strategic Strategic Plan Link Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5004-23-001 WATER - Water Tower Cleaning & Inspection
1.Department Submission
VersionYear
Project Descrtiption
2023
Description
An ROV (Remote Operated Vehicle), Structural, Coatings, and Safety Inspection was completed on the Listowel Water Tower in 2022. The report indicated that a water tower interior cleaning is required for 2023. This will include the cleaning of any sediment that is built up at the bottom and allow for a more thorough inspection of the interior coatings. This is a standard maintenance practice and something that is completed every few years. The report also indicated that the current fall arrest system no longer meets CSA certification and will need to be replaced as part of this project, as well as a few additional safety upgrades. An exterior washing of the water tower is also planned. The work will be completed by Landmark Municipal Service who are considered the experts as they are the company that designed, built, and have completed most maintenance through the current lifecycle of the Listowel Water Tower.
Risk If Not Implemented Asset Management Asset Estimated Useful Life 50 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1000.00 Page No. : 1
Project Department VersionYear 5004-23-001 WATER - Water Tower Cleaning & Inspection 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 5 Total Weight 50 Budget 2023 Total Expenditures 50,000 50,000 Funding 50,000 50,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5004 Project Rating 50 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5004-23-001 WATER - Water Tower Cleaning & Inspection
VersionYear
1.Department Submission 2023 Gallery
C:\Users\mhackett\Pictures\Water Tower 2.jpg
Page No. : 3
Municipality of North Perth
Capital Projects
Description
Project Descrtiption
The Municipality currently has a bulk water filling hydrant located at 580 Main Street West in the water tower compound. There are multiple customers that use this service. Services include pool filling, dust control, and tanked water for street sweeping etc. The water is metered through the summers months and estimated by haulers through winter months. This is done through the honor sytem with all haulers. In recent years many municpalities have moved to an automated bulk water solution. This project will include procuring and installing a bulk water despencing station in place of the current hydrant that is used. The station will consist of a small enclosed, heated structure that will house a meter, backflow devise, electrical hardware, and other associated equipment. Once completed, all approved haulers will be given an access card or code that will allow for them to fill at the station.This will automate the billling process and ensure that all water is being metered, and also provide additional security to the water system.
Risk
Project Department VersionYear 5806 WATER - Bulk Water Station Water Administration
1.Department Submission 2023
Implemented
for a more secure and accurate billing Asset Management Asset Estimated Useful Life 25 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 4000.00 Page No. : 1
If Not
Allows
Municipality of North Perth Capital Projects
Project Department VersionYear 5806 WATER - Bulk Water Station Water Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 5 Total Weight 45 Budget 2023 Total Expenditures 100,000 100,000 Funding 100,000 100,000 Attributes Attribute Value Comment Attributes Department Water Year Proposed 2023 Project Type Repair and Replacement Parent Location 5806 Project Rating 50 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5806 WATER - Bulk Water Station Water Administration 1.Department Submission 2023 Gallery C:\Users\mhackett\Pictures\Capital\Bulk water station.jpg Page No. : 3
Operations
Version Budget Year
Submission 2023
1.Department
Priority
Department Forecast Periods 2023
Department Roads Administration Roads Administration Department 16-Mar-2023 10:06:37 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 30,00030,000 5003-23-004PW - Storm Bridge/Culvert - 79 1,225,000918,750306,250 5604PW - Louise Ave North 79 1,902,0001,902,000 5605PW - Elma St North (Victoria to 79 1,701,0001,701,000 5606PW - Elm Ave North (Main to 79 70,00070,000 5609PW - Listowel Downtown 78 579,000579,000 5601-23-002PW - NEDL Phase 2 76 98,00023,00075,000 5602PW Carryover - Atwood Core 76 26,00026,000 5001-23-007PW - Radio Upgrades74 194,000194,000 5080-23-002PW Carryover - Master Servicing 74 49,00049,000 5612PW Carryover - Binning St 74 70,00035,00035,000 5603PW- Proposed Truck Route73 736,000736,000 5003-23-001PW - Storm Bridge/Culvert - 71 56,00056,000 5007-23-001PW - Sidewalks Sarah Street71 7,055,0007,055,000 5601-23-001PW - NEDL Phase 1 Walton 71 72,00072,000 5080-23-001PW Carryover - Transportation 70 535,000535,000 5611PW - 71112 Elma Street Bridge 68 185,000138,75046,250 5607PW - Tremaine Ave South67 15,00014,250750 5600PW - York Ave N Resurfacing65 425,000382,50042,500 5001-23-004PW - Replacement - 81481 64 15,00015,000 5003-23-003PW - Storm Bridge/Culvert - 64 193,000173,70019,300 5001-23-003PW - Replacement - 76264 63 400,000200,000200,000 5002-23-001PW - Ongoing Re-construction 63 65,00065,000 5002-23-002PW - Monkton - Station Street 63 21,00021,000 5003-23-002PW - Storm Bridge/Culvert 62 45,00045,000 5003-23-005PW - Storm Bridge/Culverts - 62 57,70057,700 5610PW - Nelson Ave62 225,000225,000 5002-23-005PW - Barber Avenue (McDonald 59 96,00096,000 5001-23-002PW - New 3/4 Ton Truck - 56 150,000142,5007,500 5002-23-006PW - Road Widening Rebuild 56 22,00022,000 5002-23-007PW - Arthur St Trowbridge55 17,00017,000 5608PW - Road Widening 23 @ 53 56,00056,000 5002-23-004PW - Line 81 Chip/seal (Rd 169 48 Page No. : 1
Municipality of North Perth Capital Projects by
within
Home
Version Budget Year 1.Department Submission 2023
of North Perth Capital Projects by Priority within Department Forecast Periods 2023
Department Roads Administration Roads Administration Department 16-Mar-2023 10:06:37 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 112,000112,000 5002-23-003PW - Road 169 Chip/seal (Line 47 16,497,70015,386,150911,550200,000 Total Roads Administration TotalMunicipality of North Perth 16,497,70015,386,150911,550200,000 Page No. : 2
Municipality
Home
Project Department
Municipality of North Perth
Capital Projects
5003-23-004 PW - Storm Bridge/Culvert - 071023 Box Culvert Line 71
1.Department Submission
VersionYear
Project Description
071023 Box Culvert - Line 71
2023
Description
Replacement of the culvert is recommended, the condition index for the structure sits at 37 with replacement recommended in the 5year window following the 2021 OSIM inspections.
Pre-Engineering and soils work are planned in 2023. Replacement of the culvert is planned in 2024
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5003-23-004 PW - Storm Bridge/Culvert - 071023 Box Culvert Line 71 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 9 Total Weight 79 Budget 2023 Total Expenditures 30,000 30,000 Funding 30,000 30,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5003 Project Rating 79 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Description
Project Description

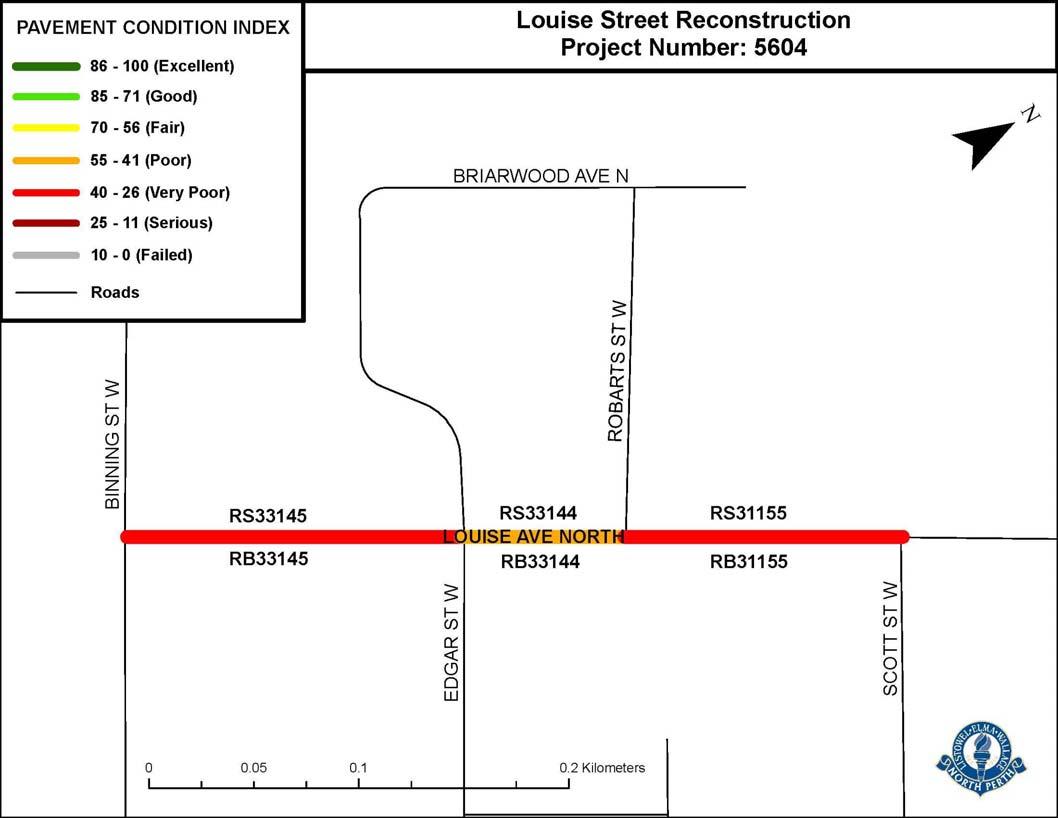

Louise Ave. is proposed as a partial reconstruction where the water and sanitary will remain in place and the storm system and road will be rebuilt to North Perth Urban standards. curbs and sidewalk are a key component and are planned for. An open house was held for the project and tendering/construction is tentatively planned for July to September of this year. Contractor availability will play a role in the timing of construction, it is hoped that the construction will be conducted in the summer holiday window to avoid conflict with school activities.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Project Department VersionYear 5604 PW - Louise Ave North Construction 1.Department Submission 2023
Capital Projects
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5604 PW - Louise Ave North Construction 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 29 Fits with The Strategic Plan (0 to 25) 18 Existing Assets/Condition/Capacity/Complaints (0 to 30) 26 Environmental/ Economic Impact (0 to 15) 6 Total Weight 79 Budget 2023 Total Expenditures 1,225,000 1,225,000 Funding 1,225,000 1,225,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5604 Project Rating 79 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5604 PW - Louise Ave North Construction 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5604 Louise Street.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects

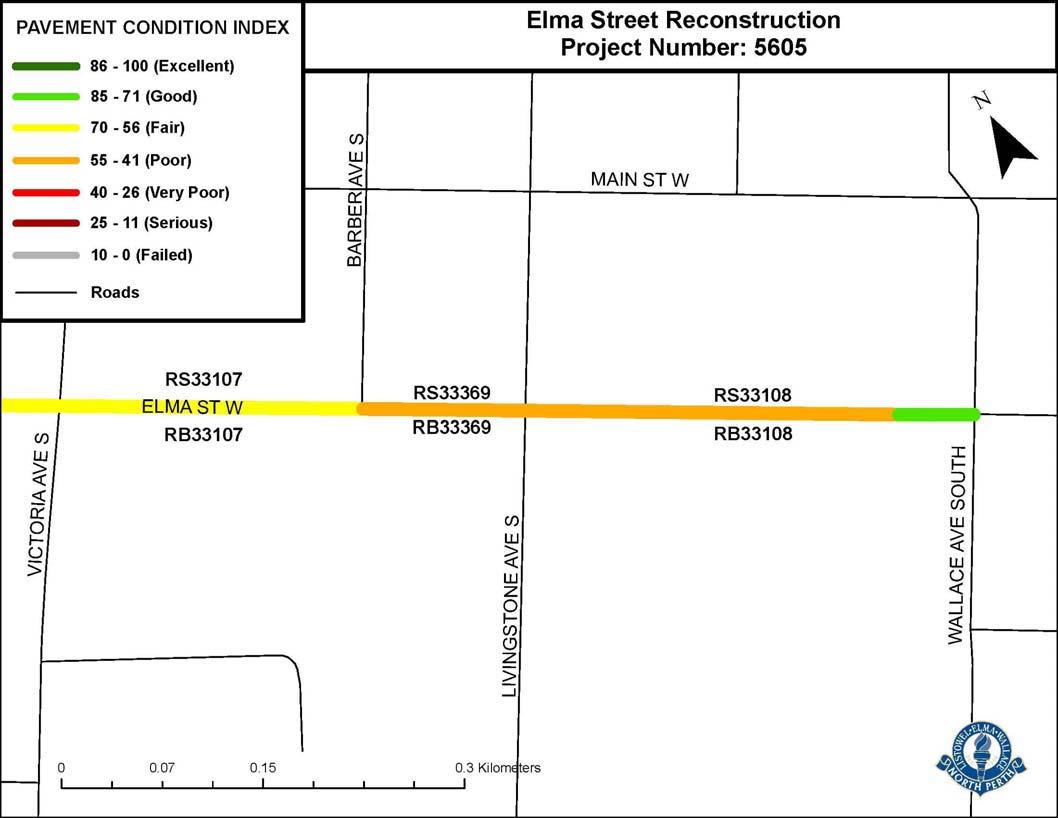

5605 PW - Elma St North (Victoria to Wallace)
1.Department Submission
VersionYear
2023 Description
Project Description
The project involves the full reconstruction of the blocks of Elma from Victoria Street to Wallace Ave. S. Water, sanitary and storm servicing will be rebuilt and the roadway brought to our current North Perth development standards. Major rehabilitation to the Elma Street Bridge L-4 is also included in this project. The bridge costs are represented in the Bridge and Culvert section of the capital program. Council had approved the design and survey work for the project in 2022 and the 2023 work will include tendering in March/April with an expectation of construction as soon as practical after award. An open house was held in February for the project.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5605 PW - Elma St North (Victoria to Wallace) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 23 Fits with The Strategic Plan (0 to 25) 19 Existing Assets/Condition/Capacity/Complaints (0 to 30) 26 Environmental/ Economic Impact (0 to 15) 11 Total Weight 79 Budget 2023 Total Expenditures 1,902,000 1,902,000 Funding 1,902,000 1,902,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5605 Project Rating 79 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5605 PW - Elma St North (Victoria to Wallace) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5605 Elma St West.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects

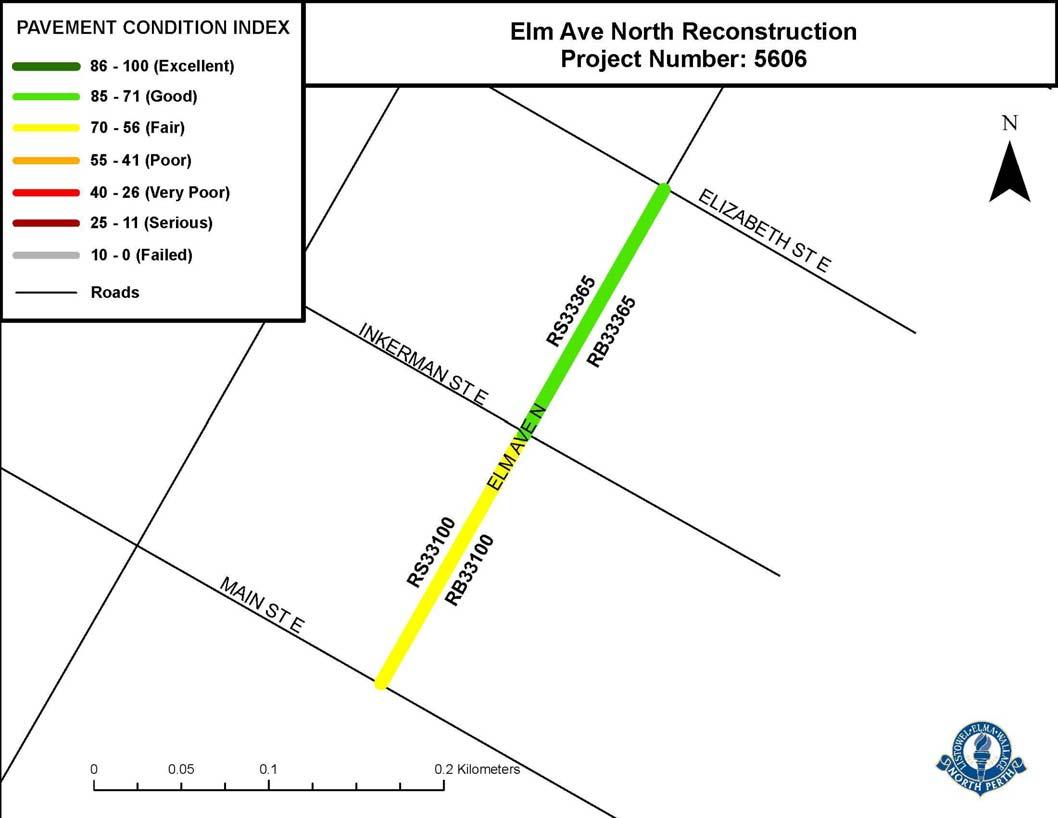

5606 PW - Elm Ave North (Main to Elizabeth)
1.Department Submission
VersionYear
Project Description
2023
Description
Elm Street reconstruction was driven by a sump in the main sanitary line on the Street which impedes sanitary flows. The blocks from Main Street to Elizabeth are within the reconstruction zone. All servicing will be replaced and the road will be built to the municipal urban standard with curb and gutter. The project was designed in 2022 and is slated to be out for tender and awarded in April. Construction is anticipated for summer of 2023.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5606 PW - Elm Ave North (Main to Elizabeth) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 26 Fits with The Strategic Plan (0 to 25) 18 Existing Assets/Condition/Capacity/Complaints (0 to 30) 28 Environmental/ Economic Impact (0 to 15) 7 Total Weight 79 Budget 2023 Total Expenditures 1,701,000 1,701,000 Funding 1,701,000 1,701,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5606 Project Rating 83 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth Capital Projects Project Department VersionYear 5606 PW - Elm Ave North (Main to Elizabeth) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5606 Elm Ave North.jpg Page No. : 3
Project Descrtiption
A review of the original design for core revitalization in Listowel is needed. The core infrastructure is ageing, some infrastructure is in nominal condition (watermain) making the core revitalization project a planning priority. Review and updating is needed as the process will have a long lead in time with planning and consultation with stakeholders before construction.
A consultant will need to be assigned the task of reviewing the design and estimating the current value of construction for the overall project. Recommendations on phasing of work, identifying any additional studies or investigation needed as well as traffic and parking implications of the design are required.
This work is needed in order to allow Council to make informed decisions on both the timing of core upgrades and if other works and consultation is needed prior to any planned construction.
Risk
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Capital Projects Project Department VersionYear 5609 PW - Listowel Downtown Reconstruction & Revitilization 1.Department Submission 2023 Description
Municipality of North Perth
If Not Implemented
Page No. : 1
Capital Projects Project Department VersionYear 5609 PW - Listowel Downtown Reconstruction & Revitilization 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 23 Existing Assets/Condition/Capacity/Complaints (0 to 30) 28 Environmental/ Economic Impact (0 to 15) 5 Total Weight 78 Budget 2023 Total Expenditures 70,000 70,000 Funding 70,000 70,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5609 Project Rating 78 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Description
Project Descrtiption
Work for Phase 2 of the North East Developing lands is the larger of the phases including the Moore Farms area as well as Wallace Industrial servicing. Phase 2 is currently underway in 2023 with necessary planning applications and studies underway.
Work ongoing and planned in the phase includes, planning, engineering as well as legal work. Studies including Noise, Archeological, Environmental and Traffic. Studies are estimated at $42,000. The municipality is sharing some study costs with the neighbouring development as both parcels are moving forward at the same timeline. Study costs are reduced due to the efficencies and scale of the work.
Engineering, if brought to final design, is budgeted at $375,000.
Additional easement work and legal/survey fees are budgeted at $43,000
A portion of phase 2 water main is necessary to be constructed in 2023 as commercial development on Fairlane Road is expected in 2023. The estimate for the construction is $119,000. Risk
Department
5601-23-002 PW - NEDL Phase 2 Commercial/Industrial Subdivision
Submission
Capital Projects Project
VersionYear
1.Department
2023
If Not Implemented Asset Management Asset Estimated Useful Life New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) Page No. : 1
Project Department VersionYear 5601-23-002 PW - NEDL Phase 2 Commercial/Industrial Subdivision 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 28 Fits with The Strategic Plan (0 to 25) 17 Existing Assets/Condition/Capacity/Complaints (0 to 30) 26 Environmental/ Economic Impact (0 to 15) 5 Total Weight 76 Budget 2023 Total Expenditures 579,000 579,000 Funding 579,000 579,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5601 Project Rating 76 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Municipality of North Perth
Capital Projects
Project Description
Atwood Core and water main upgrades continue to be staged behind the MTO resurfacing work. As the subdivisions are now seeing occupancies, the planning of upgraded flow and looping of water main is proposed to be finalized in 2023.
The resurfacing program for MTO may be pushed out to 2025 or 2026. The installation of water main along Highway 23 as previously proposed should move forward to detailed design a potentially independent project. This will require that the 3 lane configuration approved by North Perth Council and other design cross sections that have been submitted to the MTO be accepted by them prior to any construction. Staff is anticipating that this approval will be coordinated in 2023.
By bringing the water main installation on Main St. to final design it would be ready for construction in 2024. This work would not include the majority of utility work and pole removals previously discussed on the west side of the highway but would move the needed underground works forward and limit the complexity of the project and its crossover with MTO activities. Curb and sidewalk along the east side of Main would be included in this part of the design. Additional water main along Line 75 Monument road would be included in the the proposed design.
The budget is set to provide for further utility and soils information to be provided as well as survey and primarily engineering work that is needed for final designs for the project.
Project Department VersionYear 5602 PW Carryover - Atwood Core Revitilization and Water 1.Department Submission 2023
Description
Risk If Not Implemented Asset Management Asset Estimated Useful Life New Asset Approximate Annual Operating Costs (Impact to Operating budget) Future Depreciation Budget Costs (Approximate) Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5602 PW Carryover - Atwood Core Revitilization and Water 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 21 Existing Assets/Condition/Capacity/Complaints (0 to 30) 27 Environmental/ Economic Impact (0 to 15) 8 Total Weight 76 Budget 2023 Total Expenditures 98,000 98,000 Funding 98,000 98,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Growth Parent Location 5602 Project Rating 76 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Descrtiption
The service provider for the 2way radios for Perth County and the lower tiers has put the municipalities on notice that the frequency will not longer be capable of being supported after 2023. The County was notified recently and discussions have started with all involved as to how to best replace the existing radio systems most cost effectively. Cost is not known as the issue is only starting to be investigated. North Perth has over 45 mobile and stationary radios in operation at Public Works and Environmental Services. Not all radios are expected to be replaced. The cost is an estimate at the time of this report, Council will be updated as a solution or solutions are identified.
Department VersionYear 5001-23-007 PW - Radio Upgrades 1.Department Submission 2023
Capital Projects Project
Description
Risk If Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1300.00 Page No. : 1
Project Department VersionYear 5001-23-007 PW - Radio Upgrades 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 27 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 74 Budget 2023 Total Expenditures 26,000 26,000 Funding 26,000 26,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5001 Project Rating 74 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5080-23-002 PW Carryover - Master Servicing Plan
1.Department Submission
VersionYear
Project Description
2023
Description
This is the 2nd year of the project. The project follows the Class EA process and applies to the mapping and modeling of the storm, sanitary, and water systems in Listowel and Atwood. Data gathering has been completed, additional survey and data collection in both Listowel and Atwood took place in 2023. Much of this work and the remaining work is set at $194,000. The completion of the Plan is expected by year end 2023 and will accurately map the infrastructure, deficiencies and capacities in the water and storm systems as well as update the sanitary system information. An update the GIS data also included.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5080-23-002 PW Carryover - Master Servicing Plan 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 18 Fits with The Strategic Plan (0 to 25) 23 Existing Assets/Condition/Capacity/Complaints (0 to 30) 23 Environmental/ Economic Impact (0 to 15) 10 Total Weight 74 Budget 2023 Total Expenditures 194,000 194,000 Funding 194,000 194,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Annual Program Parent Location 5080 Project Rating 74 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5612 PW Carryover - Binning St Reconstruction
1.Department Submission
VersionYear
Project Description
2023
Description
The reconstruction of Binning Street W from Wallace Ave to Victoria is needed, underground infrastructure as well as all surface infrastructure is in poor condition. Survey work has been initiated for construction in 2024. Through a motion in Council an engineering firm was secured for the work in 2022.
It is anticipated that the project will be tendered in April 2023. Construction budgets will be set and a tender will be released in early 2024.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5612 PW Carryover - Binning St Reconstruction 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 26 Environmental/ Economic Impact (0 to 15) 6 Total Weight 74 Budget 2023 Total Expenditures 49,000 49,000 Funding 49,000 49,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5612 Project Rating 74 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Department
Project Description
Municipality of North Perth
Capital Projects
Description
The TMP and Truck Route will move into the final stages of the Master Plan process in April to June of 2023. Once accepted by Council, a staged plan for establishing portions of the truck route would need to be established and agreed to. Preliminary work on sections will include survey work and consultation with the municipal engineer on a build plan and scope. The budget allows for this work to be completed after the TMP is accepted and if Council directs to move forward with the Truck Route proposals. An estimated 45,000 in Engineering fees, 10,000 in survey works and 15,000 in legal fees are high level costs understood as potentially needed to move forward.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
VersionYear 5603 PW- Proposed Truck Route 1.Department Submission 2023
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5603 PW- Proposed Truck Route 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 14 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 22 Environmental/ Economic Impact (0 to 15) 12 Total Weight 73 Budget 2023 Total Expenditures 70,000 70,000 Funding 70,000 70,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Growth Parent Location 5603 Project Rating 73 Strategic Strategic Plan Link Community Planning Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5003-23-001 PW - Storm Bridge/Culvert - 088013 Box Culvert Line 88 (71098)
VersionYear
1.Department Submission 2023
Description
Project Descrtiption
088013 Box Culvert - Line 88
This box culvert lies west of Wallaceview on Line 88 with a condition rating of 45.
Preliminary engineering and soils work were conducted in 2022/23. Replacement of the culvert is needed in 2023 in advance of road rebuilding planned for 2024.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5003-23-001 PW - Storm Bridge/Culvert - 088013 Box Culvert Line 88 (71098) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 18 Existing Assets/Condition/Capacity/Complaints (0 to 30) 23 Environmental/ Economic Impact (0 to 15) 8 Total Weight 71 Budget 2023 Total Expenditures 736,000 736,000 Funding 736,000 736,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5003 Project Rating 71 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5007-23-001 PW - Sidewalks Sarah Street
VersionYear
1.Department Submission
Project Description
2023
Description
With proposed upgrades on the private lands on the block, the narrow and deteriorated sidewalk on the west side of Sarah Street can be replaced and widened to standard where possible. Depending on the upgrade timing, this money can be utilized for other longer sections of walkway in Listowel, Atwood, and Monkton where inspections show below standard panels. Risk
Asset Management Asset Estimated Useful Life 30 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1866.00 Page No. : 1
if Not Implemented
Municipality of North Perth
Capital Projects Project Department VersionYear 5007-23-001 PW - Sidewalks Sarah Street 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 27 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 9 Total Weight 71 Budget 2023 Total Expenditures 56,000 56,000 Funding 56,000 56,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5007 Project Rating Strategic Strategic Plan Link Community Planning Strategic Plan ID Page No. : 2
Municipality of North Perth
Capital Projects Project
Project Description
Description
This multi-year project includes the development of servicing on Walton Ave., Davidson and David Streets. The first phase included a sanitary pump station on David Street at Davidson. Construction was awarded to Moorefield Construction and initiated in the fall of 2022 and continues through the winter months. The construction of a force main, servicing and building of the new roadway on Walton as well as installation of the pump station will complete the work by late summer 2023. Final commissioning of the pump station is expected by October. Construction value for Phase 1 includes engineering and legal fees at 7,055,000.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Department
5601-23-001 PW - NEDL Phase 1 Walton St/Davidson Pump Station
Submission 2023
VersionYear
1.Department
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5601-23-001 PW - NEDL Phase 1 Walton St/Davidson Pump Station 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 16 Fits with The Strategic Plan (0 to 25) 23 Existing Assets/Condition/Capacity/Complaints (0 to 30) 22 Environmental/ Economic Impact (0 to 15) 10 Total Weight 71 Budget 2023 Total Expenditures 7,055,000 7,055,000 Funding 7,055,000 7,055,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5601 Project Rating Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5080-23-001 PW Carryover - Transportation Master Plan
1.Department Submission
VersionYear
Project Descrtiption
2023
Description
Work under this project included the Transportation Master Plan (TMP) as well as Wallace Ave. South traffic calming and the Truck Bypass Costs carrying forward involve the finalization of the DRAFT plan to council in April for a planned 60 day review period. Remaining project budget is set at $55.000 Consulting Engineering fees. The TMP is recommending additional studies, the parking study update is recommended as we move toward downtown revitalization of infrastructure in the future. An amount of $7,000 is listed and is listed for detailed traffic counts in the core as followup to the removal of the 1 way block trial on Wallace Ave. South. An additional 10,000 is allocated to policy, sign and study recommendations that are drafted in the TMP and will likely see costs in 2023 as a result.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Project Department VersionYear 5080-23-001 PW Carryover - Transportation Master Plan 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 22 Existing Assets/Condition/Capacity/Complaints (0 to 30) 21 Environmental/ Economic Impact (0 to 15) 7 Total Weight 70 Budget 2023 Total Expenditures 72,000 72,000 Funding 72,000 72,000 Attributes Attribute Value Comment Attributes Department Plans and Strategic Iniatives Year Proposed 2023 Project Type Annual Program Parent Location 5080 Project Rating Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5611 PW - 71112 Elma Street Bridge Rehabilitation
1.Department Submission
VersionYear
Project Description
2023
Description
The rehabilitation of the Elma Street bridge will be a part of the reconstruction of Elma Street West in 2023.
Work has already been initiated with a structural study of the bridge providing information on the integrity of the bridge. The municipal engineer has recommended that a rehabilitation and partial widening of the bridge can be achieved as part of the project and has provided the cost estimates.
The budget has been set by the estimate provided at $440,000. Additional water main and utility work has been added to the estimate.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5611 PW - 71112 Elma Street Bridge Rehabilitation 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 19 Existing Assets/Condition/Capacity/Complaints (0 to 30) 23 Environmental/ Economic Impact (0 to 15) 6 Total Weight 68 Budget 2023 Total Expenditures 535,000 535,000 Funding 535,000 535,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5611 Project Rating 68 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Description
Project Descrtiption
Pre Engineering work for Tremaine Ave South.
Several upgrades on the Tremaine Avenue corridor are required. Water and Sanitary servicing are in good condition along the corridor.
Upgrades to the storm collection system as well as the need to design sidewalk/multiuse trail and street lighting into the corridor are the primary needs for the upgrades. The project would include the section from Krotz to the Mowat Street Road allowance.
Connectivity of pedestrian and active transportation routing along the Mowat Street Road allowance is also considertations for the design work.
The removal of the current development of the Lunor subdivision has relieved some of the pressure on this project, however the pre engineering that is recommended in this budget remains listed as several of these deficiencies need to be addressed and construction planned.
Risk
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Department VersionYear 5607 PW - Tremaine Ave South 1.Department Submission 2023
Capital Projects Project
If Not Implemented
Page No. : 1
Municipality of North Perth
Capital
Project Department VersionYear 5607 PW - Tremaine Ave South 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 7 Total Weight 67 Budget 2023 Total Expenditures 185,000 185,000 Funding 185,000 185,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Growth Parent Location 5607 Project Rating Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
Project Department
Municipality of North Perth
Capital Projects
5600 PW - York Ave N Resurfacing
1.Department Submission
VersionYear
Project Description
2023
Description
York Avenue from Mcdonald Street East to the McDonalds rear entrance is currently a gravel roadway. Complaints regarding dust occur annually from residents on the street. Upgrading to an urban standard to define the roadway and reduce dust issues is needed. Some survey work as well as engineering design will be required in 2023 and are budgeted for. The project should have a budget and be tender ready for 2024/25.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5600 PW - York Ave N Resurfacing 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 5 Total Weight 65 Budget 2023 Total Expenditures 15,000 15,000 Funding 15,000 15,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Growth Parent Location 5600 Project Rating 74 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Project Description
The existing 2011 Elgin Megawind is an air sweeper. the fan unit has been rebuilt on 2 occasions and will be due again. There is value in the unit as a trade or auction item that may reduce the budget to the $400,000 range.
In talking with vendors deliveries for units are over a year away. Given the long delivery it is recommended that the tendering of the sweeper take place in 2023. The sweeper will not be fully amortized until 2026, however for the reasons listed, starting the tender process is recommended for 2023. A final decision will be brought back to Council later in 2023.
Department VersionYear 5001-23-004 PW - Replacement - 81481 Sweeper 1.Department Submission 2023
Capital Projects Project
Description
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) ? Future Depreciation Budget Costs (Approximate) 25870 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5001-23-004 PW - Replacement - 81481 Sweeper 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 17 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 12 Total Weight 64 Budget 2023 Total Expenditures 425,000 425,000 Funding 425,000 425,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Annual Program Parent Location 5001 Project Rating 64 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5003-23-003 PW - Storm Bridge/Culvert - 157067 Box Culvert - Rd 157
1.Department Submission
VersionYear
Project Descrtiption
157067 Box Culvert - Road 157
2023
Description
Replacement of the culvert is needed. Pre-engineering and soils work are planned in 2023 with replacement in 2024. The BCI for this structure was 40 in 2021. Replacement was recommended in the 5 year window.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5003-23-003 PW - Storm Bridge/Culvert - 157067 Box Culvert - Rd 157 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 4 Total Weight 64 Budget 2023 Total Expenditures 15,000 15,000 Funding 15,000 15,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5003 Project Rating 64 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Project Description
The Trackless was fully ammortized two years ago. A replacement unit is needed to replace the existing plow. Increases in sidewalk over the past 4 years have been significant particularly with the assumption of previously contracted routes in Monkton and Atwood. A new unit compatible with the existing trackless(s) and attachements will be purchased for compatibility with the fleet.
Project Department VersionYear 5001-23-003 PW - Replacement - 76264 Trackless 1.Department Submission 2023 Description
Capital Projects
Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) ? Future Depreciation Budget Costs (Approximate) 14000 Page No. : 1
Risk if Not
Municipality of North Perth
Capital Projects Project Department VersionYear 5001-23-003 PW - Replacement - 76264 Trackless 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 6 Total Weight 63 Budget 2023 Total Expenditures 193,000 193,000 Funding 193,000 193,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth 50/50 split growth and annual program? Parent Location 5001 Project Rating 63 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Description
Project Descrtiption
Ongoing rehabilitation of Line 140 is a shared project with Perth East. Historically this has been budgeted at $500,000 total per year with cost sharing at 50/50 for work conducted anually.
2023 w ork involves the replacement of a large structure as well as the removal and reuse of acceptable gravel from the surface of the road, removal of unacceptable soils and reinstatement with Both "B" and "A" gravel.
This joint project is expected to be completed in 2023. With the structure included, the cost increase in 2023 to $400,000 per municipality for 2023.

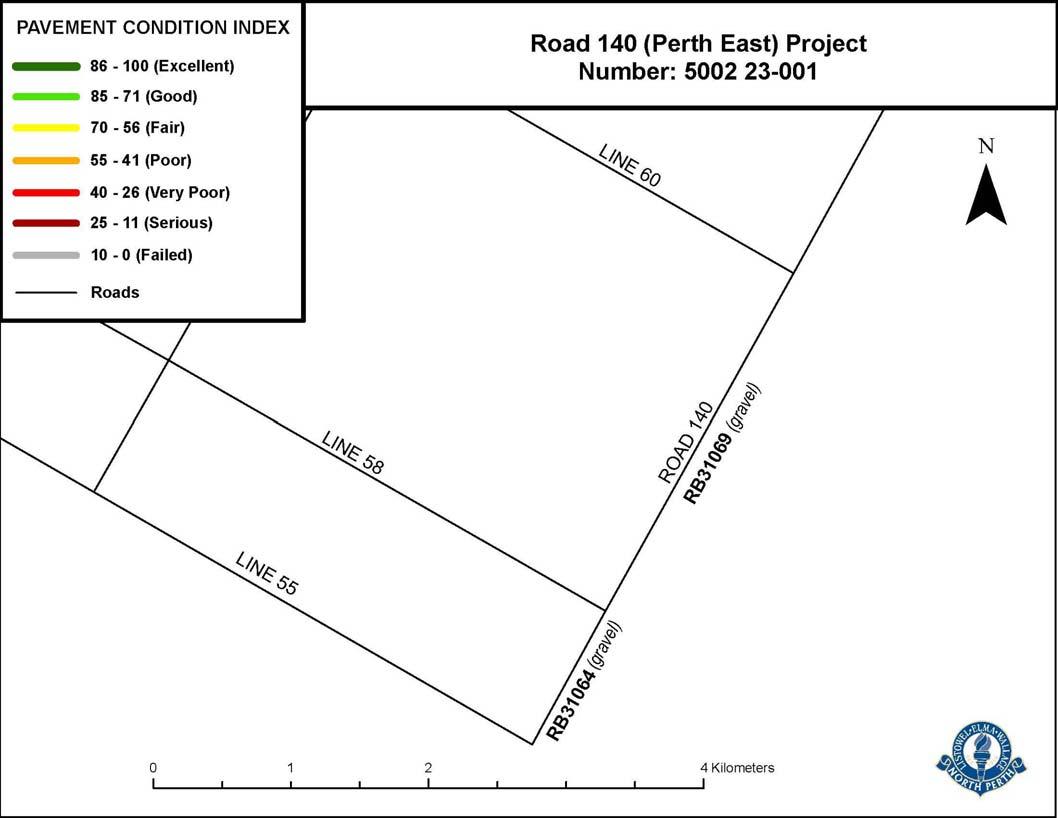

Department VersionYear 5002-23-001 PW - Ongoing Re-construction Rd 140 1.Department Submission 2023
Capital Projects Project
Risk If Not Implemented Asset Management Asset Estimated Useful Life 80 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 5000.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5002-23-001 PW - Ongoing Re-construction Rd 140 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 16 Fits with The Strategic Plan (0 to 25) 19 Existing Assets/Condition/Capacity/Complaints (0 to 30) 19 Environmental/ Economic Impact (0 to 15) 9 Total Weight 63 Budget 2023 Total Expenditures 400,000 400,000 Funding 400,000 400,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Annual Program Parent Location 5002 Project Rating 63 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-001 PW - Ongoing Re-construction Rd 140 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\5002 23-001 Road 140.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects
5002-23-002 PW - Monkton - Station Street (Rd 164 to Street limit)
1.Department Submission
VersionYear
Project Description
2023
Description
Market Street in Monkton is a Drain related project where municipal drain work will be conducted in and around the Market Street area. This project will involve a new asphalt surface and some related storm and catchbasin work.
If the Drain works are carried through as planned, the road and storm work will be contracted out for completion as well.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5002-23-002 PW - Monkton - Station Street (Rd 164 to Street limit) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 19 Environmental/ Economic Impact (0 to 15) 9 Total Weight 63 Budget 2023 Total Expenditures 65,000 65,000 Funding 65,000 65,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating 63 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5003-23-002 PW - Storm Bridge/Culvert -087125 Bridge Line 87 (71087) Roads Administration
VersionYear
1.Department Submission 2023
Description
Project Descrtiption
087125 bridge - Line 87
21,000 budget for 2023 for survey, soils and pre-engineering work on the culvert. Anticipated reconstruction will be in 2024. the 2021 Bridge Culvert Index for this structure was 55 and replacement was recommended in the next 5 year window.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5003-23-002 PW - Storm Bridge/Culvert -087125 Bridge Line 87 (71087) Roads Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 4 Total Weight 62 Budget 2023 Total Expenditures 21,000 21,000 Funding 21,000 21,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5003 Project Rating 62 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5003-23-005 PW - Storm Bridge/Culverts - <3m (2)
1.Department Submission
VersionYear
Project Description
2023
Description
An assessment of structures less than 3 meters was completed in 2021. Several culverts were ranked at or below standards in the assessment and a replacement program has been undertaken for the last two seasons. It is hoped that 2 culverts can be replaced each year as we upgrade these culverts, some are larger concrete structures. None fall in the regulatory bridge inspections.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5003-23-005 PW - Storm Bridge/Culverts - <3m (2) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 7 Total Weight 62 Budget 2023 Total Expenditures 45,000 45,000 Funding 45,000 45,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5003 Project Rating 62 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
VersionYear
Description
Project Description
Reconstruction of different infrastructure on Nelson from Main Street to Kincaid will be separated into two projects. Nelson from Main to Elma will involve potential repairs to the storm, sanitary and water systems as well an upgrade to a urban standard. The section of Nelson from Elma to Kincaid will full resurfacing and repairs to structures and some sections of curbline.
It is proposed that pre-engineering be initiated in 2023 with construction and resurfacing to be conducted in 2025 and 2027. The short block from Main to Elma is planned for reconstructed in 2025.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
5610
PW - Nelson Ave 1.Department Submission 2023
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5610 PW - Nelson Ave 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 19 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 8 Total Weight 62 Budget 2023 Total Expenditures 57,700 57,700 Funding 57,700 57,700 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Parent Location 5610 Project Rating Strategic Strategic Plan Link Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects

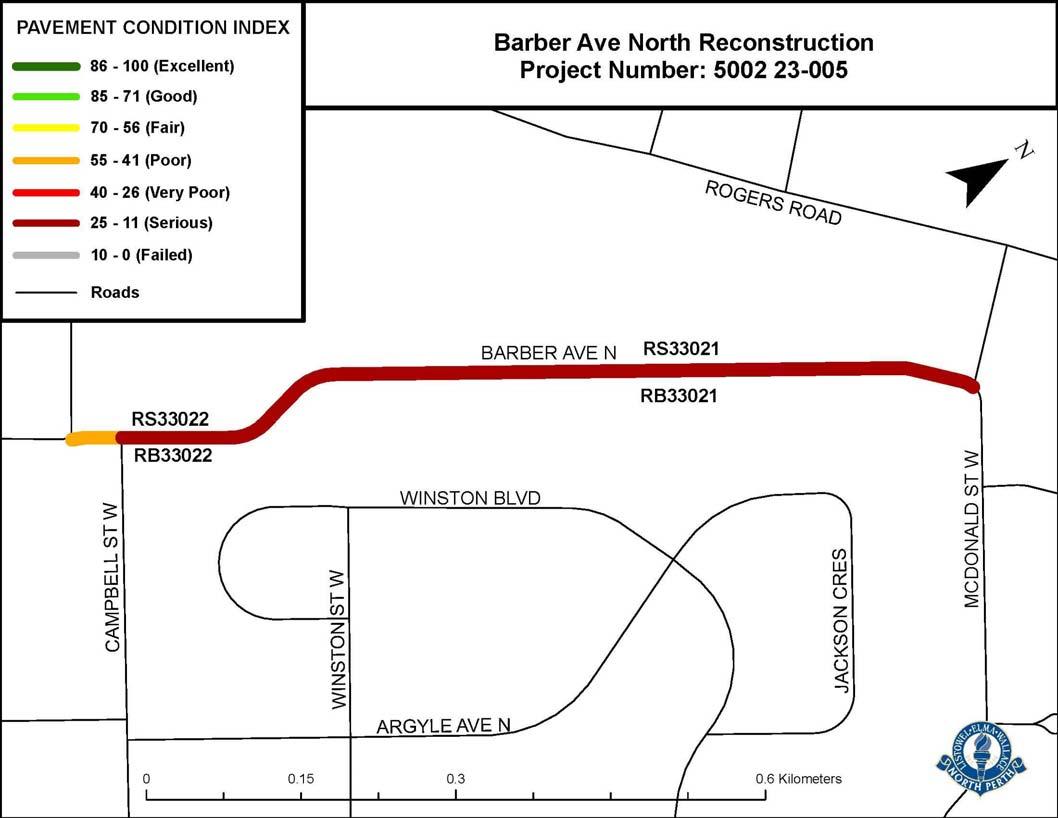

5002-23-005 PW - Barber Avenue (McDonald to Campbell)
1.Department Submission
VersionYear
Project Description
2023
Description
A resurfacing of Barber Street from McDonald St W to Cambell St W. where new top course asphalt will replace the existing surface.
Some repairs to structures and curbs are also included in the work. While the road ranked 30 out 100 for surface condition, the underground infrastructure is in good condition, which allows for a resurfacing project to be undertaken on the listed blocks.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth Capital
PW - Barber Avenue (McDonald to Campbell)
Project Department VersionYear
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 14 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 24 Environmental/ Economic Impact (0 to 15) 8 Total Weight 59 Budget 2023 Total Expenditures 225,000 225,000 Funding 225,000 225,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating 59 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
5002-23-005
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-005 PW - Barber Avenue (McDonald to Campbell) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5002 23-005 Barber Ave North Recon.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects
5001-23-002 PW - New 3/4 Ton Truck - Listowel
VersionYear
1.Department Submission 2023
Description
Project Description
The purchase of a 3/4 ton pickup primarily for the Listowel shop will provide extra towing capability at the shop for paint work as well as provide an additional lot and lane sander for smaller applications and areas. the price includes a 1-2 yard sander expected to be approximately $8,000. The additional vehicle will also provide for existing pickups to be fully available for patrol function in the winter.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5001-23-002 PW - New 3/4 Ton Truck - Listowel 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 17 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 15 Environmental/ Economic Impact (0 to 15) 9 Total Weight 56 Budget 2023 Total Expenditures 96,000 96,000 Funding 96,000 96,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5001 Project Rating 56 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects

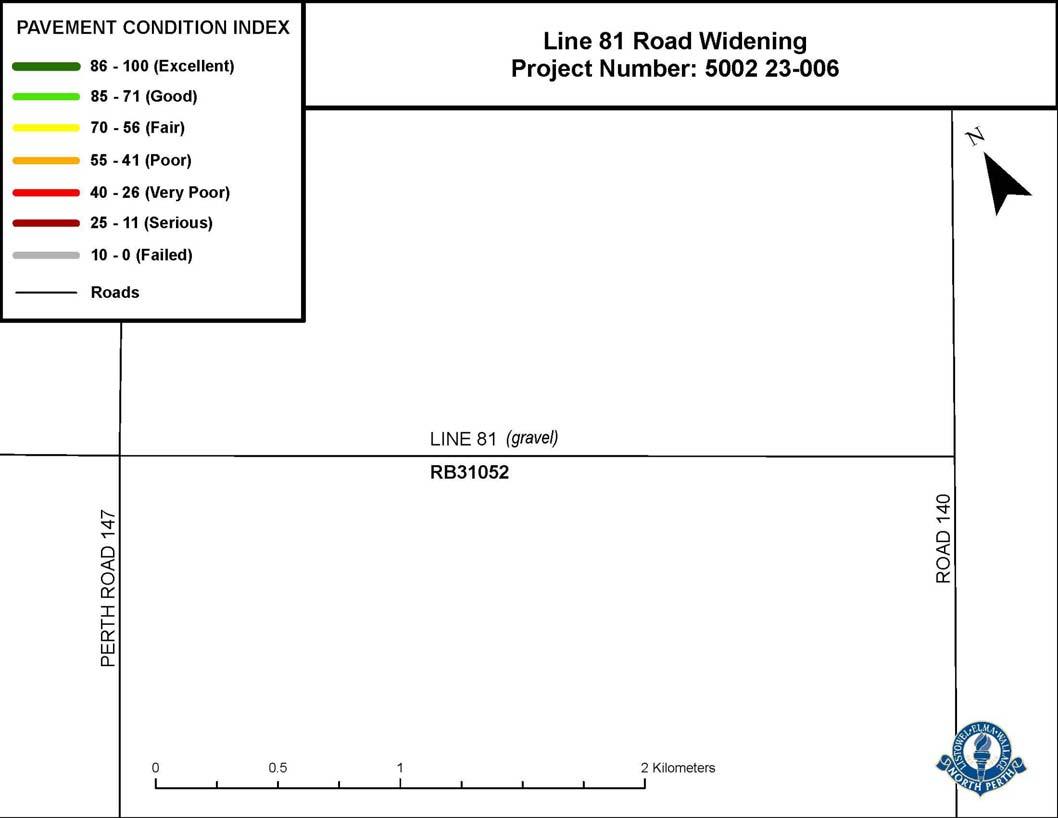

5002-23-006 PW - Road Widening Rebuild Line 81 (Britton to 140)
1.Department Submission
VersionYear
Project Description
2023
Description
Part of the road rebuilding efforts that see a wider safer platform being constructed on these rural sections.
The rebuild of this gravel section will see a minor height increase in some sections and will ensure a solid platform being built. The widening of the roadway is the primary goal of the project.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5002-23-006 PW - Road Widening Rebuild Line 81 (Britton to 140) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 16 Fits with The Strategic Plan (0 to 25) 21 Existing Assets/Condition/Capacity/Complaints (0 to 30) 12 Environmental/ Economic Impact (0 to 15) 7 Total Weight 56 Budget 2023 Total Expenditures 150,000 150,000 Funding 150,000 150,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-006 PW - Road Widening Rebuild Line 81 (Britton to 140) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5002 23-006 Line 81 Road Widening.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects

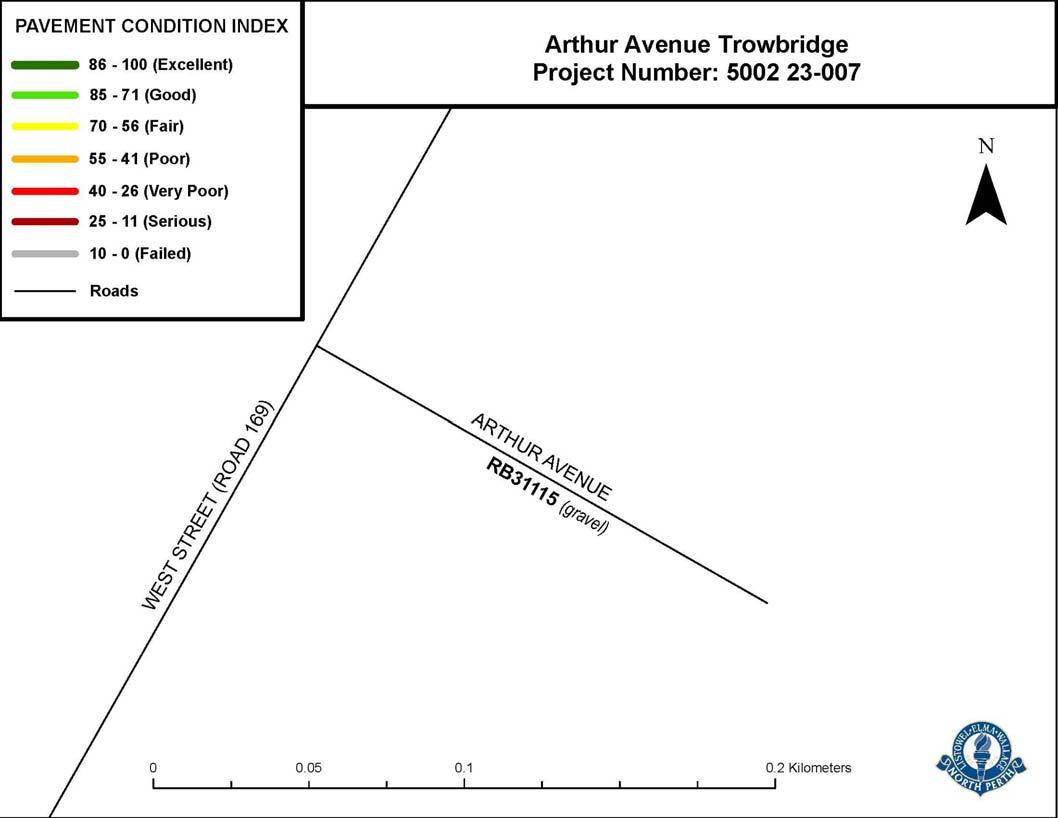

5002-23-007 PW - Arthur St Trowbridge
1.Department Submission
VersionYear
Project Description
2023
Description
Arthur Street in Trowbridge will need survey work as some private structures may be in the Right of Way. Once the road corridor is established and the project limits understood by neighbours, a hard top can be applied after ditching, grading and base preparation is completed. Staff is proposing a double chip seal coating be applied on the regraded surface of the roadway.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5002-23-007 PW - Arthur St Trowbridge 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 7 Total Weight 55 Budget 2023 Total Expenditures 22,000 22,000 Funding 22,000 22,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating 55 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-007 PW - Arthur St Trowbridge 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5002 23-007 Arthur Ave Trowbridge.jpg Page No. : 3
Municipality of North Perth
Project Descrtiption
This section of the connecting link Highway 23 south of Kincaid to Barnett Street will need upgrades once final traffic information and generation levels from the new developments are fully understood. A previous study from the developer expects some upgrades to this portion of the highway through the development. Further to this, the municipality may be required to provide some improvements to the road surface as well as the storm corridor running on the east side of the highway. It is most efficient and will create the least impact to motorists if the works at the same time. is of the highway.
The budget represents the use of the Municipal Engineering consultant on the project to provide comment and preliminary design for potential construction in 2024.
Risk If Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Project Department VersionYear 5608 PW - Road Widening 23 @ Westwood 1.Department Submission 2023
Capital Projects
Description
Page No. : 1
Capital Projects Project Department VersionYear 5608 PW - Road Widening 23 @ Westwood 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 9 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 15 Environmental/ Economic Impact (0 to 15) 9 Total Weight 53 Budget 2023 Total Expenditures 17,000 17,000 Funding 17,000 17,000 Attributes Attribute Value Comment Attributes Department Operations Year Proposed 2023 Project Type Repair and Replacement Parent Location 5608 Project Rating 53 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Department
Municipality of North Perth
Capital Projects

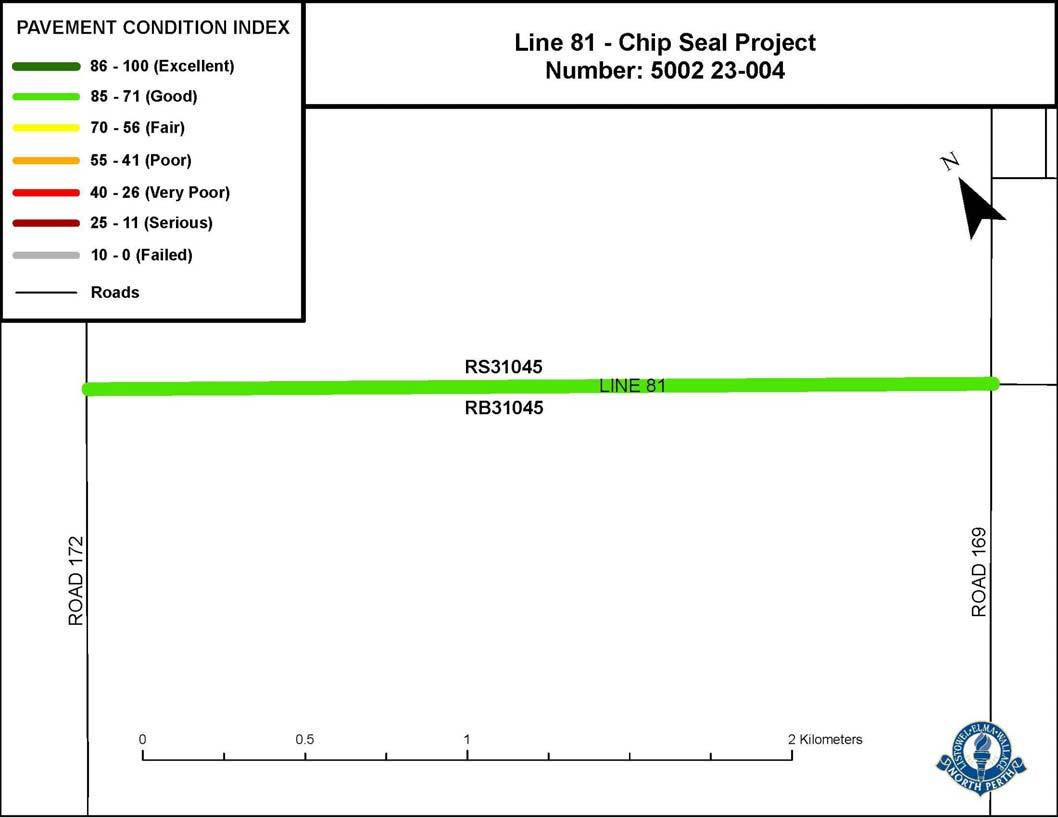

5002-23-004 PW - Line 81 Chip/seal (Rd 169 to Rd 173)
1.Department Submission
VersionYear
Project Description
Line 81 Chip Seal
2023
Description
As part of ongoing preservation work, this section of roadway will benefit from a surface treatment in order to extend usable life 5 to 7 years by protecting road surfaces with moderate distress and cracking evident. North Perth coordinates the work with several other neighbouring municipalities.
This is one of 2 sections of roadway included in this years program.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Capital Projects Project Department VersionYear 5002-23-004 PW - Line 81 Chip/seal (Rd 169 to Rd 173) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 14 Fits with The Strategic Plan (0 to 25) 12 Existing Assets/Condition/Capacity/Complaints (0 to 30) 18 Environmental/ Economic Impact (0 to 15) 4 Total Weight 48 Budget 2023 Total Expenditures 56,000 56,000 Funding 56,000 56,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating 48 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-004 PW - Line 81 Chip/seal (Rd 169 to Rd 173) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5002 23-004 Line 81 - Chip Seal.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects

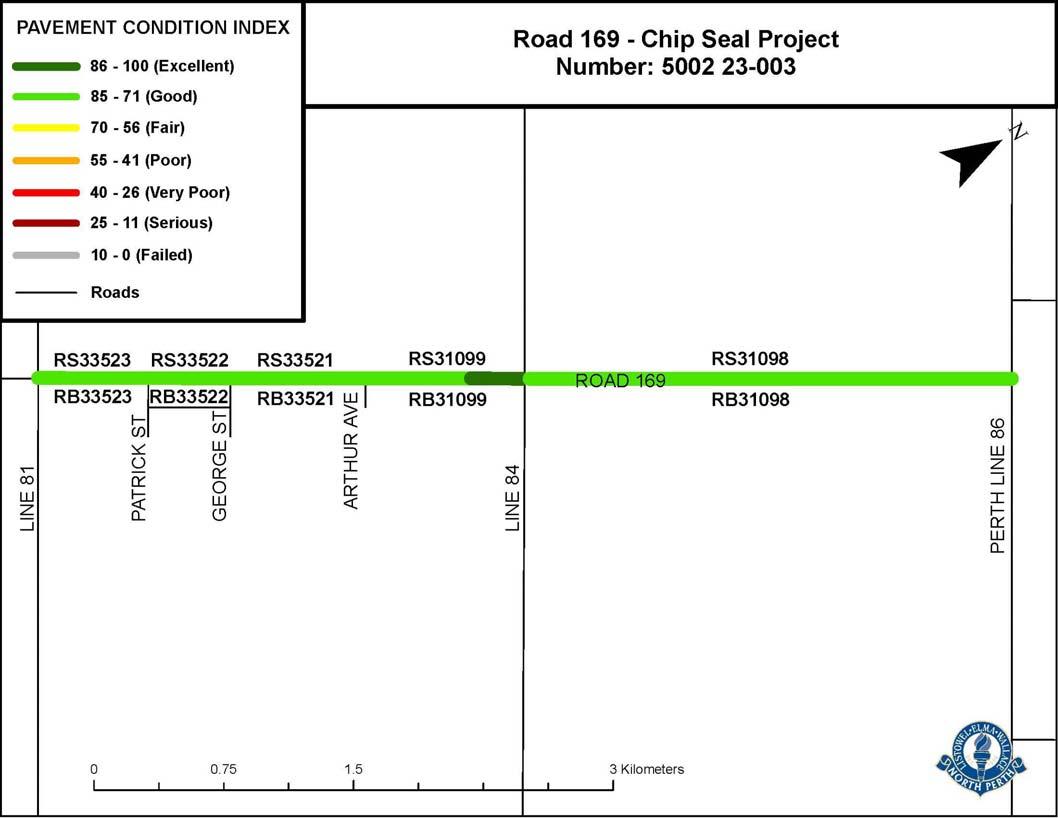

5002-23-003 PW - Road 169 Chip/seal (Line 86 to Line 81)
1.Department Submission
VersionYear
Project Description
Road 169 Chip Seal
2023
Description
As part of ongoing preservation work, this section of roadway will benefit from a surface treatment in order to extend usable life for an additional 5 to 7 years by protecting road surfaces with moderate distress and cracking evident.
North Perth coordinates the work with several other neighbouring municipalities.
This is one of 2 sections of roadway included in this years program.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5002-23-003 PW - Road 169 Chip/seal (Line 86 to Line 81) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 12 Fits with The Strategic Plan (0 to 25) 14 Existing Assets/Condition/Capacity/Complaints (0 to 30) 17 Environmental/ Economic Impact (0 to 15) 4 Total Weight 47 Budget 2023 Total Expenditures 112,000 112,000 Funding 112,000 112,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5002 Project Rating 47 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5002-23-003 PW - Road 169 Chip/seal (Line 86 to Line 81) 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Operations\Images\5002 23-003 Road 169 - Chip Seal.jpg Page No. : 3
Bridge and Culvert Projects
071023 (5003-23-004)
088013 (5003-23-001)
087125 (5003-23-007) L-4 Elma (5611)
LINE 88 PERTH LINE 86
157015 (5003-23-003)
LINE 87 ROAD 157 ROAD 165 LINE 81 LINE 75 ROAD 169 LINE 71 ROAD 164 (HWY 23) ROAD 146 ROAD 140 ¯ PERTH LINE 55 ROAD 164 (HWY 23) PERTH LINE 91 LINE 84 0 2 4 1 Kilometers PERTH LINE 86
PERTHLINE93 l
PERTHROAD178
Facilities
Version Budget Year 1.Department Submission 2023
Perth Capital Projects by Priority within Department Forecast Periods 2023 Home Department Facilities Administration Facilities Administration Department 16-Mar-2023 9:28:54 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 170,000170,000 5406FACILITIES - Atwood Pool 89 50,00050,000 5010-23-017FACILITIES - Municipal Office 73 110,000110,000 5010-23-015FACILITIES Carryover - Perth 72 656,000656,000 5403FACILITIES - PUC Building Roof72 156,000156,000 5408FACILITIES- Listowel Carnegie 72 100,000100,000 5402FACILITIES - Facility Review69 16,00016,000 5010-23-016FACILITIES Carryover - Perth 68 10,00010,000 5010-23-010FACILITIES - Elma Logan 67 20,00020,000 5010-23-012FACILITIES - Municipal Office 66 20,00020,000 5010-23-006FACILTIES - EV Charging 65 25,00025,000 5010-23-013FACILITIES - Municipal Office 65 14,00014,000 5010-23-004FACILITIES Atwood Fire Station 62 40,00040,000 5010-23-009FACILTIES - Elma Logan 62 50,00045,0005,000 5401-23-001FACILITIES - Aquatic Drawings62 50,00050,000 5010-23-001FACILITIES- Atwood Fire Station 60 25,00025,000 5010-23-014FACILTIES - OPP Municipal 60 8,5008,500 5010-23-002FACILITIES - Atwood Fire Station 57 100,00090,00010,000 5409FACILITIES - Elma Memorial 55 12,00012,000 5010-23-005FACILTIES - Listowel Fire Station 53 20,00020,000 5010-23-011FACILITIES - Elma Memorial 51 14,00014,000 5010-23-019FACILITIES - Fairview Cemetery 50 20,00020,000 5010-23-007FACILITIES - Steve Kerr 38 30,00030,000 5010-23-003FACILTIES- Atwood Fire Station 30 15,00015,000 5010-23-008FACILITIES - Steve Kerr 28 1,731,5001,661,50070,000 Total Facilities Administration TotalMunicipality of North Perth 1,731,5001,661,50070,000 Page No. : 1
Municipality of North
Project
1.Department
Project Description
Municipality of North Perth
Capital Projects
Description
The Atwood Pool's filtration system began to fail in 2022's swimming season. Staff have tendered and awarded the project with Council's pre approval in the budget process. The work will be completed in time for the 2023 season.
Department
5406 FACILITIES - Atwood Pool Filtration (81349)
VersionYear
Submission 2023
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 8500.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5406 FACILITIES - Atwood Pool Filtration (81349) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 19 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 10 Total Weight 89 Budget 2023 Total Expenditures 170,000 170,000 Funding 170,000 170,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5406 Project Rating 89 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5010-23-017 FACILITIES - Municipal Office Roof Repair
1.Department Submission
VersionYear
2023 Description
Project Description
The flat roof over the lower section of the roof has experienced damage due to poor drainage. This area is above the main entrance. Staff have had an estimate done on the repairs to the 20' x 30' area.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 2500.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5010-23-017 FACILITIES - Municipal Office Roof Repair 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 3 Total Weight 73 Budget 2023 Total Expenditures 50,000 50,000 Funding 50,000 50,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 73 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects Project Department VersionYear 5010-23-017 FACILITIES - Municipal Office Roof Repair 1.Department Submission 2023 Gallery C:\Users\sfrench\Desktop\Capital Budget Images\Municipal Roof Repair.jpg Page No. : 3
Project Department
Municipality of North Perth
Capital Projects
5010-23-015 FACILITIES Carryover - Perth Meadows Driveway Resurfacing
1.Department Submission
VersionYear
Project Description
2023
Description
In 2022 Council approved the resurfacing of the Perth Meadows Townhouse driveways. The project quotes came in higher than expected due to the cost of materials
The existing pavement has deteriorated and is pitted and broken down. It is felt that resurfacing would not address the hazards and that a replacement of all material is recommended. In order to keep costs down the concept of replacing the driveways with concrete did not justify the expense. A RFQ is underway to determine which application; concrete or asphalt is feasible. $40,000 was set aside last year.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 5500.00 Page No. : 1
Municipality of North Perth
Capital Projects
5010-23-015 FACILITIES Carryover - Perth Meadows Driveway Resurfacing
Project Department VersionYear
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 7 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 5 Total Weight 72 Budget 2023 Total Expenditures 110,000 110,000 Funding 110,000 110,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5010 Project Rating 72 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Capital Projects
5010-23-015 FACILITIES Carryover - Perth Meadows Driveway Resurfacing
VersionYear
1.Department Submission 2023 Gallery
C:\Users\sfrench\Desktop\Capital Budget Images\PM Dirveways.jpg
Municipality of North Perth
Page No. : 3
Project Department
Municipality of North Perth
Capital Projects
5403 FACILITIES - PUC Building Roof
VersionYear
1.Department Submission 2023
Description
Project Description
The Historically designated building at 580 Main Street known as the PUC Building is in need of a roof replacement. Council is looking at options for a replica cedar shake product as well as steel and asphalt shingles. Once design and material are approved by council the project can be tendered. There are concept drawings being completed with the various options. The anticipated budget of $650,000 would be the most expensive solution but the solution that is most in keeping with the historic nature of the roof. Depending on Council Direction this project could come under budget with a less expensive approach.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 30 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 21866.00 Page No. : 1
Project Department VersionYear 5403 FACILITIES - PUC Building Roof 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 72 Budget 2023 Total Expenditures 656,000 656,000 Funding 656,000 656,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5403 Project Rating 72 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5408 FACILITIES- Listowel Carnegie Library Roof Replacement
1.Department Submission
VersionYear
Project Description
2023
Description
The roof of the Listowel Library's Carnegie facility constructed in 1907 has deficiencies identified during a 2019 audit of the facility. It is important to preserve the historic building and being respectful of the Heritage designation.
Damage to the roof, parapets and walls as a result of the elements make it important to mitigate further damage.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 30 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 5200.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5408 FACILITIES- Listowel Carnegie Library Roof Replacement 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 22 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 5 Total Weight 72 Budget 2023 Total Expenditures 156,000 156,000 Funding 156,000 156,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5408 Project Rating 72 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
of North Perth Capital Projects Project Department VersionYear 5408 FACILITIES- Listowel Carnegie Library Roof Replacement 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Facilities\Listowel Carnegie Library Roof Replacement.jpg Page No. : 3
Municipality
Project Department
Municipality of North Perth
Capital Projects
5402 FACILITIES - Facility Review
1.Department Submission
VersionYear
Project Description
2023
Description
A comprehensive review of all Municipal Facilities has been requested. The review will include facility condition, functionality and recommended improvements. This project is important for asset management and will be coordinated with Public Works Staff and initiatives.
Risk if Not Implemented
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Municipality of North Perth
Capital
Project Department VersionYear 5402 FACILITIES - Facility Review 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 6 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 8 Total Weight 69 Budget 2023 Total Expenditures 100,000 100,000 Funding 100,000 100,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Condition and Risk Parent Location 5402 Project Rating 69 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-016 FACILITIES Carryover - Perth Meadows Suites - Air Conditioning Units
1.Department Submission
VersionYear
Project Description
2023
Description
As the Perth Meadows Facility ages , many of the components are failing at the same time due to the suite units being constructed at the same time. The Air Conditioning units are costly to replace and given the timing of the unit failures it is important that the residents maintain comfort in their units. By purchasing the units 4 at a time there is cost saving and more importantly, repairs are made in a time sensitive manner. Each unit is approximately $4,000.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 800.00 Page No. : 1
Project Department VersionYear 5010-23-016 FACILITIES Carryover
Perth Meadows
Conditioning
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 8 Total Weight 68 Budget 2023 Total Expenditures 16,000 16,000 Funding 16,000 16,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 68 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
-
Suites - Air
Units
Project Department
Municipality of North Perth
Capital Projects
5010-23-010 FACILITIES - Elma Logan Recreation Complex - Ice Surface Header Pipe
1.Department Submission
VersionYear
Project Description
2023
Description
In order to maintain proper temperature of the ice surface, brine needs to be pumped through a series of brine pipes located in the arena floor's concrete. The brine is fed through a header pipe which is in need of being replaced .
Risk if Not Implemented Asset Management Asset Estimated Useful Life 25 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 400.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5010-23-010 FACILITIES - Elma Logan Recreation Complex - Ice Surface Header Pipe 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 67 Budget 2023 Total Expenditures 10,000 10,000 Funding 10,000 10,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 67 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5010-23-012 FACILITIES - Municipal Office Security
1.Department Submission
VersionYear
Project Description
2023
Description
The current security fob system employed at the Municipal Office has antiquated software with limited capacity to add users. As additional Municipal staff are employed, it is not possible to add them to the security portfolio. The system has reached it's capacity
Risk if Not Implemented Asset Management Asset Estimated Useful Life 10 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 2000.00 Page No. : 1
Project Department VersionYear 5010-23-012 FACILITIES - Municipal Office Security 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 5 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 1 Total Weight 66 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5010 Project Rating 66 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-006 FACILTIES - EV Charging Station - Listowel Fire Station
1.Department Submission
VersionYear
Project Description
2023
Description
In 2022 the Listowel Fire Station was renovated to include work stations for Building Department, By-Law and Planning units. There is currently one vehicle used by the Building Department which is equipped with EV Charging technology. It should be noted that there is one EV Charging Station that is used by the Building Department at the Municipal Office. It is anticipated that as newer vehicles are purchased more of the fleet will benefit from the EV Charging Stations. Current space provides 2 parking spots to be converted with EV Chargers.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 10 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 5000 Future Depreciation Budget Costs (Approximate) 2000.00 Page No. : 1
Municipality of North Perth Capital Projects
Project Department VersionYear 5010-23-006 FACILTIES
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 15 Total Weight 65 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5010 Project Rating 65 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
- EV Charging Station - Listowel Fire Station
Project
Municipality of North Perth
Capital Projects
With increasing number of staff being added to the Municipal Office approximately 4 additional work stations need to be added to the 2nd floor.
Department
2023 Description
Description
VersionYear 5010-23-013 FACILITIES - Municipal Office Work Stations 1.Department Submission
Project
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1666.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5010-23-013 FACILITIES - Municipal Office Work Stations 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 0 Total Weight 65 Budget 2023 Total Expenditures 25,000 25,000 Funding 25,000 25,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5010 Project Rating 65 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5010-23-004 FACILITIES Atwood Fire Station - Ventilation Upgrade
VersionYear
1.Department Submission 2023
Description
Project Description
The Atwood Fire Station has had few upgrades over the years. The current ventilation system is not functioning optimally. This is a Health and Safety concern as mold is appearing on bunker gear like gloves etc
Risk if Not Implemented Health & Safety issues Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 700.00 Page No. : 1
Municipality of North Perth Capital
Project Department VersionYear 5010-23-004 FACILITIES Atwood Fire Station - Ventilation Upgrade 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 1 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 1 Total Weight 62 Budget 2023 Total Expenditures 14,000 14,000 Funding 14,000 14,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 62 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-009 FACILTIES - Elma Logan Recreation Complex - Dehumidifier
1.Department Submission
VersionYear
Project Description
2023
Description
The current dehumidifier at the Elma Logan Recreation Complex has exceeded it's life expectancy. A replacement with a new unit is required to ensure humidity in the facility is maintained.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 2000.00 Page No. : 1
Municipality of North Perth
Capital Projects
Project Department VersionYear 5010-23-009 FACILTIES
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 62 Budget 2023 Total Expenditures 40,000 40,000 Funding 40,000 40,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 62 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
- Elma Logan Recreation Complex - Dehumidifier
Project Department
Municipality of North Perth
Capital Projects
5401-23-001 FACILITIES - Aquatic Drawings
1.Department Submission
VersionYear
Project Description
2023
Description
The Listowel Kinsmen pool is coming to the end of it's life expectancy. The facility will need to be replaced and in preparation for the construction, detailed drawings need to be completed. Staff will put out an RFP for various designs. This is a carry over from 2022 due to staff capacity.
Risk if Not Implemented
Condition and Risk an issue.
Asset Management
Asset Estimated Useful Life
New Asset Approximate Annual Operating Costs (Impact to Operating Budget)
Future Depreciation Budget Costs (Approximate)
Page No. : 1
Project Department VersionYear 5401-23-001 FACILITIES - Aquatic Drawings 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 0 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 12 Total Weight 62 Budget 2023 Total Expenditures 50,000 50,000 Funding 50,000 50,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Condition and Risk Parent Location 5401 Project Rating 62 Strategic Strategic Plan Link Corporate Sustainability Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-001 FACILITIES- Atwood Fire Station Parking Lot
VersionYear
1.Department Submission 2023
Description
Project Description
North Perth Fire Fire Fighters park around the Atwood Fire Station when responding to calls. The staff park on property that is not suitable for vehicles. There is no parking lot. By installing pavement around existing facility to the South and West, parking will no longer occur on adjacent property to the east of the hall. This a Health and Safety concern for Fire Fighters.
Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 1000 Future Depreciation Budget Costs (Approximate) 2500.00 Page No. : 1
Risk if Not Implemented
Municipality of North Perth
Capital Projects
Project Department VersionYear
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 5 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 0 Total Weight 60 Budget 2023 Total Expenditures 50,000 50,000 Funding 50,000 50,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 60 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
5010-23-001 FACILITIES- Atwood Fire Station Parking Lot
Municipality of North Perth
Capital Projects
Project Department
VersionYear
1.Department Submission 2023
Description
Project Description
The Municipal Office houses the OPP Perth County on the main level of the Municipal Office. The space includes office, meeting, staff room and common work area, garage and change rooms. There have been ongoing issues with the washroom humidity and odor. A renovation and enhancement of the ventilation system is required.
5010-23-014 FACILTIES - OPP Municipal Office Washroom Renovation
if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 1 250.00 Page No. : 1
Risk
Capital Projects Project Department VersionYear 5010-23-014 FACILTIES - OPP Municipal Office Washroom Renovation 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 0 Total Weight 60 Budget 2023 Total Expenditures 25,000 25,000 Funding 25,000 25,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 60 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Municipality of North Perth
Capital Projects
Project Description
The Atwood Fire Station has the original lighting in the building. The truck bay's lights are located directly above the trucks which prevents light from covering the entire space. This is a Health and Safety concern. By installing and relocating LED lights the improvement will make it safer to work on equipment. The common areas of the space are also due for a replacement to LED.
Project Department VersionYear 5010-23-002 FACILITIES - Atwood Fire Station Lighting 1.Department Submission 2023 Description
Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 425.00 Page No. : 1
Risk if Not Implemented
Municipality of North Perth
Capital
Project Department VersionYear 5010-23-002 FACILITIES - Atwood Fire Station Lighting 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 1 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 1 Total Weight 57 Budget 2023 Total Expenditures 8,500 8,500 Funding 8,500 8,500 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 57 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
Project Department
Municipality of North Perth
Capital Projects
5409 FACILITIES - Elma Memorial Community Centre - Additional Storage
1.Department Submission
VersionYear
Project Description
2023
Description
Storage has been a concern for a number of years at Elma Memorial Complex. The storage situation can be resolved with the construction of a secure storage facility constructed on the east side of the facility. This will provide a much needed solution and provide opportunities to expand bar and office space.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 50 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 2000.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5409 FACILITIES - Elma Memorial Community Centre - Additional Storage 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 0 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 10 Total Weight 55 Budget 2023 Total Expenditures 100,000 100,000 Funding 100,000 100,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Growth Parent Location 5409 Project Rating 55 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Municipality of North Perth
Capital
Projects
Department VersionYear 5010-23-005 FACILTIES - Listowel Fire Station Accessible Doors 1.Department Submission 2023 Description Project Description Provide accessible access for staff to the washroom area and upgrade technology in the washroom (panic button). Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 600.00 Page No. : 1
Project
Capital Projects Project Department VersionYear 5010-23-005 FACILTIES - Listowel Fire Station Accessible Doors 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 2 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 1 Total Weight 53 Budget 2023 Total Expenditures 12,000 12,000 Funding 12,000 12,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 53 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Department
Municipality of North Perth
Capital Projects
5010-23-011 FACILITIES - Elma Memorial Community Centre Staging
1.Department Submission
VersionYear
Project Description
2023
Description
The Elma Memorial Community Centre's fixed stage limits the potential layouts for booked functions in the large hall. The removal of the existing stage which occupies a significant portion of the floor and replacing it with a modular portable stage will provide flexibility for facility rentals.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 1333.00 Page No. : 1
Project Department VersionYear 5010-23-011 FACILITIES - Elma Memorial Community Centre Staging 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 1 Total Weight 51 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 51 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Projects Project Department VersionYear 5010-23-019 FACILITIES - Fairview Cemetery Fence 1.Department Submission 2023 Description Project Description Installation of a privacy/security fence on south side of office/yard property near new residential development. This will provide added safety to equipment moving around yard. Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 933.00 Page No. : 1
Municipality of North Perth Capital
Project Department VersionYear 5010-23-019 FACILITIES - Fairview Cemetery Fence 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 7 Existing Assets/Condition/Capacity/Complaints (0 to 30) 17 Environmental/ Economic Impact (0 to 15) 1 Total Weight 50 Budget 2023 Total Expenditures 14,000 14,000 Funding 14,000 14,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5010 Project Rating 50 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-007 FACILITIES - Steve Kerr Memorial Complex - Asphalt Upgrade
VersionYear
1.Department Submission 2023
Description
Project Description
When the Steve Kerr Memorial Complex was constructed a Parks and Rec equipment and materials shed was built. Currently the parking surface between the arena parking lot and shed is gravel. A paved surface is preferable for moving equipment and vehicles into the shed.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 1000.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5010-23-007 FACILITIES - Steve Kerr Memorial Complex - Asphalt Upgrade 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 5 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 38 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5010 Project Rating 38 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5010-23-003 FACILTIES- Atwood Fire Station - Truck Bay Upgrade
1.Department Submission
VersionYear
Project Description
2023
Description
The Atwood Fire Station has had minimal upgrades over the years. The original cinder block walls are exposed to the cleaning and water that occurs in the bay area. By installing plasticor similar membrane over the existing interior brick it will improve the atmosphere and functionality of the space.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 1500.00 Page No. : 1
Municipality of North Perth
Capital
Project Department VersionYear 5010-23-003 FACILTIES- Atwood Fire Station - Truck Bay Upgrade 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 5 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 0 Total Weight 30 Budget 2023 Total Expenditures 30,000 30,000 Funding 30,000 30,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2024 Project Type Repair and Replacement Parent Location 5010 Project Rating 30 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Projects
Project Department
Municipality of North Perth
Capital Projects
5010-23-008 FACILITIES - Steve Kerr Memorial Complex - Shed Mezzanine
1.Department Submission
VersionYear
Project Description
2023
Description
When the Steve Kerr Memorial Complex was constructed, a storage shed was built to store machinery, equipment and materials. A storage mezzanine would improve the available storage space and make the space more useable.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 35 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 430.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5010-23-008 FACILITIES - Steve Kerr Memorial Complex - Shed Mezzanine 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 1 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 1 Total Weight 28 Budget 2023 Total Expenditures 15,000 15,000 Funding 15,000 15,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5010 Project Rating 28 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Version Budget Year
Submission 2023
1.Department
Forecast Periods 2023
Department Park Operations Administration Park Operations Administration Department 16-Mar-2023 1:38:31 PM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 300,000300,000 5404PARKS - Memorial Park 90 30,00030,000 5008-23-010PARKS - OPP CTV Project - 76 7,5007,500 5008-23-005PARKS - Memorial Park Fencing62 500,000125,000375,000 5405PARKS - Park Consultation & 60 144,600144,600 5008-23-004PARKS Carryover- Monkton Ball 59 60,00054,0006,000 5008-23-003PARKS - Tennis Courts (Atwood 55 1,400,000900,000500,000 5400PARKS - MAP5949 10,00010,000 5001-23-006PARKS - 8' Dump Trailer47 20,00020,000 5001-23-005PARKS - Zero Turn Mower & 46 22,00022,000 5008-23-006PARKS - Trowbridge Pavilion36 20,00020,000 5008-23-008PARKS - Gowanstown Trail Head 26 14,00014,000 5008-23-009PARK - Atwood Cenotaph 26 2,528,1001,583,100401,00044,000500,000 Total Park Operations Administration TotalMunicipality of North Perth 2,528,1001,583,100401,00044,000500,000 Page No. : 1
Municipality of North Perth Capital Projects by Priority within Department
Home
Municipality of North Perth
Project Description
The existing play structure in Listowel's Memorial Park no longer meets compliance and poses a security risk to park users. An outdated section of the playground was removed in the Fall of 2022 The play structure will be replaced with a new amenity which will enhance safety and provide elements of barrier free access to the destination park.
Department VersionYear 5404 PARKS - Memorial Park Playstructure (76625) 1.Department Submission 2023
Capital Projects Project
Description
if Not Implemented Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 15000.00 Page No. : 1
Risk
Municipality of North Perth
Capital Projects Project Department VersionYear 5404 PARKS - Memorial Park Playstructure (76625) 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 20 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 10 Total Weight 90 Budget 2023 Total Expenditures 300,000 300,000 Funding 300,000 300,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5404 Project Rating 90 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5008-23-010 PARKS - OPP CTV Project - Memorial Park
VersionYear
1.Department Submission 2023
Description
Project Description
Memorial Park has experienced on going acts of vandalism and mischief. The OPP applied for a grant to replace existing security cameras with an improved quality. These cameras will cover the skate park, swimming pool and pavilion areas. The grant has been received and the project is underway.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 10 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 3000.00 Page No. : 1
Municipality of North Perth
Capital Projects
5008-23-010 PARKS - OPP CTV Project - Memorial Park
Project Department VersionYear
1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 30 Fits with The Strategic Plan (0 to 25) 15 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 1 Total Weight 76 Budget 2023 Total Expenditures 30,000 30,000 Funding 30,000 30,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5008 Project Rating 76 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5008-23-005 PARKS - Memorial Park Fencing
1.Department Submission
VersionYear
Project Description
2023
Description
The Final Stage 3 of the new fencing is planned for 2023. Previously, 2 stages of the fencing came in over budget and request is being made to complete the project this year.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 25 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 300.00 Page No. : 1
Project Department VersionYear 5008-23-005 PARKS - Memorial Park Fencing 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 20 Fits with The Strategic Plan (0 to 25) 9 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 3 Total Weight 62 Budget 2023 Total Expenditures 7,500 7,500 Funding 7,500 7,500 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5008 Project Rating 62 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Municipality of North Perth Capital Projects Project Department VersionYear 5008-23-005 PARKS - Memorial Park Fencing 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Facilities\Memorial Park Fencing Image 1.jpg Page No. : 3
Municipality of North Perth Capital Projects Project Department VersionYear 5008-23-005 PARKS - Memorial Park Fencing 1.Department Submission 2023 Gallery H:\00 - Budget Working Papers\2023 Budget Working Papers\Images\Facilities\Memorial Park Fencing Image 2.jpg Page No. : 4
Municipality of North Perth
Capital Projects Project
Project Description
Staff have completed and awarded a RFP for park designs of 4 new parks (Nichol, Dalmitch, Hannah's Haven and Wallace areas). The consultation phase is underway and requesting $450,000 for implementing recommended designs in those parks that are ready to be developed. It is felt that this project will continue into subsequent years.
Risk if Not Implemented
Department
5405 PARKS - Park Consultation & Development
Submission
VersionYear
1.Department
2023 Description
Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 22500.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5405 PARKS - Park Consultation & Development 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 0 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 10 Total Weight 60 Budget 2023 Total Expenditures 500,000 500,000 Funding 500,000 500,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Growth Parent Location 5405 Project Rating 60 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5008-23-004 PARKS Carryover- Monkton Ball Lights
VersionYear
1.Department Submission 2023
Description
Project Descrtiption
The ball diamond at the Elma Logan Recreation Complex has a lighting system that is outdated. The existing wooden light standards are at least 40 years old and are in poor condition. The light fixtures are metal halide and would be replaced with LED fixtures providing a better quality of light and energy efficiency.
Some of the outfield poles were replaced approximately 10 years ago. As such replacement of the infield standards has been approved.
Light fixtures would be replaced on all standards.This project was approved funded out of 2022 capital and the project is underway.
Risk If Not Implemented Asset Management Asset Estimated Useful Life 35 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 4131.00 Page No. : 1
Municipality of North Perth
Project Department VersionYear 5008-23-004 PARKS Carryover- Monkton Ball Lights 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 12 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 2 Total Weight 59 Budget 2023 Total Expenditures 144,600 144,600 Funding 144,600 144,600 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5008 Project Rating 59 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Capital Projects
Municipality of North Perth
Capital Projects
Project
Project Description
In 2022 the Davidson Tennis Courts were approved in the capital budget. Unfortunately as a result of increasing cost of materials the project came in over budget and was not implemented. Funds allocated to the project were redirected to cover the cost of the Monkton Ball Light retrofit. As such, the request has been re added to this year's capital listing and also includes the Atwood Tennis Courts. It is anticipated that there will be cost efficiencies in grouping the 2 projects together. Both the Davidson and Atwood courts have deteriorated over time and are due for resurfacing.
Department
5008-23-003
LIstowel)
Submission 2023 Description
VersionYear
PARKS - Tennis Courts (Atwood &
1.Department
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 3600.00 Page No. : 1
Municipality of North Perth
Capital Projects
5008-23-003 PARKS - Tennis Courts (Atwood & LIstowel)
Project Department VersionYear
Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 0 Total Weight 55 Budget 2023 Total Expenditures 60,000 60,000 Funding 60,000 60,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Condition and Risk Parent Location 5008 Project Rating 55 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
1.Department
Project Department
Municipality of North Perth
Capital Projects
5400 PARKS - MAP59
1.Department Submission
VersionYear
Project Description
2023
Description
The Municipality will be constructing a Memorial Park (Map'59) on the site of the original Municipal Arena. The Memorial aspect of the park will include a memorial area, trees, sensory playground, seasonal ice skating rink, pathways, lighting and passive recreation space.
Risk if Not Implemented
Asset Management Asset Estimated Useful Life Components New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 50000.00 approx Page No. : 1
Municipality of North Perth
Capital
Project Department VersionYear 5400 PARKS - MAP59 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 1 Fits with The Strategic Plan (0 to 25) 13 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 10 Total Weight 49 Budget 2023 Total Expenditures 1,400,000 1,400,000 Funding 1,400,000 1,400,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5400 Project Rating 49 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Projects
5400 PARKS - MAP59
C:\Users\sfrench\Desktop\Capital Budget Images\MAP-59 image.jpg
Gallery
Department
Municipality of North Perth Capital Projects Project
VersionYear
1.Department Submission 2023
Page No. : 3
Project Department
Municipality of North Perth
Capital Projects
5001-23-006 PARKS - 8' Dump Trailer
1.Department Submission
VersionYear
2023 Description
Project Description
The addition of an 8 foot dump trailer for Listowel Recreation and Parks which will be used for garbage collection, carrying material, and equipment.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 666.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5001-23-006 PARKS - 8' Dump Trailer 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 10 Fits with The Strategic Plan (0 to 25) 2 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 5 Total Weight 47 Budget 2023 Total Expenditures 10,000 10,000 Funding 10,000 10,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5001 Project Rating 47 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5001-23-005 PARKS - Zero Turn Mower & Mulching Kit
Park Operations Administration
1.Department Submission
VersionYear
Project Description
2023
Description
Replacement of an existing zero turn mower in Listowel with over 6000 operating hours will be sold on gov deals and replaced with a 60" Zero Turn Mower and mulching kit.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 15 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 1500 Future Depreciation Budget Costs (Approximate) 1333.00 Page No. : 1
Project Department VersionYear 5001-23-005 PARKS - Zero Turn Mower & Mulching Kit Park Operations Administration 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 1 Existing Assets/Condition/Capacity/Complaints (0 to 30) 30 Environmental/ Economic Impact (0 to 15) 0 Total Weight 46 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Repair and Replacement Parent Location 5001 Project Rating 46 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Municipality of North Perth Capital Projects
Project Department
Municipality of North Perth
Capital Projects
5008-23-006 PARKS - Trowbridge Pavilion
VersionYear
1.Department Submission
Project Description
2023
Description
This project has been identified in previous capital requests but due to staff capacity the project has been postponed. With the cost of materials, building permits and engineered drawings the cost is anticipated to be higher than the $15,000 original budget.
Risk if Not Implemented Asset Management Asset Estimated Useful Life 25 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) Future Depreciation Budget Costs (Approximate) 880.00 Page No. : 1
Municipality of North Perth
Capital Projects Project Department VersionYear 5008-23-006 PARKS - Trowbridge Pavilion 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 0 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 25 Environmental/ Economic Impact (0 to 15) 1 Total Weight 36 Budget 2023 Total Expenditures 22,000 22,000 Funding 22,000 22,000 Attributes Attribute Value Comment Attributes Department Facilities Year Proposed 2023 Project Type Repair and Replacement Parent Location 5008 Project Rating 36 Strategic Strategic Plan Link Service Effectiveness Strategic Plan ID Page No. : 2
Project Department
Municipality of North Perth
Capital Projects
5008-23-008 PARKS - Gowanstown Trail Head Parking
VersionYear
1.Department Submission 2023
Description
Project Description
With the future development of the Gownastown Trail extension it is important to add parking spaces for trail users. The area will require a great deal of fill in order to make appropriate spaces. The parking would be a stone dust surface. The location of the parking lot would be on the south east side of the intersection of Highway 23 and Line 88 on the property that is municipal owned.
Risk if Not Implemented
Asset Management Asset Estimated Useful Life 20 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 200 Future Depreciation Budget Costs (Approximate) 1000.00 Page No. : 1
Capital Projects Project Department VersionYear 5008-23-008 PARKS - Gowanstown Trail Head Parking 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 5 Fits with The Strategic Plan (0 to 25) 5 Existing Assets/Condition/Capacity/Complaints (0 to 30) 11 Environmental/ Economic Impact (0 to 15) 5 Total Weight 26 Budget 2023 Total Expenditures 20,000 20,000 Funding 20,000 20,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5008 Project Rating 26 Strategic Strategic Plan Link Community Planning Strategic Plan ID Page No. : 2
Municipality of North Perth
Project Department
Municipality of North Perth
Capital Projects
5008-23-009 PARK - Atwood Cenotaph Upgrade
VersionYear
1.Department Submission 2023 Description
Project Description
In 2022 renovations took place to remove both the East and North facing walls of the Cenotaph Fence. Sod was installed to enhance the appearance of the amenity. Moving forward accessibility and beautification of the Cenotaph will need to be incorporated.
The intersection adjacent to the Cenotaph at Monument Road and Highway 23 will likely see significant changes to the slope of the property. It is felt that these changes will effect the accessibility to the monument. The timing of this project is dependant on the development of the intersection.
There are grant funds available for this project.
Asset Management Asset Estimated Useful Life 40 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 0 Future Depreciation Budget Costs (Approximate) 700.00 Page No. : 1
Risk if Not Implemented
Municipality of North Perth
Capital Projects Project Department VersionYear 5008-23-009 PARK - Atwood Cenotaph Upgrade 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 15 Fits with The Strategic Plan (0 to 25) 10 Existing Assets/Condition/Capacity/Complaints (0 to 30) 0 Environmental/ Economic Impact (0 to 15) 1 Total Weight 26 Budget 2023 Total Expenditures 14,000 14,000 Funding 14,000 14,000 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2024 Project Type Repair and Replacement Parent Location 5008 Project Rating 26 Strategic Strategic Plan Link Community Planning Strategic Plan ID Page No. : 2
Version Budget Year 1.Department Submission 2023 Municipality of North Perth Capital Projects by Department Ranking Forecast Periods 2023 Home Department Trail Maintenance Adminstration Trail Maintenance Adminstration Department 15-Mar-2023 10:56:39 AM ExpendituresSegregated Surplus Develop Charges GrantsUser Fees / Taxation DonationsFinancing / Other Project IdDescriptionPriority 119,556119,556 5009-23-001Project - ICIP Trail Project85 119,556 119,556 Total Trail Maintenance Adminstration TotalMunicipality of North Perth 119,556 119,556 Page No. : 1
Project Department
Municipality of North Perth
Capital Projects
5009-23-001 Project - ICIP Trail Project
1.Department Submission
VersionYear
Project Description
2023
Description
Continuation of Gowanstown Trail and repair to pedestrian foot bridges on Listowel Trails. This project was funded by a Grant. Spent $48,170 in 2022 leaving $119,556 for 2023. the total grant was $167,726
Risk if Not Implemented Asset Management Asset Estimated Useful Life 40 New Asset Approximate Annual Operating Costs (Impact to Operating Budget) 1000 Future Depreciation Budget Costs (Approximate) 2989.00 Page No. : 1
Municipality of North Perth Capital Projects
Project Department VersionYear 5009-23-001 Project - ICIP Trail Project 1.Department Submission 2023 Priority Category Priority Comment Safety of Public Risk (0 to 30) 25 Fits with The Strategic Plan (0 to 25) 25 Existing Assets/Condition/Capacity/Complaints (0 to 30) 20 Environmental/ Economic Impact (0 to 15) 15 Total Weight 85 Budget 2023 Total Expenditures 119,556 119,556 Funding 119,556 119,556 Attributes Attribute Value Comment Attributes Department Yearly General Year Proposed 2023 Project Type Growth Parent Location 5009 Project Rating 85 Strategic Strategic Plan Link Growth and Economic Development Strategic Plan ID Page No. : 2
Capital Projects by Department
MuncipalityofNorthPerth Capital-ProjectDetails
Growth GrowthandEconomic Development 56 Growth GrowthandEconomic Development 56 RepairandReplacement ServiceEffectiveness 46 RepairandReplacement ServiceEffectiveness 47 Growth GrowthandEconomic Development 26 ConditionandRisk ServiceEffectiveness 55 RepairandReplacement ServiceEffectiveness 59 RepairandReplacement ServiceEffectiveness 62 RepairandReplacement ServiceEffectiveness 36 Growth GrowthandEconomic Development 25 Growth CommunityPlanning 26 RepairandReplacement CommunityPlanning 26 Growth ServiceEffectiveness 76 Growth GrowthandEconomic Development 85 RepairandReplacement ServiceEffectiveness 60 RepairandReplacement ServiceEffectiveness 57 RepairandReplacement ServiceEffectiveness 30 RepairandReplacement ServiceEffectiveness 62 RepairandReplacement ServiceEffectiveness 53 Growth ServiceEffectiveness 65 ConditionandRisk ServiceEffectiveness 38 RepairandReplacement ServiceEffectiveness 28
RunDate:15/03/233:49PM PageNo:1 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth Capital-ProjectDetails
RepairandReplacement ServiceEffectiveness 62 RepairandReplacement ServiceEffectiveness 67 RepairandReplacement ServiceEffectiveness 51 Growth ServiceEffectiveness 66 Growth ServiceEffectiveness 65 RepairandReplacement ServiceEffectiveness 60 RepairandReplacement ServiceEffectiveness 73 ConditionandRisk ServiceEffectiveness 50 RepairandReplacement GrowthandEconomic Development 49 RepairandReplacement GrowthandEconomic Development 49 RepairandReplacement ServiceEffectiveness ConditionandRisk CorporateSustainability 62 ConditionandRisk ServiceEffectiveness 69 ConditionandRisk ServiceEffectiveness 69 RepairandReplacement ServiceEffectiveness 72 RepairandReplacement ServiceEffectiveness 72 RepairandReplacement ServiceEffectiveness 90 RepairandReplacement ServiceEffectiveness 90 Growth GrowthandEconomic Development 60 Growth GrowthandEconomic Development 60 RepairandReplacement ServiceEffectiveness 89 RepairandReplacement ServiceEffectiveness 89 RepairandReplacement ServiceEffectiveness 72 RepairandReplacement ServiceEffectiveness 72 Growth GrowthandEconomic Development 55 Growth GrowthandEconomic Development 55
RunDate:15/03/233:49PM PageNo:2 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth Capital-ProjectDetails
LegislativeRequirement CorporateSustainability 75 LegislativeRequirement CorporateSustainability 85 Growth ServiceEffectiveness 64 Growth AnnualProgram CorporateSustainability 92 AnnualProgram CorporateSustainability 40 RepairandReplacement CorporateSustainability 90 Growth ServiceEffectiveness 40 Growth CorporateSustainability 47 Growth ServiceEffectiveness 56 Growth ServiceEffectiveness 63 AnnualProgram ServiceEffectiveness 64 ConditionandRisk ServiceEffectiveness 74 AnnualProgram CorporateSustainability
RunDate:15/03/233:49PM PageNo:3 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth Capital-ProjectDetails
AnnualProgram ServiceEffectiveness 63 RepairandReplacement ServiceEffectiveness 63 RepairandReplacement ServiceEffectiveness 47 RepairandReplacement ServiceEffectiveness 48 RepairandReplacement ServiceEffectiveness 59 RepairandReplacement ServiceEffectiveness RepairandReplacement ServiceEffectiveness 55 RepairandReplacement ServiceEffectiveness 71 RepairandReplacement ServiceEffectiveness 62 RepairandReplacement ServiceEffectiveness 64 RepairandReplacement ServiceEffectiveness 79 RepairandReplacement ServiceEffectiveness ConditionandRisk ServiceEffectiveness AnnualProgram RepairandReplacement CommunityPlanning 71 AnnualProgram CorporateSustainability AnnualProgram CorporateSustainability 74 Growth ServiceEffectiveness 74 Growth ServiceEffectiveness 74 RepairandReplacement ServiceEffectiveness RepairandReplacement ServiceEffectiveness 76 Growth ServiceEffectiveness 76 Growth ServiceEffectiveness 76 Growth CommunityPlanning 73 Growth CommunityPlanning 73 RepairandReplacement ServiceEffectiveness 79 RepairandReplacement ServiceEffectiveness 79 RepairandReplacement ServiceEffectiveness 79
RunDate:15/03/233:49PM PageNo:4 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth
Capital-ProjectDetails
RepairandReplacement ServiceEffectiveness 79 RepairandReplacement ServiceEffectiveness 83 RepairandReplacement ServiceEffectiveness 83 Growth ServiceEffectiveness Growth ServiceEffectiveness RepairandReplacement ServiceEffectiveness 53 RepairandReplacement ServiceEffectiveness 53 RepairandReplacement GrowthandEconomic Development 78 RepairandReplacement GrowthandEconomic Development 78 RepairandReplacement 62 RepairandReplacement 62 RepairandReplacement ServiceEffectiveness 68 RepairandReplacement ServiceEffectiveness 68 RepairandReplacement ServiceEffectiveness 74 RepairandReplacement ServiceEffectiveness 74 Growth GrowthandEconomic Development 51 Growth ServiceEffectiveness 60
RunDate:15/03/233:49PM PageNo:5 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth
Capital-ProjectDetails
ConditionandRisk ServiceEffectiveness 72 RepairandReplacement ServiceEffectiveness 68 RepairandReplacement ServiceEffectiveness 45 RepairandReplacement ServiceEffectiveness 65 RepairandReplacement ServiceEffectiveness 55 RepairandReplacement ServiceEffectiveness 55 RepairandReplacement ServiceEffectiveness 60 RepairandReplacement ServiceEffectiveness 60 ConditionandRisk ServiceEffectiveness 50 RepairandReplacement ServiceEffectiveness 65 Growth ServiceEffectiveness 65 Growth ServiceEffectiveness 65 RepairandReplacement ServiceEffectiveness 50
RunDate:15/03/233:49PM PageNo:6 Capital-ProjectDetails RunDate:15-Mar-2023
MuncipalityofNorthPerth Capital-ProjectDetails
RepairandReplacement ServiceEffectiveness 50
Date:15/03/233:49PM PageNo:7 Capital-ProjectDetails RunDate:15-Mar-2023
Run
