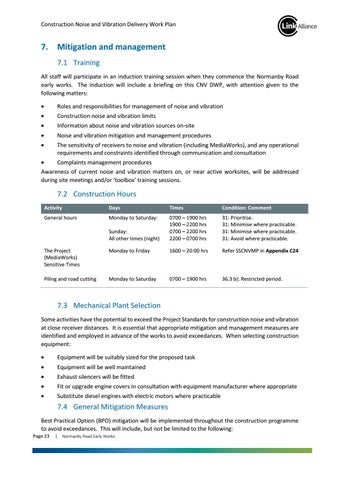

Construction Noise and Vibration Delivery Work Plan

7.

Mitigation and management 7.1 Training

All staff will participate in an induction training session when they commence the Normanby Road early works. The induction will include a briefing on this CNV DWP, with attention given to the following matters: •

Roles and responsibilities for management of noise and vibration

Construction noise and vibration limits

Information about noise and vibration sources on-site

Noise and vibration mitigation and management procedures

The sensitivity of receivers to noise and vibration (including MediaWorks), and any operational requirements and constraints identified through communication and consultation

• Complaints management procedures Awareness of current noise and vibration matters on, or near active worksites, will be addressed during site meetings and/or ‘toolbox’ training sessions.

7.2 Construction Hours Activity

Days

Times

Condition: Comment

General hours

Monday to Saturday: Sunday: All other times (night)

0700 – 1900 hrs 1900 – 2200 hrs 0700 – 2200 hrs 2200 – 0700 hrs

31: Prioritise. 31: Minimise where practicable. 31: Minimise where practicable. 31: Avoid where practicable.

The Project (MediaWorks) Sensitive Times

Monday to Friday

1600 – 20:00 hrs

Refer SSCNVMP in Appendix C24

Piling and road cutting

Monday to Saturday

0700 – 1900 hrs

36.3 b): Restricted period.

7.3 Mechanical Plant Selection Some activities have the potential to exceed the Project Standards for construction noise and vibration at close receiver distances. It is essential that appropriate mitigation and management measures are identified and employed in advance of the works to avoid exceedances. When selecting construction equipment: •

Equipment will be suitably sized for the proposed task

Equipment will be well maintained

Exhaust silencers will be fitted

Fit or upgrade engine covers in consultation with equipment manufacturer where appropriate

Substitute diesel engines with electric motors where practicable

7.4 General Mitigation Measures Best Practical Option (BPO) mitigation will be implemented throughout the construction programme to avoid exceedances. This will include, but not be limited to the following:

Page 23

| Normanby Road Early Works


Turn static files into dynamic content formats.

Create a flipbook
Issuu converts static files into: digital portfolios, online yearbooks, online catalogs, digital photo albums and more. Sign up and create your flipbook.
Construction Noise and Vibration by City Rail Link Ltd - Issuu
