Fort Pierce 2022 Strategic Plan - May 2022

Page 22

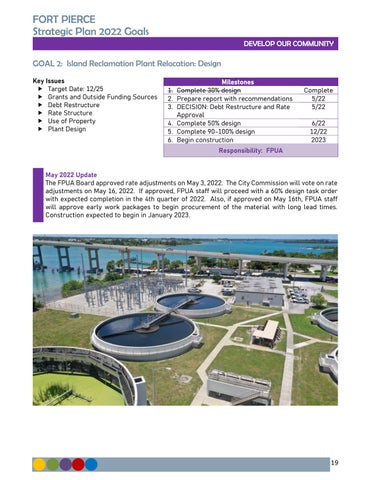

FORT PIERCE Strategic Plan 2022 Goals GOAL 2: Island Reclamation Plant Relocation: Design Key Issues  Target Date: 12/25  Grants and Outside Funding Sources  Debt Restructure  Rate Structure  Use of Property  Plant Design

1. Complete 30% design 2. Prepare report with recommendations 3. DECISION: Debt Restructure and Rate Approval 4. Complete 50% design 5. Complete 90-100% design 6. Begin construction

Complete 5/22 5/22 6/22 12/22 2023

Responsibility: FPUA May 2022 Update The FPUA Board approved rate adjustments on May 3, 2022. The City Commission will vote on rate adjustments on May 16, 2022. If approved, FPUA staff will proceed with a 60% design task order with expected completion in the 4th quarter of 2022. Also, if approved on May 16th, FPUA staff will approve early work packages to begin procurement of the material with long lead times. Construction expected to begin in January 2023.

19


Turn static files into dynamic content formats.

Create a flipbook
Issuu converts static files into: digital portfolios, online yearbooks, online catalogs, digital photo albums and more. Sign up and create your flipbook.
Fort Pierce 2022 Strategic Plan - May 2022 by City of Fort Pierce - Issuu
