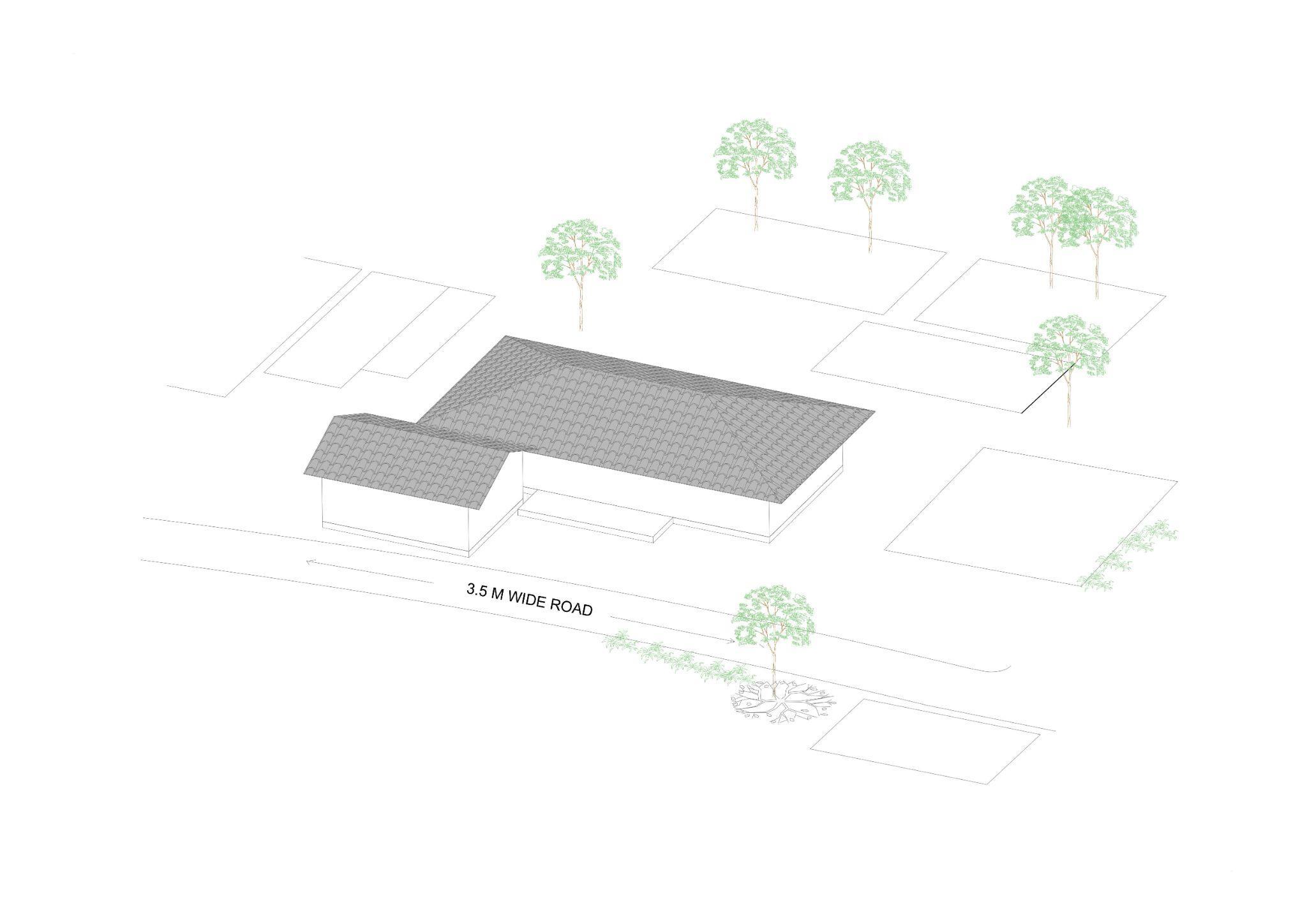

BUILDING MAKING

SITE INTR

Situated in Bot village, Palghar 350 sq.m area

SITE DEMARCATION

MARKING THE SITE BOUNDARIES

DEMOLITION OF EXISTING STRUCTURE AND CLEANING

Clearing rocks, boulders and trees for building on site

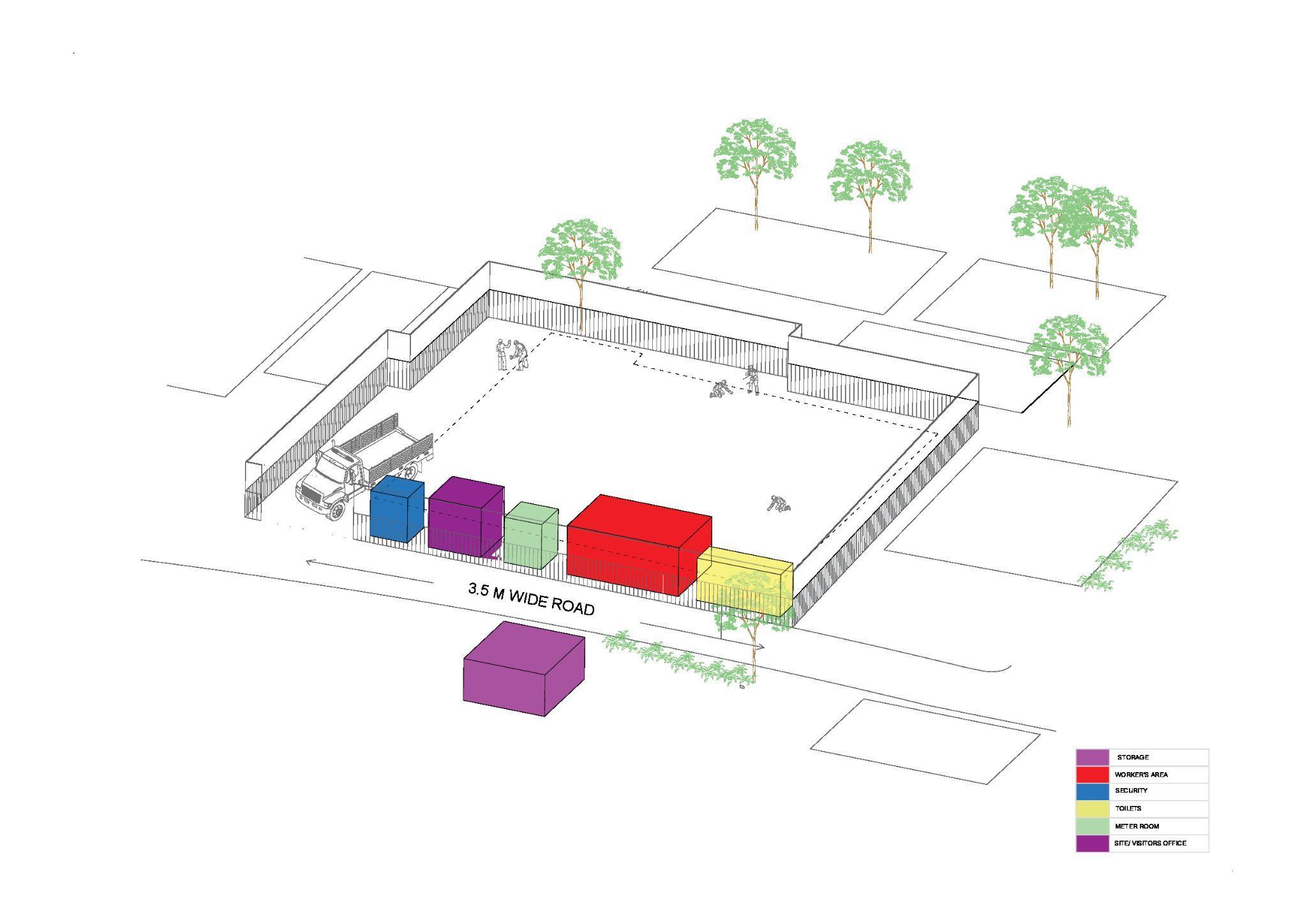

SITE MANAGEMENT

To build temporal structures like security cabin, demarcated place for loading-unloading, storage and toilets for labours and excavating for foundation

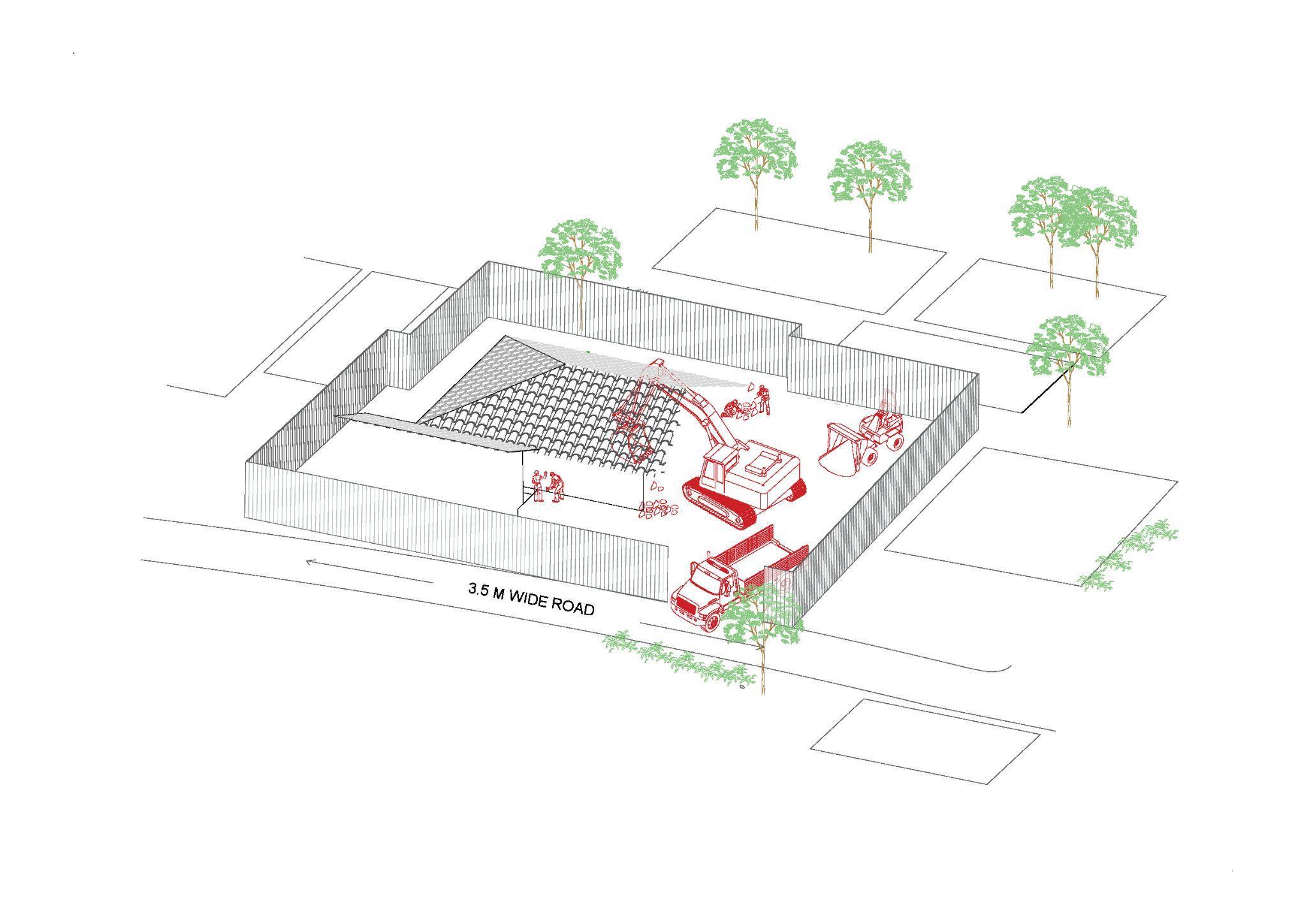

EXCAVATION, PIT PREPARATION AND SHORING

Excavating the site according to the required plinth profile and depth dimensions

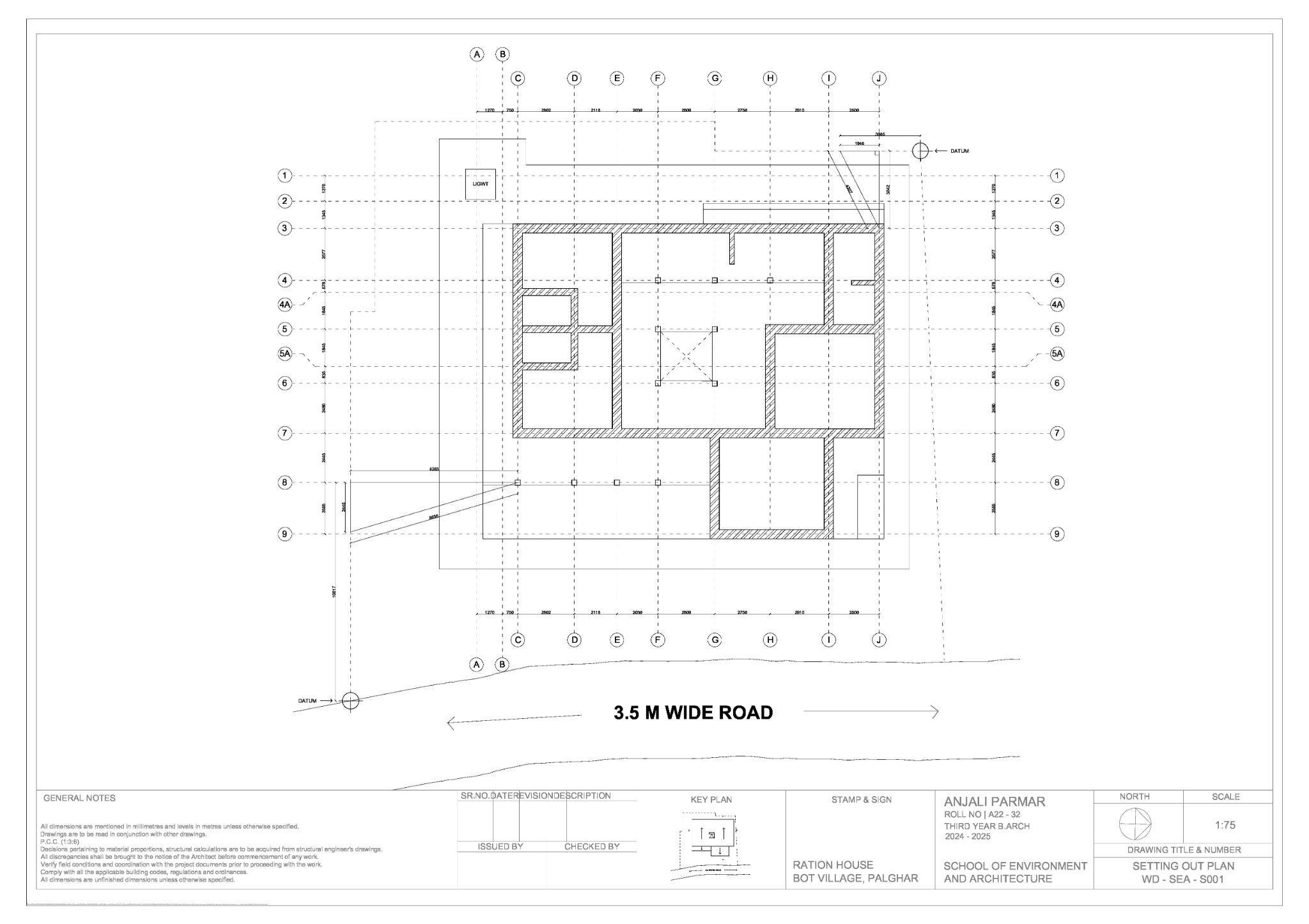

SETTING OUT

To locate points for walls, site boundary level, foundation position and other necessary structural parts according to the construction drawing

Step foundation made by the brick material

Filling the plinth area of the foundation with materials either excavated from the ground or from outside. Adding DPC.

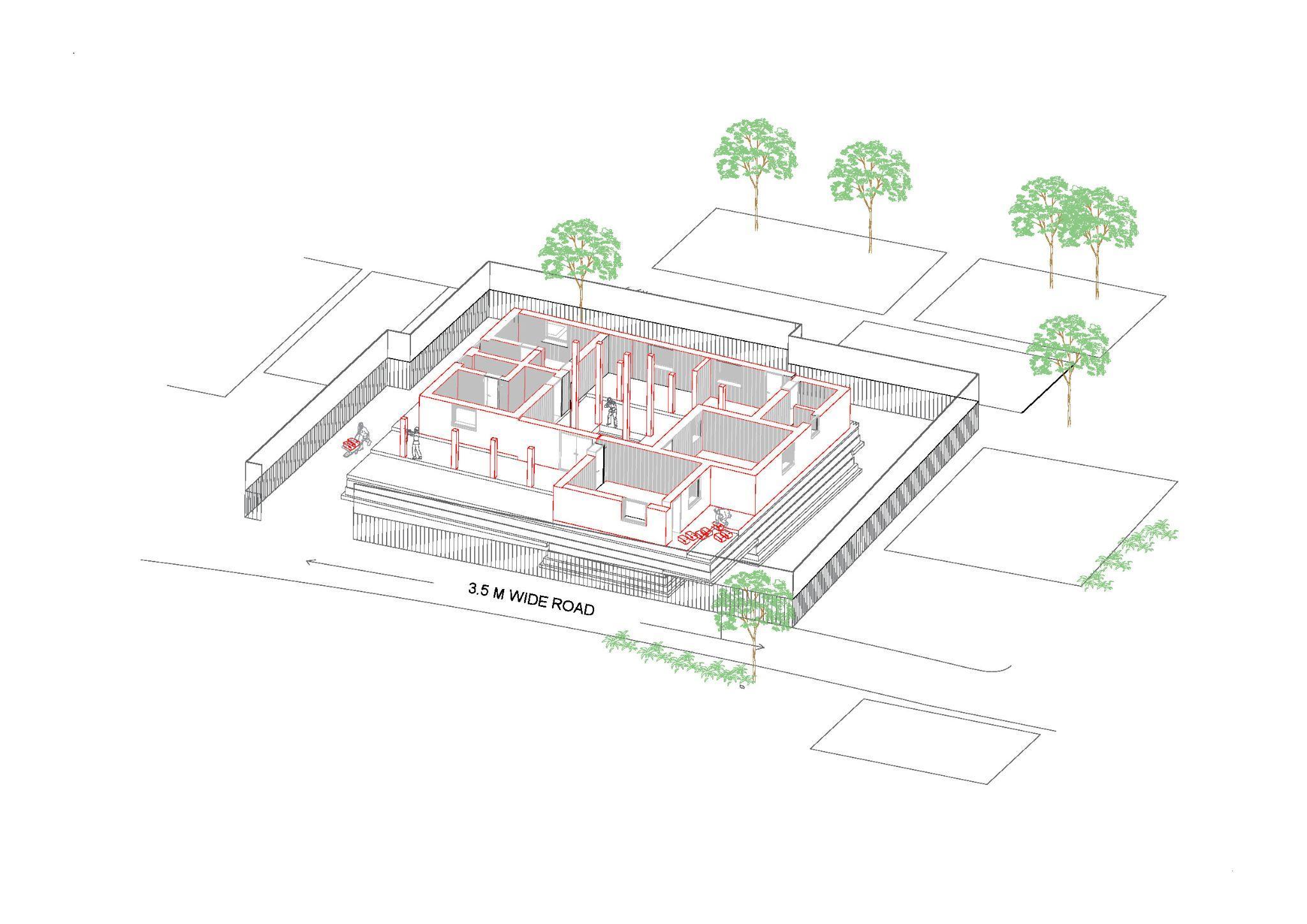

Making the initial load bearing walls leaving out punctures for openings along with lintel

FIRST FLOOR SLAB AND STAIRCASE

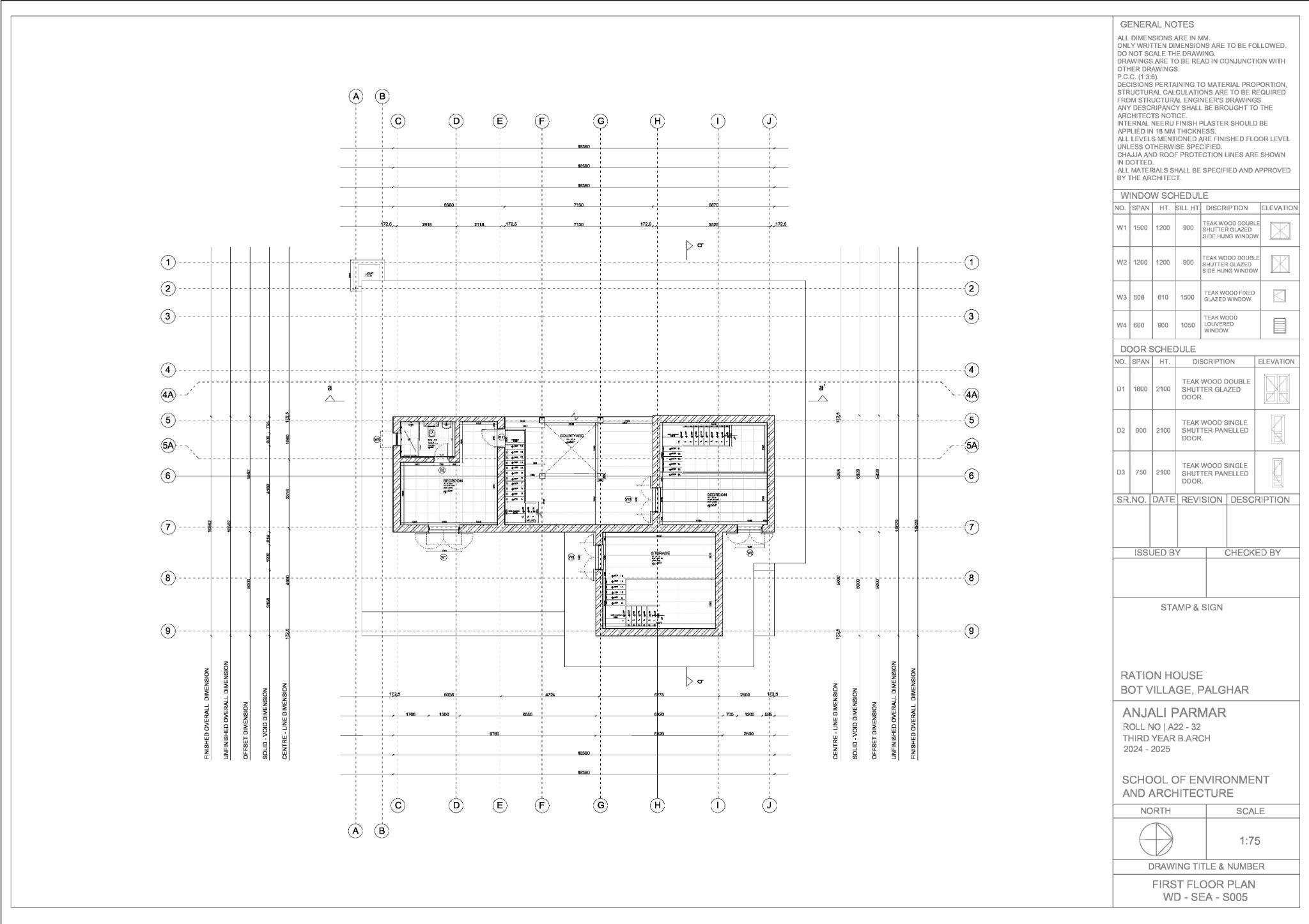

Making the first floor load bearing walls leaving out punctures for openings along with lintel

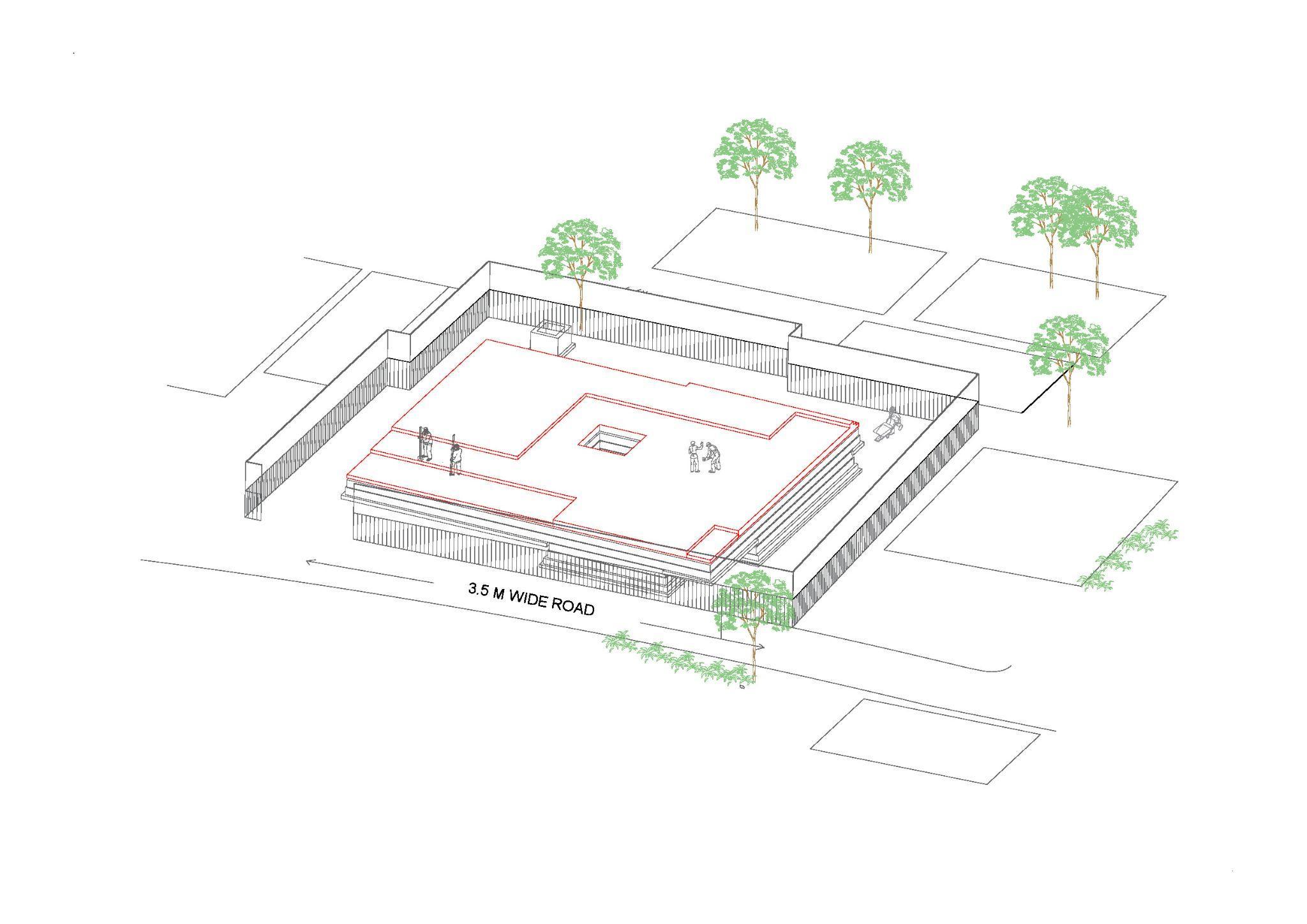

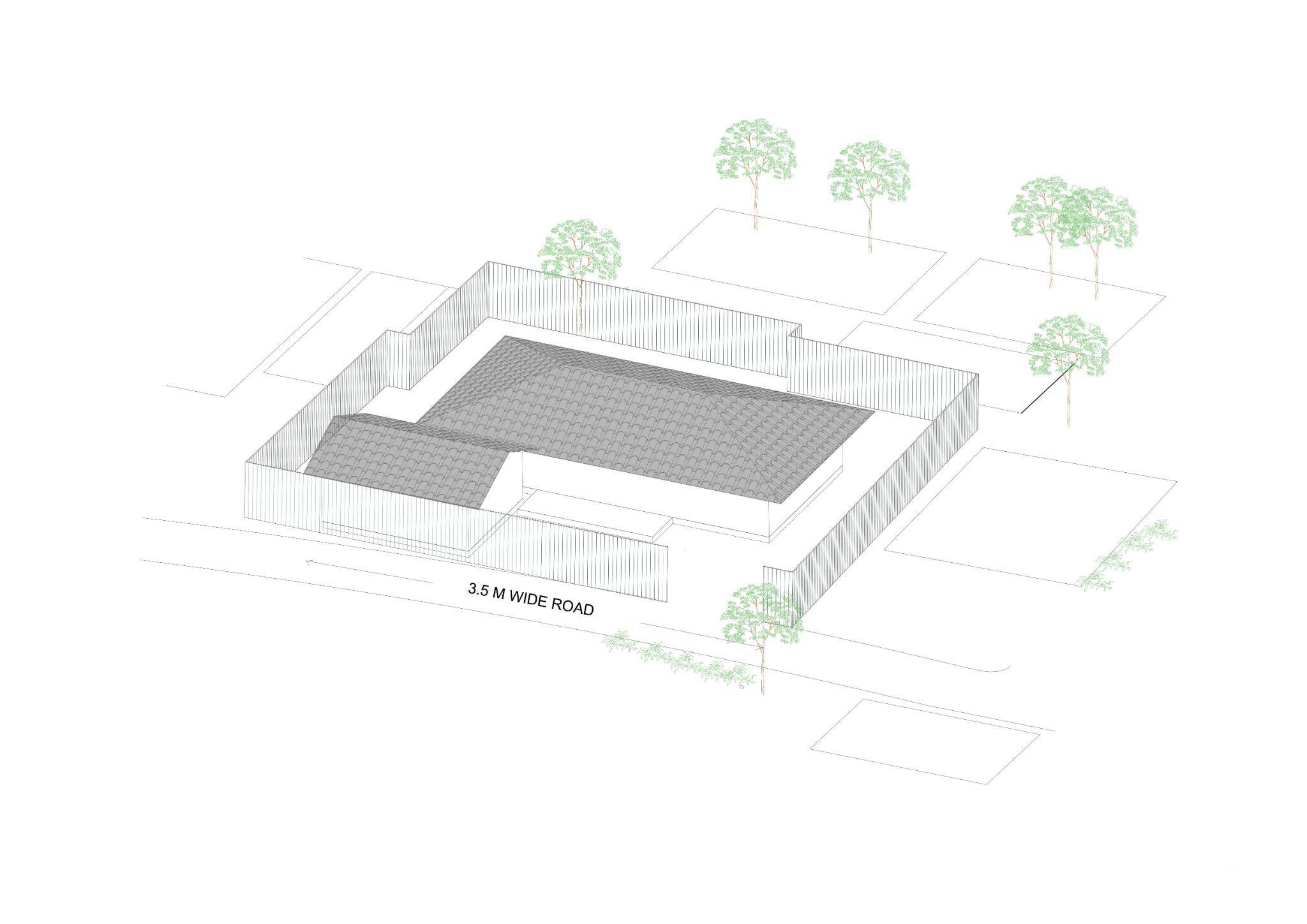

ROOF FRAMEWORK

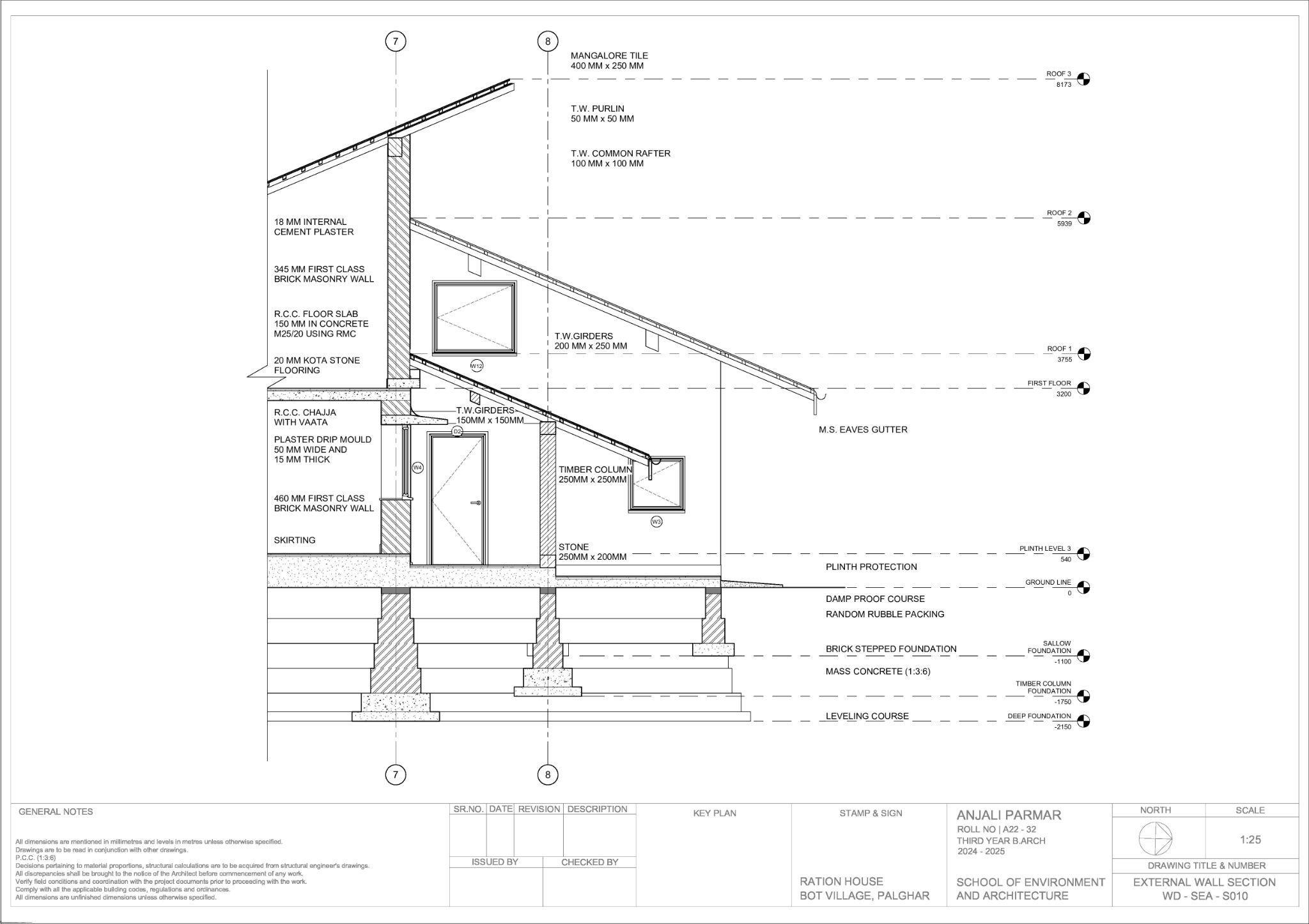

Constructing the mezzanine floor wall followed by the assembly of the timber roofing.

Adding and internal Wall plaster

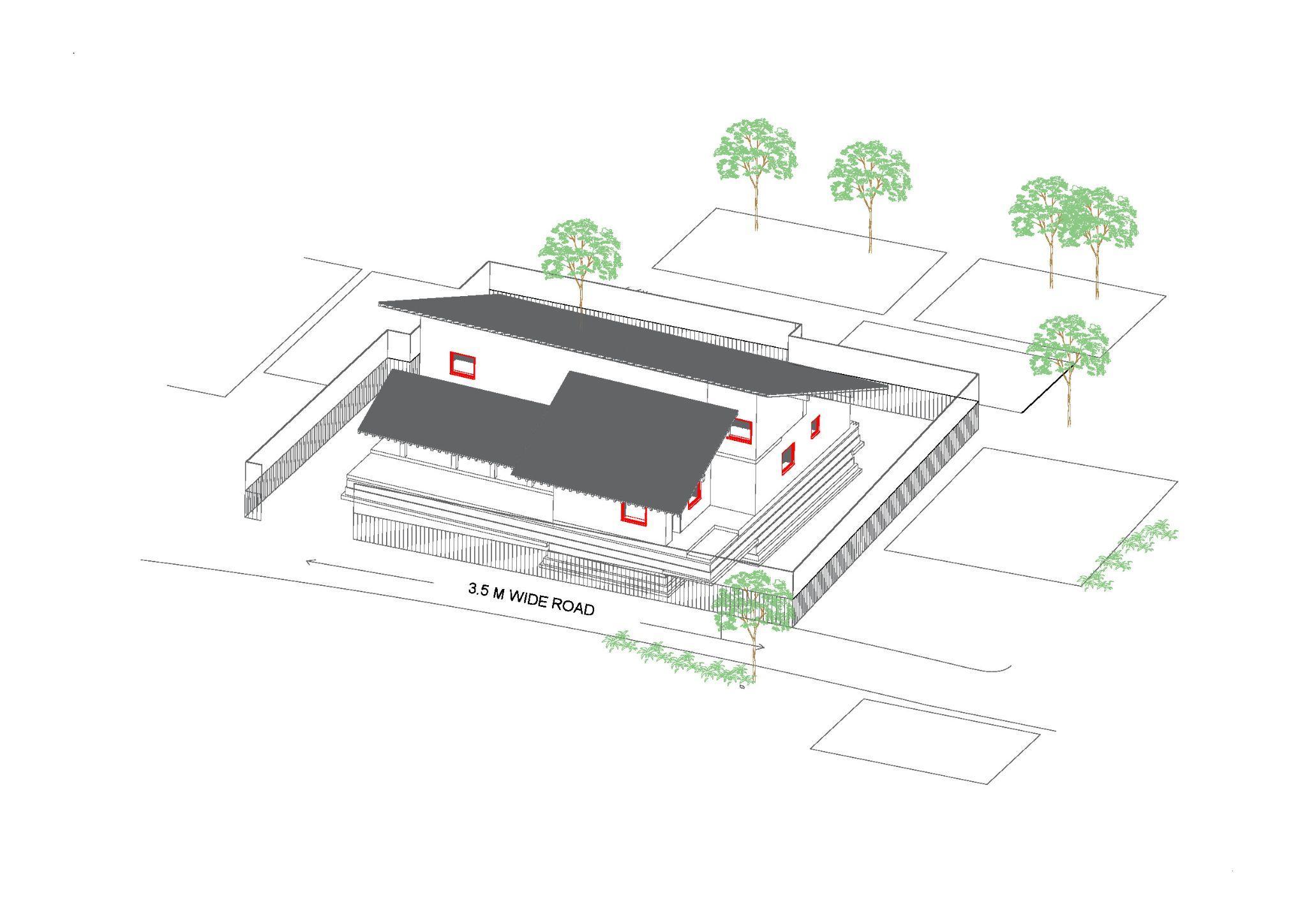

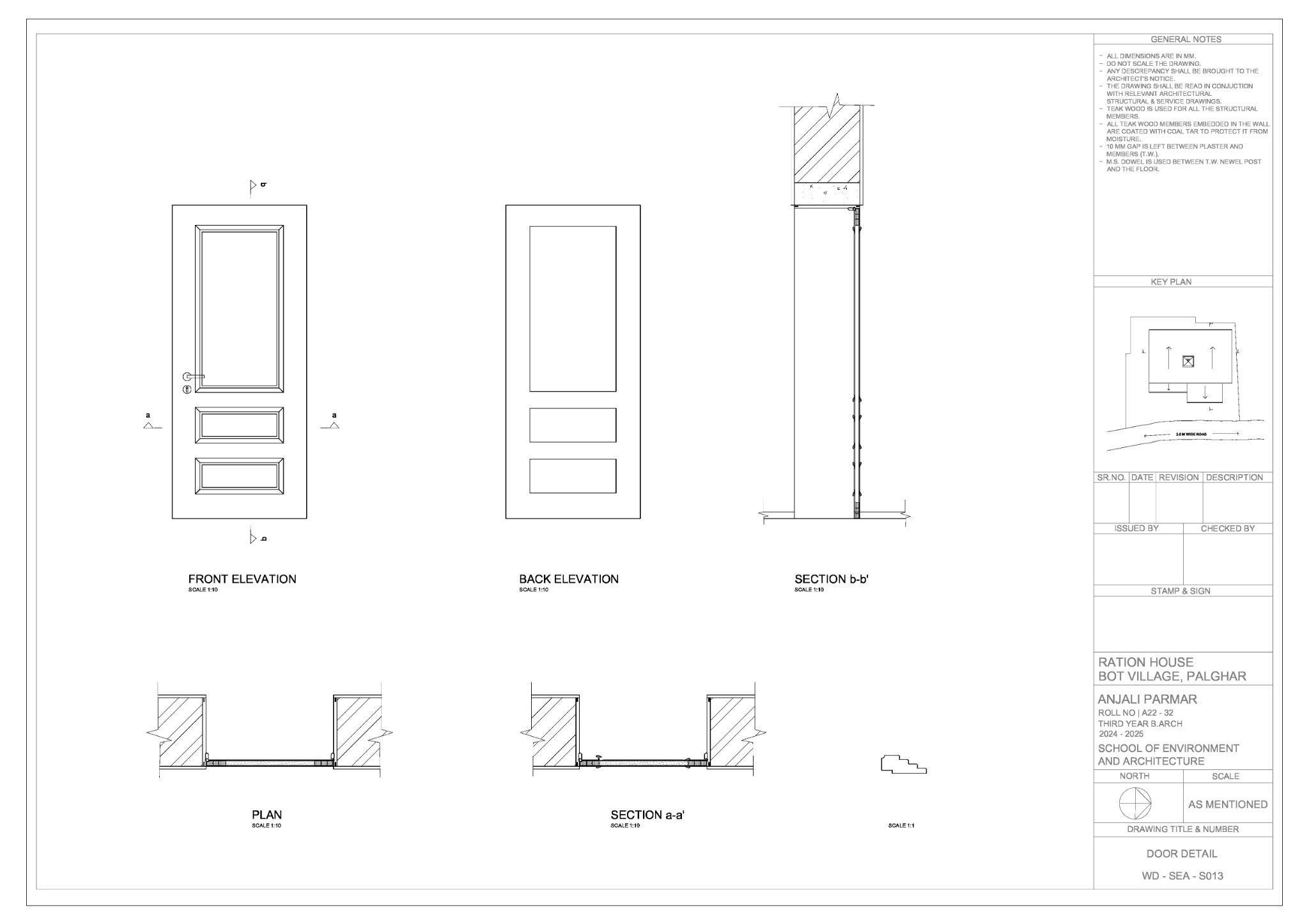

Adding door/ window fixtures

CLEANING AND HANDING OVER THE HOUSE

2024-25_6_BATCH A22_BUILDING MAKING COURSE SCHOOL OF ENVIRONMENT AND ARCHITECTURE

Turn static files into dynamic content formats.

Create a flipbook
Issuu converts static files into: digital portfolios, online yearbooks, online catalogs, digital photo albums and more. Sign up and create your flipbook.
