CONSTRUCTION STRATEGY

Next Article
MATERIAL

MATERIAL

Advertisement

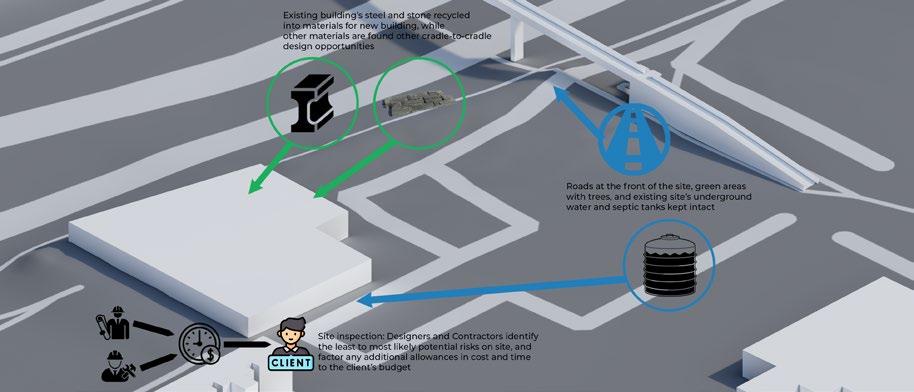

Step 01 begins with the RIBA stage 4 plan of work as specialist subcontractors are incorporated into the construction timeline. Designers identify the feasibility of technical design with potential reuse and recyclability of existing site materials and utilities. As such, different building systems and their respective specialist subcontractors can coordinate with a more ‘turnkey’ approach back to the client’s budget and timeliene.

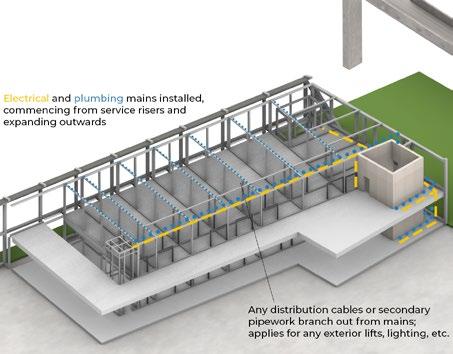

Steps 02 to 14 detail RIBA stage 5 plan of work, from finalising all site logistics and queries, to construction quality inspection of each step in preparation for a final building manual.

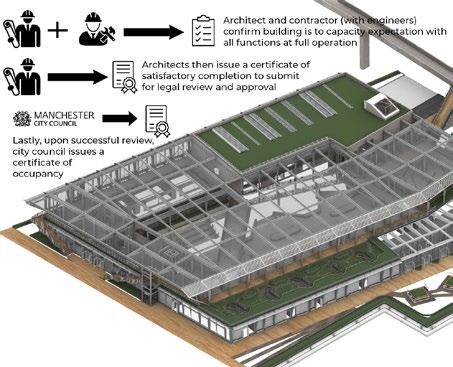

Said manual is the starting point of RIBA stage 6 plan of work, as handover begins from steps 15 to 16, first with legal bodies, then with all client groups as show below.
