Ribbon cutting Ceremony for the Danforth Road Sidewalks Project
The Public Works Department is pleased to release the Project Updates Report for the various divisions- Planning, Capital, TSPLOST, and Engineering, Construction Operations and Maintenance, Traffic Operations & Maintenance, and Solid Waste.
The report is a reference document for all active projects in the City of South Fulton that are in various stages of implementation that include procurement, design, rightof-way acquisition, construction, and maintenance. Also, it outlines other standalone activities/programs, i.e., streetlights, utilities, and traffic calming.
The document is broken into three sections as outlined below:
• SeeClickFix allows residents and business owners to provide City of South Fulton staff with pictures, specific descriptions, and other valuable information needed to get the job done efficiently.
• Transportation Section contains information related to Construction Operations & Maintenance, Traffic Operations & Maintenance, and Utilities. A summary of the Capital Improvement (CIP) and TSPLOST projects is included; however, the factsheets are omitted from this report. Instead, the department launched a web-based real time project reporting tool using this link available on the Public Works homepage.
• The Solid Waste section updates the reader on the residential collection program in the city.
Noteworthy accomplishments include:
March Project Highlights
• Ribbon cutting ceremony was held on March 27th.
• Ribbon cutting ceremony scheduled for April 1st.
• The Massana bridge repair and maintenance work on the 2023 GDOT list began, and significant progress was made to date.
• B 503: Cochran Road over Deep Creek
• OSI 602: Butner Road at Union Road
• OSI 613/615: Old Fairburn Rd at Union Rd/Stonewall tell Rd at Union Rd
• OSI 614: Rivertown Rd at Cedar Grove Road
• PB 900: Danforth Road Sidewalks
• PB 901: Enon Rd Sidewalks
• T266: New Hope Road Sidewalks
• T271/B501: Fairburn Road
•
SECTION I:
The City of South Fulton (COSF) 311 platform provides City officials with a centralized issue management system to manage issues from creation to resolution - engaging City of South Fulton residents throughout the process. The COSF mobile app and web tools allow residents and business owners to provide City of South Fulton staff with pictures, specific descriptions, and other valuable information needed to do the job efficiently. In addition, residents may seek information about city services or report non-emergency incidents by calling the city’s 24hour 311 Call Center at (470) 552-4311

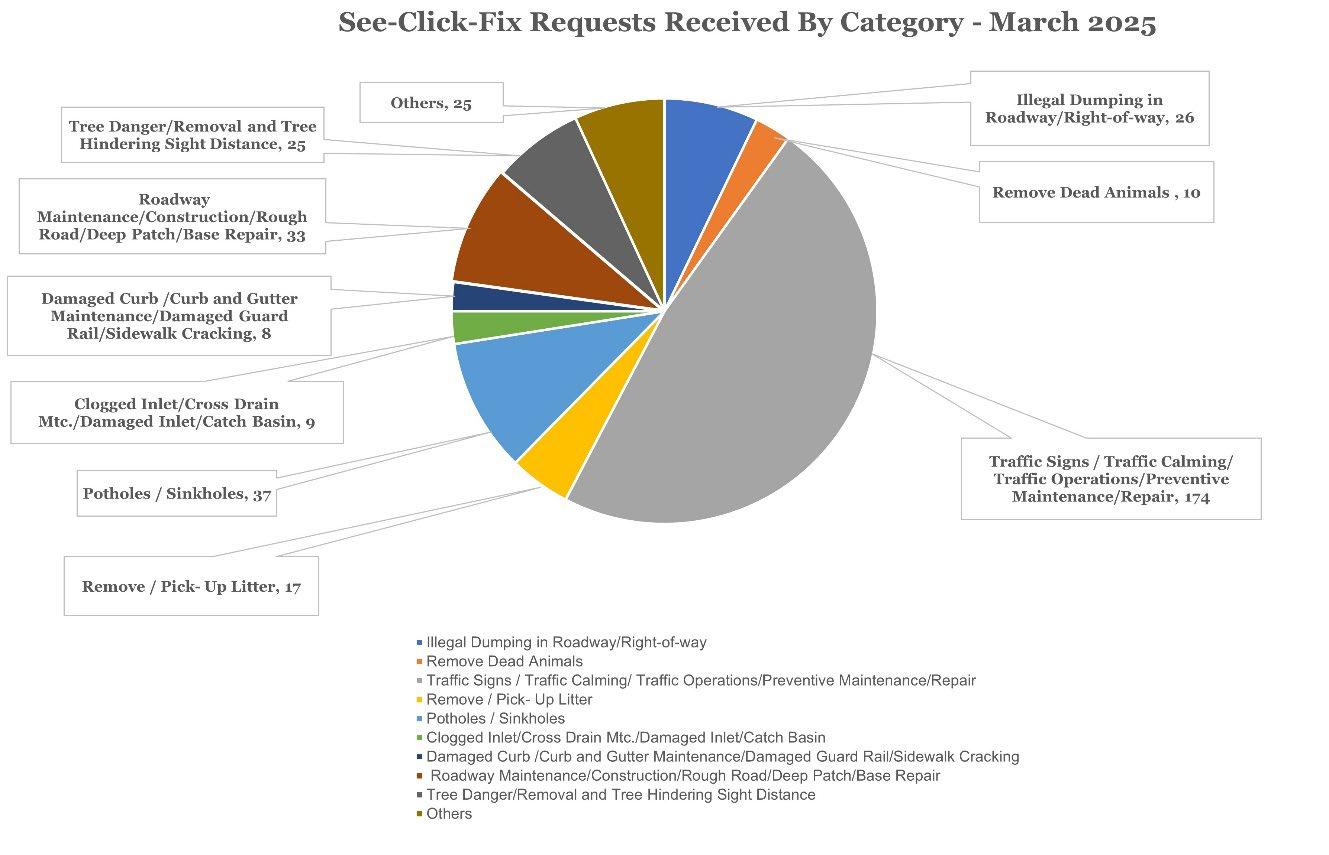

Summary of SCF Requests
Note: Category Others include Manhole Covers, Street Lights, Mowing, and Street Flooding
SECTION II: TRANSPORTATION
The City of South Fulton has a Capital and TSPLOST Program for implementing design projects that have been identified by City staff and stakeholders as a priority. Funding comes from the General Fund, TSPLOST sales tax collections, and some Federal money.
TSPLOST-I program tax collections started in 2017 and ended in 2022. TSPLOST-II program tax collections started in 2022 and will end in 2027. TSPLOST-I projects are being prioritized for completion and all TSPLOST-II projects are in the concept or preliminary design stage.
The delivery of projects is centered around GDOT’s Plan Development Process (PDP). This process typically consists of the four major phases: Design, Environmental Clearance, Right-of-Way (Services and Acquisition) and Construction (including CEI). Additional details of these phases are depicted below, which detail the project development process utilized by Public Works.

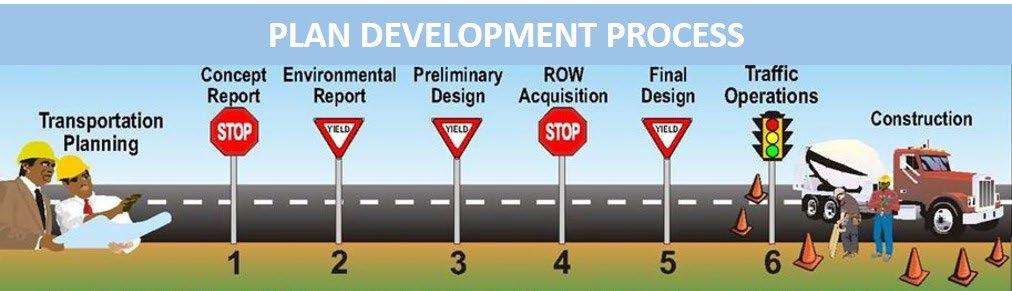

The plan development process, start to finish, is illustrated below:
TSPLOST I: Projects moving toward Construction
SU-700 – Flat Shoals Road ATMS – GDOT is working with the city’s consultant to approve the Encroachment permit. Two parcels recently closed that will allow the city to certify the acquisition of Right-of-Way. The city will prepare an ITB for advertising once the signal plans revisions are approved.
OSI-617 – Welcome All at Jailette Road – Two utilities are in final coordination with the city’s consultant. The City of Atlanta Department of Watershed Management is submitting
an IGA agreement to be approved by the Council in April before the city prepares and advertises an ITB.
B 500/OSI 601 Butner Road at Camp Creek (bridge replacement and intersection improvement) – Final design, utility coordination and ROW acquisition continue in advance of advertisement later this year.
Federally Funded Projects.
T-277 – Cochran Road at Camp Creek (Bridge) – GDOT is sending the authorization to award which will precede April City Council approval. Expecting to have a groundbreaking ceremony following contractor mobilization.
T-265 – Old National Highway Sidewalks – GDOT programmed Letting is June 2025; The city and the design consultant continue to finalize Right-of-Way and utility certification items.
TSPLOST II and Capital Projects
Three TSPLOST II Intersection Improvement projects - Aldredge Road and Merk Road, Union Road and Thames Road, and Ono Road/Hobgood Road at Rivertown Road recently advanced to preliminary design. One Bridge Replacement project – Stacks Road over CSX RR also started preliminary design. All will begin ROW plan development then land acquisition later this year.
One TSPLOST II Intersection Improvement project - Bethsaida Road at Creel West and one Sidewalk project – Union Road are in the Concept development and alternative selection stage and will be to public meetings. Designs will be validated and authorized after concept completion and public meetings.
Three TSPLOST II Intersection Improvement projects - Butner Road at Aldredge Road, Bethlehem Road, and Cedar Grove Road, and Old Fairburn Road at Thaxton Road - are in further revision by the design consultant for further next steps. Designs will be validated and authorized after concept completion and public meetings.
One TSPLOST-II Sidewalk project - Bethsaida Road is nearing concept completion and will be prepared for a public meeting in May to be held jointly with the Bethsaida Road at Creek West project.
Two TSPLOST II Sidewalk projects – Cascade Road and Flat Shoals Road are starting the concept design phase.
Three TSPLOST II Bridge/Culvert projects – Derrick Road, Koweta Road, and Oglesby Road recently entered the concept design phase.
The Jones Road and Hall Road gravel road paving and culvert replacement projects are being prepared for public meetings, tentatively in the 3rd and 4th weeks of April. Design will be validated and authorized after the public meetings.
Three gravel road paving projects - Rocky Head Road, Thames Drive, and Oxford Road are being prepared for public meetings. Rocky Head will have a joint public meeting with Union Road Sidewalk. Design for all three projects will be validated and authorized after the public meetings.
GDOT Projects within South Fulton
PI0011845/OSI-624: SR 14 at Washington Road Roundabout construction continues with grading operations with a projected completion in late 2025.
PI0013938 & PI0013939/T-272 & T-273: Buffington Road Projects - Road widening and sidewalks ROW clearance continues in advance of both overhead and underground utility work stage continues. Work on retaining walls is continuing. Projected completion in the summer of 2026.
PI0015593/T-285: SR 92 @ Butner Rd/Ridge Rd Roundabout – has a June 2025 Letting.
PI0015642/T-280: Oakley Road over Broadanax Creek - Project completion TBD, with a detour still on-hold pending GDOT resolving a ROW issue and a Comcast utility issue.
PI0017398/OSI-605: SR 92 @ Jones Road/Demooney Road Roundabout – Design continuing following the PFPR that was held December 2024; ROW Authorization expected by January 2026. Let Date early 2027.
PI0019647: FIB and Westpark – Concept is under development.
PI0019841: SR 138 at Bethsaida Road – Concept is under development and a public meeting was held in March 2025. Letting is expected in 2027.
Bridge Repairs and Maintenance – Work continues on three bridges from the 2021 GDOT bridge repair set. Two of these (Mallory and Cascade) are in coordination with the CSX railroad and one (Burdett) will require a partial wing wall repair that is under design until June. The 2023 GDOT bridge work started in March - nine bridges are complete.
B503: Cochran Rd over Deep Creek
MONTHLY PROGRESS REPORT

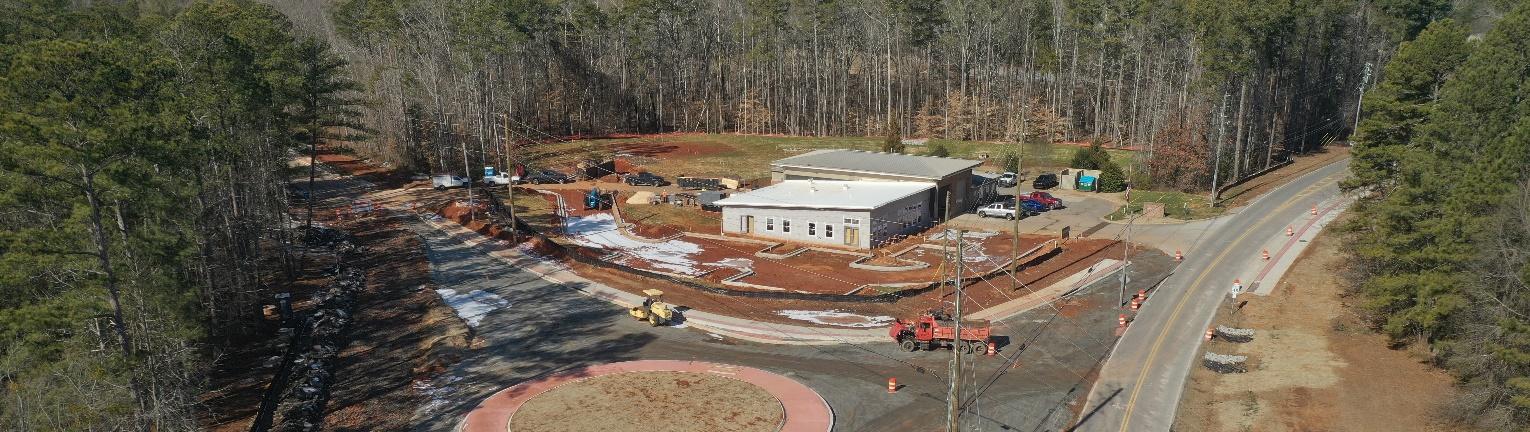

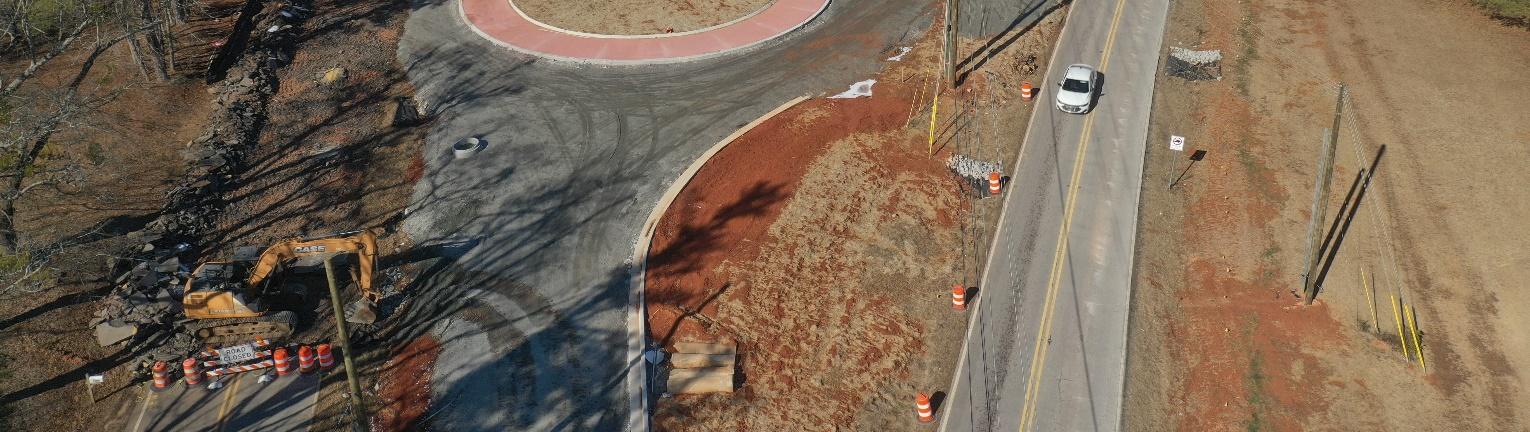

Butner & Union Road Roundabout Project
Period Begin thru
03/01/2025
Prime Contractor: SD&C INC.
Contractor Rep.: Greg.
Period End
03/31/2025
Time Charges Begin Date 01/24/2024
Scheduled Completion Date 04/25/2025
Work Begin Date 03/22/2024
Phone: 770-873-5171
Name Contact Company
WECS: KENNY COLEMAN 470-894-5609 REDROCK LAND SERVICES LLC
WTCS: Greg 404-288-2205 SD&C INC
WUCS: Greg 404-288-2205 SD&C INC
Scope of Work for this Month
Work Breakdown Structure (WBS) and performance report:
1. Erosion Control and Traffic Control Maintenance
2. Seed for Permanent Grassing (40+70 to 23+00), including Mulching
3. Fill in holes on roadway as a result of pole removal by GreyStone
4. Removal of silt fence STA 21+00 To STA26+00 RT, STA30+00 To STA38+00
5. Grading on shoulders and driveways.
Progress Schedule
As of the time of this report our estimated level of completion is 72% of the entire project.
At this stage of the project, The City of South Fulton has given permission to install road closure for the new traffic pattern to take effect. With this in place, we can then complete all outstanding work on the project
Scope of Work Planned For Next Month.
This is subject to the completion of the relocation of the utility poles
1. Continue asphalt work on roadways and driveways.
2.Completion of traffic circle construction.
3. Permanent grassing on slopes.
4.Completion of curb and gutter and sidewalk installation.
5.Traffic and Erosion control maintenance.
6.Continue installation of Drainage Structures and Storm Drain installation (B-12 to B-13, B-13 to B-14, B-14 to B-15)
Progress Photos are attached on the following pages

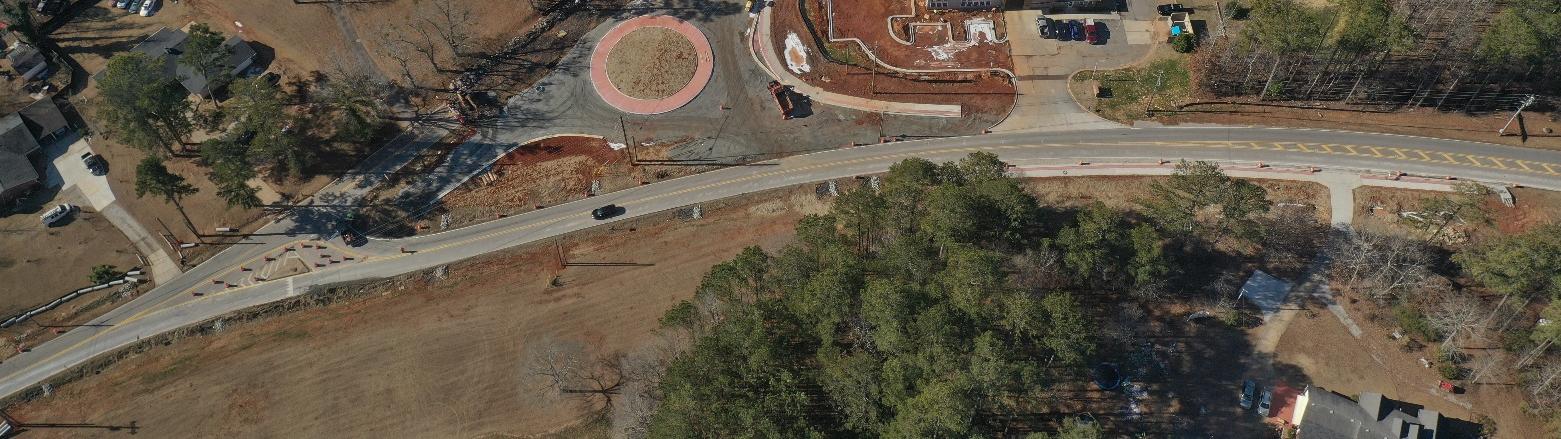

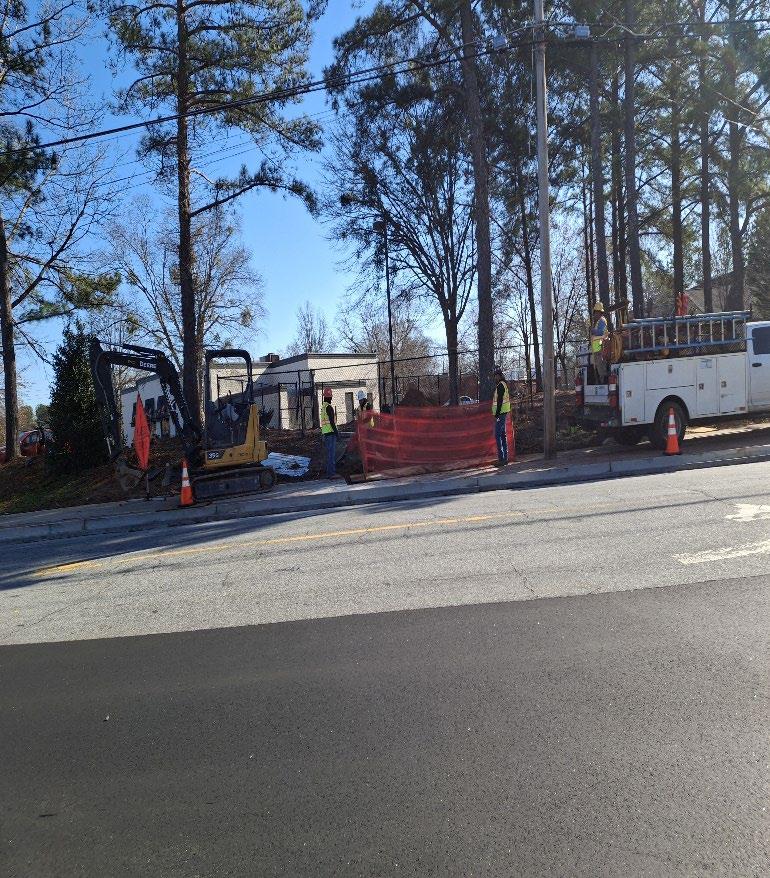

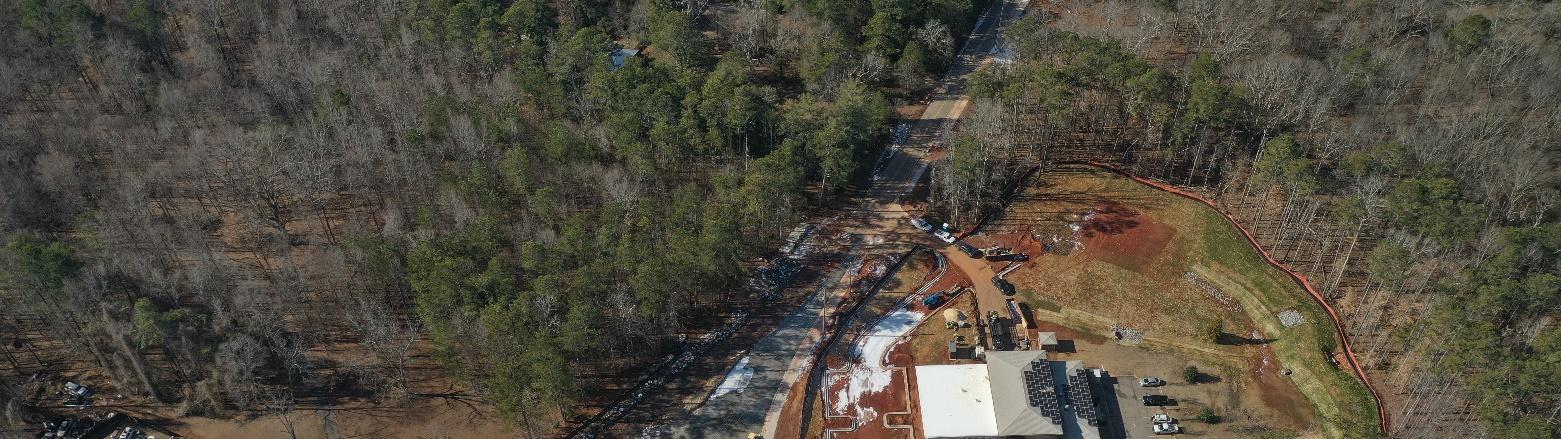

SD&C on-site grading radius for sidewalk along Butner Road and Union Road

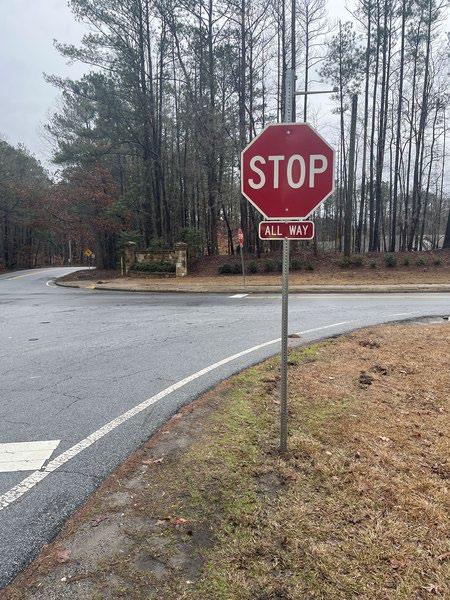

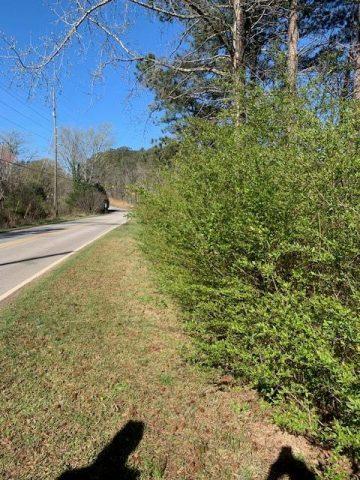

SD&C on-site removing silt fence from established vegetation areas (44+34 to 40+85) on Butner Road and Union Road
Smile Piping on site installing storm drain (21+00 to 22+00) along Butner Road

SD&C on-site placing color concrete for medians (20+67 to 21+50) along Butner Road
Triple R Paving on-site placing asphalt (leveling) along Butner Road and Union Road
Prime Contractor: Contractor Rep.:
MONTHLY PROGRESS REPORT
OSI 613 and 615 Old Fairburn Rd Roundabouts
Period Begin
Period End 3/31/2025
Time Charges Begin Date 1/10/2025
Scheduled Completion Date 4/30/2026
Work Begin Date 3/6/2025
Summit Construction and Development, LLC
Olumayowa Odumade Phone:
Olumayowa Odumade
Olumayowa Odumade
Olumayowa Odumade Name
470-636-2859
470-636-2859
470-636-2859 Contact
Scope of Work Performed This Month
Installed work zone signs
470-636-2859 Company
Work items performed between the monthly report dates detailed above:
Placed traffic control devices such as barrels and cones on site
Installing initial erosion control
Progress and Schedule
The Physical Project Status is 7% completed as of the period ending date above.
The targeted Project Schedule Status was predicted to be 7% as of the period ending date above.
Scope of Work Planned For Next Month 3/1/2025 thru

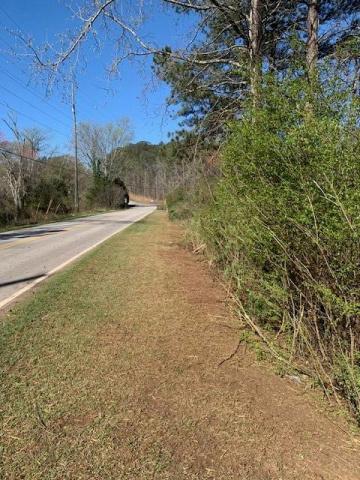

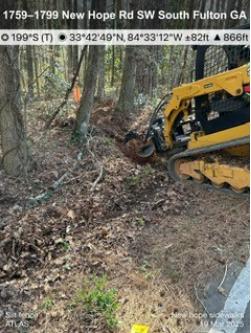

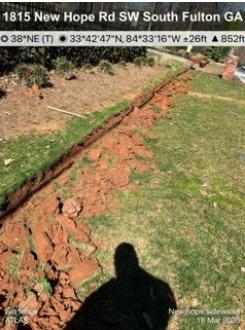

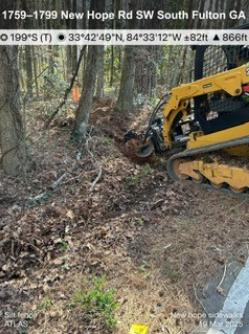

Tree clearing and grubbing operations
Continue erosion control installation
Prime Contractor:
Contractor Rep.:
CMC, Inc.
Sid Balar
MONTHLY PROGRESS REPORT
OSI614 Rivertown Road at Cedar Grove Road
Period Begin 3/1/2025 thru
Period End 3/31/2025
Time Charges Begin Date 2/1/2024
Scheduled Completion Date 6/30/2025
Work Begin Date 3/27/2024
Phone:
678-283-5760
ContactCompany
Riddhish Baldha
Riddhish Baldha
Siddharth Balar Name
470-894-5609
470-894-5610
678-283-5760
Scope of Work Performed This Month
CMC, Inc.
CMC, Inc.
CMC, Inc.
Work items performed between the monthly report dates detailed above:

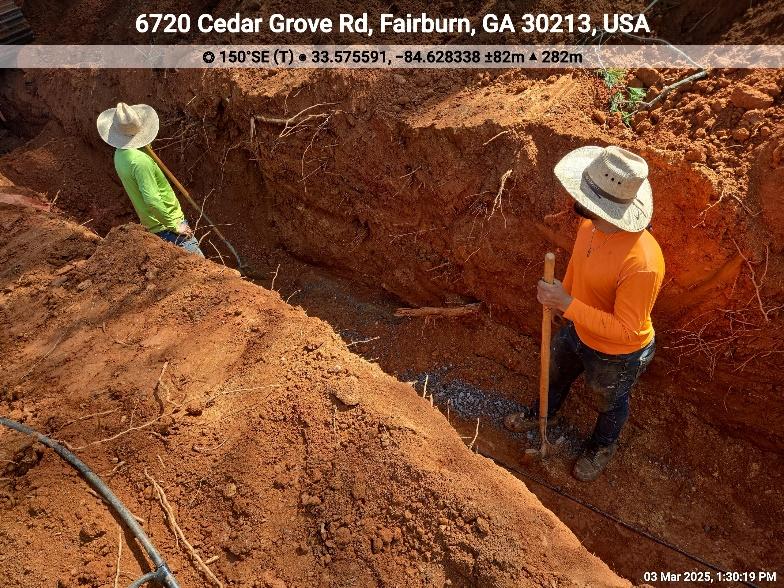

Traffic shift currently in Stage 1 and prepping for Stage 2.
Concrete poured for curb and gutter, ADA ramps, sidewalk, and storm drain structures on Rivertown Rd.
Comcast utility relocations completed. AT&T scheduled to be complete 3/31. Atlanta Gas Light began relocating gas main on 3/24 and scheduled to be complete by 4/1.
Grading subgrade and GAB.
Progress and Schedule
The Physical Project Status is 71% completed as of the period ending date above.
The targeted Project Schedule Status was predicted to be 82% as of the period ending date above.
Project delays have been related to unforeseen utility delays related to water, cable, and power and obtaining easement from Fulton County on Parcel 2.
Scope of Work Planned For Next Month
Traffic shift to Stage 2 projected to occur on April 15, 2025. Note Stages 2 and 3 should occur within a 30-day duration. Stage 2 detour signage will be placed.
For the Stage 2 detour, traffic will be temporarily detoured along the signed detour route following Virlyn B. Smith Road to Roosevelt Highway (US 29 / SR 14) to Hobgood Road to navigate around the closure.
Complete gas line relocation and complete storm drain pipe installation on Rivertown Rd.
* Asphalt paving to occur on Rivertown Rd and at the roundabout to prepare for the reopening of the closed section of Rivertown Rd.

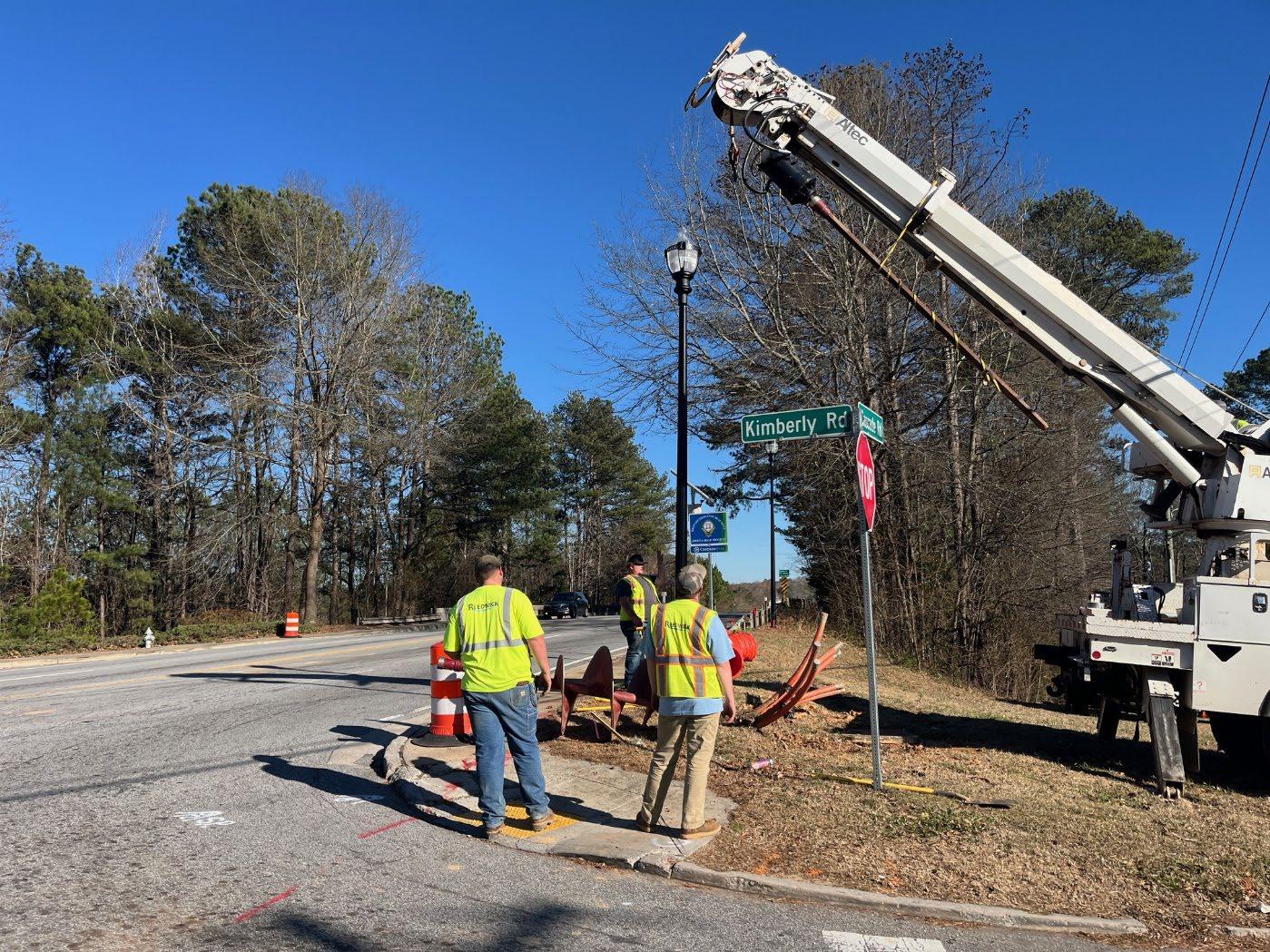

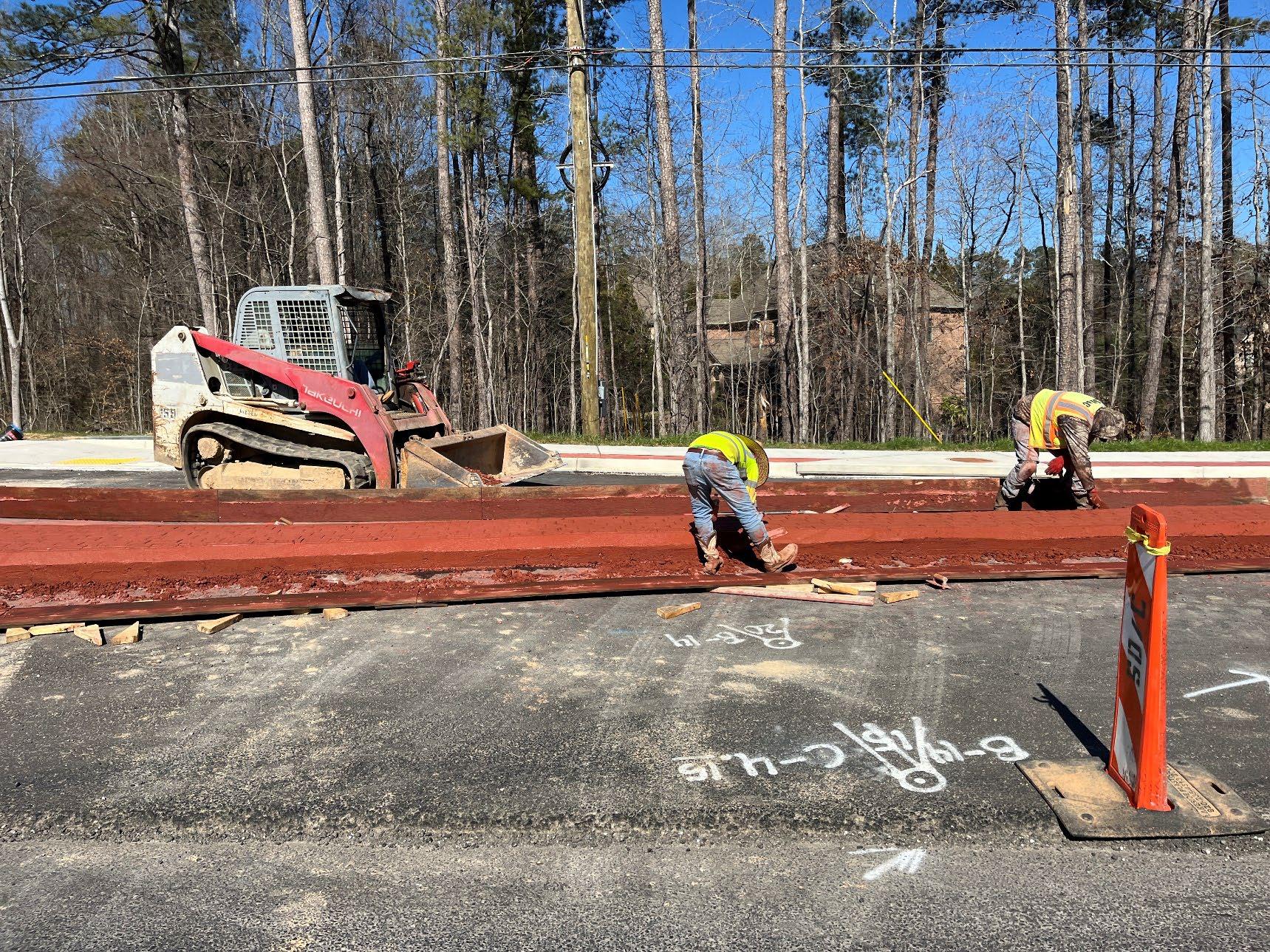

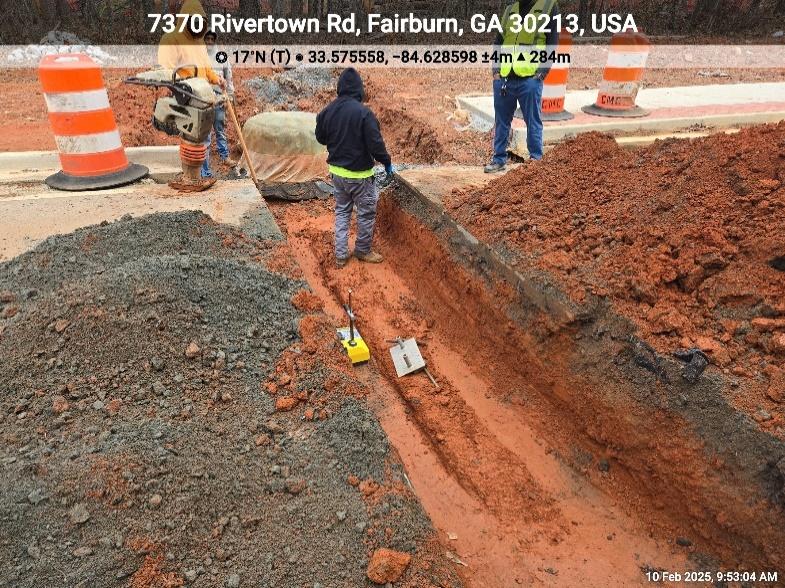

Progress Photos are attached on the following pages

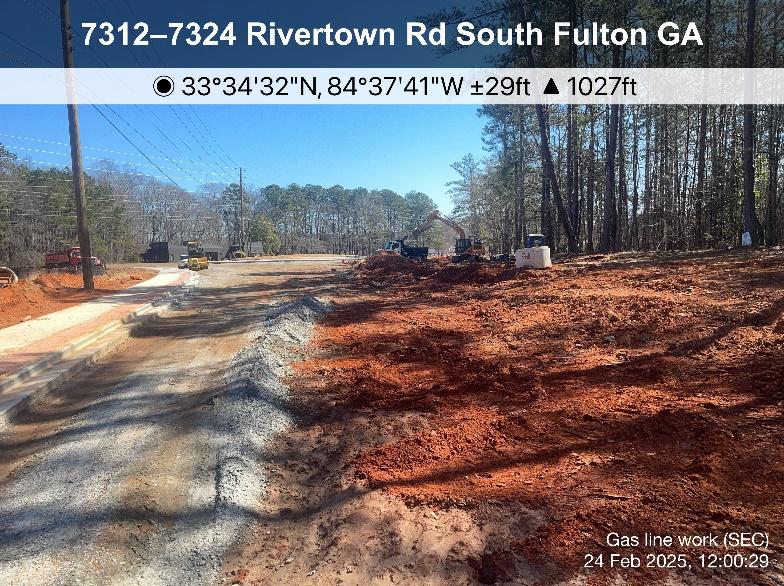

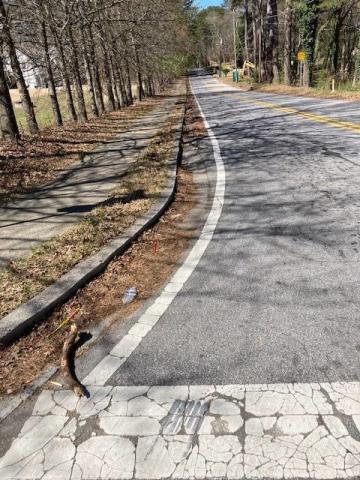

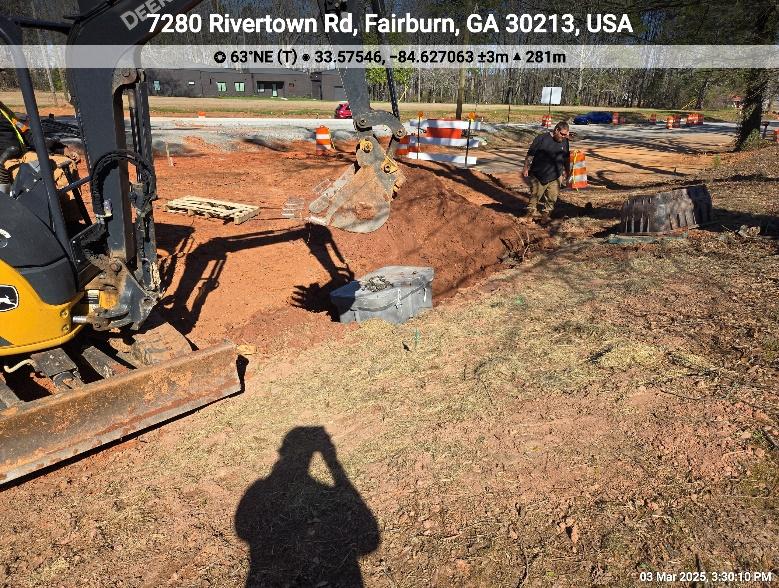

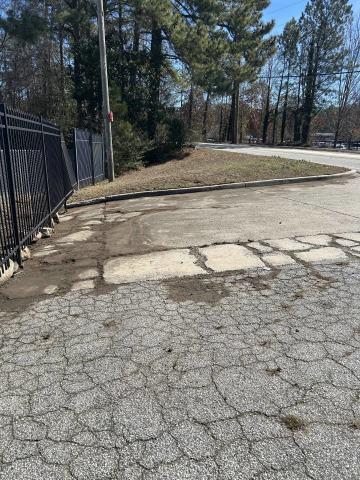

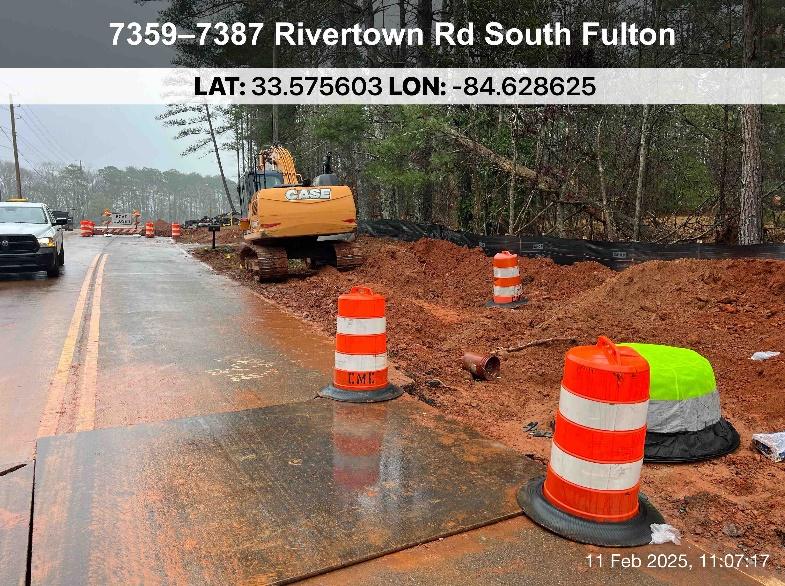

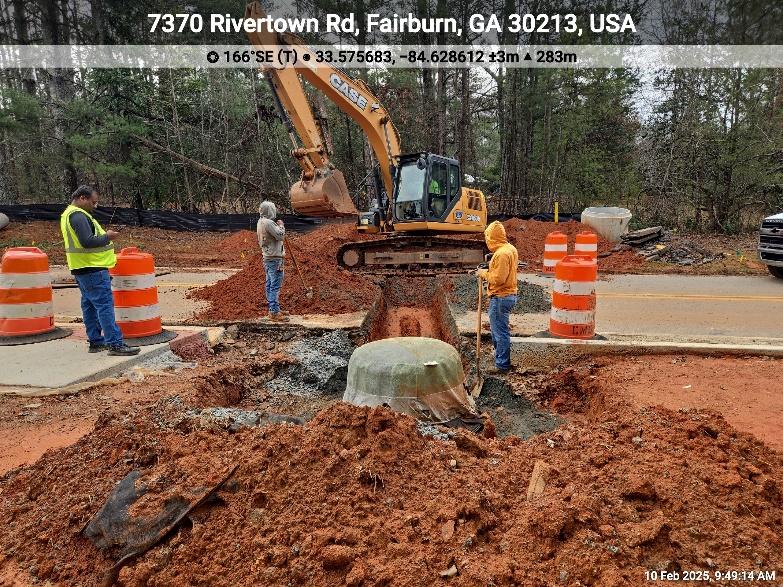

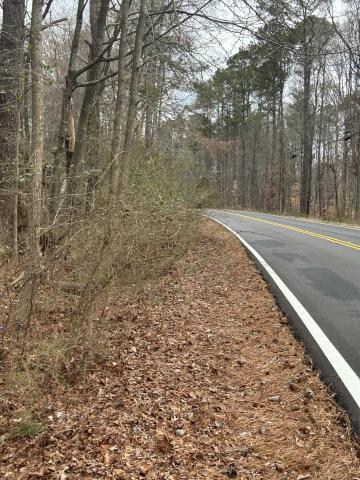

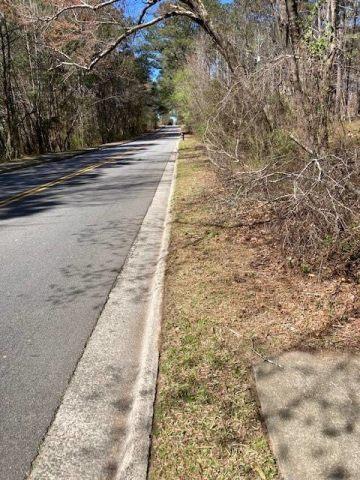

OSI614 Rivertown Road at Cedar Grove Road
OSI614 Rivertown Road at Cedar Grove Road

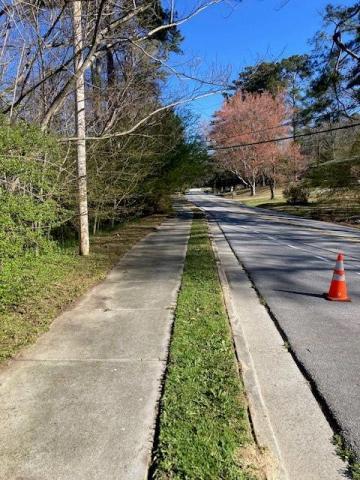

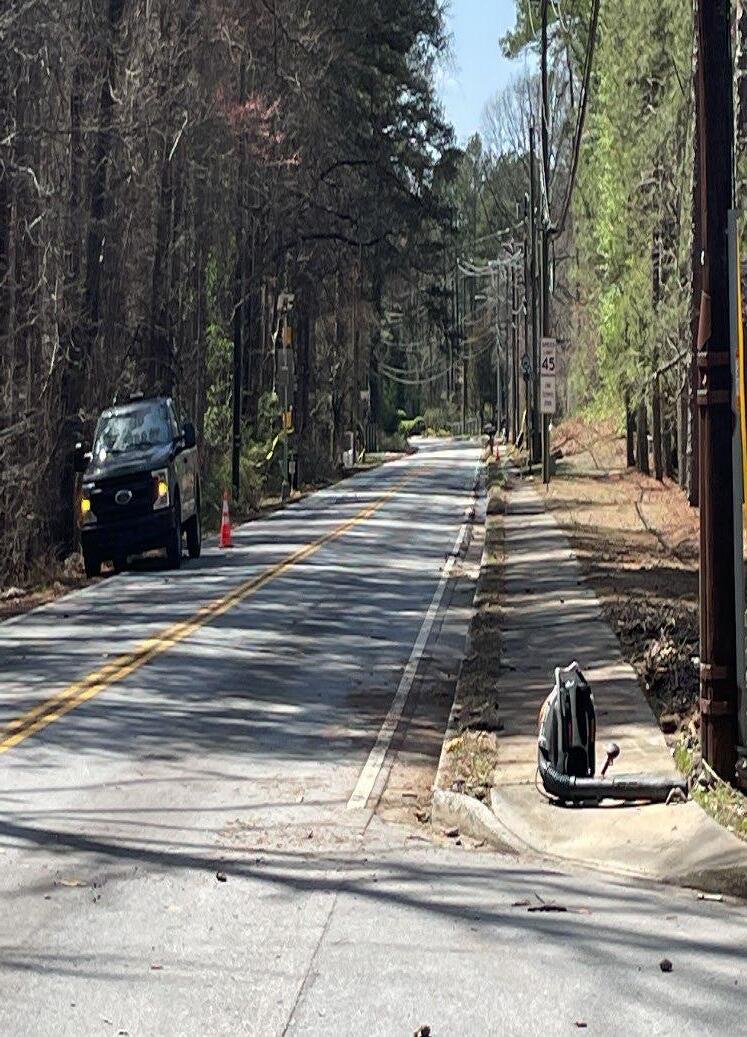

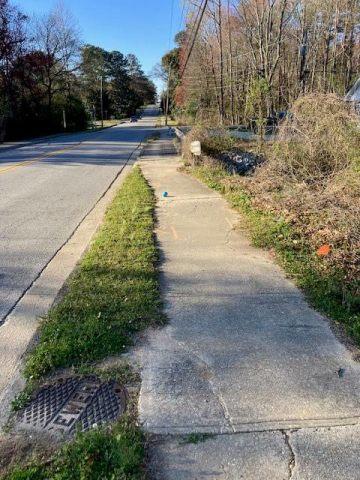

P900: Danforth Rd Sidewalks
Prime Contractor: Contractor Rep.:
DAF Concrete
MONTHLY PROGRESS REPORT
P901 Enon Road Sidewalk Improvements
Period Begin
Period End 3/31/2025
Time Charges Begin Date 4/10/2024
Scheduled Completion Date 3/12/2025
Osvaldo Sanchez Phone:
Contact
Osvaldo Sanchez
Itorah Udoh
Maria Arboleda Name
404-395-8464
404-747-0885
470-883-7997
Scope of Work Performed This Month
Completed 99% of pay items.
Guardrail Installation complete.
Work Begin Date 4/15/2024
404-395-8464
Company
DAF Concrete
Safeway LLC
DAF Concrete
Work items performed between the monthly report dates detailed above:

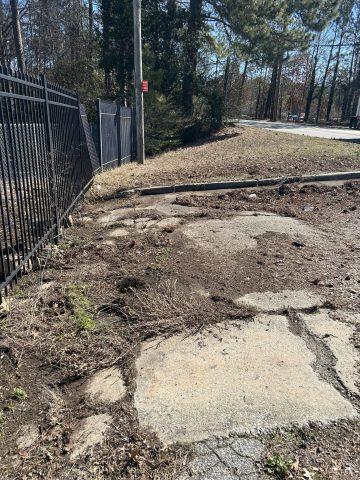

SEC on site performing utility work and replacing sidewalk damaged by their work.
Ribbon Cutting Ceremony scheduled for April 17, 2025 at 10am.
Progress and Schedule
The Physical Project Status is 99% completed as of the period ending date above.
The targeted Project Schedule Status was predicted to be 65% as of the period ending date above.
Scope of Work Planned For Next Month 3/1/2025 thru
Complete all remaining pre-punch list work.
Hold Ribbon Cutting Ceremony.

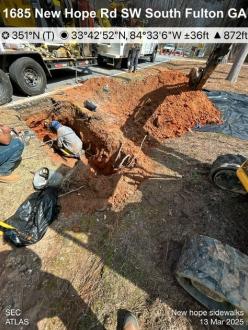

Progress Photos are attached on the following pages
DAF Concrete
MONTHLY PROGRESS REPORT PI 0012637 New Hope Rd Sidewalk Improvements
Period Begin
Period End 3/31/2025
Time Charges Begin Date 9/12/2024
Scheduled Completion Date 3/12/2026
Work Begin Date 3/10/2025
Osvaldo Sanchez Phone:
Contact
Osvaldo Sanchez
Itorah Udoh
Maria Arboleda Name
404-395-8464
404-747-0885
470-883-7997
Scope of Work Performed This Month

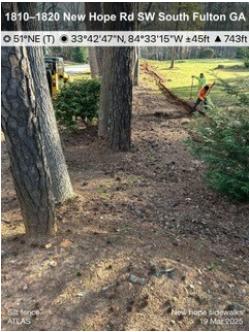

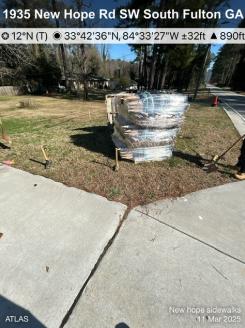

Installed work zone signs

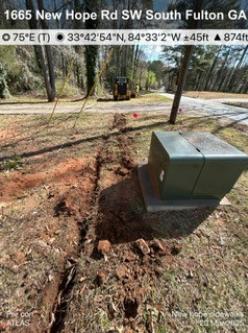

Utility locates

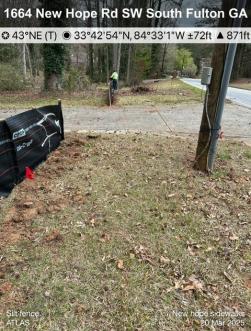

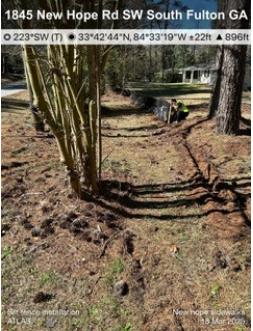

Installing silt fence and orange barrier fence
Progress and Schedule
404-395-8464
Company
DAF Concrete
Safeway LLC
DAF Concrete
Work items performed between the monthly report dates detailed above:

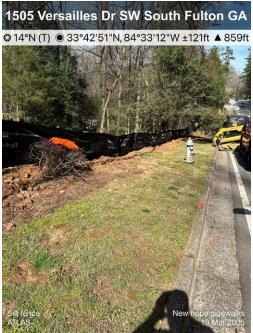

The Physical Project Status is 5% completed as of the period ending date above.
Scope of Work Planned For Next Month 3/1/2025 thru
Prime Contractor: Contractor Rep.: Progress Photos are attached on the following pages
The targeted Project Schedule Status was predicted to be 14% as of the period ending date above.
Mobilization to begin sidewalk construction once silt fence and initial BMP installation is complete.
MONTHLY PROGRESS REPORT

Fairburn Road Upgrade Project
Period Begin thru Period End
02/20/2025
Prime Contractor: SD&C INC.
Contractor Rep.: T. BUAH
03/20/2025
Time Charges Begin Date 5/19/2024
Scheduled Completion Date 5/30/2026
Work Begin Date 6/24/2024
Phone: 678-334-7788
Name Contact Company
WECS: KENNY COLEMAN 470-894-5609 REDROCK LAND SERVICES LLC
WTCS: SD&C INC 404-288-2205 SD&C INC
WUCS: SD&C INC 404-288-2205 SD&C INC
Scope of Work Performed This Month
Work Breakdown Structure (WBS) and performance report:
• Atlanta Gas Company contractor Primoris/Pride has completed about 70% the installation of 6” gas line pipe by combination of digging and directional boring
• SD&C subcontractor T&J has welded up 48 inches casing of about 180 feet for the bypass. A 30 inches pipes has been joined and enroot into a 100 feet casing, set to be ready for installation on South Utoy A pumping machine with water hoes set in place by South Utoy Creek ready to pump water from South Utoy Creek to the North Utoy Creek.
• Backflow and water meters to Chick-Fill -A has been relocated.
• Erosion control and onsite maintenance
Progress and Schedule

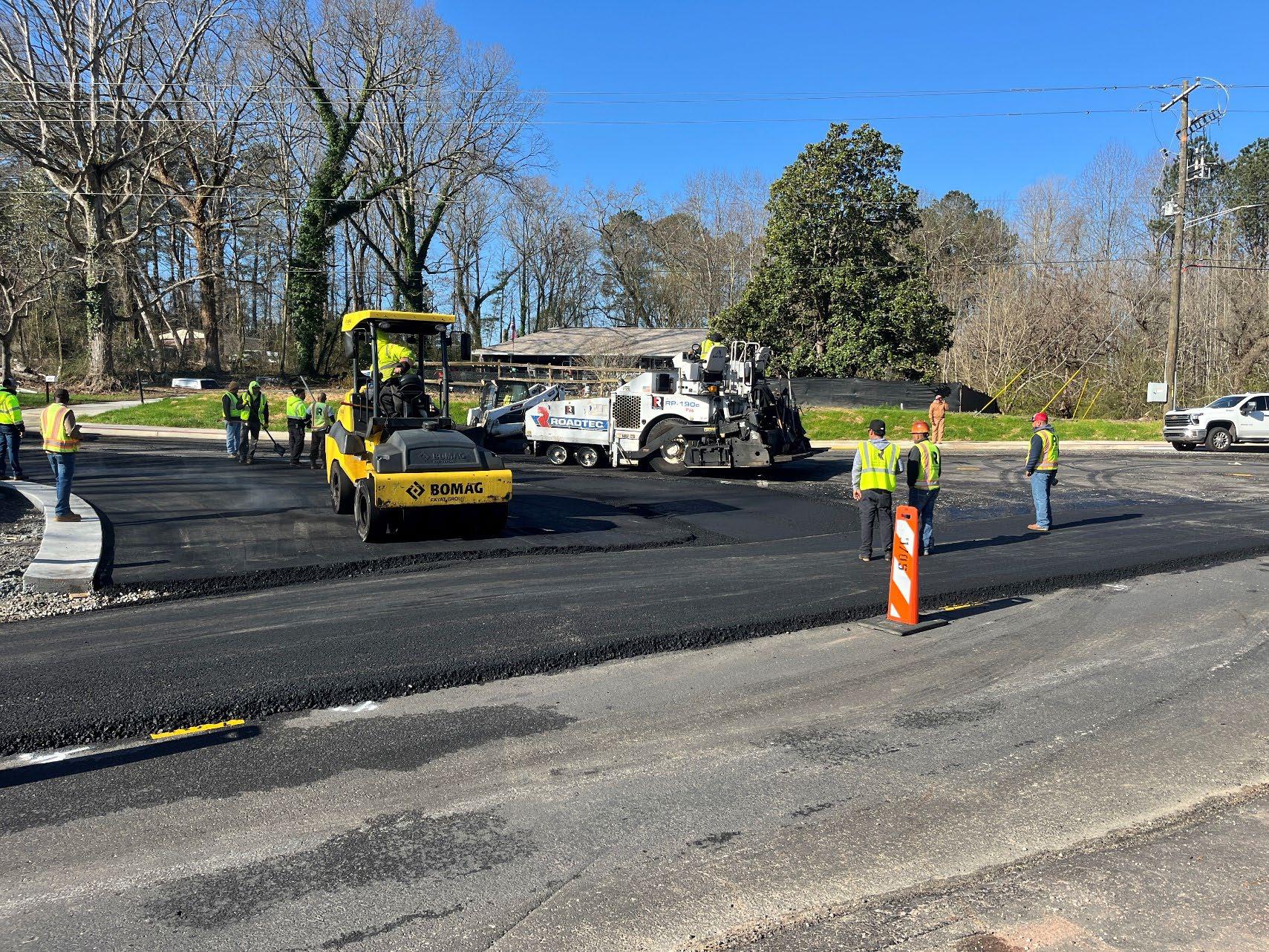

• 45% completion of grading, GAB, Curb & Gutter, sidewalk installation, Traffic Signal Installation and Storm drain installation.
• GA Power utility poles relocate, 0% complete, AT&T and Comcast completion 0%. Gas line work completion 40%
Scope of Work Planned for Next Month
• Grading, Placing G.A.B and Continuing Constructing Sidewalk, Color Stamped Concrete Beauty Strip and Medians; Pavement widening from Station: 146+00 LT to 147+00 LT and 49+00 RT to 50+00 RT, 145+17RT to 145+60 RT, 50+81 to 51+40RT
• Relocate Fire Hydrant and Water Meters
• Relocation of Backflow Preventor at Walgreens being relocated by others
• Water mains Bypass installation
• Build a dam on South Utoy Creek.
• Erosion Control

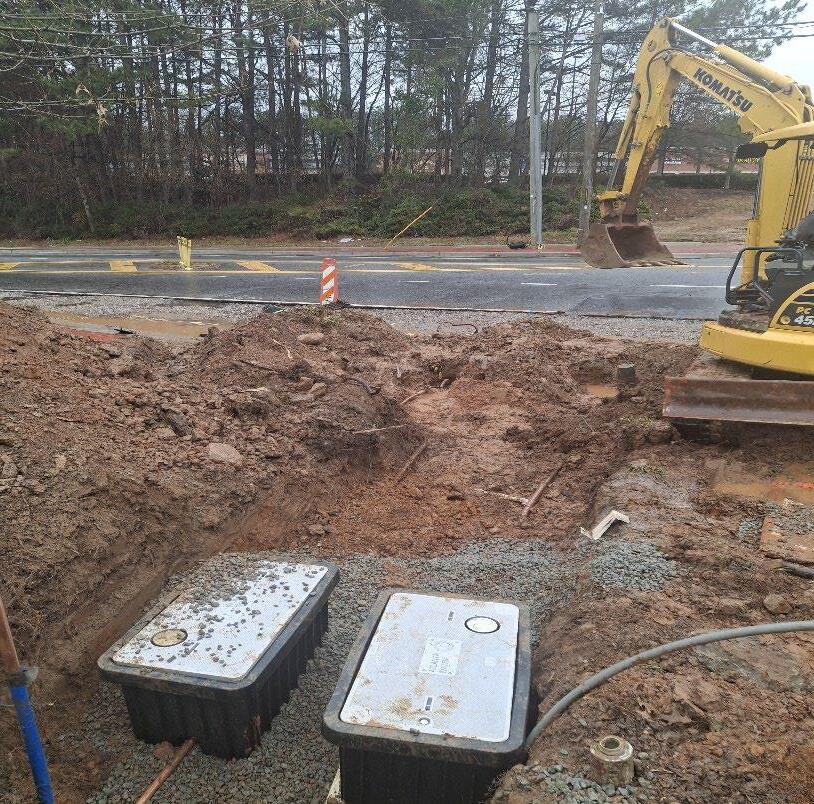

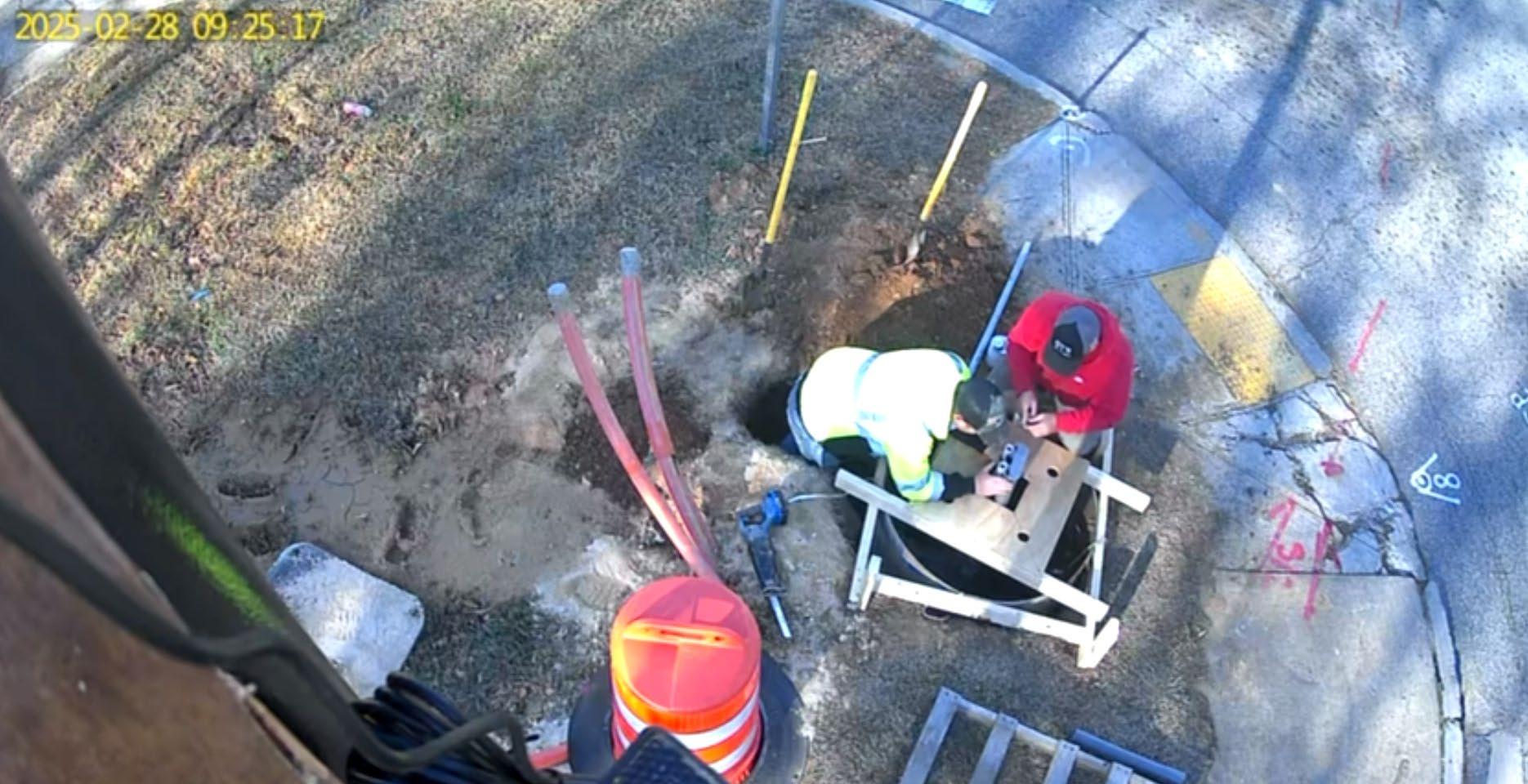

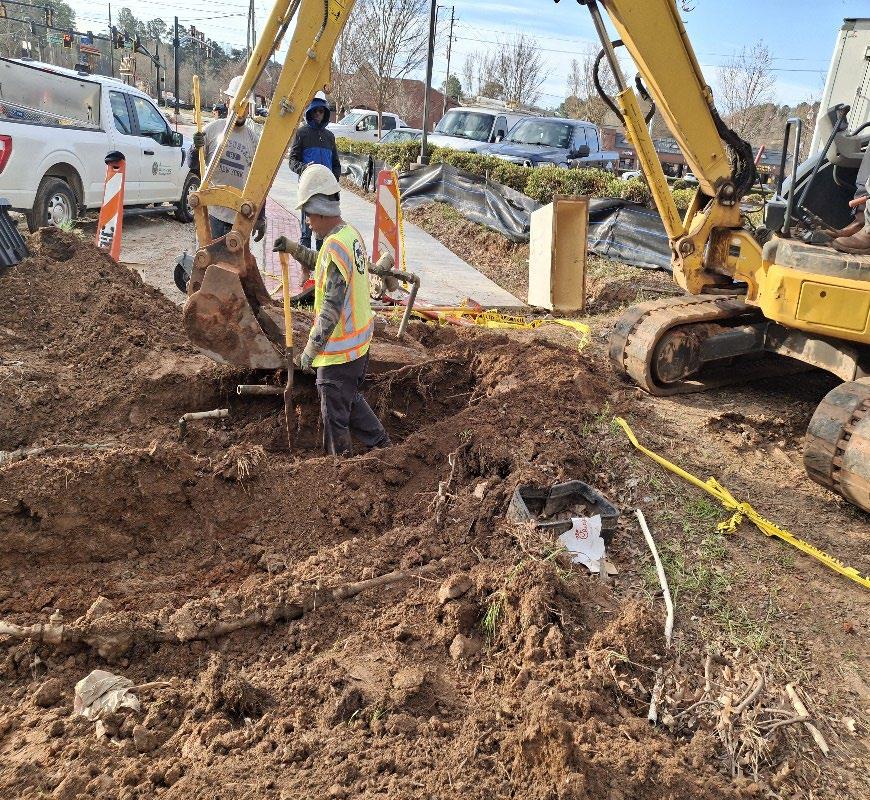

Gas line Installation by Primoris
Bypass Casing Fabrication

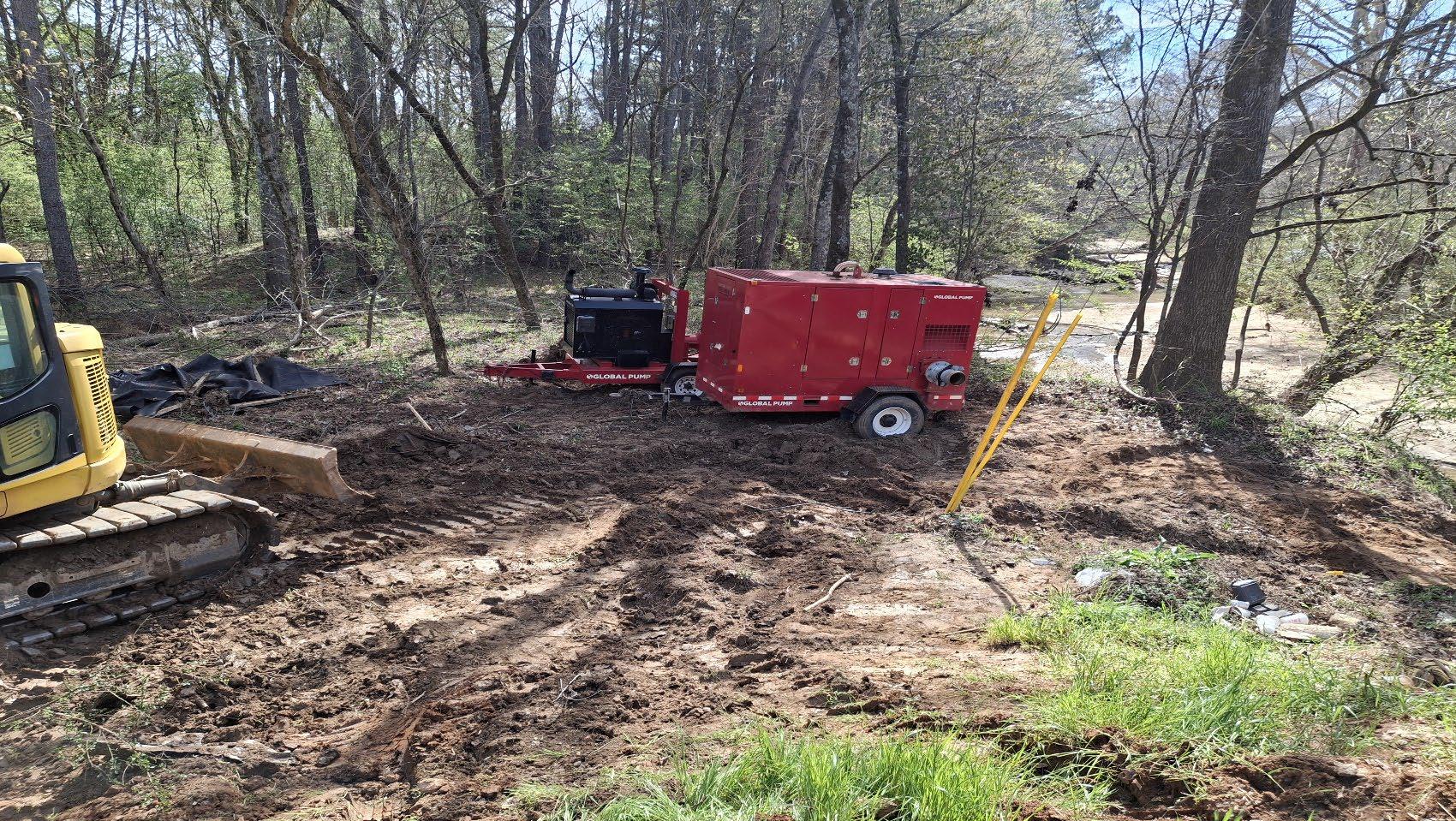

Pumping Machine
Backflow Preventor & Water Meters Relocate for Chick -Fill-A
Work items performed between the monthly report dates detailed above:

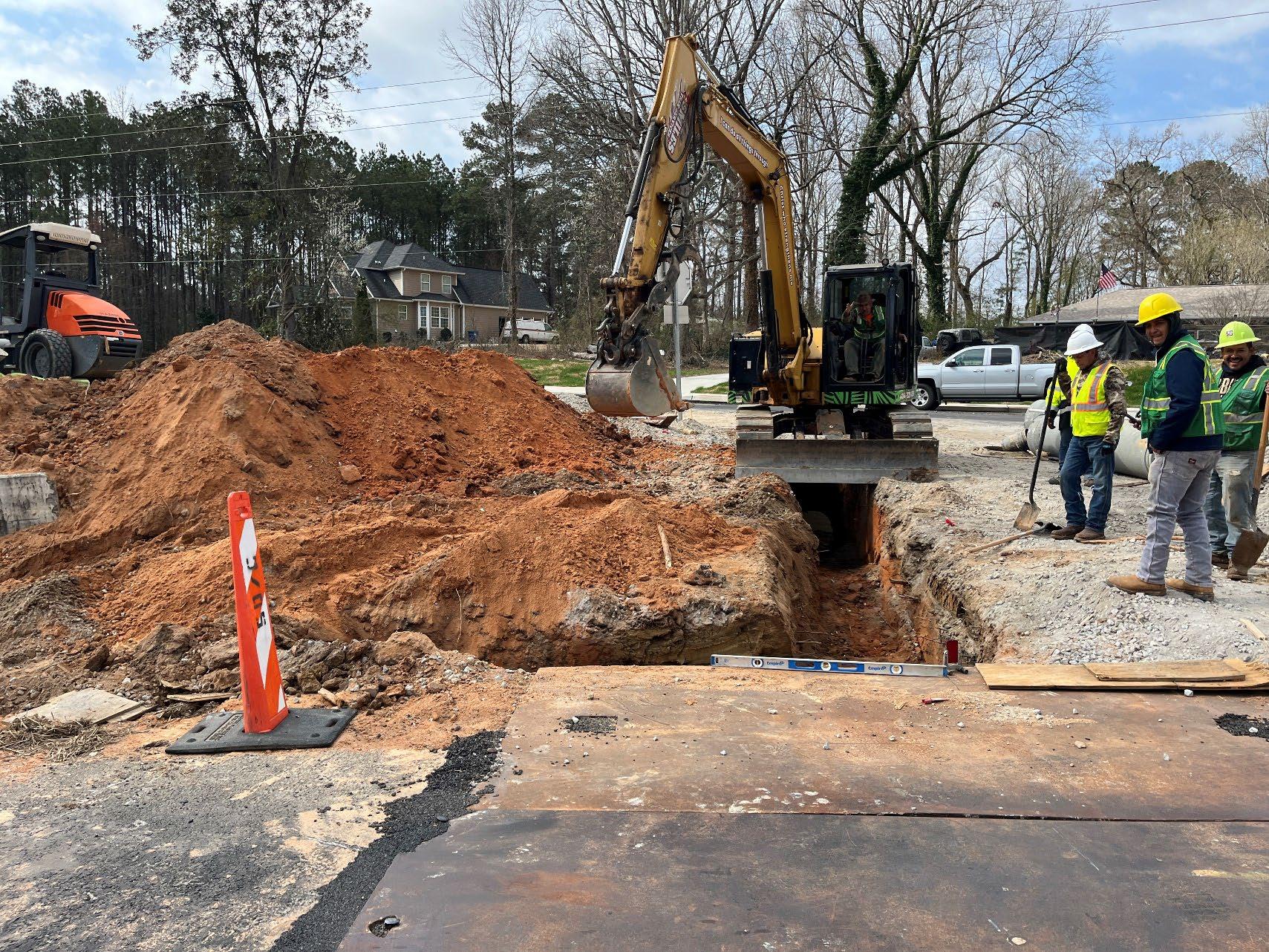

Excavation & concrete pour for steel strain pole
Install conduit, Install pull boxes
Did directional bore for 5”, 7” and 9”
Observed and repositioned a fallen traffic control barrel. The barrel was restored to an upright position to maintain proper traffic control in a construction zone.
The Physical Project Status is 20 % completed as of the period ending date above.
Scope of Work Planned for Next Month
Work items performed between the monthly report dates detailed above:
As soon as we get an update on the replacement of the inlet grate and on the field adjustment of ramps, we will start demolition of the Sidewalk and pour concrete.
Signal Contractor are waiting for materials delivery, as soon as they get material they will start the installation of signals.
SECTION IIA: CONSTRUCTION OPERATIONS
Right of Way Maintenance is required to provide safe and multi-use roadsides. A wellmaintained right of way promotes a positive quality of life and is integral to the other functions such as utility installations, vehicle emergencies and sign placements. Right of way Maintenance serves to maintain a safe zone adjacent to the road pavement, improves drainage of stormwater from the road surface, and creates an attractive vista along road corridors. Accomplishments this month include:
Number of Storm Drains Maintained: 12
Clogged Culvert
Thaxton Rd
Clogged Culvert 3380 Towanda Dr 18452681 Clogged Culvert 140 Buckhurst Way 18254272 Clogged Inlet 4080 W Stubbs Rd 18540545 Clogged Inlet 2130 Enon Rd SW 18542843 Clogged Inlet 2685 West Rd 18522875
Street Flooding 3900 Clearwater Dr 18538055
Street Flooding 3380 The Way Pl
Street Flooding 3380 The Way Pl 18538082
Street Flooding 2915 Oxford Rd
Street Flooding 2493 Wood Bend Ln 18581071
Street Flooding 5085 Gwendoline Dr
Number of Dead Animals Received: 11
18456366 Remove Dead Animals in Right-of-Way Cascade Hills Dr SW 18485884 Remove Dead Animals in Right-of-Way 2750 Butner Rd SW 18520345 Remove Dead Animals in Right-of-Way 3850 Old Fairburn Rd SW 18544805 Remove Dead Animals in Right-of-Way Cascade Rd SW 18596357 Remove Dead Animals in Right-of-Way 4556 Stonewall Tell Rd 18625231 Remove Dead Animals in Right-of-Way 2900 West Rd 18533318 Remove Dead Animals in Roadway 2160 Union Rd SW 18564135 Remove Dead Animals in Roadway Vandiver Rd SW 18508698 Remove Dead Animals in Roadway 5858 Old National Hwy 18531537 Remove Dead Animals in Roadway 4564 Dawes Cir 18577853 Remove Dead Animals in Roadway 5755 Old National Hwy
Number of Potholes Repaired: 33
SeeClick Fix
18422574
Pothole Ben Hill Rd & Roosevelt Hwy 18438939
18461425
Pothole Trade Water
Pothole 4010 Thaxton Rd 18466331
Pothole 30331 18466354
Pothole 767-839 Selig Dr SW 18470767
18470983
18518033
Pothole 5534-5586 Miles Rd
Pothole Bowhead Ct
Pothole Palmetto Cascade Hwy 18521159
Pothole 6310 Koweta Rd 18527353
Pothole 5301-5399 Thames Dr 18536046
18539366
Pothole 6280 Jones Rd
Pothole E Stubbs Rd 18539932
Pothole LaGrange Blvd SW 18544341
Pothole 2195 Union Rd SW 18547022
Pothole Wolf Creek Elementary School 18549417
Pothole Enon Rd SW 18555188
Pothole 4518-4568 Welcome All Rd SW 18565650
Pothole 2711 Feldspar Way 18567314
Pothole Cliftondale Pl 18569135
Pothole 5475 Jamerson Dr 18574209
Pothole 3100 Wolf Club Dr SW 18577895
18581390
Pothole 3225 Bethsaida Rd
Pothole 7135 Bishop Rd 18585905
Pothole 5900-5904 Buffington Rd 18585990
Pothole 5960 Buffington Rd 18587471
Pothole Old Bill Cook Rd 18595357
Pothole 4604-4606 Stonewall Tell Rd 18599745
Pothole 5945 Mallory Rd 18610919
Pothole Koweta Rd 18612887
Pothole Appoloosa Cv & Estonian Dr 18617533
Pothole Fayetteville Rd & Red Hawk Run 18401659
Deep Patch/Base Repair 2855 Jerome Rd 18470953
Deep Patch/Base Repair 4240-4288 Stonewall Tell Rd 18572417
The Traffic Operations Crew is on constant patrol in the City of South Fulton to ensure that all signs and signals are clear to see and work properly. This consists of approximately 35,000 static signs, 66 Traffic Signals, 14 Traffic Beacons, 40 School Flashers and numerous Solar Flashing signs.
The following is what each category is used for and what they represent.
• Traffic Operations - Other is used for anything that dosen’t fall into a specific category.
• Sign – Other Sign Down/Missing is used for missing signs, installing new signs, replacing or upgrading signs. If there are other signs on that post, the crew will clean them.
• Sign – Preventative Maintenance is used for the cleaning and straighting of signs.
• Sign - Stop/Yield Sign Down/Missing is used for responding to or finding STOP sign or YIELD sign that has been knocked down or missing\. This category is responded to as an emergency any time.
• Signal - In Flash or Dark is used to let us know that the traffic signal is flashing all RED lights, or no lights are visible. This category is responded to as an emergency at any time.
• Signal - Other Issues is used to let us know if there are any other problems with the Traffic Signal. There can be that there is an LED bulb not working, if the crosswalk is being problematic, sitting at a signal too long or just not changing.
This month, the Traffic Operations Department acquired 192 new requests and closed 188. The following are the 188 See Click Fix with the Catagories that Traffic Operations responded to and completed this past month. Examples of work completed this past month are highlighted in Exhibit A.
Number of Signs – Other sign Down/Missing: 87
Seeclickfix Locations
18471400 500-598 John F Varley Ct SW
18472401 Old National Hwy
18472468 5381-5385 Old National Hwy
18484686 6930 Dodd Rd
18493058 4505 Valley Brook Dr
18493609 7253 Taloga Ln
Seeclickfix Locations
18549103 100 Oak Park Ter
18549203 100 Oak Park Ter
18549346 510 Willow Ash Dr
18549532 5160 Willow Park Blvd
18549700 200 Willow Park Trl
18558665 Camp Creek Pkwy SW 18494230 4585 Jailette Trace
18558787 3480 Old Fairburn Rd SW 18494393 4240 Hidden Valley Dr
18494567 4335 Valley Lake Ter
18495045 5981-5999 Koweta Rd
18561297 100 Cainwood Ct E
18565265 4665 Butner Rd
18577864 5175 Old National Hwy 18495239 5900-5900 Koweta Rd 18577882 7496 Old National Hwy
18495697 4475 Jailette Rd
18578302 3980 Thaxton Rd SW 18500826 4310 Hidden Valley Dr 18578309 3965 Old Fairburn Rd SW
18500904 5703-5713 Boat Rock Rd SW 18578625 2020 High Point Trl SW 18500986 5775 Koweta Rd
18578921 2280-2298 Crossrail Dr 18501090 4355 Valley Lake Ter 18578926 3755 High Point Ln SW
18502063 4201-4299 Hidden Valley Dr 18579058 100-120 Old Fairburn Close SW
18502322 4340 Valley Lake Ter
18579443 N Close SW 18503004 4320 Hidden Valley Dr 18580451 3920 Old Fairburn Rd SW
18517026 3562 Hamlin Sq SW 18580776 4327-4399 Pompey Dr SW 18517124 Thaxton Rd SW 18581244 4140 Central Park Pl 18517130 5248 Lexmark Cir SW 18587067 4015 Old Fairburn Rd SW 18519090 4220 Valley Lake Ter 18587130 4355 Old Fairburn Rd 18519266 4300-4418 Valley Brook Ln 18587328 4825 Highland Lake Dr 18519822 5650 Koweta Rd 18588473 Cascade Rd SW 18525163 3466 Ebb Cir 18588748 2645 Lantern Ln
18531538 5888 Harrier Ln 18588914 2630 Lantern Ln 18532148 4835 Southern Rd 18589006 2630 Lantern Ln 18534649 2662-2780 Enon Rd SW 18596032 7435 Bodnant Dr 18540124 Cascade Rd SW 18596120 7546 Saint David St 18540158 2075 Enon Pines Dr SW 18598179 2639 Picardy Cir S 18540251 767-779 Wilson Mill Rd SW 18598368 4870 Canyon Lake Dr 18540287 781-799 Wilson Mill Rd SW 18598451 2540 Picardy Cir N 18540350 767-779 Wilson Mill Rd SW 18598609 2760 Lantern Ln 18540361 100 Piney Ct SW 18604037 Old National Hwy 18540490 760-798 Wilson Mill Rd SW 18605870 2050 Wallace Rd SW 18540654 700 Wilson Mill Rd SW 18612170 Cascade Palmetto Hwy SW 18541056 2040 Enon Mill Dr SW 18613135 Camp Creek Pkwy SW 18541371 2000 Enon Mill Dr SW 18618656 Alamosa Path SW 18541986 740 Garr Cir SW 18622591 295 Allegrini Dr 18542013 2120 Enon Mill Dr SW 18542354 745-765 Wilson Mill Rd SW 18542563 729-799 Timbergrove Dr SW
Sign- Preventive Maintenance: 67
Seeclickfix Locations
18463265 125-199 Tarver Ter
Seeclickfix Locations
18463265 125-199 Tarver Ter 18463658 3301-3539 Lee Pl
18463658 3301-3539 Lee Pl 18463970 4805 Campbell Dr 18533262 5901-5919 Old Carriage Dr 18465168 3605 Sulene Dr 18550557 Camp Creek Pkwy SW 18465351 3605 Las Olas Dr
18550763 Walton Xing SW 18465568 3590 Towanda Dr 18558515 3480 Old Fairburn Rd SW 18465739 4601-4799 Towanda Cir 18579537 2120 High Point Trl SW 18484576 Feldwood Rd 18581467 4000 Montego Bay Dr 18493232 4075 Will Lee Rd 18587083 4005 Old Fairburn Rd SW 18493332 4230 Welcome All Ter 18587301 3920 Old Fairburn Rd SW 18493922 6015-6099 Westpark Dr SW 18587600 2000-2010 High Point Trl SW 18494848 5901 Koweta Rd 18587943 3480 Old Fairburn Rd SW 18495088 4625-4699 Spring Valley Ct 18588559 2560 Lantern Ln 18495255 Green Mountain Trl 18589203 2695 Old Spanish Trl
18495472 5901 Koweta Rd 18595802 7759-7787 Cedar Grove Rd 18495488 3465 Spring Valley Blvd 18596224 5601-5617 Northcutt Rd
18495648 5775 Koweta Rd 18596400 7791-7793 Cedar Grove Rd
18495796 5820-5848 Koweta Rd 18596873 8201-8201 Cedar Grove Rd 18501283 5601-5603 Koweta Rd 18597047 8126-8178 Cedar Grove Rd 18502789 4320 Hidden Valley Dr 18598970 6448 Snowden Dr
18503509 5630 Sturbridge Way 18603957 Camp Creek Pkwy SW & Campbellton Rd
18517147 1475 Elva Dr SW 18604291 Old National Hwy 18517285 295 Enon Ct SW 18604643 Camp Creek Pkwy SW & Old Fairburn Rd SW
18651329 200 Highland Lake Trace 18518598 5235 Koweta Rd
18651455 415 Highland Lake View 18518743 5235 Koweta Rd 18651622 910 Highland Hill Dr 18518873 5225 Koweta Rd 18651795 5075 Highland Lake Dr 18518891 4330 Valley Lake Ter
18652064 5120 Highland Lake Dr 18519722 4155 Welcome All Ter
18652215 805 Highland Hill Dr 18519844 4115 Sunrise Trl
18533262 5901-5919 Old Carriage Dr Number of Signals – In
Number of Signs – Stop/Yield Sign Down/Missing: 16
SeeclickFix Location
18471073 501-599 John F Varley Ct SW
18488033 4709 Buffalo St
18488224 Alamosa Path SW
18501417 961-1067 Boat Rock Rd SW
18519566 Camp Creek Pkwy SW
18532730 Hazeltine Cir
18535171 3390-3398 W Stubbs Rd
18577858 6400 Old National Hwy
18577869 Bethsaida Rd
18583600 1995-1999 New Hope Rd SW
18605479 2045 Wallace Rd SW
18611106 Emmanuel Dr SW
18611973 2620 Lantern Ln
18612346 2375-2439 Pleasant Hill Rd
18625338 3883-3899 Butner Rd
18645535 7880 Rivertown Rd
Number of Signals – Other Issues: 11
SeeclickFix Location
18437688 Cascade Rd SW
18470918 4347-4367 Fulton Industrial Blvd SW
18471638 6201-6209 Shenfield Ln
18472064 4020 Shenfield Dr
18493584 3707-3715 Cascade Rd SW
18541418 7040 Rivertown Rd
18561609 Oakley Industrial Blvd
18605787 6305 Kimberly Mill Rd
18612699 5851 Campbellton Rd SW
18636863 Campbellton Fairburn Rd
18642640 Highway 92 & Jones Rd
Traffic Operations - Other: 4
SeeclickFix Location
18567044 ATM at Fifth Third Bank Publix Supermarkets
18577886 6350 Old National Hwy
18591723 Old Fairburn Rd SW 18605002 Lendy Ln
Here are
1. Repairing signs throughout the city.
2. Responding to emergencies.
Keeping our city clean, one sign at a time.
Upgrading signs throughout the city.
Repairing Traffic Signals to make the city safer.
TRAFFIC OPERATIONS
RESPONDING TO EMERGENCIES
KEEPING OUR CITY CLEAN, ONE SIGN AT A TIME
REPAIRING TRAFFIC SIGNALS TO MAKE THE CITY SAFER
Staff
Staff
Makeover
Longmeadow Lane
Staff emailed online petition to initiator for use and distribution
Staff emailed online petition to initiator for use and distribution. Staff have yet to receive petitions. Three
Flat
Staff emailed online petition to initiator for use and distribution. Staff have yet to receive petitions.
Staff emailed online petition to initiator for use and distribution Sable
Enterkin
Enterkin
Staff emailed online petition to initiator for use and distribution
Staff emailed online petition to initiator for use and distribution
Staff emailed online petition to initiator for use and distribution
Staff emailed online petition to initiator for use and distribution
Speed cushions were installed in Feb 2022
SECTION IIC: UTILITY PERMITS
Purpose of utility permits is to help the City of South Fulton staff track and manage construction operations more efficiently. Each utility permit contains a unique reference number, special requirements before/ during operation, procedures, and contact information in case of emergencies. All this information is essential when dealing with construction operations in our Right of Way.
Permits
RWEP(25)086 3855 Jailette Rd SW
RWEP(25)087 5755 Cedar Pass To Existing Ped At 5714 Village Loop
RWEP(25)088 4362 Parkaire Pl, Union City, GA 30291
RWEP(25)089 4205 Jailette Rd
RWEP(25)090 6435 Old National Hwy Atlanta, Ga 30349
RWEP(25)091 855 Cascade Rd SW
RWEP(25)092 3820 Stonewall Tell Rd
Comcast is to excavate & install 50' new 48ct fiber to be pulled through new 2" conduit then riser up 25' and overlash 2253' new 48ct fiber to existing GPC.
Comcast is to excavate, bore, and install 995’ of new 0.875” coax cable to be pulled through new 2” conduit within the row of Cedar Pass and Village Loop to complete node split.
COMCAST is to bore and install a total of 631' new 24CT of .5 fiber cable in existing 2" conduit in existing ROW, servicing between 4362 Parkaire Pl and 7128 Boulder Pass.
Complete
Complete
RWEP(25)093 301 Fulton Industrial Cir
RWEP(25)094 Welcome All Rd
Hasn’t Started
Comcast is to rise down 25' from an existing GPC pole then excavate, & install 276' new 0.625" ug coax cable to be pulled through new 2" conduit within the ROW of Wolf Creek Trace to provide service to 4205 Jailette Rd. In Progress
Install 154' x 1.25" plastic gas service to customer.
Comcast is to pull 1694' new 24-count fiber through existing roll duct within the Row of Cascade Rd SW to provide service to 855 Camp Creek Pkwy
Comcast is to riser 25’ down 2 poles, excavate, bore and install 1,490’ of new 24ct fiber through new 2” conduit, riser25’ up pole and overlash 15,138’ of new 24ct fiber to existing poles along W Stubbs RD, Rindle DR and Butner RD to fix fiber choke to provide service to the Twin Shoals subdivision.
AT&T to lash 5014' of new fiber aerial fiber cable to existing pole line, place handholes, directional bore 463' of new buried fiber cable and 78' of innerduct to provide fiber service.
Comcast has existing aerial (and/or underground) facilities within project. Comcast has no apparent conflict. 30 days is being allowed for construction engineering for any revisions that create conflict.
Complete
Hasn’t Started
Hasn’t Started
In Progress
Complete
RWEP(25)095 SR 279 / Old National HWY
RWEP(25)096 1970 Maple Ave
RWEP(25)097 Spring ST @ Campbell Dr
RWEP(25)098 Campbell Dr, Lee Place, and Hannah Rd
RWEP(25)099 5225 Phillip Lee Dr
RWEP(25)100 3680 Stonewall Tell Rd, Fulton County, Ga 30349
RWEP(25)101 SR 70 / Fulton Industrial Blvd. east along the north R/W of Plummer Rd. SW for 670' then across Plummer Rd. SW and off City R/W
RWEP(25)102 5958 Buffington Rd
RWEP(25)103 8475 Campbellton Fairburn Rd, Fulton County, Ga 30213
Scope of Work
Comcast is to relocate existing aerial and underground facilities within limitations of project In Progress
Comcast is to excavate, bore, & install 1331' new 24ct fiber to be pulled through new 2" conduit within the ROW of Maple Ave to provide service to 1970 Maple Ave. Hasn’t Started
Comcast to overlash 203' new 24ct fiber then build 155' new 0.25" strand & 24ct fiber to existing GPC poles within the ROW of Campbell Dr to provide service to 5001 N Commerce Dr. In Progress
DB 3 1.5" HDPE ducts e/w 228ct FOC a total of 3025' along Campbell Dr, Lee Place and Hannah Rd Hasn’t Started
Comcast is to pull 40' new 0.625" coax cable through existing 2" rollduct then excavate & install 98' new 0.625" coax to be pulled through new 2" conduit within the ROW of Phillip Lee Dr to provide service to 5225 Phillip Lee Dr. In Progress
Install 1-5/16" strand and lash 1-24ct foc. Maintain 18' min vertical clearance. Row 2425' Complete
Placement of 776' of 3-2.25" (7-way) HDPE conduits (1 e/w 96 fiber optic cable, 1 vacant e/w tracer wire and 1 vacant e/w mule tape) and 1 36"x60"x36" hand holes
Hasn’t Started
Comcast is overlash 294’ 0.623” coax cable to existing GPC poles within the row Buffington Rd to complete node split. In Progress
Install 1-5/16" strand and lash 1-144ct FOC maintain 18' min vertical clearance. Row within South Fulton is 187'
Hasn’t Started
SECTION
IID: STREETLIGHTS
The Streetlight Program is established to address the need for adequate illumination of public streets or roadways within the City of South Fulton. The goal is to aid in the safety and systematic movement of vehicular traffic within the public traveled roadway. Lighting on roadways is not provided for personal security, such as lighting of yards, driveways, or private property. In-house staff assesses requests from residents, conducts field visits and works with power companies to address inquiries for new lights, repairs, and upgrades.
On July 9, Mayor and Council approved a resolution adopting the Streetlight Masterplan. The masterplan provides options for street and pedestrian light poles, styles, spacing, lighting technology and control, and appropriate lighting levels for various locations such as: state roads, arterials minor residential streets, major street corridors including those with existing and proposed bike lanes, controlled intersections, roundabouts, uncontrolled pedestrian crossings, transit station street areas, and parks.
Additionally, the city is looking at various alternatives to upgrade the infrastructure, including solar lights. The city has spoken with a vendor with a good experience in providing high-quality solar lighting solutions. Two TSPLOST projects where the city has investigated the possibility of solar lighting are the combined OSI 601/OSI615 Old Fairburn Road-Stonewall Tell Road at Union Road roundabouts projects for overhear lighting and the P 901 Enon Road Sidewalk project for pedestrian scale lighting. Procurement options include a monthly fee to the power company or a one-time upfront purchase and installation cost to consider for each. Time to break even on the investment is 8-10 years.
Lastly, the department is developing a priority list to install and/or upgrade streetlights on all corridors with proposed and existing sidewalks, State routes, and intersections. All sidewalk projects will also include pedestrian lights. Upon completion, staff will meet with the power companies to draft an implementation plan that will include costs and schedules.
Requests for streetlights- new and upgrades- received to date are detailed in Exhibit A. There is an ample number of streetlights proposed during the construction of our capital and TSPLOST projects. The estimated number of lights, by project id, are listed in Exhibit B.
•Remove (91)
•Remove (14)
•Remove (3)
STREETLIGHT INQUIRY/APPROVED LOG
T-SPLOST AND CAPITAL PROJECTS
NUMBER OF STREETLIGHTS
SECTION III:
Solid Waste Group Purpose and Responsibilities
The City of South Fulton Solid Waste Group is tasked with regulating solid waste activities inside the city limits for commercial and residential properties. This includes education and outreach, recycling events, operations of Merk Miles Citizens Convenience Center, solid waste services for city facilities, and collection of franchise fees.
Residential Service (Weekly Garbage and Monthly Bulk Collections
Residential Service (Weekly Garbage and Monthly Bulk)
Statistics
Complaints
Cart Maintenance and Delivery
Solid Waste staff or responsible for the delivery and maintenance of roll carts for the residential solid waste program.
Source: Solid Waste Group
Merk Miles Citizens Convenience Center
Resident Versus Commercial/Non-Resident Commercial
On March 3, Latham instituted a sign-in sheet for all customers. The initial findings were reported:
• Residents - 170
• Non-Resident/Commercial - 4
• Commercial - 1
Merk Miles Metrics
COSF Expenses and Profit Sharing By Month
Source: Latham Monthly Reporting
Special Events
Paper Shredding/Recycling events were successfully held in multiple districts.
District 2: 90 participants for paper shredding, 115 for recycling.
District 6: 43 participants for recycling, 54 for paper shredding.
Additionally, the Oak Community Clean-Up event was a success, contributing to a cleaner and greener community.
Residential Cart Delivery
The following represent deliveries and services performed by the team.
