summarised progress report
Surrey House Island Site – Project Honey (10372)
contents
1.0 executive summary
2.0 programme
3.0 planning update
4.0 legals

5.0 design and project update
6.0 procurement update
7.0 construction works update

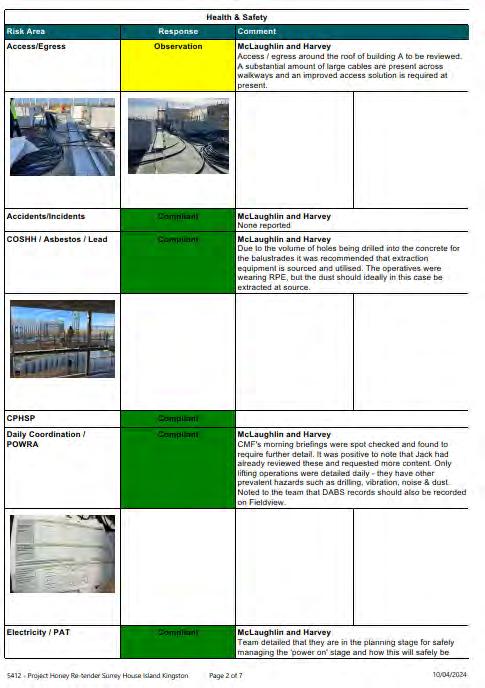

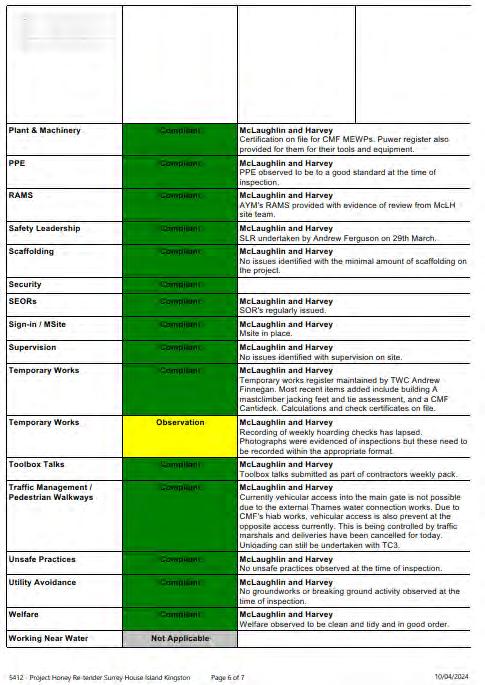

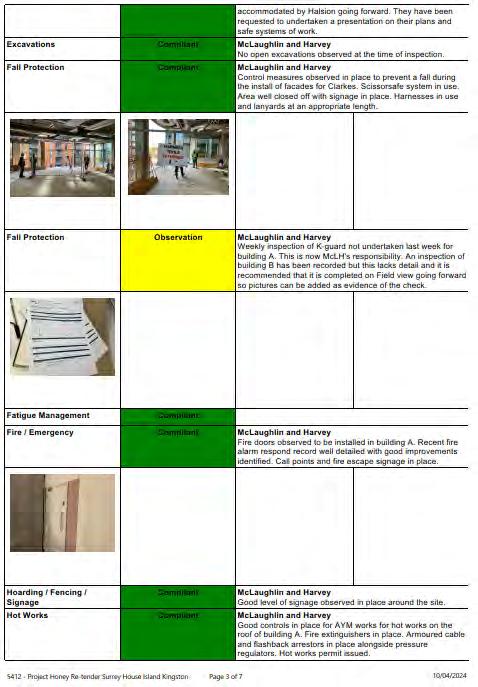

8.0 health and safety matters
9.0 tenant variations and approvals update

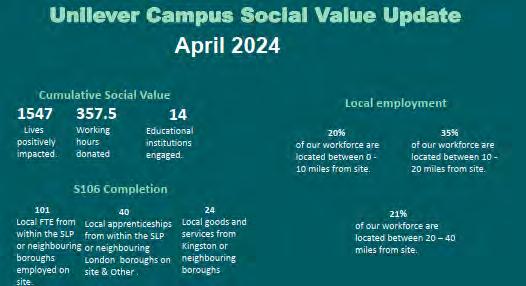

10.0 sustainability / Net Zero Carbon
11.0 environmental status update
12.0 key risks
13.0 areas of concern
14.0 key activities in the reporting period
15.0 lookahead – key activities in the next reporting period
appendices
appendix a – LoR & warranties tracker
appendix b – McLH update report
appendix c – McLH construction programme
appendix d – outline programme
appendix e – G&T progress report
appendix f – Clarke’s manufacturing update
FH090-151015 appendix a LoR
warranties tracker
&
warranty and PI schedule
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty primary warranties 1.00 main consultants 1.01 Employers Agent FHPM £10m expires 08/08/24 Signed 25//5/22 Completed Gwlng May Tracker Signed 8/6/22 Issued by Gwlngs for Docusign 7/7/23…signed TA email 19/7/23 Warranty required per building CLOSED 1.02 Monitoring Architect DAA £5m expires 27/08/24 Signed 25//5/22 N/A for monitor Signed 8/6/22 Issued by Gwlngs for Docusign 7/7/23…signed TA email 19/7/23 Only one monitoring architect's appointment. TA email 5/7/23 CLOSED
Monitoring Civil and Structural Engineer (main and monitoring) MNP £5m expires 18/04/25 Signed 19/10/22 Completed…Gwlng May Tracker. Tenan Warranty not required for Monitoring. Signed 19/10/22 Issued by Gwlngs for Docusign 7/7/23….13/9/23 Lender to sign all warranties in one go. 29/11/23 Lender warranty (Main) signed by Lender. CLOSED 1.04 MEP Engineer Aecom £10m expires 01/04/24 …new certificate requested Signed 19/10/22 Completed- Gwlng May Tracker. Signed 19/10/22 29/11/23 Lender signed. CLOSED 1.05 Cost Consultant G & T £10m expires 01/05/24 Signed 25//5/22 N/A Signed 8/6/22 .signed TA email 19/7/23 CLOSED 1.06 Main Contractor MCLH £20m expires 31/12/24 Contract dated 16/11/22 With Tenant Fund warranties completed Contractor lender warranty sent out for Docusign by Gwlngs 7/7/23. Lender to sign all warranties in one go. GOWLINGS/MAYER BROWN 1.07 Demolition Contractor Shorts £1m expires 01/06/24 (£5m) Contract dated 3/2/23 Fund warranties completed 25/7/23 Shorts have signed. GOWLINGS
Warranties/LoR within 12 months of unconditional or no more drawdowns for relevant trades 2.01 Architect Novated x 3 appointments DAA £10m expires 27/08/24 signed 25/5/23 Completed- Gwlngs May Tracker Fund warranty completed Email of 30/1/24 COMPLETED CLOSED 2.02 Contractors Engineer RBG £10m expires 31/12/24 COMPLETED COMPLETED- Gwlng May Tracker 30/1/24 Fund Warranty "COMPLETED" 30/1/24 Lender Warranty COMPLETED CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
1.03
2.00
project: Surrey House
warranty
PI
and
schedule
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.03 Cladding consultant x 3 appointments Eckersley O'Callaghan (EOC) £10m expires 23/03/25 Signed by Consultant…and by Employer COMPLETED- Gwlng May Tracker Funder warranty issued and completed by Gwlngs Docusign 11/7/23 Issued by Gwlngs for Docusign 7/7/23. 29/11/23 COMPLETED CLOSED 2.04 Right of light consultant Point2 £10m expires 19/12/24 Appointment COMPLETED COMPLETED- Gwlng May Tracker FUNDER WARRANTY COMPLETED LENDER WARRANTY COMPLETED CLOSED 2.05 Measurement Surveyor consultant Plowman & Craven £5m expires 01/06/24 Gwlng May TrackerAppt with Client for signature Reliance letters to be issued once reports are prepared. Gwlng May Tracker- with Client for signature Gwlng May Tracker- with Client for signature GOWLINGS 2.06 Validation Engineer Inhabit £2m expires 31/12/24 (£10m) Gwlng awaiting details Gwlng awaiting details Gwlng awaiting details Gwlng awaiting details Services not carried out until completion. 2.07 Environmental consultant GEA £5m expires 31/03/25 Gowlngs awaiting details. Report dated February 2022 COMPLETED COMPLETED COMPLETED 2.08A Landscape Architect Gillespies £5m expires 25/09/24 signed 13/02/22 Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED 2.08B Landscape ArchitectContractor Appointment McIIlwaine £2m expires 08/11/24 30/1/24 TA says that draft has been received. Not required Draft Fund Warranty forwarded
approval.
been reviewed
approval. 30/1/24..TA
be issued.
GOWLINGS 2.09 Principal Designer x 3 appointments ORSA £10m expires 24/02/25 Signed 19/10/22….check if completed Completed Gwlng May Tracker Signed 19/10/22…check if completed COMPLETED CLOSED 2.10A Fire Strategy Consultant SWECO Not required No longer engaged…replaced by Marshall Fire.
Marshall £5m aggregate expires 25/07/24 COMPLETED Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED 2.10C Fire Strategy ConsultantContractor Appointment Marshall £5m aggregate expires 25/07/24 Draft received ….30/4/24 email...Client Warranty sent out to Consultant for signature. Not required 1/3/24 Marshall have confirmed they can accept the draft warranty. Gwlng May Tracker-issued to Consultant for signature. 29/11/24 TA to be issued. ….Gwlng May Trackerissued to Consultant for signature FHPM to check
to MCLH to obtain
Gwlng May Tracker- Comments have
and sent to Consultant for
..to
…but on tracker 6/3/24 shown as N/A….check
2.10B Fire Strategy Consultant x 2 (one direct/retained and one with contractor) ….see below for contractor appointment
subcontractor Van Elle £5m aggregate expires 29/04/24 (updated cert requested) Redacted order signed and dated 2/11/22 received and filed on Centrodoc. Completed Completed Gwlng May Tracker COMPLETED COMPLETED CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
2.11 Piling Bored.Sheet
project: Surrey House
11/10/24
2.14 MEPH subcontractor Halsion £10m AOC expires 11/12/24
Redacted order dated 21/11/22 received and saved on Centrodoc. Certified copy required.
2.15 Façade, cladding and curtain walling Clarkes £10m aggregate expires 28/02/25
2.16 Acoustic consultantContractor Appointment Hann Tucker £1m expires 24/7/24
2.17 Lift subcontractor Otis £5m aggregate expires 30/11/24
Fully executed order dated 30/5/23 received and filed on Centrodoc. redacted . 6/3/24 Certified copy required.
29/1/24...no change. Issued to subcontractor. 12/4/24 Issued by Docusign again by GWLNGS
Gwlng May TrackerDraft received. 30/4/24 email…Client Warranty sent to Consultant by Docusign
Redacted subcontract order dated 4/5/23 received and filed on Centrodoc.. 6/3/24 Certified copy required.
29/1/24 Signed by subcontractor, to be signed by the contractor.
29/1/24...no change. Issued to sub-contractor. 12/4/24 Issued by Docusign again by GWLNGS
29/1/24...no change. Issued to sub-contractor. 12/4/24 Issued by Docusign again by GWLNGS
Not required Gwlng May Trackerissued to Consultant for signature.
29/1/24...no change. Issued to sub-contractor.
12/4/24 Issued by Docusign again by GWLNGS
Gwlng May Tracker- with Consultant for signature
2.18 Car Park Contractor (if separate)
FP McCann £10m aggregate expires 31/01/25 Fully executed subcontract order dated 26/7/23 received and saved on Centrodoc.. 6/3/24 Certified copy required.
29/1/24 Issued to subcontractor . 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
Completed- Gwlng May Tracker
.6/3/24 Signed by the subcontractor. Sent to the Tenant. 12/4/24 Issued to Otis again by GWLNGS
6/3/24 Still with subcontractor. Issued to Otis by Docusign by GWLNGS ….12/4/24
Completed- Gwlng May Tracker
29/1/24 Issued to subcontractor. 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
29/1/24 Issued to subcontractor. 12/4/24 Issued to FPMcCann by Docusign again by GWLNGS.
warranty
PI
and
schedule
ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.12 Concrete frame subcontractor Mitchellson
Redacted
on
COMPLETED Completed Gwlng May Tracker COMPLETED COMPLETED. CLOSED 2.13 Roofing subcontractor AYM
expires
Received, certified
Issued to sub-contactor for signature Issued to sub-contactor for signature ….2 warranties, Building A and Building B Issued to sub-contactor for signature Issued to sub-contactor for signature GOWLINGS
date: 08/05/24
£10m aggregate expires 18/11/24
subcontract order dated 5/1/23 received …saved
Centrodoc.
£10m aggregate
copy required.
Completed Gwlng May Tracker Completed Gwlng May Tracker Completed Gwlng May Tracker Completed Gwlng May Tracker CLOSED
GOWLINGS
GOWLINGS
GOWLINGS
GOWLINGS https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
warranty
PI schedule
and
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 2.19 Architectural metalwork/secondary steelwork CMF Limited £10m in the aggregate certificate provided expires 03/07/24 Fully executed subcontract order dated 4/9/23 received and saved on Centrodoc. 6/3/24 Certified copy required. Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker CLOSED 2.20 Plant screens and Louvres (if separate) TBA 2.21 Soffit cladding (if appropriate) Clarkes See Clarkes above 2.22 Steelwork connections (if appropriate) TBA Included in Mitchellsons 2.23 Fire curtains TBA
Feature staircase TBA 29/11/23 requested from LN 2.25 Mansafe system PTSG £10 m in the aggregate Expires 31/3/25 Signed sub-contract order dated 5/9/23 received and filed and Centrodoc. 6/3/24 Certified copy required. Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker Completed- Gwlng May Tracker GOWLINGS 2.26 Internal glazed screen subcontractor TBA £2m 2.27 Greenwall ANS Global 2.28 Flood protection equipment TBA 2.29 Car park cladding (if separate) Maple 2.30 Other subcons with material design responsibility. TBA 3 Secondary consultants supporting Planning Application only 3.01 Acoustic consultant Hann Tucker £1m expires 24/07/24 (£10m) Appointment completed Funder warranty completed CLOSED 3.02 Air Quality consultant AQ Consultants £2m expires 06/03/25 Appointment completed Funder warranty completed CLOSED 3.03 Arboriculture consultants Landmark Trees £2m continuous Appointment completed Funder warranty completed CLOSED 3.04 Archeological consultants RPS Consultancy £1m expires 30/9/24 (£10m) Appointment completed Funder warranty completed CLOSED https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
2.24
project: Surrey House
warranty
PI schedule
and
date: 08/05/24 ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty 3.05 Asbestos consultant Search Environmental £1m expires 21/8/24 Appointment completed Funder warranty completed CLOSED 3.06 Ecological consultant Ecology Practice £2m expires 17/12/24 Appointment completed Funder warranty completed CLOSED 3.07 Planning consultant Chart Plan £2m expires 30/7/24 Appointment completed Funder warranty completed CLOSED 3.08 Security consultant Kabsec £5m expires 03/01/25 L of R agreed. 6/3/24 Reliance letter signed by Consultant…to be sent to Funder. CLOSED 3.09 Blast consultant Aibara £1m expires Appointment completed …but Gwlng May Tracker "Awaiting details". Funder warranty completed CLOSED 3.10 Cladding Access consultant PTSG (Through MCLH) £5m expires 31/03/25 Awaiting details to prepare Appt. TA 6/3/24 To be issued with Appt. Missing from TA schedule on 6/3/24 but CMS have been informed that it is PTSG through MCLH. 3.11 Transport consultant Milestone £5m expires 5/12/24 Appointment completed Funder warranty completed CLOSED 3.12 Environmental Impact Statement consultant Stantec £1m expires 1/10/24 COMPLETED N/A COMPLETED COMPLETED CLOSED 3.13 Approved Inspector Sweco £1m expires 29/4/24 Not required…statutory service. 4.00 Other 4.01 Wind and microclimte consultant BRE With Consultant …Letter of Reliance. 4.02 Heritage and Townscape Consultant Peter Stewart Consultancy Completed CLOSED 4.03 Viability study Housing Expectations Completed CLOSED 4.04 Building Control MLM (Sweco) Completed CLOSED 5.00 Product and Component Guarantees ( Tenant Guarantees) 5..01 To be added if required in this document 6.00 Sub-sub- contractor warranties https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
project: Surrey House
wall (Mitchelson sub-sub contractor)
confirmed that she has sent a draft form of warranty to BCLP for all 5 of these sub-subbies…....and will arrange for these to be issued once approved. 6.02 Design of PT slabs (Mitchelson sub-sub contractor)
6.03 Design, manufacture, installation (Mitchelson sub-sub contractor)
6.05 Design and manufacture(Mitchelson sub-sub contractor)
6.06
(Halsion)
warranty and PI schedule
ref consultant PI level & wording certifciate provided redacted order sent employer tenant fund lender comments status/ r e sponsibilty
twin
Kilsaran
TA 6/3/24 ..To be issued
with
approval) To be issued To be issued To be issued 23/2/24 TA
CCL Received, certified
TA 6/3/24
be issued
To be issued To be issued To be issued See
date: 08/05/24
6.01 Design and supply of
Awaited
(currently
the Funder for
copy required.
..To
(currently with the Funder for approval)
Kilsaran above
Received, certified
required. TA 6/3/24 ..To be issued
with the
approval) To be issued To be issued To be issued See Kilsaran above
Creagh Received, certified
TA
be issued
To be issued To be issued To be issued See Kilsaran above
Intersteel
copy
(currently
Funder for
6.04 Design and manufacture (Mitchelson sub-sub contractor)
copy required.
6/3/24 ..To
(currently with the Funder for approval)
FP McCann
TA 6/3/24 ..To be issued
approval) To be issued To be issued To be issued See Kilsaran above
Awaited
(currently with the Funder for
Carbon3 Received, certified copy required To be issued (currently with Funder
approval) To be issued To be issued To be issued https://francishunter.sharepoint.com/sites/FH/Shared Documents/Projects/03 current/10372 - Project Honey/01 Appts Contracts & Proc/Warranty & LOR tracker/Warranty and PI ScheduleTracker/Warranty PI schedule for Honey 2400508 v34
Sub-sub-contractor
for

FH090-151015 appendix b
McLH update report
25.04.24
2024 Progress
24
Progress Report 24 -
Report
Project Honey
Progress Report 24 - 25.04.24 Contents 1. CDM / Health and Safety ........................................................................................................ 3 2. List of sub-contractors on site: ................................................................................................ 3 3. Construction Update .............................................................................................................. 3 4. Progress/Programme Dropline ............................................................................................... 3 5. Lookahead Activities ............................................................................................................... 3 6. Key Risk Schedule ................................................................................................................... 4 7. Outstanding Instructions/Tennant Variations ......................................................................... 4 8. Site Wide Issues / Matters Affecting Progress ......................................................................... 5 9. Quality and Environmental ..................................................................................................... 5 10. Sustainability ......................................................................................................................... 6 11. Architects Report ................................................................................................................... 7 12. Civils/Structures Report ............................................................... Error! Bookmark not defined. 13. MEP Report ................................................................................. Error! Bookmark not defined. 14. Utility Tracker ........................................................................................................................ 8 15 Contract and Commercial Matters 15 15.1 Valuation ..............................................................................................................................15 15.2 Projected Final Account ........................................................................................................15 15.3 Provisional Sum ....................................................................................................................15 15.5 Project Cash Flow .................................................................................................................19 16 Warranty Tracker ..................................................................................................................20 17 Progress Photos ....................................................................................................................20 18 SHEQ Audit ...........................................................................................................................25 19 Planning Tracker/Update ......................................................................................................32 20 Building Control Tracker........................................................................................................32 21 AOB .............................................................................................Error! Bookmark not defined.

1. CDM / Health and Safety
• Construction Phase and Environmental plans are in place and updated as required.
• All risk assessments / method statements and COSHH assessments currently up to date for the work activities on site.
2. List of sub-contractors on site:
• FP McCann – Precast Multistorey Carpark
• O’Neill & Brennan – Logistics/Waste Management
• Trident – Temporary Electrics & Water
• LTC – Tower Cranes
• ATJ – Partitions/Ceilings
• Halsion – MEP
• RECO – Hoists
• CMF – Metalwork
• Clarkes – Façade
• AYM – Roofing & Cladding
• Swiftcrafted – Core fit out/Joinery.
• Maple – Carpark Façade
• Kingspan – Raised Access Flooring
• Original Joinery – Building C Fitout
3. Construction Update
• Partitions are complete up to level 8 building A, and level 10 building B.
• CAT A - Ceilings ongoing to all floors.
• MEP is up to level 8 building A, and level 10 building B
• UKPN have completed their installations.
• Clarke Façades currently progressing:
Block A: Unitised progressing to level 4. Stick CW from GF – Level 1 ongoing. Block B: Unitised complete to level 7, level 8 ongoing Stick CW from GF- Level 1 ongoing
• AYM Roofing 95% complete on Buildings A, B & C.
• Swift crafted progressing with joinery/tiling/vanity units/doors to Building A & B cores
• Car park fit out ongoing.
• Plant room cladding complete.
• Key plant positioned on to the roof.
• Otis have completed 5No. lifts (Tested). Currently working on the next batch of lifts.
• Raised Access Flooring complete in Building B to levels 2,3 & 4
4. Progress/Programme Dropline
• Block A – 3 weeks and 4 days behind programme due to Twin wall delay
• Block B – 4 weeks and 3 days behind programme due to Twin wall delay
• Block C – 1 week behind programme
5. Lookahead Activities
• FP McCann snagging complete
• CAT A ceilings ongoing
• MEP works ongoing
• CMF steelwork ongoing (Feature stair, reception steel, balustrades etc)
• Roofing ongoing to all three blocks
• Frost Landscaping to Block C roof
25.04.24
Progress
Report 24 -
• Maple completion of façade to car park.
• Clarkes Façade progressing to buildings A & B
• Lift installations ongoing
• Power on
• Building C Fitout ongoing
6. Key Risk Schedule
• Future client variations/TVR’s
• Twin Wall Core impact
• MSCP Provisional Sum
• Planning
o Building A & B Spandrel Panel – NMA Granted 7th September 23
o Building A & B Equitone
o Building C Façade
• LFB ‘sign off’
o CAT A Omissions / Temporary Measures – discussions ongoing regarding Building Control Final Certification
o Building C Façade – LFB submission agreed on current Maple proposal
o Building C Sprinkler Requirements – Insurance Acceptance issued via email from client

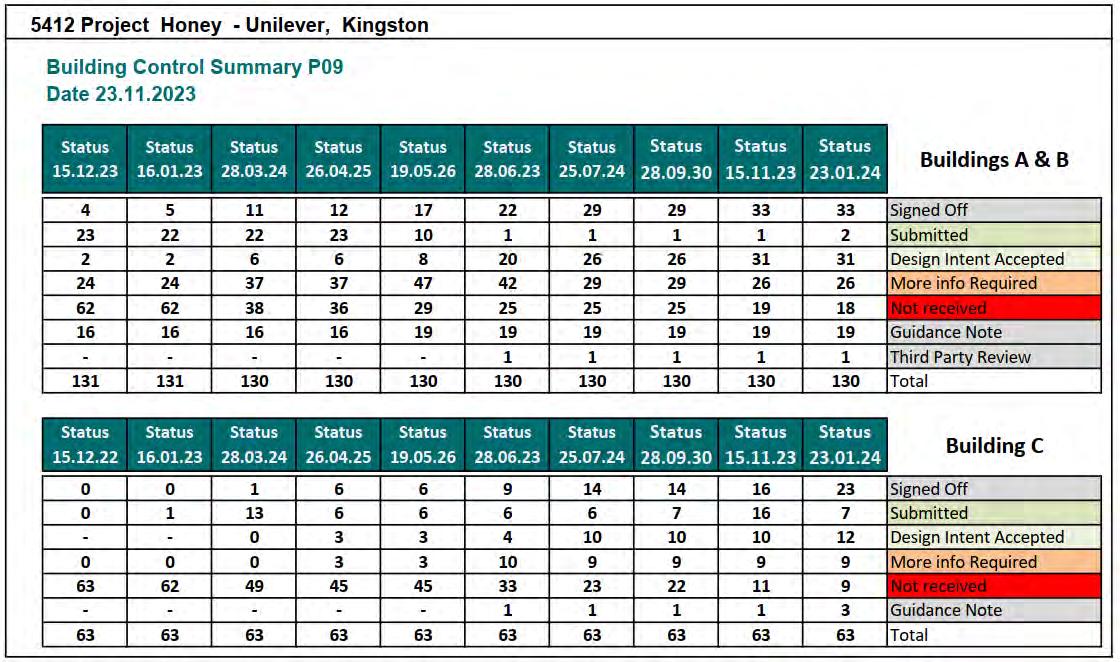

• Building Control Certification
o Discussions ongoing with SWECO regarding Final Cert and Letter of Comfort
• Building C Parkmark Accreditation – instruction issued in part

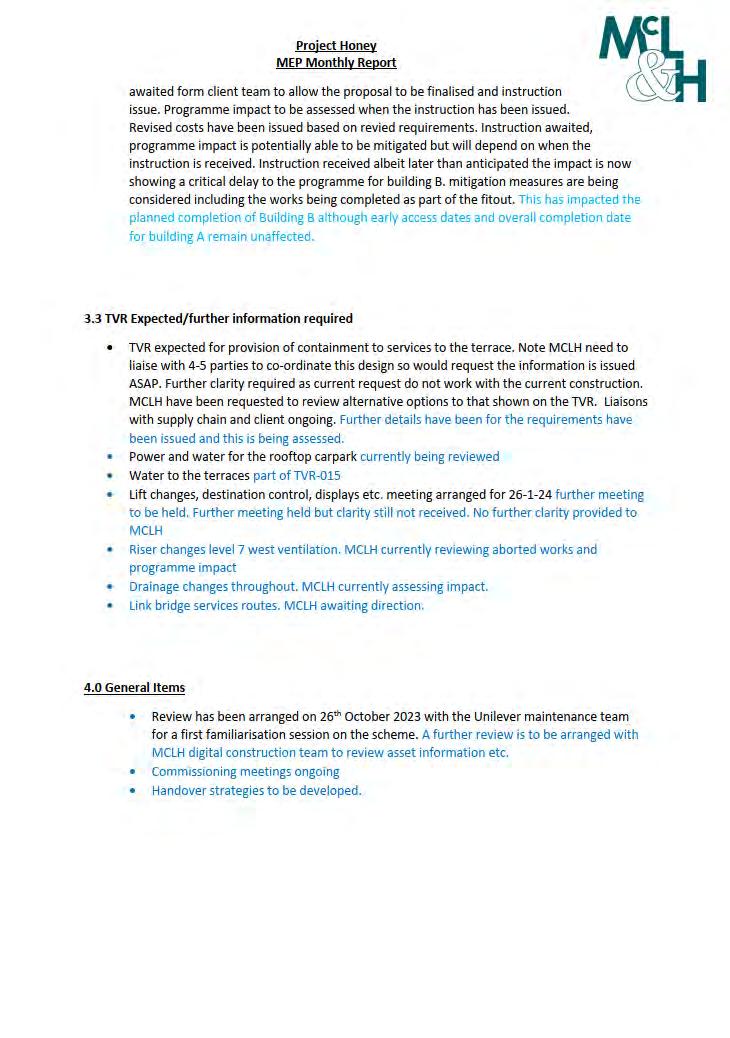

• Tenant Fit-Out design potentially not aligned with MCLH ER’s / Instructed works (e.g. Modified CAT A/Omissions)
• Access Control – Omitted from MCLH Contract – EAI 118 Issued
• S278 Works
o Tender Pack issued for pricing. Quotations due Mid May ‘24
o RFC now issued
o Works will not be completed for Practical Completion
• SMART Buildings – EAI 115 issued and programme impact being discussed
7. Outstanding Instructions/Tenant Variations
• Integration of Smart Building Technology – EAI 115 issued
• External Lighting – cost currently being rationalised by FH. EAI to be issued

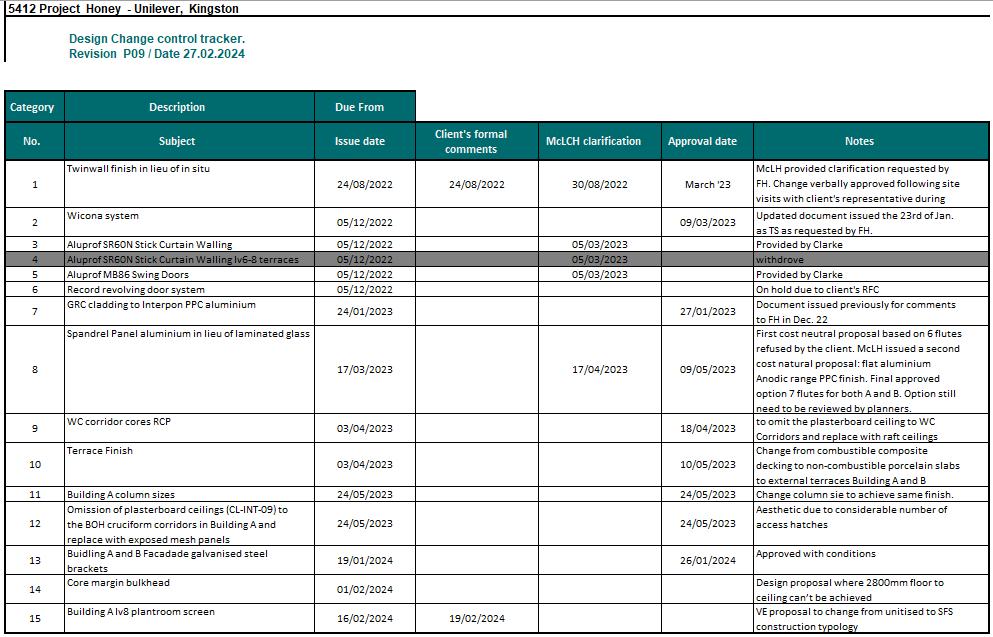

• EAI 29 Rev 1 to be reviewed and comments updated: Anti Drumming, Reverberation etc
• EOT 3 to be updated – Removal of Early Access Dates Schedule, draft dates and protocol submitted to Francis Hunter
• Terrace Façade Penetrations (RFC 54) – cost submitted but revised brief now issued
• General Instructions – future RFC’s instructed will more than likely impact Programme, for example -
- RFC 005 – External Building Signage
- RFC 061 & 070 – Woodland Walk and Building C Roof Terrace; more information required from client
- EAI 089 – Louvres to Façade; design instruction received and being progressed. Impact on construction to be reviewed following detailed design and instructed.
- EAI 096 Public Artwork – RBG & Clarke’s design instructed and completed. FH to issue instruction for detailed design in order to progress.
- EAI 117 – Building B GF Changing Layout; reduced Scope instructed, potential risk to Programme
Progress Report 24 - 25.04.24
- EAI 118 – Access Control Hardware & CCTV Mounts – potential risk to programme (Glazed Door lead in times)
- EAI 104 Rev 3 – Blind Boxes have been instructed including recommencement of Curved Grill procurement. Potential Programme impact as already advised
8. Site Wide Issues / Matters Affecting Progress
• Twin Wall impact
• Wayleaves
9. Quality and Environmental
• Environmental plan in place
• Section 61 approved
• CPDs carried out: Pudlo Waterproofing, quelfire (fire collars), CCL (post tensioning), Imperial Ductwork, British Gypsum and Wicona.
Progress Report 24 - 25.04.24
Progress Report 24

10. Sustainability
- 25.04.24
BREEAM (Tracker attached)
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24

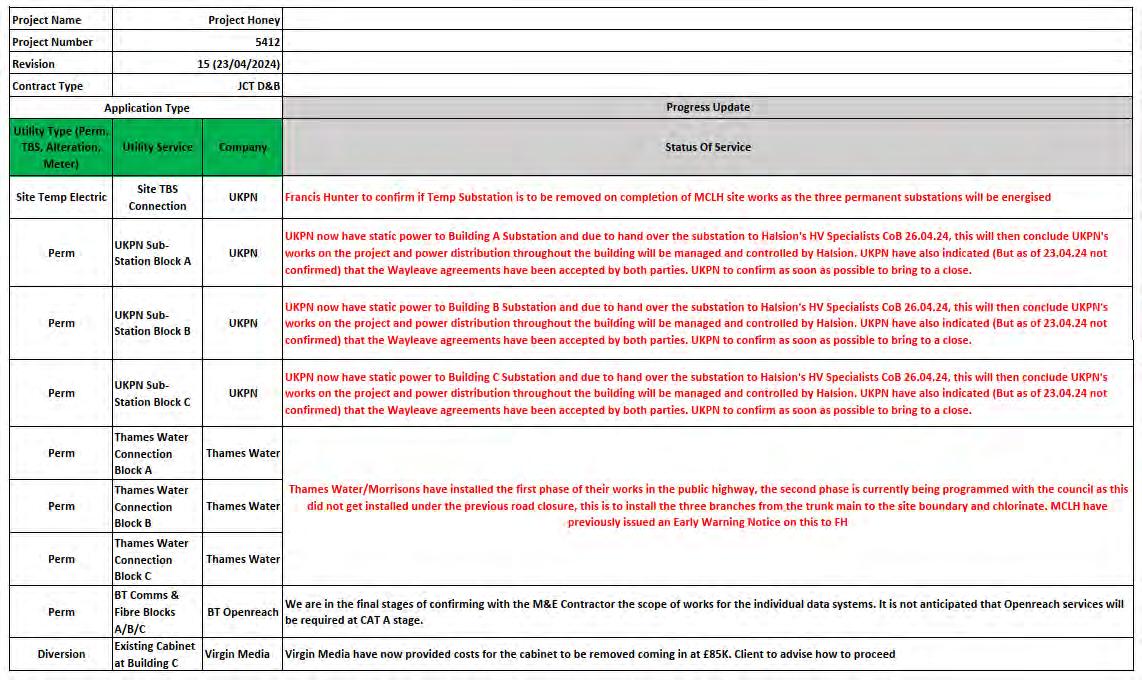

11. Utility Tracker
Progress
12 MEP Report
Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24
13 Civils
Structures Report
- 25.04.24
&
Report 24 - 25.04.24
Progress

14.
Architectural Report
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24

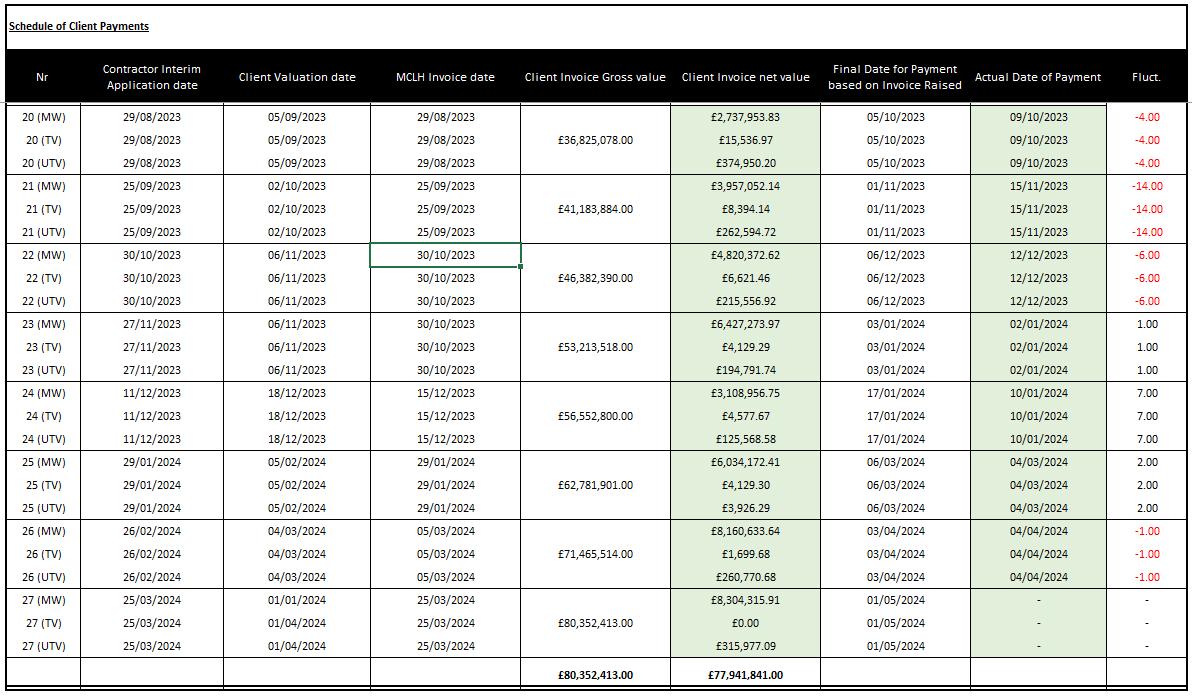

15.1 Valuation
- Valuation Nr 28 to be submitted on the 29th April 2024
- Next payment Cert. due on the 9th May 2024
15.2 Projected Final Account
£121,032,434
15.3 Provisional Sums
• Statutory Authorities £735,000
o £735,000 Omitted (under EAI 063)
o £461,993.51 Addition (under EAI 063)
• Bird Deterrent to Facades £50,000 – to be omitted
• Fibre Backbone Cabling for Wired Score £180,000
• Public Art Works £50,000 (design instructed under EAI 096)
• Asbestos £5,000 (Omitted under EAI 063)
• Newts, bats & bat roosts, Japanese knotweed and hogweed. £5,000 (Omitted under EAI 063)
• UXO £5,000 (Omitted under EAI 063)
• Cycle Path Works including Green Wall to Carpark £295,000 – to be omitted
Progress Report 24 -
15 Contract and Commercial Matters
25.04.24
15.4 Employer Instructions
• EAI 001 – BIM Level 2
• EAI 002 – Townhall design feasibility
• EAI 003 – Gym design feasibility
• EAI 004 – Drop kerb
• EAI 005 – S106
• EAI 006 – Townhall & Gym additional piles (only)
• EAI 007 – ASHRAE
• EAI 008 – Below ground drainage
• EAI 009 – CAT A Omission
• EAI 010 – Bridge Link Widening
• EAI 011 – Townhall & Gym
• EAI 012 – MER and SER Loading Design
• EAI 013 – S73 Façade and Plant Screen Amendment Rev1
• EAI 014 – MER and SER Loading Changes - 6th Floor Building B
• EAI 015 – Building B Column Sizes
• EAI 016 – Above Ground Drainage
• EAI 017 – Greywater and Rainwater Design
• EAI 018 – Additional Pile Mat
• EAI 019 – Change in RAL Colours
• EAI 020 – Gym Structural Changes
• EAI 021 – Building C Fees
• EAI 022 – Building A Ground Floor Amendments
• EAI 023 – Signage Design Costs
• EAI 024 – Rainwater Harvesting Tank (Supply Only)
• EAI 025 – CHW and LTHW Design
• EAI 026 – Ventilation Uplift Design
• EAI 027 – Splice Details
• EAI 028 – Green and White Brick Confirmation
• EAI 029 – GRC Alternative
• EAI 030 – Expenditure of FP McCann MSCP Structure
• EAI 031 – Green Wall Design
• EAI 032 – Town Hall Design Amendments
Report 24 - 25.04.24
Progress
• EAI 033 – Building C Below Ground Obstruction
• EAI 034 – LV Design
• EAI 035 – Domestic Water
• EAI 036 – Structural Penetrations
• EAI 037 - Wicona
• EAI 038 – Rainwater Harvesting Tank
• EAI 039 – New Sewer Connection & Manhole
• EAI 040 – Internal Ramps
• EAI 041 – Townhall Amendments
• EAI 042 – Spandrel Panels
• EAI 043 – Terrace Doors
• EAI 044 – SMART Buildings Design
• EAI 045 – Building A – Slab Penetrations for Future MEP
• EAI 046 – Building B Slab Penetrations
• EAI 047 – MSCP Cast In Channels
• EAI 048 – WC Corridor RCPs
• EAI 049 – Secondary CAT A Omissions
• EAI 050 – CCTV and Access Control Omissions
• EAI 051 – Terrace Finishes
• EAI 052 – Building A and B Spandrels
• EAI 053 – Building C Ramp Ducts
• EAI 054 – Building A Column Sizes
• EAI 055 – Building A Soffit to Retail Entrance
• EAI 056 – Expenditure of Building C Lifts
• EAI 057 – Circleslide Doors
• EAI 058 – Generator Uplift TVR Construction Works
• EAI 059 – Domestic Water TVR Construction Works
• EAI 060 – Gym Floor Design
• EAI 061 – Building B Stair Glazed Screen/Fire Curtain Omission (Levels 1-10)
• EAI 062 – Expenditure of Utilities Prov Sum
• EAI 063 – Omission of Undefined Provisional Sums
• EAI 064 – Service Yard Door
• EAI 065 – Mullion Cover Strips
Progress Report 24 - 25.04.24
• EAI 066 – Ventilation TVR Construction Works
• EAI 067 – LV Panel Enhancement Construction Works
• EAI 068 – Modified CAT A
• EAI 069 – Maple & Halsion MSCP Construction Works
• EAI 070 – Gym Floor Dead Load Increase
• EAI 071 – Omission of Soap Dispensers
• EAI 072 – MSCP Additional Fire Alarm Protection
• EAI 073 – CHW & LTHW Uplift
• EAI 074 – RAL 9010
• EAI 075 – BOH Corridor Ceilings
• EAI 076 – Building A & B Shell and Core Sockets
• EAI 077 – Rainwater Above Ground
• EAI 078 – WC Hand Driers
• EAI 079 – Building B Opening
• EAI 080 – Corian Alternative
• EAI 081 – Building C Packages (Brick, Block, Roof)
• EAI 082 – Bridge Link Design
• EAI 083 – Building A Feature Stair Nosing
• EAI 084 – Omission of Toilet Roll Holders
• EAI 085 – CAT A Temporary Measures
• EAI 086 – Façade Lighting
• EAI 087 – Internal & External Doors (Design)
• EAI 088 – Building B Changing Places (Design)
• EAI 089 – External Louvres (Design)
• EAI 090 – Door Vision Panel Beads
• EAI 091 – Building A & B GF Screed and RAF Omission
• EAI 092 – Building C Planning Approval
• EAI 093 – BREEAM MAN02 Credit omission
• EAI 094 – Building C Fitout and Metalwork Packages
• EAI 095 – Town Hall Intumescent paint
• EAI 096 – Public Art Design
• EAI 097 – Feature Stair Curtains
• EAI 098 – MSCP Access Control/Park Mark/CCTV
Progress Report 24 - 25.04.24
• EAI 099 – Blind Box Design
• EAI 100 – Woodland Walk Widening Design
• EAI 101 – WC Frameless Grilles
• EAI 102 – Omission of Tea Point Fans & Ducts
• EAI 103 – Wiring Accessories
• EAI 104 – Blind Box Construction Rev3
• EAI 105 – Disabled Refuge Phone Recess
• EAI 106 – Public Art Schematic & Connection
• EAI 107 – RAF Omissions
• EAI 108 – Galv. Brackets
• EAI 109 – Building A Baby Changing
• EAI 110 – Building C roof Landscaping
• EAI 111 – Building A Level 9 AHU Clash
• EAI 112 – Service Yard Door
• EAI 113 – Building A & B Manifestation
• EAI 114 – Building C Shower Shelf
• EAI 115 – SMART Network Infrastructure
• EAI 116 – BOH Door
• EAI 117 – Building B Changing Places Instruction
• EAI 118 – Access Control Hardware & CCTV Mounts
• EAI 119 – Brook Street Trees
• EAI 120 – Water Reduction
• EAI 121 – Floor Screed
• EAI 122 – Irrigation to Building C
15.5 Project Cash Flow
• Cashflow issued on 1st December 22 in line with Townhall Instruction
• Cashflow Rev 1 issued on 8th August 23
• Cashflow Rev 2 issued on 6th February 24
• Cashflow Rev 3 issued on 6th March 24
Progress Report 24 - 25.04.24
16 Warranty / Sub-Contract / Appointment Tracker
• See attached
• Key Changes in the period
o Warranties – Francis Hunter have issued client version as a REV E Tracker
o Certified Sub-Contracts
AYM issued
Sub-Sub-Contracts – clarity needed around certifying of these
MCLH to issue any further redacted Sub-Contracts upon signing
17 Procurement schedule
Key Changes in the Period
• Building A & B (see attached)
• Building C (see attached)
18 Commercial and Contractual (in the Period)
• Early Access Protocol
o DRAFT issued to Francis Hunter
Overbury/Mace have returned comments; MCLH to review
o Early Access Protocol meetings ongoing with Overbury & Mace
o Point cloud Survey Parameters issued by MCLH
• Early Warnings
o EWN 001 – Brooke Street Closure; issued on 24/03/23
o EWN 002 – Thames Water; issued on 18/10/23
o EWN 003 – UKPN Wayleaves; issued on 19/03/24
Progress Report 24
- 25.04.24
Progress

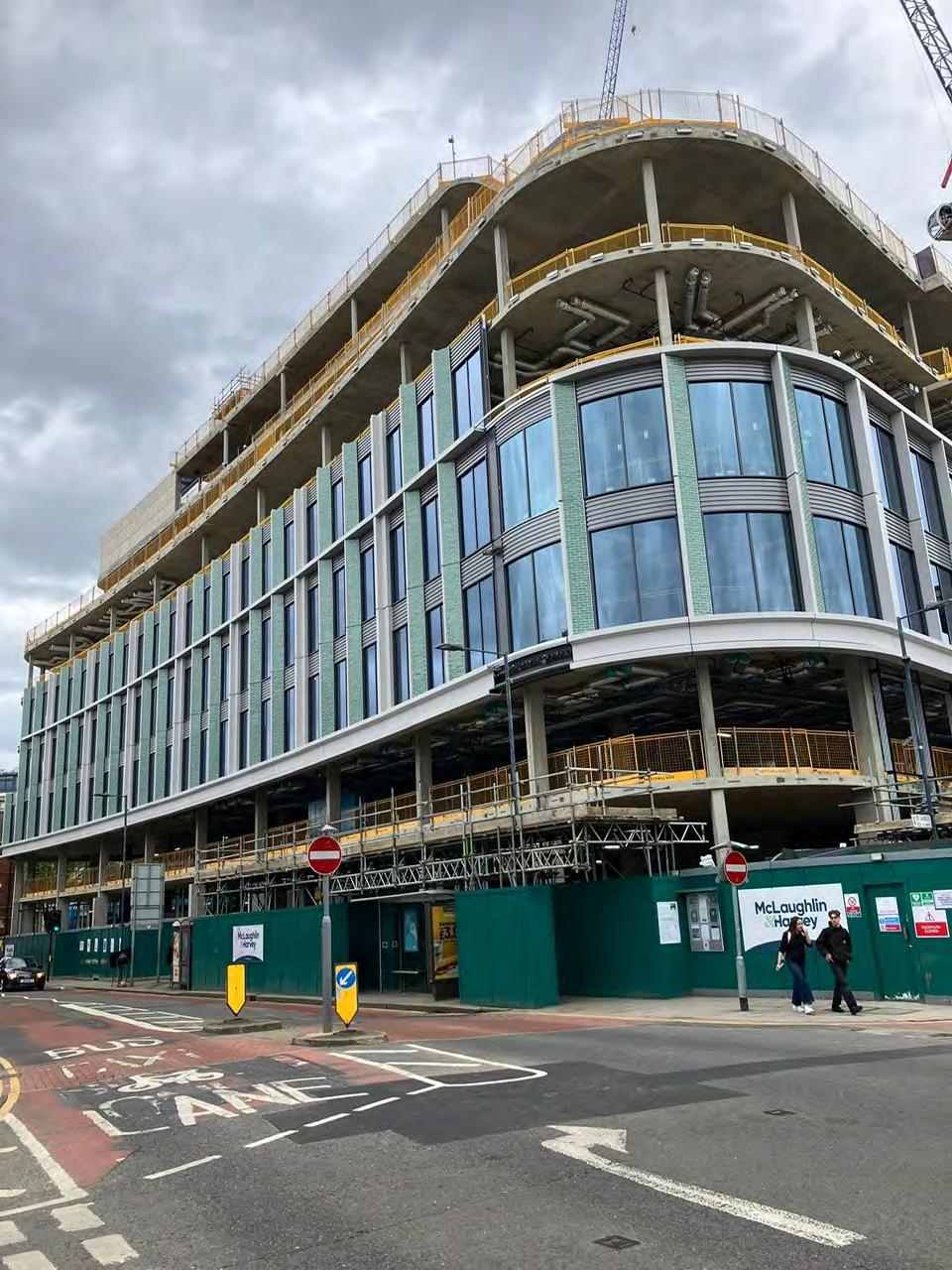

A Unitised Progressing
Report 24 - 25.04.24 19 Progress Photos Block
Progress Report 24 - 25.04.24

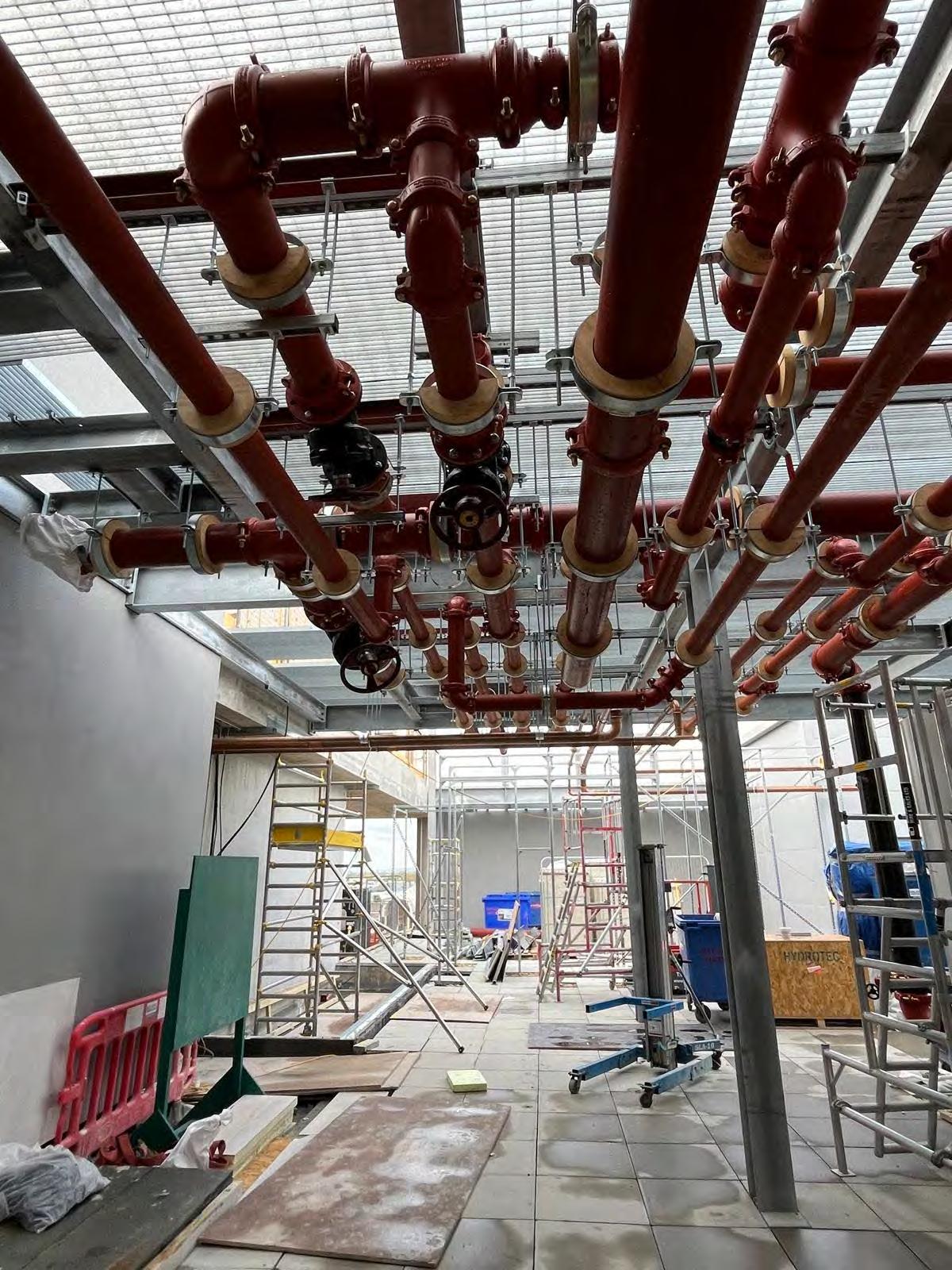

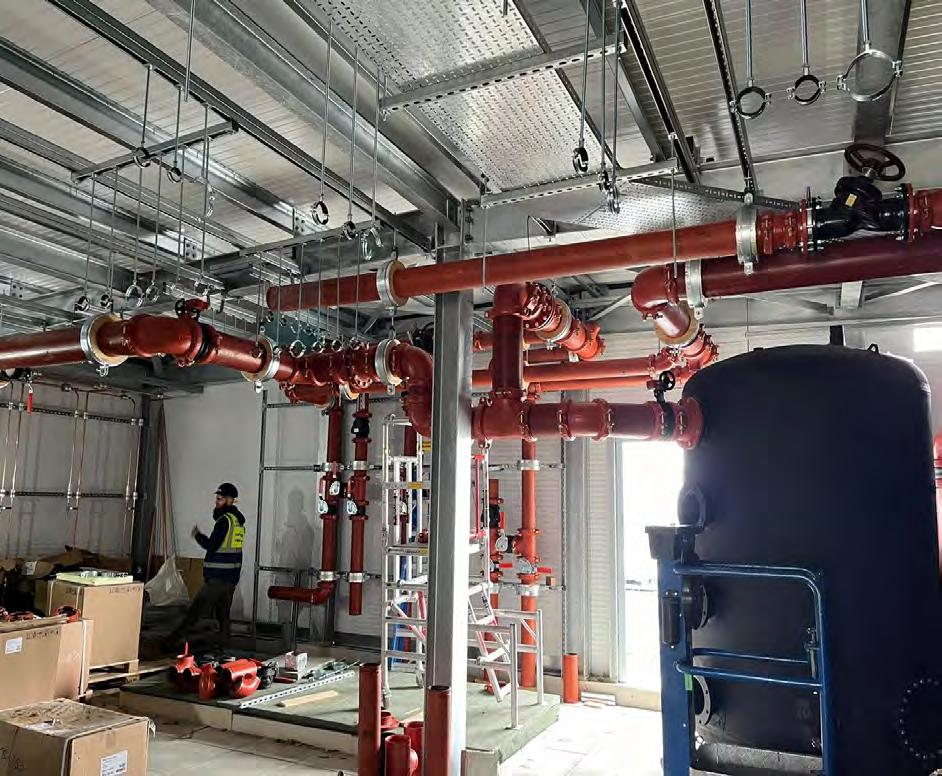

Block A Pipework Progressing
Progress Report 24 - 25.04.24
Building B Roof Plant Room
Progress Report 24 - 25.04.24
Car Park MEP Ongoing
Progress Report 24

20 SHEQ Audit
- 25.04.24
Report 24 - 25.04.24
Progress
Report 24 - 25.04.24
Progress
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24
Progress Report 24 - 25.04.24 21 Planning Tracker/Update *Latest planning condition tracker has been issued 22 Building Control Tracker 23 Change Control Tracker
construction programme
FH090-151015 appendix c
McLH
09/11/22A 10/11/22A 09/11/22A 13/01/23A 02/06/23A 27/07/23A 03/02/23A 08/04/24 12/09/22A 19/09/22A 03/10/22A 21/10/24 21/10/24 24/10/22A 10/10/22A 16/02/23A 10/02/23A 09/03/23A 02/02/23A 02/02/23A 28/06/23A 27/11/23A 31/10/23A 07/11/23A 15/11/23A 02/10/23A 13/12/23A 06/10/23A 13/09/24 27/06/24 06/10/23A 06/10/23A
CONTRACTOR PROGRAMME DESCRIPTION: PROJECTHONEY - Construction Progress - 17/04/24 - Jagged Line Summary CLIENT STATUS CODE: FILE NAME: EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.00 - Client Issue PROGRAMME REFERENCE: 5412-C03 LAST ACCEPTED PROG: ISSUE/REVISION DATE: 22/03/2024 REVISION COMMENT: S2 - For Information NATIVE FILE REFERENCE:-S:\Planning\_1 workspace\Project Honey 2021\Programmes\Project Honey Progress 170424\EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.03 - progress 170424 Jagged.pp PROGRAMME STATUS: C03.03 Print Date: 19/04/2024 12:18:09 Page 1 of 2 REVISION AUTHOR: JP/SL PROGRAMME VIEW: working LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete 2023 2022 2024 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 39 40 41 42 43 44 45 46 47 48 49 50 51 52 53 54 55 56 57 58 59 60 61 62 63 64 65 66 67 68 69 70 71 72 73 74 75 76 77 78 79 80 81 82 83 84 85 86 87 88 89 90 91 92 93 94 95 96 97 Pre-Construction,Mobilisation,Co-ordinatedDesign ContractSignature DefermentPeriod McLHLongstopDate MainContractorMobilisation DateofPossession Section1Completion Section2Completion ProvisonalSums(latestinstructiondate) Stage4DesignCommence PlanningConditionDischarge ExistingMSCPDemolition Stat.Consents MainContractorMobilisation MainAccommodation(off-site) StartonSite(BuildingAPossession) OverallSummaryBar ProjectHoneyConstructionProgramme StartonSite SiteWideUtilities(tbc) Cranage ExcavationsandPrep CompletionofDraiangeAheadofTCInstall SurfaceWaterandAttenuationTank FoulWater ApplicationstoThamesWater ConnectionsIntoExistingThamesWater IncomingServices/Ducting Hoists OriginalStartonSite DeferementofDateofPossession(1) TownHallInstructionEAI011(newbaselinedate) Section02BuildingAandBuildingC TheHoneyBuilding(BuildingA)(Grd,1st-8th,Roof) Bearing/FoundationPiling MitchellsonsStartasperDeferementProgramme Sub-Structures MezzanineArea MezzFloorComplete GroundFloorUpstands InsituColumnsGround1st LGFandGFWorks(installfrombelowlevel1) UpperFloorstoRoofLevel FRCCOREWALLOVERRUNS FRCCAPPINGSLABTOCORE FRCPERIMETERPARAPETWALLS Pre-CastStairInstallationsB1-L9Roof BlockAStrikeandClear FacadeMobilisation BuildingEnvelopeWorks ABlockInstallation SFS SlabEdgeBrackets GfLevel01 Level2 Level3 Level4 Level5 Level6 Level7 Level6LinkBridge Level8 Level9/Roof GF1Floor ReceptionLink GRCCladding BrickCladding/Screens/Balustrades Cappings HoistInfillstoBuildingA FinishingWorks RoofWorks Level09 TerraceLevel08 TerraceLevel06 PlantAreaLevel08 BriseSoleiltoRoofLevel InfillsfollowingRemovalofHoist1 TemporaryWeatheringtoUpperFloorsfrom6thFloorto CommenceStage1Finishes OriginalCoreDate C01CoreDate C02CoreDate CoreSubstantiallyWeathertighttoCommenceFitOut BuildingProgressivelySubstantiallyWeathertighttoCommence Stage2Finishes LinkBridgeCompleteandAccess(1)Closed LiftInstallationsBuildingA WeatheringtoLiftShafts/Cores TemporaryPower/LightingtoLiftShafts Strip/CleanLiftShafts OTISInstallationsBuildingA BBUlinktohoist BBUDurationfor00-L07and00-L06 Re-InstatementsandTestingandCommissioning HandoverandCompletion BuildingServices InternalFinishesNEW MEPMezzanineFit-Out FirstFloor(EastShellandCore+RAFWestCATA) 23w1d 8w 8w 65w1d 26w2d 15w2d 16w 11w 14w 103w1d 103w1d 41w4d 75w 4w 1w3d 10w1d 2w 4w 33w3d 102w1d 102w1d 5w 15w4d 5w 3w 1w 7w 44w1d 1w1d 1w 3w1d 23w4d 4w 4w3d 48w3d 37w3d 2w3d 2w3d 1w2d 5w2d 5w2d 5w2d 5w2d 5w2d 5w2d 3w3d 11w1d 3w4d 14w3d 8w3d 21w3d 16w2d 4w 1w 15w3d 26w2d 12w 23w2d 12w1d 23w4d 6w 3w 46w4d 1w4d 7w 7w 36w2d 20w2d 4w 55w2d 54w1d 6w 42w4d 06/09/21A 17/05/22A 18/05/22A 14/07/22A 15/07/22A 20/09/22A 05/08/24 21/10/24 20/06/22A 30/05/22A 18/05/22A 14/06/22A 01/07/22A 17/06/22A 15/07/22A 20/09/22A 12/09/22A 12/09/22A 20/09/22A 14/02/23A 10/10/22A 13/10/22A 10/11/22A 31/10/22A 21/10/22A 02/06/23A 14/07/23A 09/01/23A 31/07/23A 12/09/22A 19/09/22A 03/10/22A 20/09/22A 20/09/22A 20/09/22A 10/10/22A 17/10/22A 04/01/23A 09/03/23A 13/01/23A 27/01/23A 10/05/23A 09/01/23A 24/10/23A 01/11/23A 25/10/23A 06/04/23A 16/11/23A 06/09/23A 20/09/23A 20/09/23A 20/09/23A 20/09/23A 09/10/23A 11/10/23A 03/11/23A 28/11/23A 21/12/23A 29/01/24A 21/02/24A 22/03/24 12/03/24A 16/04/24 26/02/24A 26/04/24 27/03/24 19/04/24 29/07/24* 23/04/24 28/05/24* 07/11/23A 07/11/23A 28/11/23A 28/02/24A 16/11/23A 16/11/23 15/01/24 18/08/23A 13/09/23A 21/09/23A 05/10/23A 08/11/23A 28/02/24 26/04/24 06/11/23A 06/11/23A 06/11/23A 13/11/23A 31/01/24A 22/04/24 22/04/24 16/09/24 11/10/24 04/09/23A 18/09/23A 22/03/24A 18/09/23A 28/02/22A 17/05/22A 14/07/22A 14/07/22A 09/09/22A 20/09/22A 05/08/24* 21/10/24* 18/10/23 30/05/22A 23/11/22A 30/09/22A 24/10/22A 02/09/22A 24/10/22A 20/09/22A 21/10/24 21/10/24
05/03/24
30/08/24 14/08/24 23/08/24 29/04/24 13/09/24 28/05/24 12/02/24 28/05/24 28/05/24 17/05/24 10/01/24 02/02/24 18/08/23A 13/09/23A 21/09/23A 05/10/23A 08/11/23A 28/02/24 26/04/24 17/10/24 16/11/23A 22/12/23A 12/01/24A 17/10/24 22/04/24 13/09/24 11/10/24 11/10/24 15/10/24 21/10/24 07/05/24 31/07/24 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 66% 66% 100% 100% 99% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 57% 57% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 41% 65% 100% 100% 100% 100% 100% 100% 100% 100% 100% 87% 54% 8% 57% 18% 73% 100% 74% 66% 42% 100% 100% 100% 100% 100% 100% 100% 100% 31% 100% 100% 100% 26% 71% 46% 44% 83% 100% 100% 100% 100% 100% 100% 70% 100% 100% 100% 100% 100% 100% 100% 52% 52% 100% 93% 91% 100% 100% 100% 100% 100% 100% 100% 58% 100% 100% 100% 48% 48% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 15% 24% 100% 100% 100% 82% 55% 38% 21% 19% 19% 8% 10% 46% 80% 53% 21% 42% 100% 100% 100% 100% 100% 39% 100% 100% 100% 38% 55% 40% 10% 56% 2ContractSignature 3DefermentPeriod 4McLHLongstopDate 5MainContractorMobilisation 6DateofPossession 7Section1Completion Section2Completion 9 ProvisonalSums(latestinstructiondate) 10StageDesignCommence 11 PlanningConditionDischarge 12 ExistingMSCPDemolition 13 Stat.Consents 14MainContractorMobilisation 15 MainAccommodation(off-site) 16StartonSite(BuildingAPossession) 17 OverallSummaryBar 18 ProjectHoneyConstructionProgramme 19StartonSite SiteWideUtilities(tbc) 21 Cranage 22ExcavationsandPrep 23CompletionofDraiangeAheadofTCInstall 24SurfaceWaterandAttenuationTank 25FoulWater 26ApplicationstoThamesWater 27ConnectionsIntoExistingThamesWater 28IncomingServices/Ducting 30OriginalStartonSite 31DeferementofDateofPossession(1) 32TownHallInstructionEAI011(newbaselinedate) 33 Section02BuildingAandBuildingC 34 TheHoneyBuilding(BuildingA)(Grd, 35Bearing/FoundationPiling 36MitchellsonsStartasperDeferementProgramme 37 Sub-Structures 38MezzanineArea 39MezzFloorComplete 40GroundFloorUpstands 41InsituColumnsGround1st 42LGFandGFWorks(installfrombelowlevel1) 43 UpperFloorstoRoofLevel 44FRCCOREWALLOVERRUNS 45FRCCAPPINGSLABTOCORE 46FRCPERIMETERPARAPETWALLS 47 Pre-CastStairInstallationsB1-L9Roof BlockAStrikeandClear 49FacadeMobilisation 50 BuildingEnvelopeWorks 51 ABlockInstallation 52SFS 53SlabEdgeBrackets 54GfLevel01 55Level2 56Level3 57Level4 58Level5 59Level6 60Level7 61Level6LinkBridge 62Level8 63Level9/Roof 64 GF1Floor 65ReceptionLink 66 GRCCladding 67 BrickCladding/Screens/Balustrades 68Cappings 69HoistInfillstoBuildingA 70 FinishingWorks 71 RoofWorks 72Level09 73 TerraceLevel08 74TerraceLevel06 75 PlantAreaLevel08 76BriseSoleiltoRoofLevel 77InfillsfollowingRemovalofHoist1 78TemporaryWeatheringtoUpperFloorsfrom6thFloortoCommenceStage1Finishes 79OriginalCoreDate 80C01CoreDate 81C02CoreDate 82CoreSubstantiallyWeathertighttoCommenceFitOut 83BuildingProgressivelySubstantiallyWeathertighttoCommenceStage2Finishes 84LinkBridgeCompleteandAccess(1)Closed 85 LiftInstallationsBuildingA 86WeatheringtoLiftShafts/Cores 87TemporaryPower/LightingtoLiftShafts 88Strip/CleanLiftShafts 89 OTISInstallationsBuildingA BBUlinktohoist 91 BBUDurationfor00-L07and00-L06 92Re-InstatementsandTestingandCommissioning 93HandoverandCompletion 94 BuildingServices 95 InternalFinishesNEW 96MEPMezzanineFit-Out 97 FirstFloor(EastShellandCore+RAF/WestCATA) + + + + + + ++ + + + + ++ + + + + ++ ++ + + ++ ++ ++ ++ ++ ++ ++ ++ ++ ++ + + + + ++ + + ++ + + ++ + + 6w LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 2023 2022 2024
20/09/22A 15/12/23 29/04/24
17/10/23A 16/11/23 11/12/23 17/01/24 09/02/24
28/03/24 18/04/24 03/06/24 13/05/24 11/06/24 27/06/24
CONTRACTOR PROGRAMME DESCRIPTION: PROJECTHONEY - Construction Progress - 17/04/24 - Jagged Line Summary CLIENT STATUS CODE: FILE NAME: EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.00 - Client Issue PROGRAMME REFERENCE: 5412-C03 LAST ACCEPTED PROG: ISSUE/REVISION DATE: 22/03/2024 REVISION COMMENT: S2 - For Information NATIVE FILE REFERENCE:-S:\Planning\_1 workspace\Project Honey 2021\Programmes\Project Honey Progress 170424\EDC-MLH-XX-XX-PR-W-6002-ContractProgramme-A5-C03.03 - progress 170424 Jagged.pp PROGRAMME STATUS: C03.03 Print Date: 19/04/2024 12:18:12 Page 2 of 2 REVISION AUTHOR: JP/SL PROGRAMME VIEW: working LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete 2023 2022 2024 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 98 99 100 101 102 103 104 105 106 107 108 109 110 111 112 113 114 115 116 117 118 119 120 121 122 123 124 125 126 127 128 129 130 131 132 133 134 135 136 137 138 139 140 141 142 143 144 145 146 147 148 149 150 151 152 153 154 155 156 157 158 159 160 161 162 163 164 165 166 167 168 169 170 171 172 173 174 175 176 177 178 179 180 181 182 183 184 185 186 187 188 189 190 191 192 193 SecondFloor(CATA) ThirdFloor(CATA) FourthFloor(CATA) FifthFloor(WestShellandCore+RAFEastCATA) SixthFloor(ShellandCore+RAF) SeventhFloor(ShellandCore+RAF) EighthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) CompletionofFit-OutfollowingRemovalofHoist1 StairsandLobbies CompletionActivities TargetEarlyAccessDates FirstFloor(EastShellandCore+RAFWestCATA) SecondFloor(CATA) ThirdFloor(CATA) FourthFloor(CATA) FifthFloor(WestShellandCore+RAFEastCATA) SixthFloor(ShellandCore+RAF) SeventhFloor(ShellandCore+RAF) EighthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) HandoverofTheHoney TheBee-keepers(CarPark)(indicativeProgramme) InstructionRequiredtoCompleteOutstandingClientWorks GasDiversionComplete(byothers)(tbc) OutstandingClientWorks(includingpilingmat,breakoutfootpath) InstructionRequiredtoCompleteOutstandingClientWorks GasDiversionComplete(byothers)(tbc) OutstandingClientWorks(includingpilingmat,breakoutfootpath) PlanningApprovalGrantedforBuildingC VanElleOriginalPilingDate VanElleActualStartonSiteDuetoPlanning EAI017RainwaterHarvestingTankDesignInstructionIssued EAI024RainwaterHarvestingTankProcurementInstructionIssued EAI038RainwaterHarvestingTankInstallInstructionIssued Bearing/FoundationPiling BLOCKCCARPARK Pre-CastSuperstructure BlockCEnvelope BlockCInternalFit-OutandBuildingServices HandoverofTheBeeKeepers OriginalStartonSite DefermentofBuildingBandBuildingCDateofPossession(2) Section01BuildingB TheHiveBuilding(BuildingB)(Grd,1st-10th,Roof) Bearing/FoundationPiling Sub-Structures Pre-CastGroundFloorSlab InstallPre-CastPlanks ScreedTopping(75mm) Superstructure BlockBStrikeandClear Upstands+PlinthsonRoof Pre-CastStairInstallationsB1-L9Roof LiftCoresCappedat11thFloorLevel FacadeMobilisation BuildingEnvelopeWorks RoofingWorks TerraceLevel10 RoofLevel CoreSubstantiallyWeathertighttoCommenceFitOut BuildingProgressivelySubstantiallyWeathertight LiftInstallationsBuildingB BuildingServices InternalFinishesNEW FirstFloor(ShellandCore+RAF) SecondFloor(ShellandCore+RAF) ThirdFloor(ShellandCore+RAF) FourthFloor(CATA) FifthFloor(CATA) SixthFloor(ShellandCore+RAF) SeventhFloor(CATA) EighthFloor(CATA) NinthFloor(ShellandCore+RAF) TenthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF)(instructedtostopworksonground floor21/03/24duetoclientchanges) ClearOutandCleanFloor ReceptionArea(Shell) RetailArea CompletionofFIt-OutfollowingRemovalofHoist2 StairsandLobbies CompletionActivities TargetEarlyAccessDates FirstFloor(ShellandCore+RAF) SecondFloor(ShellandCore+RAF) ThirdFloor(ShellandCore+RAF) FourthFloor(CATA) FifthFloor(CATA) SixthFloor(ShellandCore+RAF) SeventhFloor(CATA) EighthFloor(CATA) NinthFloor(ShellandCore+RAF) TenthFloor(ShellandCore+RAF) GroundFloor(ShellandCore+RAF) HandoverofTheHive(BuildingB) LandscapingandPublicRealm 39w3d 38w3d 37w4d 37w3d 37w3d 35w3d 36w1d 36w3d 6w 32w1d 15w3d 8w 99w2d 1w 2w 1w 2w 3w3d 4w 8w3d 38w3d 23w2d 42w1d 88w3d 88w3d 3w3d 8w4d 5w 1w 1w 40w2d 2w 2w3d 20w4d 2w 37w 15w 12w 12w 44w1d 40w 47w1d 38w 33w2d 32w2d 31w3d 30w1d 29w1d 28w1d 27w1d 26w2d 25w2d 28w2d 4d 14w 14w 6w 17w 11w4d 10w 32w4d 02/10/23A 16/10/23A 30/10/23A 13/11/23A 27/11/23A 11/12/23A 08/01/24A 08/01/24A 12/06/24 16/02/24A 03/07/24 12/08/24 01/10/24 12/08/24 27/08/24 17/09/24 24/09/24 10/09/24 17/09/24 01/10/24 07/10/24 21/10/24 10/10/22A Week8A Week10A Week13A 07/11/22A 21/11/22A 12/12/22A 11/01/23A 10/10/22A 17/01/23A 31/10/22A 27/01/23A 10/03/23A 17/01/23A 20/02/23A 21/04/23A 29/11/23A 11/12/23A 21/10/24 12/09/22A 26/09/22A 10/10/22A 10/10/22A 10/10/22A 14/11/22A 19/04/23A 25/05/23A 30/06/23A 16/01/23A 07/11/23A 06/10/23A 26/04/23A 06/10/23A 29/08/23A 12/09/23A 04/10/23A 04/10/23A 25/10/23A 06/10/23A 09/01/24A 11/09/23A 29/09/23A 21/08/23A 21/08/23A 04/09/23A 18/09/23A 02/10/23A 16/10/23A 30/10/23A 13/11/23A 27/11/23A 11/12/23A 08/01/24A 08/01/24A 30/07/24 16/04/24 16/04/24 02/05/24 05/04/24A 14/05/24 13/05/24 09/07/24 13/05/24 20/05/24 18/06/24 02/07/24 11/06/24 02/07/24 23/07/24 09/07/24 16/07/24 23/07/24 05/08/24 28/02/24 23/07/24 30/07/24 07/08/24 20/08/24 04/09/24 04/09/24 23/09/24 25/09/24 23/07/24 04/10/24 21/10/24 07/10/24 01/10/24 12/08/24 27/08/24 17/09/24 24/09/24 10/09/24 17/09/24 01/10/24 07/10/24 21/10/24* 21/10/24 Week8A Week10A Week14A 07/11/22A 25/11/22A 23/12/22A 11/01/23A 02/11/22A 17/01/23A 31/10/22A 27/01/23A 10/03/23A 13/02/23A 27/04/23A 02/02/24A 29/05/24 21/10/24 21/10/24* 12/09/22A
05/08/24
02/11/22A
20/11/23A 24/10/23A 21/09/23A 06/10/23A 11/09/23A 14/06/24 30/01/24 09/01/24 30/01/24 06/10/23A
02/08/24 24/07/24 05/08/24 31/05/24 10/05/24 17/05/24 28/05/24 31/05/24 07/06/24 14/06/24 21/06/24 01/07/24 08/07/24 29/07/24 02/08/24 24/07/24 24/07/24 14/06/24 05/08/24 05/08/24 23/07/24 09/07/24 13/05/24 20/05/24 18/06/24 02/07/24 11/06/24 02/07/24 23/07/24 09/07/24 16/07/24 23/07/24 05/08/24* 21/10/24 77% 60% 56% 47% 41% 37% 34% 16% 1% 58% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 90% 30% 100% 100% 74% 74% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 90% 100% 100% 100% 100% 100% 86% 92% 60% 93% 93% 88% 88% 85% 52% 63% 55% 42% 38% 38% 1% 1% 5% 12% 56% 57% 50% 49% 41% 30% 20% 24% 3% 49% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 70% 20% 100% 100% 53% 53% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 100% 32% 70% 71% 70% 100% 100% 35% 73% 44% 48% 59% 55% 59% 55% 45% 52% 50% 40% 35% 33% 2% 98 SecondFloor(CATA) 99 ThirdFloor(CATA) 100 FourthFloor(CATA) 101 FifthFloor(WestShellandCore+RAFEastCATA) 102 SixthFloor(ShellandCore+RAF) 103 SeventhFloor(ShellandCore+RAF) 104 EighthFloor(ShellandCore+RAF) 105 GroundFloor(ShellandCore+RAF) 106CompletionofFit-OutfollowingRemovalofHoist1 107 StairsandLobbies 108 CompletionActivities 109TargetEarlyAccessDates 110FirstFloor(EastShellandCore+RAFWestCAT 111SecondFloor(CATA) 112ThirdFloor(CATA) 113FourthFloor(CATA) 114FifthFloor(WestShellandCore+RAF/EastCAT 115SixthFloor(ShellandCore+RAF) 116SeventhFloor(ShellandCore+RAF) 117EighthFloor(ShellandCore+RAF) 118GroundFloor(ShellandCore+RAF) 119HandoverofTheHoney 120 TheBee-keepers(CarPark)(indicative 121InstructionRequiredtoCompleteOutstandingClientWorks 122GasDiversionComplete(byothers)(tbc) 123OutstandingClientWorks(includingpilingmat,breakoutfootpath) 124InstructionRequiredtoCompleteOutstandingClientWorks 125GasDiversionComplete(byothers)(tbc) 126OutstandingClientWorks(includingpilingmat,breakoutfootpath) 127PlanningApprovalGrantedforBuildingC 128VanElleOriginalPilingDate 129VanElleActualStartonSiteDuetoPlanning 130EAI017RainwaterHarvestingTankDesignInstructionIssued 131EAI024RainwaterHarvestingTankProcurementInstructionIssued 132EAI038RainwaterHarvestingTankInstallInstructionIssued 133Bearing/FoundationPiling 134BLOCKCCARPARK 135 Pre-CastSuperstructure 136 BlockCEnvelope 137 BlockCInternalFit-OutandBuildingServices 138HandoverofTheBeeKeepers 139OriginalStartonSite 140DefermentofBuildingBandBuildingCDateofPossession(2) 141 Section01BuildingB 142 TheHiveBuilding(BuildingB)(Grd,1st-10th,Roof) 143Bearing/FoundationPiling 144Sub-Structures 145Pre-CastGroundFloorSlab 146InstallPre-CastPlanks 147ScreedTopping(75mm) 148 Superstructure 149BlockBStrikeandClear 150Upstands+PlinthsonRoof 151 Pre-CastStairInstallationsB1-L9Roof 152LiftCoresCappedat11thFloorLevel 153FacadeMobilisation 154 BuildingEnvelopeWorks 155 RoofingWorks 156TerraceLevel10 157RoofLevel 158CoreSubstantiallyWeathertighttoCommenceFitOut 159BuildingProgressivelySubstantiallyWeathertight 160 LiftInstallationsBuildingB 161 BuildingServices 162 InternalFinishesNEW 163 FirstFloor(ShellandCore+RAF) 164 SecondFloor(ShellandCore+RAF) 165 ThirdFloor(ShellandCore+RAF) 166 FourthFloor(CATA) 167 FifthFloor(CATA) 168 SixthFloor(ShellandCore+RAF) 169 SeventhFloor(CATA) 170 EighthFloor(CATA) 171 NinthFloor(ShellandCore+RAF) 172 TenthFloor(ShellandCore+RAF) 173 GroundFloor(ShellandCore+RAF)(instructedtostopworksongroundfloor 174ClearOutandCleanFloor 175ReceptionArea(Shell) 176RetailArea 177CompletionofFIt-OutfollowingRemovalofHoist2 178 StairsandLobbies 179CompletionActivities 180TargetEarlyAccessDates 181FirstFloor(ShellandCore+RAF) 182SecondFloor(ShellandCore+RAF) 183ThirdFloor(ShellandCore+RAF) 184FourthFloor(CATA) 185FifthFloor(CATA) 186SixthFloor(ShellandCore+RAF) 187SeventhFloor(CATA) 188EighthFloor(CATA) 189NinthFloor(ShellandCore+RAF) 190TenthFloor(ShellandCore+RAF) 191GroundFloor(ShellandCore+RAF) 192HandoverofTheHive(BuildingB) 193 LandscapingandPublicRealm + + + + + + + + + + + + + + + + + + ++ + + + + ++ ++ + + ++ ++ + + + + + + + + + + + + + + + + + + + + + + 4w LineNameDurationStartFinish Plannedpercent complete@ 17.04.24 Percent complete -18-16-14-12-10-8-6-4-213579111315171921232527293133353739414345474951535557596163656769717375777981838587899193959799101103105107109111113 1630132711258225193173114281226923620620317115291226102472141821630132711258225194181152913271024822519216301428 MayJuneJulyAugustSeptemberNovDecJanFebMarAprMayJunJulAugSepOctNovDecJanFebMarAprMayJunJulAugSepOctN Oct 2023 2022 2024
26/09/22A
05/08/24
26/01/23A 24/05/23A 01/06/23A 06/07/23A 06/11/23A
09/01/24A
outline programme
FH090-151015 appendix d
PossessionNoticetoMCLH
Contractormobilisation
OriginalSection1CompletionDate(B)
OriginalSection2CompletionDate(AandC)
Constructionperiod-Section1-BuildingB
tenantsearlyaccessBuildingB
Constructionperiod-Section2-BuildingsAandC
tenantsearlyaccessBuildingA
Contigencyto27MonthsTargetPracticalCompletion Date
KeyPackages-StartonSite/Milestones
Piling-VanElle
GroundWorksandFrame-Mitchellsons
CarParkStructure-FPMcCann
Townhallsteelworkscommence
MEPHinstallations-Halsion
Internalfinishes
Toppingout-Allbuildings
Facade-ClarkeFacades
Poweron
Buildingssubstantiallyweathertight
Lifts-Otis
Commencecommissioning
ExtensionsofTime
EoT1-Deferment-Section1(BuildingB)
EoT1-Deferment-Section2(BuildingAandC)
EoT2-TownHallDesign(TVR)-Section1(Building B)
EoT2-TownHallDesign(TVR)-Section2(BuildingA andC)
EoT3-TownHallconstructionimpact-Expected Section1(BuildingB)
EoT3-TownHallconstructionimpact-Expected Section2(BuildingAandC)
15/06/2022
09/11/2024
15/07/2022
15/09/2022
15/07/2022
15/07/2022
15/07/2022
15/09/2022
07/06/2024
07/06/2024
23/08/2024
23/08/2024
12/09/2022
04/08/2024
15/05/2024
06/08/2024
12/09/2022
20/10/2024
29/07/2024
20/10/2024
20/09/2022
20/09/2022
07/10/2022
31/07/2023
18/08/2023
29/08/2023
18/09/2023
08/11/2023
21/11/2023
08/01/2024
23/01/2024
08/01/2024
25/06/2024
02/06/2024
02/06/2024
23/08/2024
18/06/2024
03/09/2024
01/07/2024
16/09/2024
24/07/2023 C:\Users\LukeNurser\Francis Hunter\Francis Hunter - Documents\Projects\03 current\10372 - Project Honey\17 Programme\Surrey House - Post Contract Strat Prog 001e 230724.pp Surrey House, Kingston upon Thames - PROJECT HONEY Outline programme Cube Real Estate/NUFM Line Name StartFinish 2023 2022 2024 JAODFAJ AugustSeptemberOctoberNovemberDecemberFebMarAprMayJunJulAugSepOctNovDec Jan 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 unconditional+permitteddelays Construction
15/08/2024 20/09/2022 07/10/2022 31/07/2023 18/08/2023 29/08/2023
08/01/2024 11/03/2024 08/01/2024 15/08/2024 20/10/2024 12/06/2024 02/09/2024 01/07/2024 16/09/2024 04/08/2024 20/10/2024 1 1 22 33 44 55 66 7 7 8 8 9 9 10 10 1111 12 12 1313 1414 1515 1616 1717 1818 19 19 2020 2121 2222 2323 2424 25 25 2626 2727 2828 2929 3030 3131 20/10/2024 9 Weeks 3 weeks 04/08/2024 27 MONTHS + 8 weeks A B & C Section 1 PC Section 2 PC A B C B A C 22 33 44 7 7 8 8 9 9 12 12 1313 1414 1515 1717 1818 19 19 2020 2424 25 25 2626 2828 2929 3030 3131 Line Name StartFinish JAODFAJ AugustSeptemberOctoberNovemberDecemberFebMarAprMayJunJulAugSepOctNovDec Jan 2023 2022 2024
20/10/2024 09/11/2024
18/09/2023 08/12/2023 21/11/2023
G&T progress report
FH090-151015 appendix
e
Project Honey
Gardiner & Theobald Progress Report at 25 April 2024
General Update
Building facades and fit out are progressing.
Activities & Progress in Period
Contractor
Valuation and recommendation no 27 of MCLH works for March 2024.
Ongoing review of general & tenant variations.
Interface with tenant team
Ongoing dialogue with MACE cost team in relation tenant changes
Interface with funder team
None in the period
Cost Status
Gardiner & Theobald Cost Report 22 issued 26 March 2024 and Report 23 to be issued 26 April 2024
Procurement
Deck car park MCLH final procurement to allow final agreement.
Design Development
None in the period
Project Honey
Gardiner & Theobald Progress Report at 25 April 2024
Future Works
Continuing valuation of the works. Valuation 27 due date 6 May 2024.
Agreement of remaining provisional sums.
Agreement of further tenant changes.
Agreement of costs with MACE against AFL position.
Information Required
MCLH final costs for deck car park.
MCLH response to outstanding TVO’S
Team
No changes
FH090-151015 appendix f
Clarke’s manufacturing update
Project Honey - Block B Straight Panels (including linkbridge)
Block B Straight Panels
22/01/202429/01/202405/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
10/06/202417/06/202424/06/202401/07/2024
22/01/202429/01/202405/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
10/06/202417/06/202424/06/202401/07/2024
202308/01/202415/01/202422/01/202429/01/2024
18/03/202425/03/202401/04/202408/04/202415/04/202422/04/2024
29/04/202406/05/202413/05/202420/05/202427/05/202403/06/2024
17/06/202424/06/202401/07/202408/07/202415/07/2024
22/07/202429/07/202405/08/202412/08/202419/08/2024
05/02/202412/02/202419/02/202426/02/202404/03/202411/03/2024 26/08/2024 10/06/2024
15/01/202422/01/202429/01/202405/02/202412/02/202419/02/2024
26/02/202404/03/202411/03/202418/03/202425/03/202401/04/2024
08/04/202415/04/202422/04/202429/04/202406/05/202413/05/2024
20/05/202427/05/202403/06/202410/06/202417/06/202424/06/2024
01/07/202408/07/202415/07/202422/07/202429/07/202405/08/2024
12/08/202419/08/202426/08/202402/09/2024
Total Check Panels Fabrication (Planned) 332 0 71 17 15 12 12 14 14 17 18 18 18 18 18 18 18 18 16 Panels Fabrication (Actual) 332 -101 71 17 15 16 22 21 23 22 17 5 1 0 1 0 Cumulative Fabricated (Planned) 71 88 103 115 127 141 155 172 190 208 226 244 262 280 298 316 332 332 332 332 332 332 332 332 Cumulative Fabricated (Actual) 71 88 103 119 141 162 185 207 224 229 230 230 231 231 Installed On-site (Planned) 332 0 50 20 15 16 8 15 19 12 17 13 17 13 21 9 15 24 16 10 10 10 2 Installed On-site (Actual) 332 -150 86 27 13 10 0 27 1 0 7 0 11 Cumulative Installed (Planned) 50 50 70 85 101 109 124 143 155 172 185 202 215 236 245 260 284 300 300 310 320 330 332 332 Cumulative Installed (Actual) 86 113 126 136 136 163 164 164 171 171 182 21 38 33 30 26 32 31 29 35 36 41 42 47 44 53 56 48 32 32 22 12 2 0 0 Total Check Panels Fabrication (Planned) 82 0 19 2 3 4 4 5 5 5 5 4 4 5 5 5 5 2 Panels Fabrication (Actual) 82 -35 19 2 3 3 4 5 3 4 2 0 1 1 0 0 Cumulative Fabricated (Planned) 19 21 24 28 32 37 42 47 52 56 60 65 70 75 80 82 82 82 82 82 82 82 82 82 Cumulative Fabricated (Actual) 19 21 24 27 31 36 39 43 45 45 46 47 47 47 Installed On-site (Planned) 82 0 14 4 5 4 4 5 5 4 5 4 5 5 7 2 5 1 3 Installed On-site (Actual) 82 -40 25 2 2 6 2 2 2 0 0 0 1 Cumulative Installed (Planned) 14 14 18 23 27 31 36 41 45 50 54 59 64 71 73 78 79 82 82 82 82 82 82 82 Cumulative Installed (Actual) 25 27 29 35 37 39 41 41 41 41 42 5 7 6 5 5 6 6 6 7 6 6 6 6 4 7 4 3 0 0 0 0 0 0 0 Total Check Panels Fabricated (Planned) 436 0 16 6 5 6 5 6 10 11 19 21 22 22 22 22 22 22 21 24 41 36 45 32 Panels Fabrication (Actual) 436 -188 16 0 0 6 5 6 17 13 19 27 24 24 18 14 15 29 15 Cumulative Fabricated (Planned) 16 16 16 22 27 33 38 44 54 65 84 105 127 149 171 193 215 237 258 282 323 359 404 436 436 436 436 436 436 436 436 436 436 436 436 436 Cumulative Fabricated (Actual) 16 16 16 22 27 33 50 63 82 109 133 157 175 189 204 233 248 Installed On-site (Planned) 436 0 16 19 15 26 27 20 22 18 16 17 5 18 19 18 20 22 22 20 21 23 17 9 9 9 8 Installed On-site (Actual) 436 -283 16 0 0 0 0 0 0 2 0 11 10 15 9 23 20 31 16 Cumulative Installed (Planned) 16 16 16 16 16 16 16 16 16 16 16 35 50 76 103 123 145 163 179 196 201 219 238 256 276 298 320 340 361 384 401 410 419 428 436 436 Cumulative Installed (Actual) 16 16 16 16 16 16 16 18 18 29 39 54 63 86 106 137 153 0 0 0 6 11 17 22 28 38 49 68 70 77 73 68 70 70 74 79 86 122 140 166 180 160 138 116 96 75 52 35 26 17 8 0 0 Total Check Panels Fabricated (Planned) 69 0 0 2 3 5 5 5 5 4 4 5 5 5 5 4 5 4 3 Panels Fabrication (Actual) 69 -39 0 4 1 1 1 2 3 5 3 5 5 Cumulative Fabricated (Planned) 0 0 0 0 0 0 2 5 10 15 20 25 29 33 38 43 48 53 57 62 66 69 69 69 69 69 69 69 69 69 69 69 69 69 69 69 Cumulative Fabricated (Actual) 0 4 5 6 7 9 12 17 20 25 30 Installed On-site (Planned) 69 0 0 4 2 12 5 3 6 4 3 0 6 0 6 4 2 2 4 3 1 2 Installed On-site (Actual) 69 -56 7 2 2 0 2 Cumulative Installed (Planned) 0 0 0 0 0 0 0 0 0 0 0 0 4 6 18 23 26 32 36 39 39 45 45 51 55 57 59 63 66 67 69 69 69 69 69 69 Cumulative Installed (Actual) 7 9 11 11 13 0 0 0 0 0 0 2 5 10 15 20 25 25 27 20 20 22 21 21 23 27 24 24 18 14 12 10 6 3 2 0 0 0 0 0 0 Stock available at Week End
Stock available at Week End Block A Curved Panels Project Honey - Block A Curved Panels
02/09/2024 Stock available at Week End
202308/01/2024
Block B Curved Panels Project Honey - Block B Curved Panels
Stock available at Week End Block A Straight Panels Project Honey - Block A Straight Panels (including linkbridge)
