Skip to main content

FPA_Material Reuse Guide

Page 1


For more information, please contact Fletcher Priest: sustainability@fletcherpriest.com

Joanna Wilson

Sustainability Lead MA(Hons) MPhil ARB

Lorraine Chan

Project Leader and Material Reuse Champion

BArch MArch AACA

Foreword

It has been encouraging and exciting to hear the conversations around circularity gaining momentum in the last few years. Despite the growing ambition, however, we find there is often a lack of knowledge about how to break down material reuse into understandable, manageable and actionable steps.

We wrote this Guide to share our experience and provide a replicable process for those who want to reuse materials, but don’t know where to start. We hope that by setting out a straightforward framework that can be adapted to individual projects or different materials, we can demystify material reuse and integrate it into project planning and design.

Collaboration and communication are key. We recognise that this guide is only one part of a wider movement to develop our industry’s capacity to reuse materials. Building on the knowledge others have shared, and working with our collaborators has been essential to developing this guide. We hope that by sharing what we have learnt, we can help streamline this process for others, enabling all of us to more efficiently develop and implement reuse strategies.

Each project and each material will have its own challenges and opportunities, and we know there are people who will be able to add more than we could at the time. We encourage others to adapt, develop, explore and share new opportunities as the industry evolves. In time, we hope that valuing existing materials will become the new normal, and we will create better buildings for everyone as a result.

How to read this guide

Purpose

This guide aims to help those in the building industry to identify, develop and implement strategies for material reuse.

Components: the Guide vs the Catalogue

The Material Reuse Guide

The Guide first summarises the key background theory that explains why we reuse materials and what the priorities are.

It then sets out a step by step process by which to structure the material reuse process for your project. This is useful to read and explain to the project team at the start of a project. Refer back to throughout the design process and when preparing for the next stage of work .

The Material Reuse Catalogue

The Catalogue is a supplementary document to help you work through the reuse analysis process for specific materials.

It is a starting point to build on, rather than a completed report. Materials in the catalogue should be updated and added to as knowledge and experience is gathered through projects.

Guide Contents

Theory

Waste and recovery

Circularity principles

Reuse options

Reuse processes

Timeline Setting up for success

Analyse

Refine + Build

Material catalogue

1. Skin

2. Structure 3. Service 4. Space plan 5. Stuff 6. Site

Theory

Waste and recovery

Circularity principles

Reuse options

Waste and Recovery

A material problem

The Construction Industry's Waste Problem

The UK construction industry creates almost 140 million tonnes of waste and half comes from building demolition and construction*. As an industry we can significantly reduce this by focusing our efforts on reusing and recovering this waste.

PROBLEM

Source:

of the UK’s total annual waste is from material waste from the construction industry ***

Why Reuse?

Material Reuse minimises the ecological, social, and climate impacts of the extraction and disposal of construction materials. Instead of mining the earth for new materials, we need to find ways to repurposing existing ones.

TARGET

Reduce the production of new materials by repurposing the existing materials

Material assessment methods to investigate potential future uses. Material information is recorded to enable future reuse.

Buildings can be a material source, rather than continuing the damaging extraction of new materials.

Utilising the value of the existing The result is 'Urban Mining' or BAMB (buildings as material banks). This means circulating materials we already have in our built environment, not extracting new. Urban Mining, however, requires a deeper understanding of these material resources, and a deeper collaboration across consultants, contractors, and suppliers.

Need to reinvent disposal methods to reduce the amount of construction waste goes to landfill

Circularity principles

A hierarchy of options

'Building as Material Banks, BAMB, assumes that a material's time 'locked up' in a building, is just one period of time in it's life-cycle'.

When these materials are no longer needed in the building, they are freed and could be ready for reuse.

Historically, cities were built in this way, however recently, cheap energy and production has meant that we became used to a linear 'take, make, waste' system.

The circular economy is based on three principles, driven by design:

• Eliminate waste and pollution

• Circulate products and materials (at their highest value)

• Regenerate nature

(Ellen MacArthur Foundation)

materials

Upcycled / downcycled materials

Biogenic materials

Materials can be seen as always being in a constant state of flux, their time “locked up” in buildings is just one chapter in their lifecycle.

The bigger the loop the more energy and value lost

Re-Introduction to natural cycles where possible

COMPOST (BIO-BASED MATERIAL)

Primary Source

RECYCLE

Turn into new materials

REMANUFACTURE

Turn materials into new products

Re-use products

REUSE

A Constructed Lifetime

Circular economy aims to keep materials in use, prioritising the minimum reprocessing possible.

Reuse options

Keep the loop small

1. In-situ

Prioritise retaining materials in-situ. This minimises cost and carbon associated with deconstruction and reconstruction. Often materials can be refurbished, reconditioned, or upgraded to meet new performance or aesthetic requirements.

2. On-Site

Retaining materials on-site enhances their value by utilising their narrative, reducing travel distances, and minimising processing. This approach, known as a closed-loop, emphasizes minimal processing and travel. The project should aim to reuse materials directly at the construction site by adapting to existing materials and structures in the development.

3. Client Ownership

If on-site reuse is not feasible, keeping the materials within the same ownership (for example, reuse in another project owned by the same developer) increases the level of control over programme, cost and risk associated procuring reused materials, while directly reducing the embodied carbon of client’s other projects.

4. Recycling (3rd Party)

When materials cannot be reused within the same site or ownership - sale or donation to a third party should be considered. Markets and marketplaces for reused materials are growing rapidly as projects look to decarbonise, however demand, travel distances and processing requirements vary considerably.

PRIMARYAIM

1. In-situ
2. On-Site

Donor projects are vital to developing economies of scale in reuse markets, giving designers a wider and more reliable choice of reused materials to design with.

3. Client Ownership
4. Recycling (3rd Party)
5. Landfill

Reuse processes

Timeline Prepare

Step 1. Setting up for success

Analyse

Overview

Step 2. Investigate

Step 3. Possibilities and Priorities

Step 4. Who can do it?

Bring it together: record findings

Bring it together: decide strategies

Refine + Build

Step 5. Getting things done

Step 6. Logistics

Step 7. Long term value

What to do, when

An iterative design process

The material reuse process is not linear. Investigation of the site and exploration of material opportunities informs initial strategies which may in-turn inform further material and site investigations.

This process is repeated using a degree of trial and error until a convincing reuse strategy is developed.

Plan, and start early!

In order to do this, it is important to set ambitions from the beginning, and start early. This timeline sets out how this process should progress alongside RIBA stages.

PREPARE

ANALYSE

REFINE + BUILD

1. Setting up for success

2. Investigate

3. Material possibilities

4. Who can do it?

Knowledge not implemented

Consider project requirements

Each project will have different existing conditions, design scope, and programme. Some material reuse processes will need to be started earlier and require more in-depth analysis than others. For example structural and facade reuse will likely need coordination earlier than interior finishes. Adapt this timeline according to the project and systems that are within the project scope.

5. Getting stuff done 6. Logistics 7. Long-term value

Prepare Step 1: Setting up for Success

Successful material reuse needs to be considered from the outset of a project. It requires early inclusion of design team and early engagement and collaboration with supply chains.

Form the project narrative

Identify the ways that circular economy and material reuse could bring value to the project. Integrate into the project brief to ensure it remains a core component.

Assemble a talented team

Appoint a team with the knowledge, experience and ambition to align with the project narrative and clearly communicate the project brief.

Define reuse ambition

Identify specific goals and opportunities with the team and in the project brief. Review specific material strategies and design options against these.

Build the programme (+ costs)

Incorporate testing, recovery and processing time. Early demolition contractor input will be crucial.

Set measurable targets

It is important to develop a shared and specific set of metrics for the project, keeping these measurable targets front and centre of all design decisions throughout all material reuse steps. Ensure the entire design team understand the project ambition and the review and reporting requirements that go alongside these.

Collaborative problem solving

The right team with the right attitude and the right experience at the right time will include design consultants, project management, client and construction / logistics / deconstruction advice.

This does not necessarily make projects longer or more complicated. A well thought-through project set-up and programme are key to an effective reuse strategy.

donor projects

architects

building owners

local authority

WiderCircularEconomy

Projectstakeholders

existing tenants

project team

engineers

other consultants

suppliers

future tenants

deconstruction

contractor

contractors

recycling depots

recipient project

Analyse Overview

The analysis process is inherently circular, each new piece of information will inform the next step and revisit the one before.

Step 1: is where the project team and ambition is set up where the opportunities have to be analysed to develop reuse strategies.

There are 3 key steps in the analysis process:

Step 2: Investigate

Step 3: Possibilities & Priorities

Step 4: Who can do it?

These steps will inform one another, findings should be recorded and brought together into a set of initial strategies.

The Material Reuse Catalogue aims to guide the design team through each of these steps in detail on a material by material basis.

PREPARE

ANALYSE

2. Investigate

Output: Audit

3. Material possibilities

Output: Sketching and banding

4. Who can do it?

Output: Supplier Matrix

Bring it together

Output: Record of investigations

Output: Comparison Table

REFINE + BUILD

Analyse Step 2: Investigate

Audit the Building

Understanding the materials in a building is essential preparation for them to be reused.

Set the Criteria

Aligning the information criteria with the agreed project targets before inspection allows for a focused approach. Some values include: condition, quantity, homogeneity, historical significance, economic value, ease of dismantling, logistics and possible re-homing of reclaimed materials.

Visual inspections first

Visual inspections may be sufficient for some materials and can be started early, others may need intrusive investigations or disassembly. Often this is not possible in occupied buildings, so time should be allowed in the programme to pick up later if necessary.

Collaborate

Live databases, such a airtable, are useful to pool and share information and ideas in an organised and digestible way. The more information that can be gathered, the better decisions can be made and the more time saved.

Start Early!

By planning in advance, material reuse surveys can be programmed to coincide with other inspections of the building.

create accurate recovery scope

INVESTIGATION TIPS

Steps to investigation

1. Site visit photography, notes and survey

2. Material properties e.g. glass, brick etc catalogue all findings to be shared across the team

3. Research e.g. Filtering out items worth saving based on initial assessment

4. Identify materials that may need more in-depth assessment

Use the checklist below for the initial audit:

Focus on 'good quality' material

Record potential reusability & location

Think about the potential work involved in reharvesting

Note areas that may require specialists opinions

Reusable quantity

Material and condition Suggestion on reuse

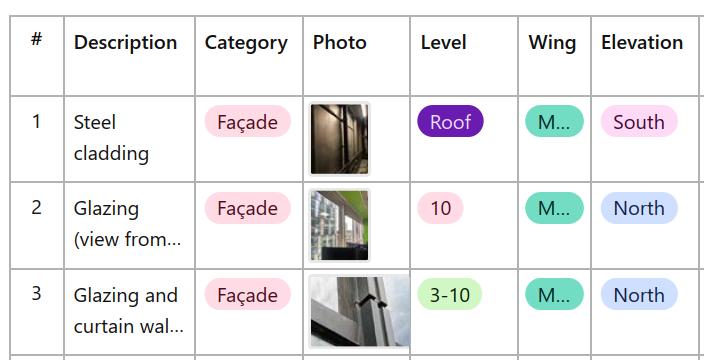

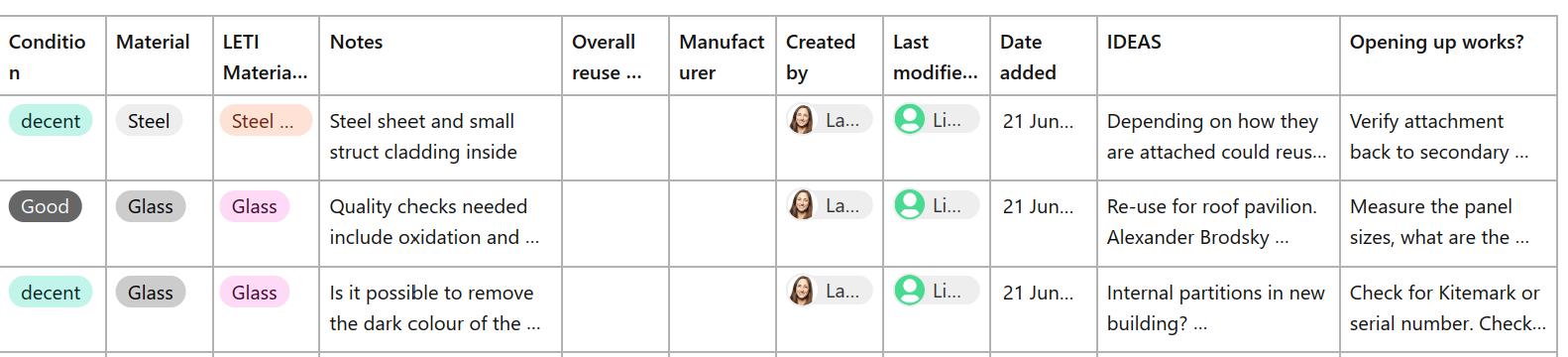

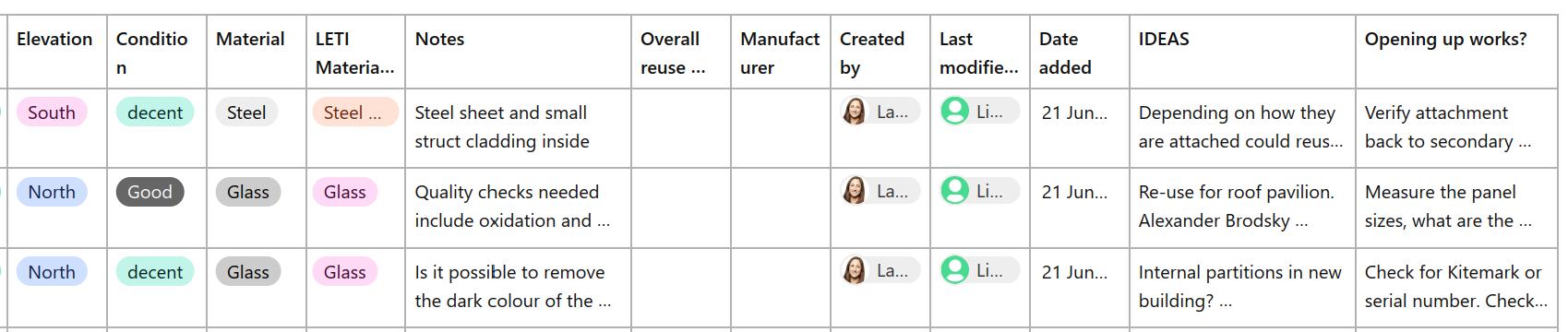

Example of findings recorded in Airtable

Helps to determine a banding strategy

Each condition should reflect an additional question. For example, can it be modified? Is it easy to remove? Does it have many reuse oppportunities? The answer will help determine its overall band.

Analyse Step 3: Possibilities & Priorities

Identify key opportunities for material re-use

Undertaking a detailed material audit can uncover a matrix of varying materials with a spectrum of qualities and quantities. The number of materials in a project can be overwhelming if not sorted. To distil the findings, it is helpful to focus the attention on the top 10 materials based on project criteria, e.g. embodied carbon.

Use existing materials to drive design opportunities

The process is iterative. Once the priority materials have been indentified, the proposed design should aim to absorb as many of those materials as possible. For the materials that are unable to be reused on site, other reuse options offsite should be explored.

Highlighting materials that are in high in carbon is also an opportunity to consider the whole life impact of any new materials.

The materials on the adjacent page are an example of identifying direct reuse opportunities at an early stage in the design development.

PRECAST CONCRETE

Materials identified from the Auditing Possible New Products

GLASS

Precast concrete facade panels

External paving

External cladding

BRICK RED GRANITE

Masonry Partitions

Project Example: The 10 materials containing the most embodied carbon are identified from the site audit alongside their potential design opportunities from reuse.

Analyse

Step 3: Possibilities & Priorities

Refine a logic for material sorting

To categorise and prioritise materials for reuse, assessment criteria must be set. Banding is one of the methods that can used to used to organise material according to the criteria identified.

The purpose of banding Specification banding is an analytical process to study the existing building condition and potential possibilities for all materials.

The diagram illustrates the decision making of each material by asking gateway questions.

The banding process therefore helps to identify the most suitable reuse strategy for each material type and quality.

The quality metric example below illustrates possible descriptions and conditions for each band, showing a correlation with the level of intervention required for the materials. A higher number within the band indicates a greater degree of intervention necessary to reuse the materials.

Reuse Suitability: Quality Metric

• “As New”

• Visible Finish Item

• Satisfies performance criteria to use as is i.e. warranties, structural integrity etc.

• Standard Sizes?

• High visibility

• Visible wear / tear like hairline cracks and holes

• Partially satisfies performance

• Refurbishable

• Visual based on Aesthetic Standards of context

• Standard Sizes?

• Low visibility

• Damage / degradation

• Doesn’t satisfy performance criteria

• Refurbishment not practical

• Standard composition

• Can be recycled and reused

• Almost “As New”

• Satisfies performance criteria

• Applicable to Aesthetic Standards

• Standard Sizes?

• Applicable to Front of House

• Visible wear / tear and some damage

• Partially satisfies performance

• Refurbishable

• Non-standard Sizes

• Low visibility

• Within Build-up (not visible)

• Damage / degradation

• Fails performance criteria

• Non-Standard composition/ harder to break down/ Possible contaminants

• Recycling and reuse or safe disposal

GATEWAY QUESTION 1

Tile e.g. To be used as is YES NO

Can the materials be used AS IS? Can it be MODIFIED to be reused?

GATEWAY QUESTION 2

Set project specific quality metrics

By defining a quality metric early on, the most appropriate reuse action can be determined, based on different environmental, practical and aesthetic requirements specific to the project.

For example, in a building with an industrial aesthetic, exposed steel beams and aged timber may be an appropriate aesthetic. But for a high end shopping mall, these items may need to be painted, polished or treated before they are deemed suitable.

Project specific criteria will vary, but could include:

- Embodied Carbon

- Fire

- Aesthetic standard

- Thermal Performance

- Warranty

- Structural

- Cost

- Programme

Additional examples of quality metrics for different materials are provided in the Material Reuse Catalogue.

ESTIMATED %

ESTIMATED %

e.g. Trimmed to acceptable size

Can it be PROCESSED to be reused?

GATEWAY QUESTION 3

ESTIMATED %

Band 1-a & b
e.g. Crushed into terrazzo
Band 2-a & b
Band 3-a & b

Analyse

Step 4: Who can do it?

Once the interventions are defined, it is important to find out who can execute them. Various materials may involve multiple steps in the supply chain, including processors, manufacturers, and fabricators.

Decisions can be based on:

– Supplier experience, stability and location

– Testing time and cost

– Quantity of material required

– Process requirements

Understanding and engaging with the material reuse supply chain is a time-consuming process. Experience of past material reuse projects can streamline this and provide a springboard for new ideas.

Following the material reuse process, this page provides a brief starting point of some relevant contacts to help initiate ideas, but there are many more out there. One supplier might also work with multiple products/materials so it’s best to speak to them to check even if it's not listed.

Surveyors with digital tools

Circotrade: Trading platform for building materials. Services include material inventory/ material passport and marketplace.

Multivista: Surveyors using point cloud to convert point scans into usable Revit models.

Logistics

Site audit and analysis. Time to gather all you can find out about the building, listing all the materials, quantity, quality and begin visual assessments to identify areas in need for specialist input.

Extract materials from the audit list that are suitable for trading/ resell, usually materials in Band 1, and contact the 3rd party materials markets to identify options.

Think local to reduce carbon emissions!

Local 3rd Party Material Market

Globechain: Reuse Marketplace.

Excess Materials Exchange: Digital platform for material exchange, resource material is part of the service.

Madaster: Helps to create material passport.

The Reclaim and Salvage: Reselling or bricks, flooring, roofing , antique building elements e.g. fire places etc.

Environmate: Closed loop material market buys and resells building materials, plumbing, carpentry etc.

Best Reclaimation: Reclaimation yard located in Heathfield, East Sussex.

General Demolition: expert demolition and enabling works services across.

Collect and Recycle: paper and cardboard recycling collection companies, supplying waste packaging material back into manufacturing.

Sea Cadets: Donation platform for second hand items.

Reuse Network: Donation platform for second hand items.

Collecteco: Based in the UK, donation platform for furniture, equipment and fitout materials.

Armstrong ceiling: Donation platform for used ceiling tiles.

Sorting

Identify possibilities and priorities

Talk to specialists to understand how materials can be harvested and connect with the supply chain to understand how to realise the possibilities

Think across sectors to help with small batches of testing and reuse

Deconstruction Contractors Smaller manufacturers

JF HUNT: Specialist Contractors in Construction, Demolition & Regeneration.

General Demolition: expert demolition and enabling works services across.

Lawmens: Demolition/waste/site logics and labour provided. Also provide sustainability service including waste report, pre-demolition audit,Circular economy statement.

Szremley: Restoration and new-build specialist.

May glass: Glass recycling specialist.

Recolight: Reuses and specialises in safely disposing luminaries.

Contact Local supply chains

EMR: Metal recycling for salvage and recovery, construction, demolition and decommissioning.

SSAB: Provides recycled steel.

Cappagh: Recycles construction and demolition waste and making it into concrete aggregate.

Techcrete: Supply of precast concrete facades constructed offsite. Possibility of collaborating to make new panels with site materials.

Clayworks: Mixes demo waste into their clay render product.

Saint Goban: One of UK largest glass recycling and manufacturer

CollectandRecycle: paper and cardboard recycling collection companies, supplying waste packaging material back into manufacturing.

Kbriq: Creates new bricks from recycled brick rubble.

La Pietra Compattata: Produces new stone tiles from crushed stone from site.

Clayworks: Mixes demo waste into their clay render product.

RMF: Recycling and reusing raised access floor.

Tarkett: Flooring take-back scheme, collects carpet, linoleum, vinyl etc. and makes 100% recycled flooring.

Who can do it

Analyse

Bring it together: record findings

Recording what you find

Use an excel table to help track the material reuse possibilities.

The excel should include minimum information as below:

A. Building layer

B. Quantity

C. Potential embodied carbon saving

D. Sizes and other relevant description

E. Reuse possibility/suggestion

F. Reuse recommendation

A. Building layer

B. Quantity

Future use

The information that is recorded can be useful further into the project to create material passports for existing elements during technical design (see Step 7).

C. Potential embodied carbon saving

E. Reuse possibility /suggestion

D. Sizes and other relevant description

Szerelemy

Analyse

Bring it together: decide strategies

Bring the analysis together

After analysing results from the material investigation, prioritising key materials, and identifying possibly reuse strategies based on project criteria, it is time to draw together all of this analysis to identify the strategies to take forward into the next phase of design.

Make decisions collaboratively Ensuring this process is a collaborative effort with the input from the whole design team helps to ensure the strategies chosen are robust and will be carried through.

Reuse recommendation can sometimes only be determined after demolition. You can still list items that are predicted to be reuseable.

Key

Possible impact level

Easy/net benefit

Slight disadvantage /challenge

Significant disadvantage /challenge

ITEM

Concrete + Hollow Pot

Services + Plant

1 (a) Steel (b) Steel elements

2 Pre-cast Cladding

3 Glass

4 Aluminium

5 Bricks

6 (a) Red Granite “as is” (b) Red Granite “down-cycled”

7 Exterior Paving

8 Sanitary-ware

9 Soft Strip

Example of material comparison table

FEASIBILITY OF RECOVERY

Just because it’s technicality possible doesn’t mean it should be done. Once application scope and possibilities have been discussed - project specific and practical criteria should be set.

Project specific criteria can be added to assess the value of the ‘reuse‘ after application scope has been identified. The table is only an example, criteria like warranties, fire rating or design intent can also need added.

Origin Recipient Evaluation

Project Other Client projects 3rd party

Blockwork?

Piling mat? Recycle plants

Additional projects specific criteria for assessment

Refine + Build

Step 5 : Getting things done

Produce clear documentation

Drawings and sketches can help to clearly communicate to designers and contractors on site what materials are being collected, where they are in the building, and how they should be extracted.

Material inventories

Building on the site investigation and reuse analysis, an inventory of materials and their associated reuse requirements can be created.

This is a accompanied by structural sketches indicating locations of the structural elements with any IDs referenced in the inventory.

The inventory is used to:

– measure material quantities and establish the type of elements available for reuse

– help select reclamation markets to target (based on aggregated inventory data)

– feed into the BIM model of the existing building and material passports for individual elements

– guide demo contractor

The drawings on the right page indicate how recovery scope can be incorporated into deconstruction tender documents.

Programme

This whole process will take time, but does not have to delay the project if properly planned. Delays can be avoided if the process is started early and the benefits to the project are widely understood.

COMMUNICATION IS KEY

Directly discussing these documents during the tender process and with site teams ensures reuse intentions and implications are clear.

Steel elements

Pre-cast panels

Exterior paving

Glass
Aluminium
Red Granite Key
Sanitary items
Soft Strip
Bricks

Refine + Build

Step 6: Logistics

Site logistics

The close collaboration of the disassembly and design teams ensures site logistics and testing requirements associated with reused materials are accommodated into the programme.

Minimising waste

The handling of materials on site is crucial to minimising wastage and maximising recovery. How materials are safely deconstructed and stored needs to be carefully considered.

Coordination champion(s)

Champions are incredibly valuable when trying to coordinate the material reuse process, but you may need different individuals at different times depending on the project and programme. During design and deconstruction, access to parts of the building, testing, transportation, processing, manufacturing, and delivery, will need to be organised - a champion within the project team can help this run smoothly.

It is also highly valuable to have a champion on site during construction who can oversee the deconstruction and coordinate any material collections.

Continuing reuse

The design team should ensure that recovered and new materials are designed and handled to enable reuse. Designing according to the principle of ‘shearing layers’ where building systems of lifespans can be repaired or replaced independently, is key. Considering and recording assembly and disassembly information will enable this future deconstruction.

Re-implementation

LOOP 1

Minimise Wider Transport Logistics

Demolition+ Extraction

Deconstruction

Temporary In-situ Store

Long-term Storage / Third Party Recycle materials from other material stores

Other Sites recycle faclilties and wider material store

LOOP 2 Wider Transport Logistics

The logistical challenges of material reuse will be different depending on whether materials are kept within a site or project, or handed to a 3rd party.

Refine + Build

Step 7: Long term value

Build for future reuse

With all the analysis that it takes to reuse existing materials, it is important how those materials can also be reused in future. The information that is gathered as part of the investigation and analysis process can be extremely helpful in speeding up this process if it is stored in an accessible and legible manner for future stakeholders to understand.

The role of material passport Materials passports is a method to consolidate the history, specification and evaluation of the salvaged materials. With the use of modern day algorithms and BIM software, clients will now have a detailed schedule of materials across their portfolio.

Materials from different projects can be shared and connected through a database, making material exchange more user friendly and quantifiable.

Add value to building components

Information from the material passport can be accessible via QR code. The table creates a detailed inventory, providing information for maintenance, repair, replacement and reuse opportunities, onsite or offsite.

This information helps organise and connect reuse opportunities across the industry - facilitating a futures market and increasing material and asset value.

DIGITAL TWIN AND BIM

A Digital Twin is a virtual model that accurately reflects a physical object, system, or process. With increasing use of BIM, the process of developing and maintaining a digital twin becomes more efficient and accessible

MATERIAL PASSPORT

For more information on material passports please refer to Watermans Material Passports Framework.

Understanding EPDs

What is an EPD?

Environmental Product Declarations describe the environmental impact of a product throughout its life cycle and are based on findings from a Life Cycle Assessment (LCA) study. To help compare the sustainability of products, EPDs simplify complex manufacturing and production processes from LCAs into shorter table of numbers.

Base on European standard (EN 15804+A2), the EPD has been an established and verified information measurement since 1998. It is fast becoming a global standard as it focuses on quality and consistency of measurement verified by a third-party assessor.

EPDs should comply with ISO 14025, but they can also be self-declared. Before relying on self declared EPDs consider if there is a good reason why the product may not be certified.

Life cycle stages

EPDs can be understood in stages and lists the GWP value (Global Warming Potential) for each stage.

Cradle-to-gate (A1-A3): Covers extraction of raw materials to manufacturing.

Gate-to-completion (A4-A5): Covers transport and construction.

Cradle-to-grave (B1-B5): Covers the entire lifecycle, from extraction to disposal.

Cradle-to-cradle (C1-C4): Includes recycling at the end of life, listing the CO2 emissions from product disposal.

Beyond life (D):

Lists potential benefits from possible reuse, recovering or recycling.

EPDs tell you more than carbon... But Carbon isn’t a bad place to start if you’re new to understanding the information. When evaluating material reuse choices and implications, always consider whether your choice has wider ecological and environmental impacts such as water use and habitat loss.

Look out for:

– The validity period

– Which lifecycle stages (right) are included in the assessment

– A table of impacts (GWP or Global warming potential will tell you the embodied carbon)

Numbers

These are usually written exponentially to allow big and small numbers to appear alongside each other. If you don’t know how to translate them, get some help from the internet!

If in doubt, as a colleague, supplier, or sustainability consultant to explain.

The catalogue will focus on this stage, showing the environmental impact of manufacturing this product.

Benefits and load beyond the system boundary

Potential To: Reuse / Recovery / Recycling BEYOND LIFE CYCLE

Approximate distribution of A1 - C4 emissions. Adapted from LETI, ultra-low energy residential model.

Useful sources of more information

Below is a selection of organisations, reports and books to go to for more information on different topics. These titles have also informed the development of reuse theory and process described in this guide. There are many more useful documents not listed here, but this is a good starting point.

General Circular Economy Content

Ellen MacArthur Foundation

Material Reuse References

Institution of Structural Engineers, Circular Economy and Reuse: guidance for designers (very useful for structural materials)

Key Circular Economy Summaries

LETI, Circular Economy Primer

ACAN, Circular Economy Design Guide Summary

Urban Mining and Buildings as Material Banks

ReLondon

BAMB

More Information on Circular Economy

UKGBC, System enablers for a circular economy

ACAN, Circular Economy Design Guide UKGBC, Circular Economy Metrics for Buildings

Reuse Case Studies and Inspiration

Duncan Baker-Brown, The Reuse Atlas Lendager Group

For more information on Material Passports

Watermans, Material Passports Framework Lancaster Uni and Orms, Material Passports Policy Paper

How to read EPDs

Institution of Structural Engineers, How to read an EPD: basics for the structural engineer

For more information, please contact Fletcher Priest: sustainability@fletcherpriest.com

Joanna Wilson Sustainability Lead MA(Hons) MPhil ARB

Lorraine Chan Project Leader and Material Reuse Champion BArch MArch AACA

Book Production Team

Joanna Wilson

Lorraine Chan

FPA Team

Ayshah Begum

Benjamin Koslowski

Caterina Izzo

Chris Radley

Gabriella Badeira

Jaxon Kelly

Myungin Lee

Rotem Lewinsohn

Shafia Motaleb

Stephanie Kukulka

Yue Jiang

Zi Kang Lim

Every effort has been made to trace the authors of copyright. We would be happy to rectify any errors or omissions in further editions. Unless otherwise stated, all images are copyright of Fletcher Priest Architects.

© 2025 Fletcher Priest Architects LLP

All rights reserved. No part of this publication may be reproduced or transmitted in any form or by any means, electronic or mechanical, including photocopy, recording or any other information storage or retrieval system, without prior permission of both the copyright owner and Fletcher Priest Architects.

Fletcher Priest Architects is a limited liability partnership.

Turn static files into dynamic content formats.

Create a flipbook
FPA_Material Reuse Guide by Fletcher Priest Architects - Issuu
