GDOT Transportation Project Update - COSF D1 Townhall - November 2022

Page 1

CITY OF
HALL November 17, 2022 Paul DeNard, PE District Engineer, Metro Atlanta Rubin McCullors Area Manager, South Fulton, Clayton, Douglas
SOUTH FULTON D1 TOWN

District 7 – Metro Atlanta

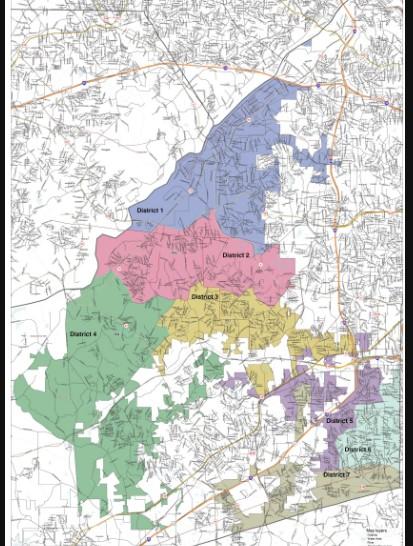

State Transportation Board Members Representing South Fulton County

City of South Fulton

Recently Completed Projects

SR 6, SR 14, SR 14 Conn & SR 70 @ 4 Locations - Cable Barrier • $2.4 M • Completed Spring 2022 SR 154/Cambellton Rd at Boat Rock and New Hope Rd Roundabout • $6 M • Completed Summer 2022

City of South Fulton

Projects in Preconstruction Phase

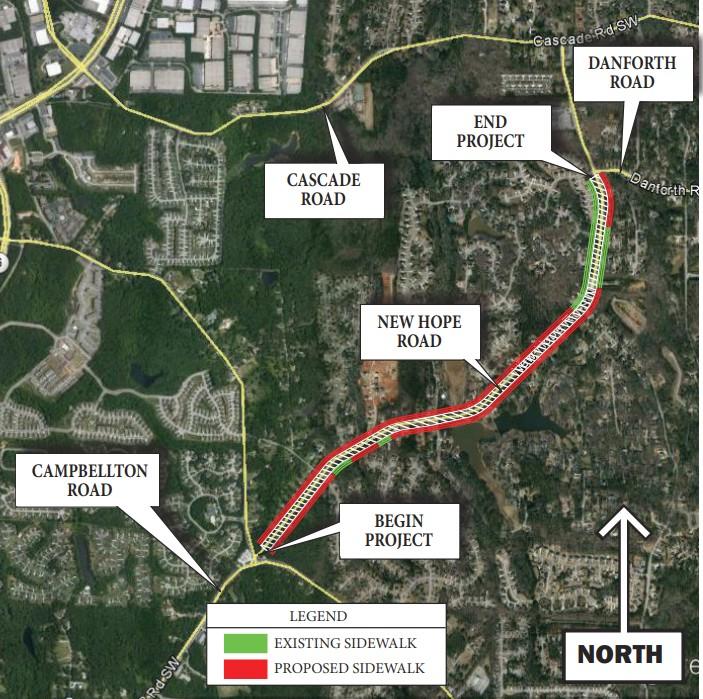

New Hope Rd from E of Boat Rock Rd to Danforth Rd – Enhancement Project • This project will connect/complete the sidewalks along both sides of New Hope Rd from east of Boat Rock Rd to Danforth Rd • Add 24 ft. curb and gutter, a two-foot grass strip, and a 5foot-wide sidewalk • Est CST: $3.5 M • Scheduled Let: Spring 2023
SR 3 at 8 Locations and SR 70/Fulton Industrial Blvd at 4 Locations – Pedestrian Upgrades • This project will upgrade pedestrian facilities on SR 70 in compliance with ADA standards at the following SR 70 locations:  Marvin Miller Dr  Patton Dr  I-20 EB , WB ramps • Est CST: $2.4 M • Scheduled Let: Spring 2023

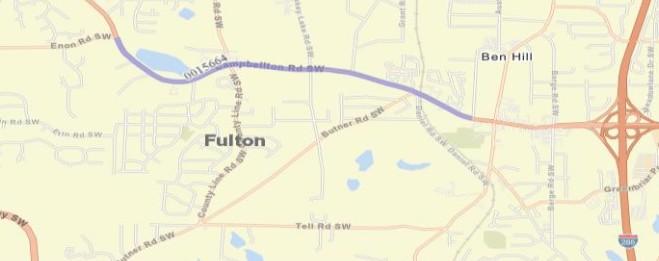

Campbellton Rd from Enon Rd to Campground Rd – Reconstruction • The proposed project will construct pedestrian accommodations where needed and minor widening along the corridor • Improvements will also include minor operational improvements throughout the project corridor • Est CST: $ 7.2M • Scheduled Let: winter 2024
SR 154/Campbellton Rd from SR 70/Fulton Industrial Blvd to I-285 - Resurfacing • Est CST: $ 2.75M • Scheduled Let: summer 2024

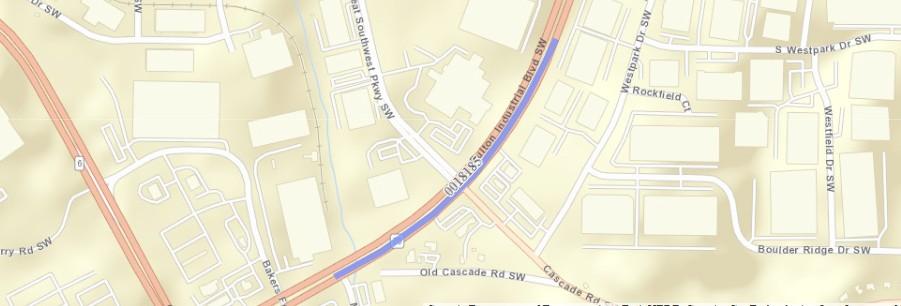

SR 70/Fulton Industrial Blvd at Cascade Rd – Operational Improvements • The proposed improvement would reconstruct Cascade Rd into three lanes in both directions, with dedicated left-turn, through lane and right-turn lanes • Northbound and southbound left turns on SR 70 Fulton Industrial Blvd will be reconstructed to align within the existing landscaped median • Est CST: $4.5 M • Scheduled Let: winter 2025

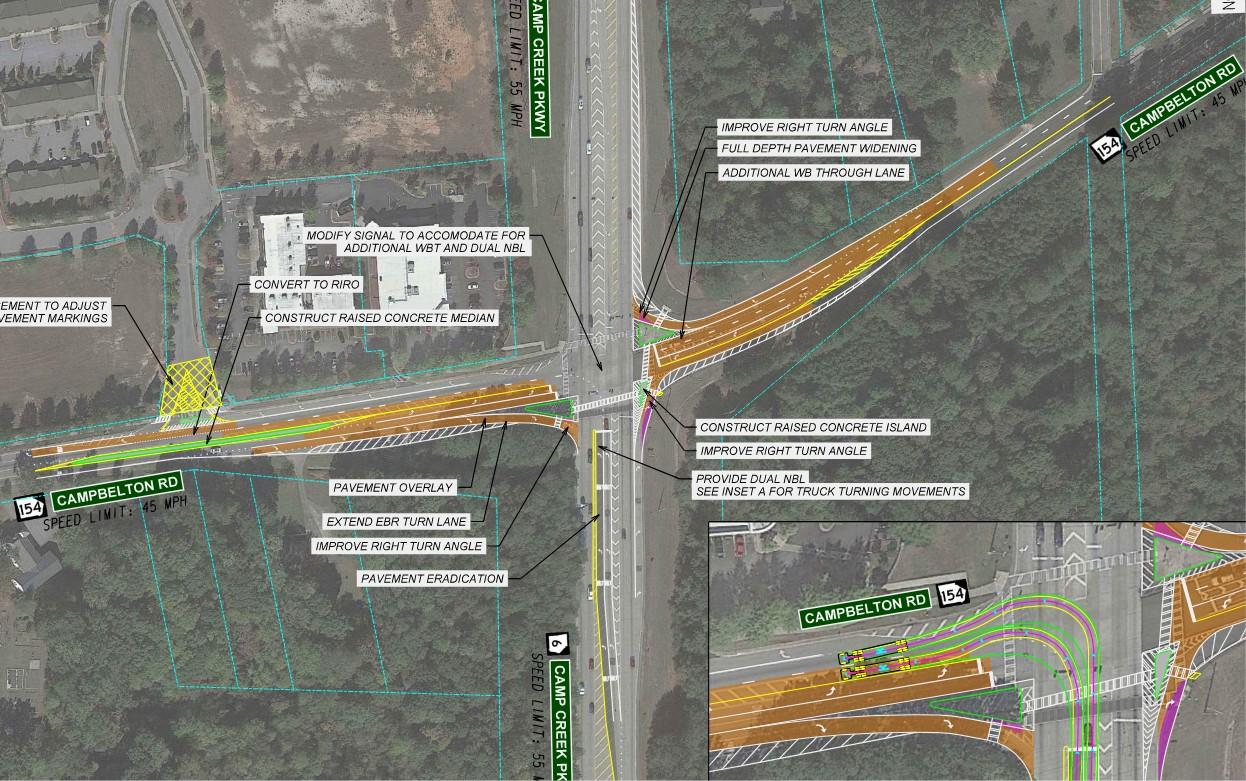

SR 154/Campbellton Rd at SR 6/Camp Creek Pkwy – Operational Improvements • This project proposes an additional WB thru lane, dual NB LT lane, and median improvements to improve operations. • Est CST: $1.5 M • Scheduled Let: TBD
I-285 from Mt. Gilead Rd to Collier DrReconstruction • Est CST: $103 M • Scheduled Let: TBD
GDOT Customer Service • customerservice@dot.ga.gov - Our policy guidelines are to respond within 72 hours for non-emergency inquiries • Phone, email, web-based contact form at www.dot.ga.gov
@gadeptoftrans Paul DeNard, PE, PTOE District Engineer District 7, Metro Atlanta Office: 770-216-3890 pdenard@dot.ga.gov Thank you! Rubin McCullors Area Manager Area 3, South Fulton, Clayton, Douglas Office: 404-559-6699 rumccullors@dot.ga.gov
