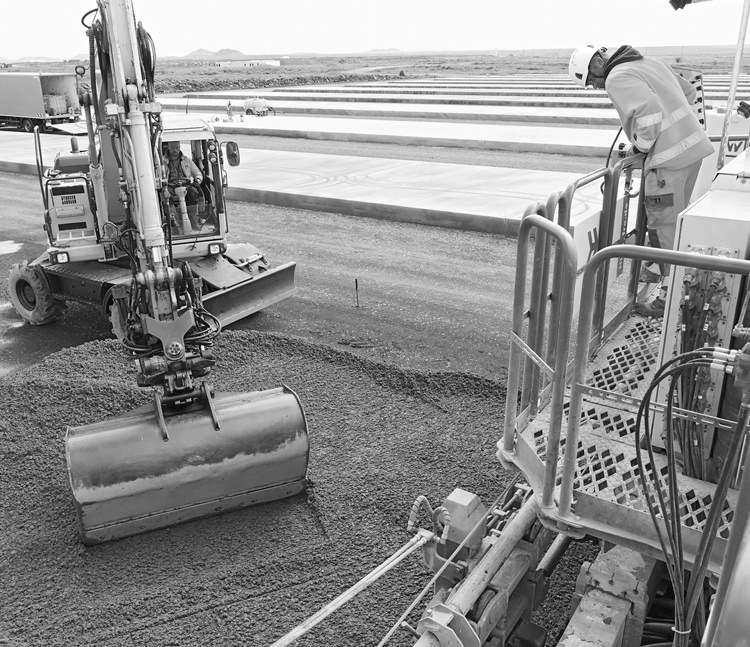

* Technical testing regulations for evenness measurements on road surfaces in longitudinal and transverse directions. A clear sign of the quality that can be achieved only with a perfectly coordinated team and the right equipment, as Hendrik Wendt, Site Manager & Concrete Technologist, HIB Infra GmbH & Co. KG subsequently explained: “On this project, we once again enjoyed the excellent experience of working together with the team from Wirtgen.

Facts, Figures: Extension Project at Keflavik Air Base
Project Dimensions • Parking apron length: 918 ft.; • Parking apron width: 771 ft.; • Hazardous cargo pad length: 394 ft.; • Hazardous cargo pad width: 249 ft.
Paving Data • Specified cross-slope: ≤ 1 percent; • Paving width: 25 ft.; • Paving thickness: 16 to 18 in.; • Daily paving performance: 1,177 cu. yds.; • Overall paved surface area: approximately 89,700 sq. yds.
General • Construction contractor: HIB Iceland
Ehf; • Project timeframe: 07–09/202;1 • Wirtgen machines deployed: SP 62i.



Roads must be built. Worlds must be connected.
DURABLE EASY TO USE


DOUBLE DRUM OSCILLATION & HIGH FREQUENCY

Highway Equipment Company
www.highway-equipment.com 1405 Timken Place SW Canton, OH 44706 330-915-8391
Swanston Equipment Company
www.swanston.com 3450 W Main Ave. Fargo, ND 58103 800-369-0371 3915 Burdick Expressway E. Minot, ND 58703 800-210-8766 3327 E Fir Ave. Fergus Falls, MN 56537 218-739-4505












YEXCLUSIVEINDUSTR TIC TAUTOMA TRACKTENSIONINGSYSTEM
















Star Equipment, Ltd.
starequip.com




1401 2nd Avenue Des Moines, IA 50314 515-283-2215
2950 6th Street SW Cedar Rapids, IA 52404 319-365-5139 2625 W Airline Hwy. Waterloo, IA 50703 319-236-6830 2100 E Lincoln Way Ames, IA 50010 515-233-9500
Entering Year Four of Rebuild Illinois, the Illinois Department of Transportation announced multiple projects in the Peoria and Quad Cities area are under way or planned. Twelve major projects in Peoria represent a total investment of $245.3 million, improving safety and mobility while sustaining and creating good-paying jobs throughout the region. Of these projects, 10 of them are scheduled to be completed in 2022, with the remaining two in 2023.
Seven major projects in the Quad Cities area represent a total investment of $55.78 million, improving safety and mobility while sustaining and creating good-paying jobs throughout the region. Five of the seven projects are scheduled to be completed in 2022. Peoria Projects
Eastbound McClugage Bridge replacement began spring of 2019 and is estimated to be open in fall 2023, with demolition of the existing eastbound bridge to occur in 2024.
Pinecrest Drive over Interstate 74 replacement will finish late this summer after starting in 2020.
Western Avenue from Adams Street to
Lincoln Avenue reconstruction began last year and is scheduled to be completed in December.
Interstate 474 from the Illinois River to
I-74 resurfacing began last summer and will be completed in November.
Illinois 74 from Morton to Goodfield
painting, bridge overlay repairs and joint/bearing replacement work began last year and scheduled to be completed later this spring.
I-74 and I-474 and Illinois 6 interchange structure repairs and bridge deck overlay work began last year and are scheduled to be complete this spring.
McNaughton Bridge over the Illinois
River in Pekin rehabilitation, joint replacement and deck repairs began in 2021 and scheduled to be completed this summer.
Illinois 8 structures: Nixon Run, Warsaw Creek and Kickapoo Creek
Tributary structural overlay and joint repairs began in early April and scheduled to be completed in August. Traffic reduced to one lane operated by traffic signals.
U.S. 24 1 mile west of Mapleton superstructure replacement began in early April and scheduled to be completed in October.
I-74 from east of Morton to Woodford
County line resurfacing began in early April and is scheduled to be completed in November.
Broadway Road from Veterans Drive to
Springfield Road resurfacing and drainage improvements began in March and are scheduled to be completed in the summer of 2023.
Courtland Street from Walton Avenue
to Main Street in Morton reconstruction and widening work begins in May and is scheduled to be completed in November.
Quad Cities Projects
Interstate 280 over the Mississippi
River (Sgt. John F. Baker Jr. Bridge) began the second year of a three-year bridge deck replacement project in March. Construction shifted in the eastbound lanes after the westbound lanes were completed in 2021. This year’s work is scheduled to be completed in November.
Interstate 74 in Henry County pavement patching from the Interstate 74/80/280 interchange to Illinois 81 began in March and finished in May.
Colona Road/Avenue of the Cities in
East Moline and Silvis pavement patching was completed in April. The repairs were from Kennedy Drive in East Moline to Hospital Road in Silvis.
I-74/280 over Shaeffer Creek in Coal
Valley began in May. Work includes replacing bridge expansion joints and steel repairs. The project is scheduled to be completed in July.
Interstate 74 in Moline will begin landscaping from the Mississippi River bridge to the Avenue of the Cities this summer. This project concludes this fall.
Illinois 192 in Edgington construction will begin in July to resurface the highway from 123rd Street West to 140th Street West. This project concludes in September.
Centennial Bridge (U.S. 67) over the
Mississippi River in Rock Island repairs to structural steel, hanger and other related items begin this fall. The first stage of work will continue until winter before resuming in spring.
Passed in 2019, Rebuild Illinois is investing a total of $33.2 billion over six years into the state's aging transportation system, creating jobs and promoting economic growth. Rebuild Illinois is not only the largest capital program in state history, but also the first that touches all modes of transportation: roads and bridges, transit, waterways, freight and passenger rail, aviation, and bicycle and pedestrian accommodations.
Accomplishments through March include approximately $7.3 billion of improvements statewide on almost 3,800 mi. of highway, more than 370 bridges and nearly 550 additional safety improvements.
For more information, visit idot.click/Rebuild-Illinois.
