Technical specification
Item- SS 306 plate
Finish- Brush finish
Advertisement
Size- as per design
Opportunities
1. Column Footing

Material- Cement, Fine aggregate (M sand), Coarse aggregate(20 mm metal), steel( FE 500 D)
Brand - cement- Ultra tech Reinforcement - TATA
Grade – M25
Design – As per structural drawing
2. PCC
Material- Cement, Fine aggregate ( M sand), Coarse aggregate( 40 mm metal),
Brand - cement- Ultra tech
Grade – M10
Design – As per structural drawing
3. Plinth beam
Material- Cement, Fine aggregate ( M sand), Coarse aggregate( 20 mm metal), steel( FE 500 D)
Brand - cement- Ultra tech Reinforcement - TATA
Grade – M20
Design – As per structural drawing Protection – two matte clear coat Endura /Fila

5. Modular Kiosk

Item- Mild Steel Frame, Panel - Steel, PVC, Aluminium & ACP
Colour- As per design

Size- As per design

Babel 4.0 | Dewan Arch

• Weunderstandtheimportanceof championingvariousbackgrounds, cultures,visionsandexperiences, exemplifiedbythefirm’sdiverse multi-culturalteamwithover50 nationalitiesrepresented.Withthese valuesinmind,DewanArchitectshas createdBabel4.0,areinterpretation ofthemythicalTowerofBabel, previouslycitedas,‘Aunitedhuman raceinthegenerationsfollowingThe Atrahasis(TheGreatFlood),speaking asinglelanguage,migrating westward,cometoalandwherethey agreetobuildautopianverticalcity tallenoughtoreachtheheavensand liveinperpetualharmony’.Inthehope toencourageacademia,government bodies,architects,engineers, universities,materialandproduct producersandthecommunityto interactandexchangeideasina virtualworld.

ON SITE CONDITIONS:

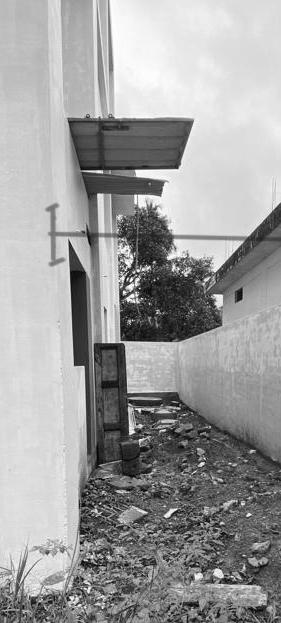

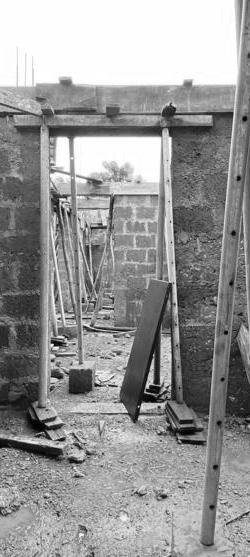

1. Regarding the grill deisgn, a 10cm Flush needs to be there with the ground floor beam in order to accomodate the box section.
2. The window fenestrations needs to accomodate an extra sill so that water cannot be pentrated into the built form

3. As of now, Joinary works are going on, but some of the doors can only done after flooring, in order to accomodate that adequate height.

ON
SITE CONDITIONS:

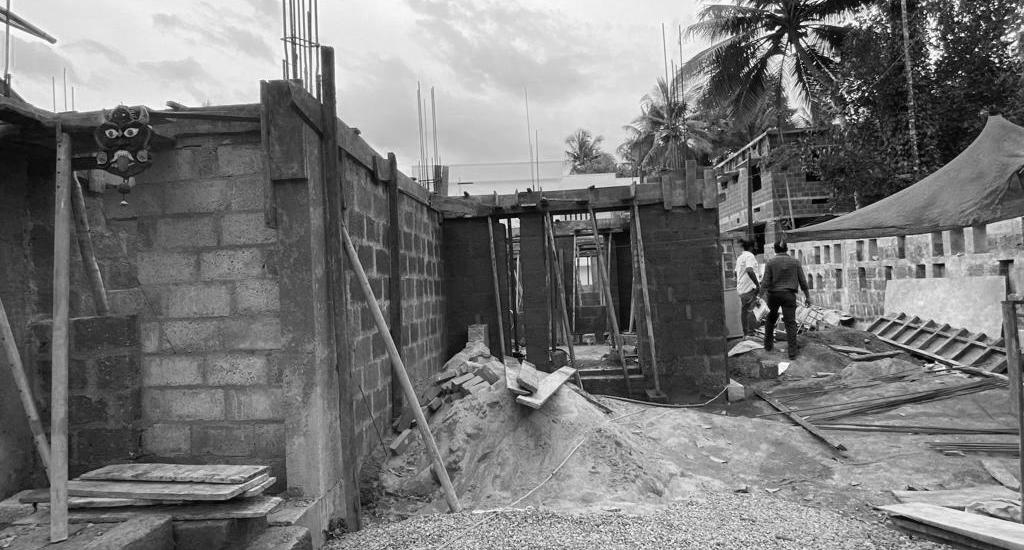

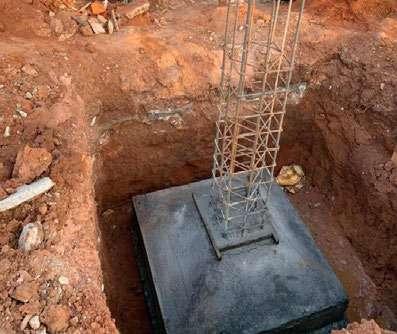

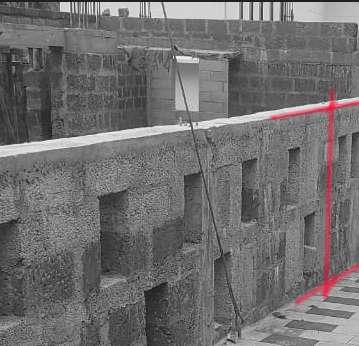

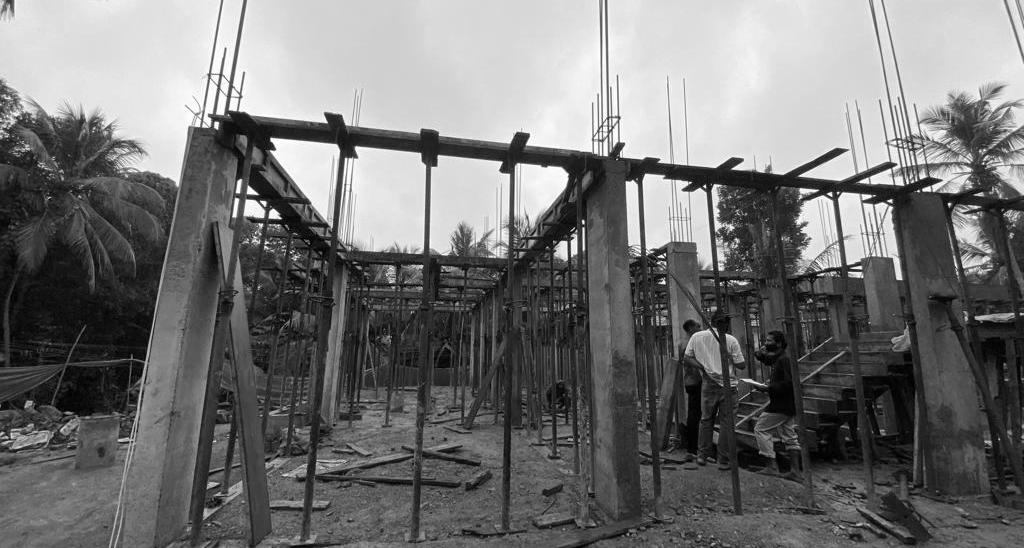

1. The residence is currently in its 1st floor slab casting and beam shuttering with plinth beams to completion.

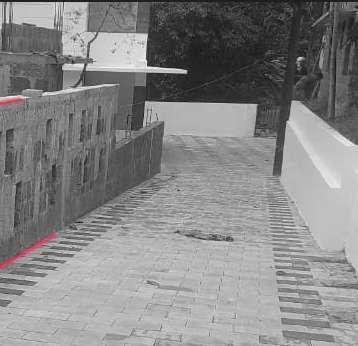

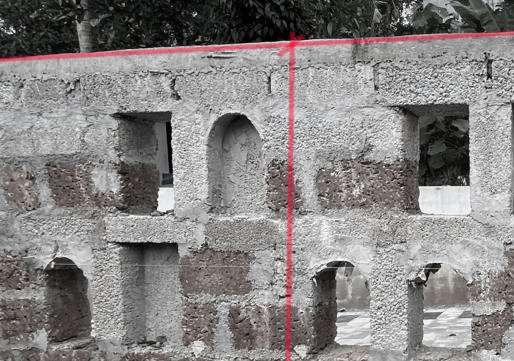

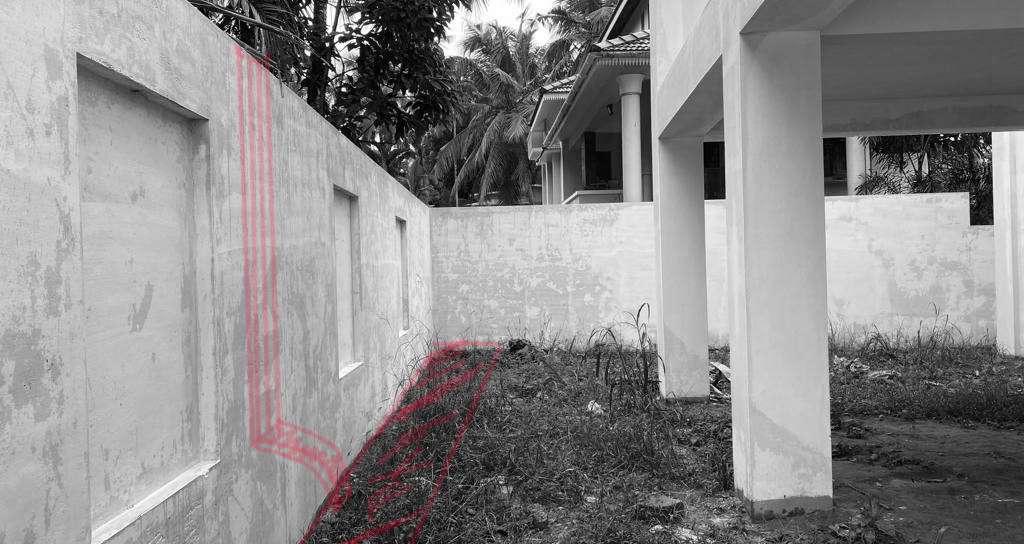

2. There occurs to be an issue with the coumpound wall with not up to accurate height of 1.8 M and currently its only up to 1.2 M.

ON
SITE CONDITIONS:

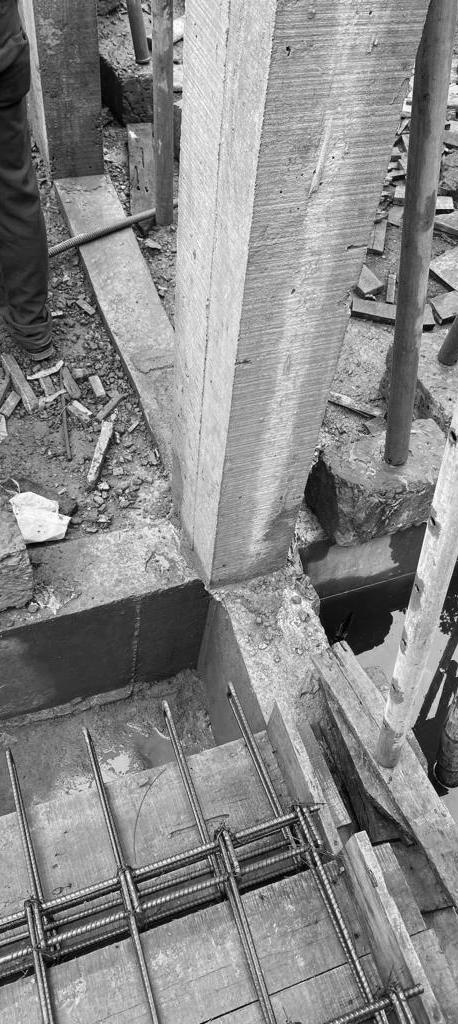

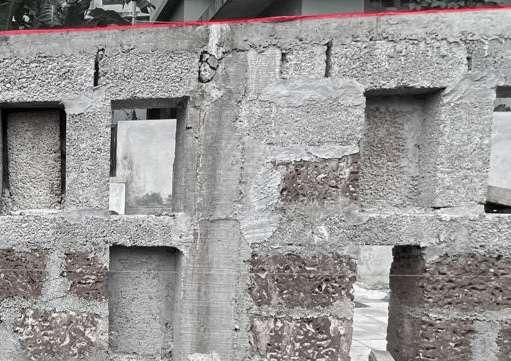

3. There occurs to be a buldge in the water body beam which then has to be chipped and corrected.
ARJUN NISHIDA RESIDENCE
SITE VISIT

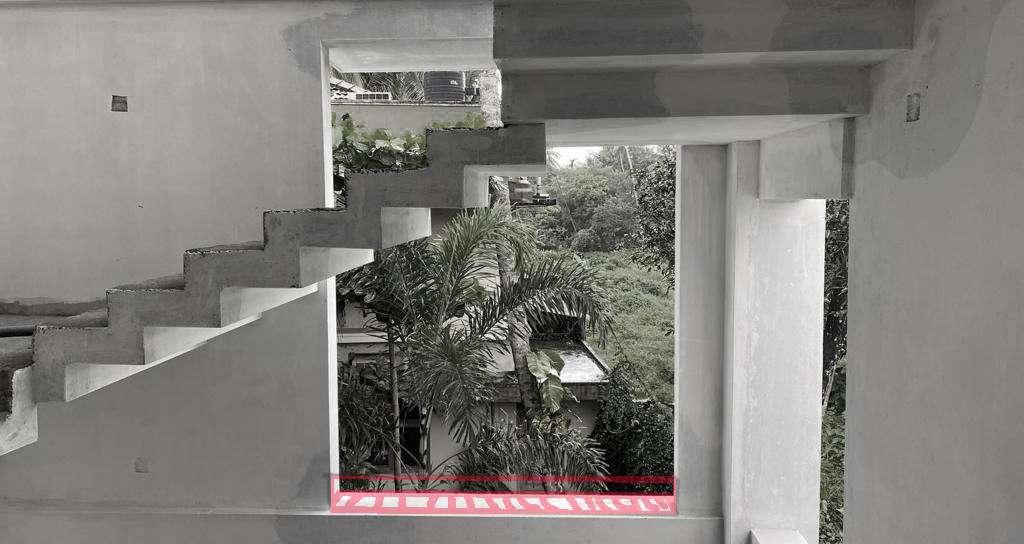

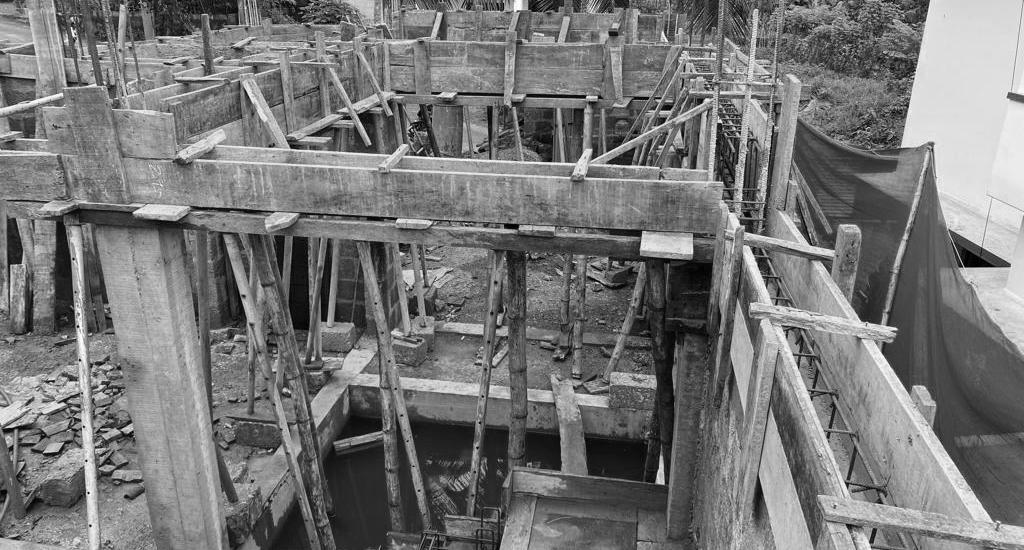

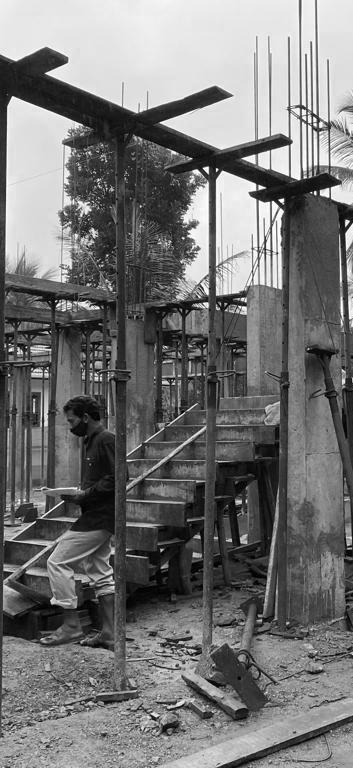

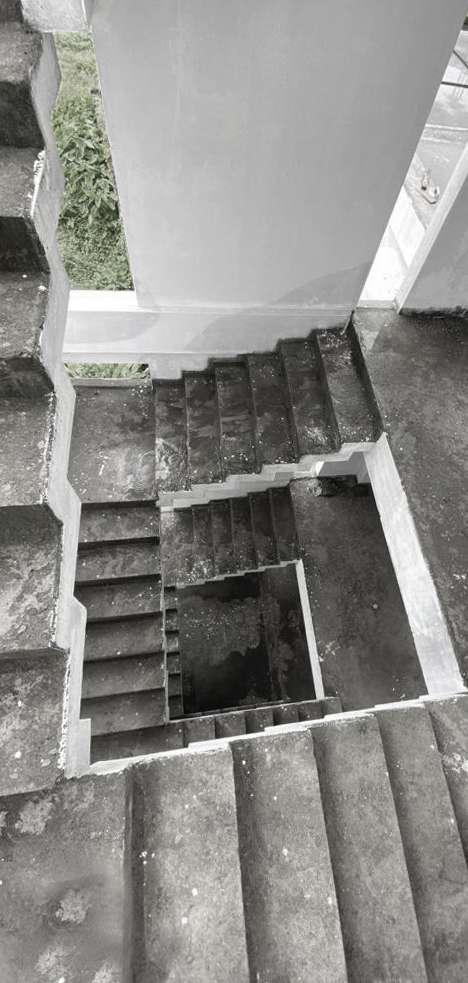

Stage : 1st floor slab shuttering 07
ON SITE CONDITIONS:

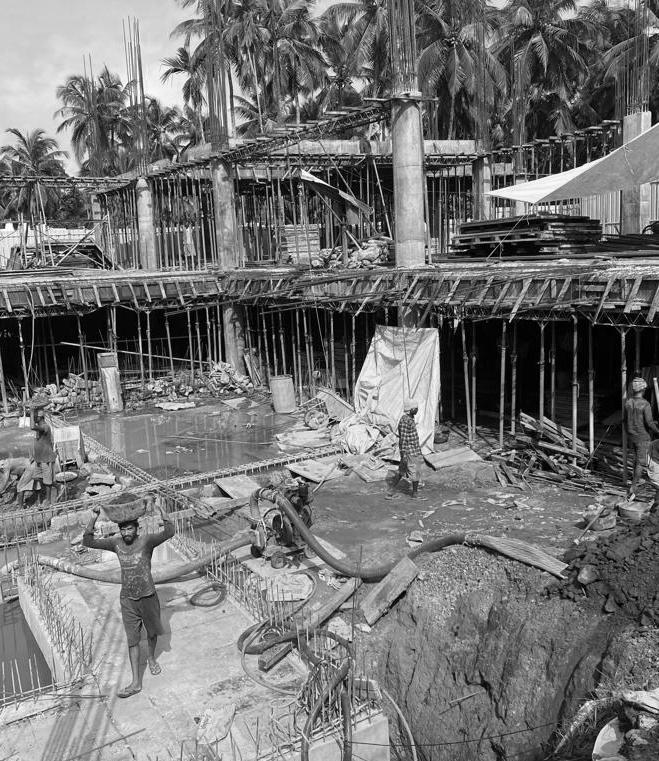

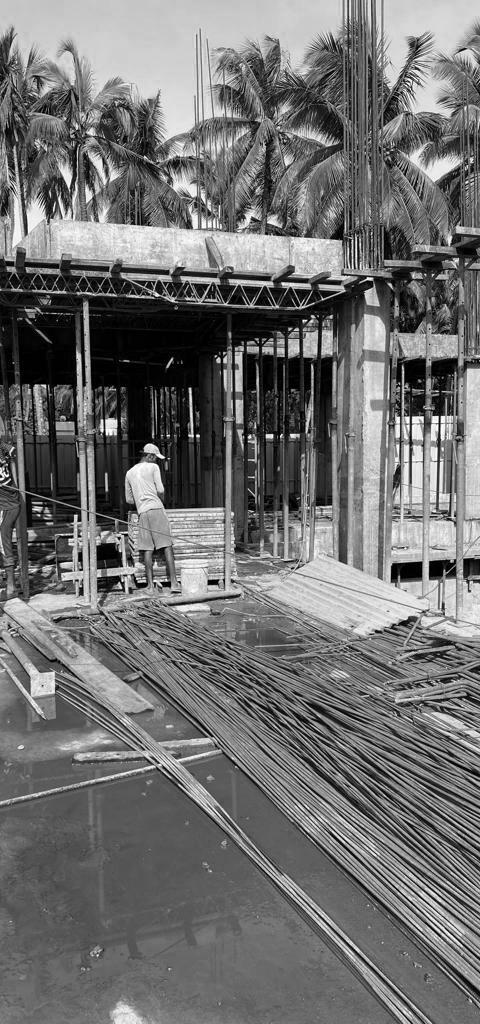

1. The commercial site at pavangadu have reached a stage of upper floor slab casting with beam shuttering.

2. At the basement due to rain at the moment there appears to be some difficulty with subsequent leech pit works. Any building with more than 200 sqm needs a leech pit. Standard dimensions of STP depends upon occupency and load.
COMMERCIAL @ PAVANGADU
Status: 1st floor slab shuttering

ON SITE CONDITIONS:

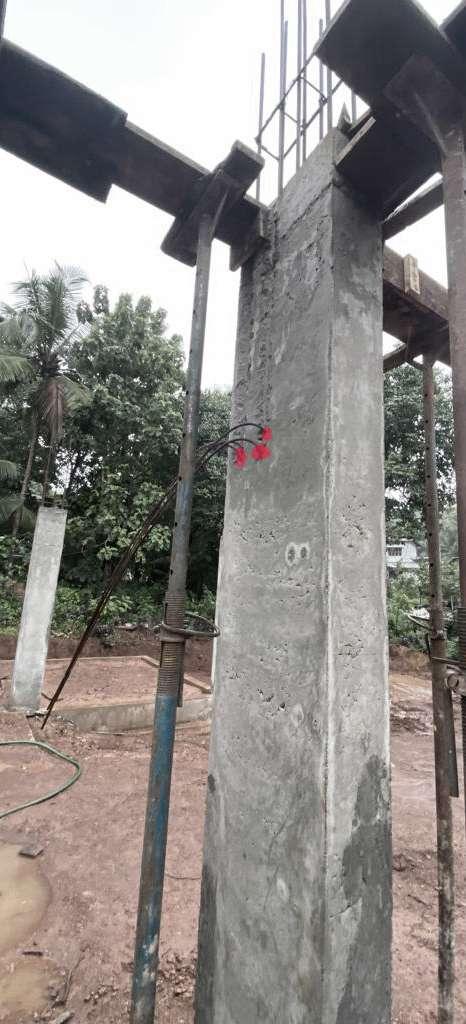

1. During the coloumn casting, there appears to be an defect with the coloumns regarding the lintel dowels which was not provided resulting coloumn dowels being chipped out which would result in the over integrity of the coloumn.
HARILLILA AYIRVEDIC SPA+RESORT Stage : Column Casting with beam shuttering
