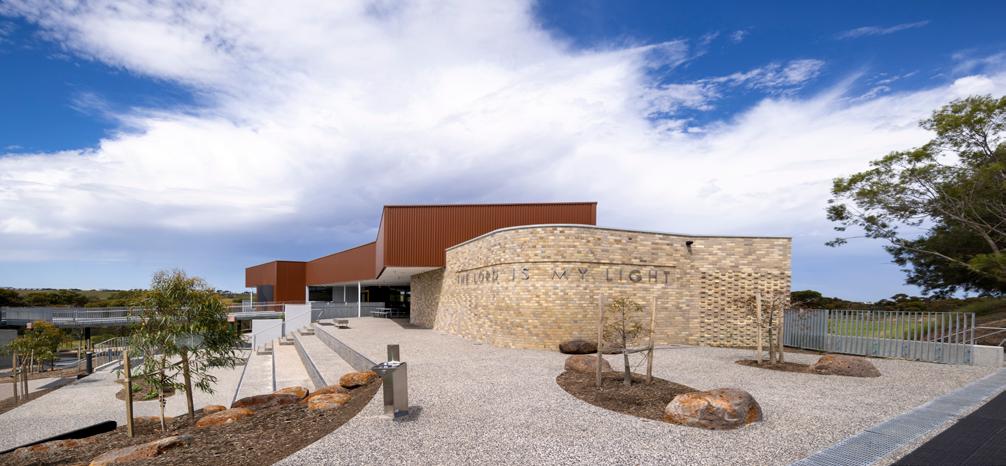

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024 6: VISUAL FEATURE

Overnewton Anglican Community College (OACC) is located on the land of the Wurundjeri, Woi Wurrung People of the Kulin Nation. OACC has offered coeducational independent education on a dual Campus for Prep to Year 12 students for over 30 years in Melbourne’s North-West. As part of a strategic masterplan developed in 2017, the College engaged the Architect and Project Team to transform their two school sites into a separate Junior campus at Taylors Lakes and a Middle/ Senior Campus at Keilor. The new Middle School (Years 5–8) building became Stage 1 of the Yirramboi (Keilor) Campus.

The building sits nestled into a steep hill adjacent to the existing learning building and reimagines the offerings for middle years students into a healthy habitat promoting a sense of belonging and connectedness. The design is focused on flexible learning environments that are connected to each other and the surrounding environment. The building materials and finishes reference the natural environment and colours of the earth.

Comprising fifteen learning areas arranged around a tiered ‘Central Commons’, the precinct is consolidated by a canteen, external (undercover) auditorium and concourses. Pedagogical flexibility is paramount, resulting in a diverse range of learning areas, nooks and informal gathering spaces. Meanwhile, all fifteen learning areas have direct access to generous external covered spaces. The building layout and surrounding landscape design strategically link to previously disparate existing buildings across the school site to create a more unified and cohesive learning environment for the whole campus.

VISUAL FEATURE

“This project demonstrates the benefits of significant consultation with the school community that resulted in a well-considered and robust brief allowing Law Architects to successfully develop a design to create rich, contemporary learning environments. The site, though challenging, presented opportunities to engage seamlessly with the natural environment. The building is imaginative, creating unusual shapes and spaces that work well on the sloping site. A sense of calm and connectedness is provided through the extensive use of glass to frame vistas of the landscape. All learning areas have direct access to generous external learning spaces that promote both passive and active learning, collaboration and reflection.

The functionality of the design has created a diverse range of internal spaces of varying sizes and shapes including informal spaces, nooks and larger spaces to gather in large or smaller groups.

Law architects have successfully executed a design that is totally reflective of the learning culture envisioned by the school. The building is well connected both visually and aesthetically to its natural surroundings and has created a learning community that welcomes all.”

Learning Environments Australia, Judges Citation

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024: 7

VISUAL FEATURE

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024 8:
WINNER OF THE LEARNING ENVIRONMENTS AUSTRALASIA AWARDS 2022 FOR NEW FACILITY (OVER $8 MILLION CATEGORY) HONOURABLE MENTION (CATEGORY RUNNER UP) – INTERNATIONAL 2022 INDE AWARDS AWARDS

COMMENDATION – 2022 LEARNING ENVIRONMENTS AUSTRALASIA, VICTORIAN AND TASMANIAN CHAPTER AWARDS, FOR EXCELLENCE IN EDUCATION FACILITY DESIGN

SPECIAL MENTION – 2023 ARCHITIZER A+ AWARDS PRIMARY & HIGH SCHOOLS

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024: 9
AWARDS
VISUAL FEATURE

VISUAL FEATURE

“As Project Cost Management Group (PCMG) celebrate the achievements of the OACC Yirramboi Campus Middle School Project, we extend our heartfelt appreciation to each Team Member for their indispensable role in this journey. Their contributions have not only elevated the project to new heights of success but have also enriched our collective experience, leaving an indelible mark on the Cost Management Field of excellence.

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024 10:
BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024: 11
VISUAL FEATURE
This feature was provided by Project Cost Management Group (PCMG) and all images are credit to photographer Dianna Snape.

MITIGATION, ACCELERATION AND CONSTRUCTIVE ACCELERATION

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024 12: DELAYS

This article will consider the differences between mitigation, acceleration, and constructive acceleration. The recent case of V601 v Probuild1 is of interest, as it demonstrates that a constructive acceleration claim can be successful in certain circumstances.

MITIGATION

First, let’s understand the consensus regarding mitigation.

Generally, the contractor is required, as far as reasonably practicable, to minimise the effect of a delaying event without spending additional money or resources.

Similarly, where the contractor was able to reduce the impact of the employerrelated delaying event but did not, the contractor will not be able to recover costs incurred from the effects of the events that it could have reasonably avoided.

This is reinforced by several standard forms of contract clauses regarding mitigation:

AS4300 1995:

“In determining a reasonable extension of time for an event causing delay, the Superintendent shall have regard to whether the contractor has taken all reasonable steps to preclude the occurrence of the cause and minimise the consequences of the delay.”

“What if the contractor and employer do not agree on an EOT?”

AS2124 1992:

“The contractor shall take all reasonable steps to limit, reduce and otherwise mitigate any loss or damage and the contractor shall, unless the Superintendent otherwise directs, take such emergency action as may be required to mitigate the loss or damage.”

FIDIC 2017:

“All reasonable endeavours to minimise any delay in the performance of the contract.”

To paraphrase, to claim an extension of time (EOT), it is a condition precedent of the contract that reasonable steps are taken to mitigate the potential impact of the alleged delaying event.

ACCELERATION

Acceleration is the execution of the planned scope of work in a shorter time than the originally planned duration.

Acceleration usually incurs an extraover cost to the contractor, whereas mitigation does not. Generally, before any acceleration measures are undertaken, the employer and contractor must agree to the proposed acceleration measures and their (likely) cost, as reinforced by the following excerpt from The Society of Construction Law (SCL) Protocol2 :

“Where the contract provides for acceleration, payment for the acceleration should be based on the terms of the contract. Where the contract does not provide for acceleration but the contractor and the employer agree that accelerative measures should be undertaken, the basis of payment should be agreed before the acceleration is commenced.”

1 V601 Developments Pty Ltd v Probuild Constructions (Australia) Pty Ltd (2021) VSC 849.

2 Society of Construction Law, Delay and Disruption Protocol, 2017, pg. 41.

Mitigation necessitates an actual delay event to occur that impacts progress and the date(s) for completion, whereas acceleration does not.

The employer can instruct the contractor to accelerate, regardless of whether the project is likely to be delayed (or not).

For example, the employer may require the use of the completed project earlier than contractually defined i.e., an earlier date than the contractual date for completion, requiring the contractor to accelerate.

However, if the contractor is in delay, the employer may direct the contractor to accelerate (at its own cost) to meet the contractually agreed date(s) for completion.

Before agreeing on the acceleration strategy (and cost), an entitlement to an EOT will have been determined in line with the relevant conditions of the contract.

CONSTRUCTIVE ACCELERATION

The SCL Protocol defines constructive acceleration as:

“Acceleration following failure by the employer to recognise that the contractor has encountered employer delay for which it is entitled to an extension of time and which failure required the contractor to accelerate its progress to complete the works by the prevailing contract completion date.”

What if the contractor and employer do not agree on an EOT?

In the case of Motherwell Bridge v Micafil3, Motherwell accelerated its scope of work to accommodate the earlier days of Micafil so the date for completion could be maintained.

BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024: 13
DELAYS

Motherwell notified Micafil of the three week critical path delay and provided an acceleration strategy. Motherwell was not instructed to accelerate, nor were they given an extension of time. Rather, Motherwell, at its own cost, accelerated its program.

His Honour Judge Toulmin awarded Motherwell an EOT to the date for completion, had it not been for the accelerated program i.e., after the actual date of completion. Motherwell was also entitled to claim the associated prolongation costs between the date of and for completion. Interestingly, Motherwell was not entitled to recover the associated acceleration costs.

The Motherwell Bridge v Micafil case highlights that, although Motherwell was entitled to an extension of time, they were not entitled to acceleration costs; even though Micafil agreed to the proposed acceleration strategy, they did not issue an instruction to accelerate.

In the case of Perini Corporation v Commonwealth of Australia4, Perini submitted several EOT claims that were subsequently rejected by the Director of Works. Moreover, the Director of Works took an excessive amount of time to make his decisions regarding the EOT claims.

Perini accelerated their works to meet the date for completion and to avoid liquidated damages. Justice Macfarlan found that the failure of the Director of Works to respond to Perini’s EOT claims in a reasonable time was a breach of contract.

Perini effectively constructively accelerated their works and they were successful in claiming the associated acceleration costs.

“EOT claims should be assessed as close to the time that the delaying event(s) occurred.”

The case of V601 Developments Pty Ltd v Probuild Constructions (Australia) Pty Ltd is similar to Perini v Commonwealth of Australia in that it was the Principal’s breach of contract that resulted in the successful constructive acceleration claim.

KEY TAKEAWAYS

Failure by the employer to grant an EOT, where it should have, does not necessarily give rise to a constructive acceleration claim.

Similarly, when a contractor does accelerate, they are not entitled to claim the associated costs unless explicitly directed to accelerate as a result of an employer delay event(s).

The ‘wait and see’ approach is not the best way to manage EOT claims.

EOT claims should be assessed as close to the time that the delaying event(s) occurred.

3 Motherwell Bridge Construction Ltd v Micafil Vakuumtechnik (2002) CILL 1913

4 Perini Corporation v Commonwealth of Australia (1969) 2 NSWR 530

5 SCL Delay and Disruption Protocol 2nd Edition: February 2017, pg. 41.

“...The contractor should seek the approval of the relevant EOT claim.”

Before implementing any acceleration measures to expedite an employerrelated delay, the contractor should seek the approval of the relevant EOT claim. As per the SCL Protocol recommendation that:

“Where the contractor is considering implementing acceleration measures to avoid the risk of liquidated damages as a result of not receiving an EOT that it considers is due to it, and then pursuing a constructive acceleration claim, the contractor should first take steps to have the dispute or difference about entitlement to EOT resolved in accordance with the contract dispute resolution provisions. Otherwise, there is the risk that it will not be entitled to compensation for those acceleration measures.

In any event, before pursuing any such acceleration measures, the contractor should provide notice with the particulars of the intended acceleration measures to the CA. The contractor should then include such measures in a revised programme.”5

written by Paul McArd FAIQS, CQS from Accura Consulting. BUILT ENVIRONMENT ECONOMIST: MARCH – MAY 2024 14:
