Launders Lane Public Meeting 25 Nov 2025 - 3 DMC presentation

Page 1


25th November 2025

DMC Proposals

• DMC aspire to a redevelopment of the Site for a commercial / light industrial end use

• The site is in metropolitan greenbelt which presents a challenge under NPPF. DMC believe Very Special Circumstances apply

• DMC first approached LBH in 2018 with proposal but have been repeatedly rejected until 2024

• Re-development will include remediation of the Site that will provide permanent, lasting improvement and eradication of fires

• Major constraint is sites designation as metropolitan greenbelt

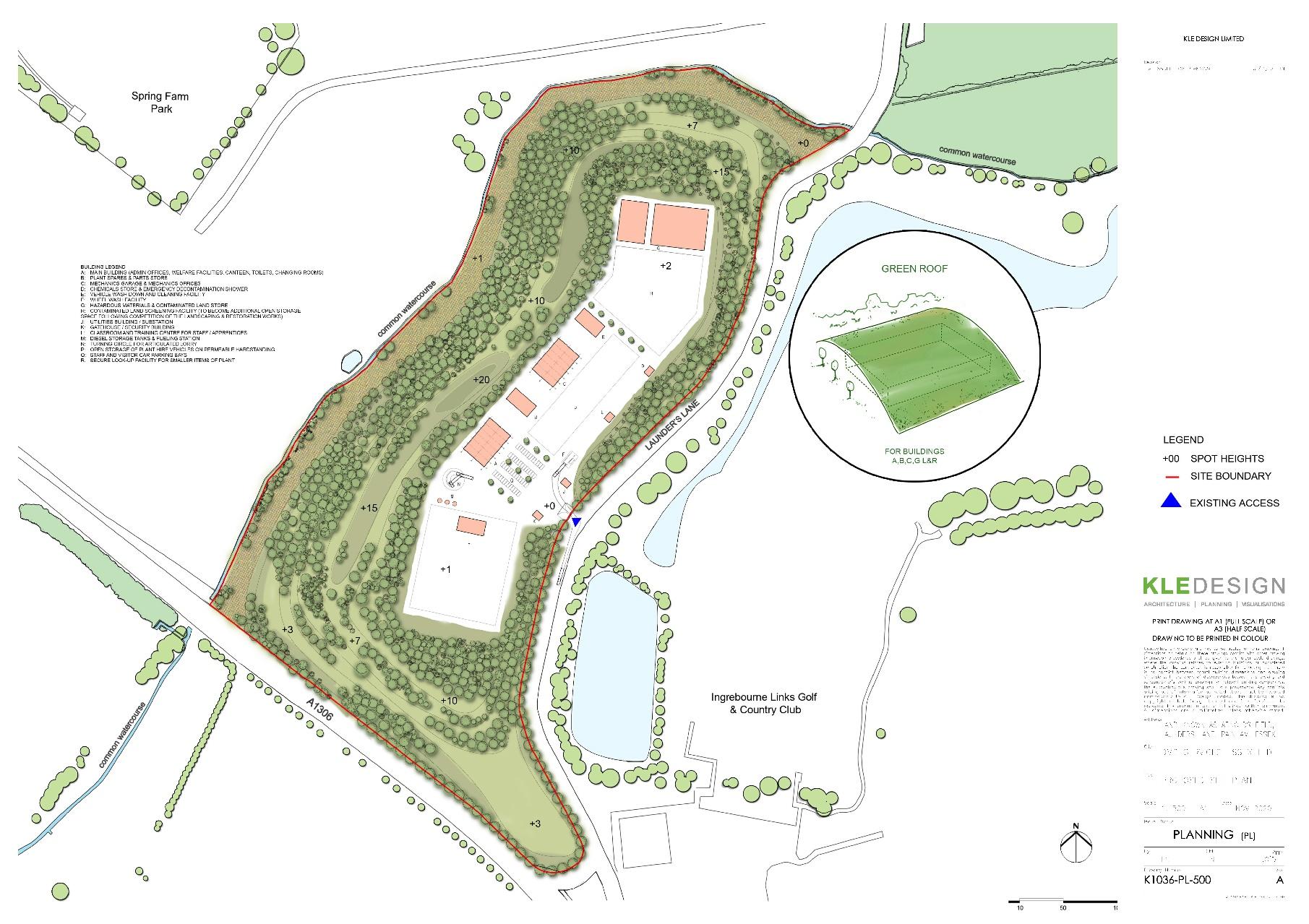

Development Proposal

Current Status

• DMC currently preparing a scoping report to submit to LBH, including air quality, ecology, ground conditions, etc.

• JR, & Contaminated Land Determination have diverted resources away from Scoping Report

• Some of the reports that were previously prepared now need to be updated as submission delayed due to Cont. Land Determination.

Remediation Proposals (1)

• Remediation Proposals first submitted to LBH October 2022, involving:

• Vegetation clearance and topsoil strip;

• Waste, sorting, screening, segregation;

o Recover useable materials e.g. concrete, metals bricks, ceramics

o Remove deleterious material e.g. plastic, paper, combustibles

o Off-site disposal of unacceptable materials

o Recycle inert materials to produce soils and aggregates

• Waste Compaction / Stabilisation (Earthworks)

o Strip off-restoration soils where present

o Compact / stabilise underlying waste

o Installation of geomembrane over waste, where required

Remediation Proposals (2)

• Site re-profiling / Cut and Fill (Earthworks)

o Reduce elevation in central area, fill in voids and remove steep slopes / uneven ground

o Create development platform

o Soil treatment to remove contamination (by recognised methods)

• Removal of Dangerous Waste

o e.g. LPG cylinders, putrescible wastes

• Backfilling of Excavations / Voids

• Excavations / voids created by the removal / treatment of wastes will be backfilled and compacted appropriately, to prevent settlement (and fires ..)

• Construction of Restoration / Capping Layer

• Final layer of soils will be suitable for use and will meet commercial end use criteria

• Layer will be of sufficient thickness to provide a capping layer to waste below

Engineering Approach

• Foundations

o Piled due to waste thickness

• Buried Services

o To be constructed of protective materials

• Backfilling of Excavations / Voids

• Excavations / voids created by the removal / treatment of wastes will be backfilled and compacted appropriately, to prevent settlement (and fires ..)

• Construction of Restoration / Capping Layer

• Final layer of soils will be suitable for use and will meet commercial end use criteria (not contaminated)

• Layer will be of sufficient thickness to provide a capping layer to waste below

• Installation of gas protection measures

• All buildings will be constructed with gas protection measures

LBH Approach

o Polymer / cement coating applied by broadcast spray

o Not used previously in this application

o Typically used as daily cover on landfill sites so very temporary

o Will require vegetation to be stripped and will look like a grey mass of cement (check out the website) . https://halcyonenvironmental.com/posi-shell/

o May require importation of 300mm of subsoil (equiv. to @ 45000m3 of soil), permit required or purchase as primary resource

o No guarantee of success at prevention of fires in this scenario

o Does not provide a permanent solution

LBH Approach – Financial Estimate

• Polymer / cement coating, supply only to cover 75% site £375,000 equiv. to @1875 tnes waste removal

• Cost of application (unknown) estimate ~£4.0 /m2 @ £600,000 equiv. to @3000 tnes waste removal

• Cost of vegetation strip ~1.20/m2 equiv. to @702 tnes of waste removal

• Cost of disposal of green waste ~£30/tne @£1.75 million equivalent to @8750 tnes waste removal

• Cost of import (without waste permit) of 300mm sub-soil ~£30/m3 £1.35 million equivalent to @6750 tnes waste removal

• Environmental permit for import if using waste @£30,000 equivalent to @150 tnes waste removal

• Monitoring / Testing /Consultants / Reporting @£30,000 equivalent to @150 tnes waste removal

• LBH estimated expenditure to date ~£1.0 million equivalent to @5000 tnes waste removal

Concluding Remarks

• Approx. 5000 tnes of waste could have be removed for the LBH expenditure to date

• The cost of the proposed spray cover is equivalent to ~21,397 tnes of waste removal (estimated total quantity waste 47,385 tnes)

• Planning permission would allow the site to be a viable proposition for DMC and provide long-term income to support remediation and site development

• Requires recognition of VSC under NPPF and co-operation from LBH

• Planning permission would include amenity facilities for use by residents

• Provides a long-term sustainable approach and end to fires
